Permit Application Status

PRSUBD20180796


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary


PRSUBD20180796
Public Infrastructure
Final Acceptance
CMH PARKS INC
DEVELOPMENT COMPLETE
Hawthorne Ridge 1st Plat - onsite
03/23/2018
04/19/2018
02/08/2023
Locations
Contacts
CLAYTON PROPERTIES GROUP, INC, Address:120 SE 30TH ST, Phone:(816) 246-6700
Emery Sapp & Son Construction Co., Address:140 Walnut Street , Phone:(816) 221-3500
CMH PARKS INC, Address:5000 CLAYTON RD
Reviews
Review Type Outcome Est. Completion Date Completed
Site Visit/Devices Installed Passed 04/13/2018 04/20/2018
Tom Chandler
Fees
Paid Fees Amount Paid Owing Date Paid
91100C8-Sanitary Sewer Insp Fees $13,587.21 $13,587.21 Paid 03/23/2018
91100C9-Water Insp Fee $11,873.82 $11,873.82 Paid 03/23/2018
9110072-Water Test Fee $1,600.00 $1,600.00 Paid 03/23/2018
9110068-Storm Fee $14,548.98 $14,548.98 Paid 03/23/2018
$14,548.97
9110081-Paved Surface Inspection Fee $26,973.47 $26,973.47 Paid 03/23/2018
9110071-Site Grading Fee $25,518.15 $25,518.15 Paid 03/23/2018
9110079-After Hours Inspection (Building Codes)(Per Hour) $2,920.00 $2,920.00 Paid 05/21/2019
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Site Visit Failed 4/9/2018 at 10:00 AM 04/09/2018
PW-Misc
Corrective Action Required
04/09/2018
Tom Chandler 04/09/2018 10:53 AM Contractor has demo permit for on-site demo of existing barn. Contractor was on-site this morning and tracked mud and gravel onto Hook road west all the way to Pryor road. Contractor is getting skid steer and street sweeper to clean roads. Will install larger rock at construction entrance as well.
Miscellaneous PWORKS Inspection Partial 4/9/2018 at 10:15 AM 04/09/2018
PW-Clean mud from street
Corrective Action Required
04/09/2018
Clean all mud from the street. Preventative measures must be taken to prevent this from reoccurring. Tom Chandler 04/09/2018 10:58 AM Spoke to Travis Ruf on-site this morning about the project as well. Summit Custom Homes intentions are to work on-site with the approved plans including the on-site sanitary sewer main prior to constructing the off-site sanitary sewer main. There are (2) seperate engineers for the systems and minimum slopes for part of the system as well.
Site Visit Complete 4/9/2018 at 2:00 PM 04/09/2018
PW-Misc
Resolved
04/09/2018
Tom Chandler 04/09/2018 10:53 AM Contractor has demo permit for on-site demo of existing barn. Contractor was on-site this morning and tracked mud and gravel onto Hook road west all the way to Pryor road. Contractor is getting skid steer and street sweeper to clean roads. Will install larger rock at construction entrance as well. Tom Chandler 04/09/2018 3:46 PM Contractor has street sweeper clean Hook road and begin installing new construction entrance with larger rock. Will monitor the rest of the week.
Erosion Control Inspection Partial 4/19/2018 at 10:30 AM 04/19/2018
PW-Misc
Informational
04/19/2018
Tom Chandler 04/19/2018 10:46 AM Installed some silt fence. Mulch berms and rock check dams will be installed this week as well.
Miscellaneous PWORKS Inspection Passed 4/10/2018 at 9:30 AM 04/19/2018
PW-Clean mud from street
Resolved
04/19/2018
Clean all mud from the street. Preventative measures must be taken to prevent this from reoccurring. Tom Chandler 04/09/2018 10:58 AM Spoked to Travis Ruf on-site this morning about the project as well. Summit Custom Homes intentions are to work on-site with the approved plans including the on-site sanitary sewer main prior to constructing the off-site sanitary sewer main. There are (2) seperate engineers for the systems and minimum slopes for part of the system as well.
PW-Misc
Resolved
04/11/2018
Tom Chandler 04/11/2018 8:47 AM Met with Kent Monter and Dawn Bell. They spoke to Travis Ruf and David Price and will address any outstanding items. Demo permit is the only active permit at this time.
Grading/Excavation/Fill Inspection Partial 4/19/2018 at 10:30 AM 04/24/2018
PW-Misc
Informational
04/19/2018
Tom Chandler 04/19/2018 10:58 AM Begin excation of the sediment basin on the northeast corner of the site.
Grading/Excavation/Fill Inspection Partial 4/24/2018 at 10:00 AM 04/24/2018
PW-Misc
Informational
04/24/2018
Tom Chandler 04/19/2018 10:58 AM Begin excation of the sediment basin on the northeast corner of the site.
PW-Misc
Informational
04/24/2018
Tom Chandler 04/24/2018 1:39 PM Began construction of the sediment basin at the south west area of the site. Installed stand pipe and skimmer on the basin at the north east of the site.
Grading/Excavation/Fill Inspection Partial 4/25/2018 at 10:00 AM 04/25/2018
PW-Misc
Informational
04/24/2018
Tom Chandler 04/19/2018 10:58 AM Begin excation of the sediment basin on the northeast corner of the site.
PW-Misc
Informational
04/24/2018
Tom Chandler 04/24/2018 1:39 PM Began construction of the sediment basin at the south west area of the site. Installed stand pipe and skimmer on the basin at the north east of the site.
PW-Misc
Informational
04/25/2018
Tom Chandler 04/25/2018 10:51 AM Stand pipe and skimmer installed on the sediment basin at the south west of the site. Rock check dams installed at the basin on the north west of the site. Olsson has been on-site to get proctors. Will be out testing at the end of the week. Stewart Legg is the Project Manager for Olsson.
Grading/Excavation/Fill Inspection Partial 5/1/2018 at 10:15 AM 05/01/2018
PW-Misc
Informational
04/25/2018
Tom Chandler 04/19/2018 10:58 AM Begin excation of the sediment basin on the northeast corner of the site.
PW-Misc
Informational
04/25/2018
Tom Chandler 04/24/2018 1:39 PM Began construction of the sediment basin at the south west area of the site. Installed stand pipe and skimmer on the basin at the north east of the site.
PW-Misc
Informational
04/25/2018
Tom Chandler 04/25/2018 10:51 AM Stand pipe and skimmer installed on the sediment basin at the south west of the site. Rock check dams installed at the basin on the north west of the site. Olsson has been on-site to get proctors. Will be out testing at the end of the week. Stewart Legg is the Project Manager for Olsson.
PW-Misc
Corrective Action Required
05/01/2018
Tom Chandler 05/01/2018 11:14 AM Contractor cutting grade at the northwest corner of the site and placing fill at the sediment basin at the southwest corner of the site. Olsson testing today as well.
Grading/Excavation/Fill Inspection Partial 5/7/2018 at 1:00 PM 05/07/2018
PW-Misc
Informational
05/01/2018
Tom Chandler 04/19/2018 10:58 AM Begin excation of the sediment basin on the northeast corner of the site.
PW-Misc
Informational
05/01/2018
Tom Chandler 04/24/2018 1:39 PM Began construction of the sediment basin at the south west area of the site. Installed stand pipe and skimmer on the basin at the north east of the site.
PW-Misc
Informational
05/01/2018
Tom Chandler 04/25/2018 10:51 AM Stand pipe and skimmer installed on the sediment basin at the south west of the site. Rock check dams installed at the basin on the north west of the site. Olsson has been on-site to get proctors. Will be out testing at the end of the week. Stewart Legg is the Project Manager for Olsson.
PW-Misc
Informational
05/07/2018
Tom Chandler 05/01/2018 11:14 AM Contractor cutting grade at the northwest corner of the site and placing fill at the sediment basin at the southwest corner of the site. Olsson testing today as well.
PW-Misc
Informational
05/07/2018
Tom Chandler 05/07/2018 3:49 PM Cutting grade on the north end of the site. Olsson was on-site 5/4/2018 and 5/5/2018 for testing of fill.
Grading/Excavation/Fill Inspection Partial 5/10/2018 at 1:00 PM 05/10/2018
PW-Misc
Informational
05/07/2018
Tom Chandler 04/19/2018 10:58 AM Begin excation of the sediment basin on the northeast corner of the site.
PW-Misc
Informational
05/07/2018
Tom Chandler 04/24/2018 1:39 PM Began construction of the sediment basin at the south west area of the site. Installed stand pipe and skimmer on the basin at the north east of the site.
PW-Misc
Informational
05/07/2018
Tom Chandler 04/25/2018 10:51 AM Stand pipe and skimmer installed on the sediment basin at the south west of the site. Rock check dams installed at the basin on the north west of the site. Olsson has been on-site to get proctors. Will be out testing at the end of the week. Stewart Legg is the Project Manager for Olsson.
PW-Misc
Informational
05/07/2018
Tom Chandler 05/01/2018 11:14 AM Contractor cutting grade at the northwest corner of the site and placing fill at the sediment basin at the southwest corner of the site. Olsson testing today as well.
PW-Misc
Informational
05/07/2018
Tom Chandler 05/07/2018 3:49 PM Cutting grade on the north end of the site. Olsson was on-site 5/4/2018 and 5/5/2018 for testing of fill.
PW-Misc
Informational
05/10/2018
Tom Chandler 05/10/2018 4:32 PM Contractor grading and placing fill this week. Olsson testing has been on-site everyday this week.
Grading/Excavation/Fill Inspection Partial 5/17/2018 at 8:00 AM 05/17/2018
PW-Misc
Informational
05/10/2018
Tom Chandler 04/19/2018 10:58 AM Begin excation of the sediment basin on the northeast corner of the site.
PW-Misc
Informational
05/10/2018
Tom Chandler 04/24/2018 1:39 PM Began construction of the sediment basin at the south west area of the site. Installed stand pipe and skimmer on the basin at the north east of the site.
PW-Misc
Informational
05/10/2018
Tom Chandler 04/25/2018 10:51 AM Stand pipe and skimmer installed on the sediment basin at the south west of the site. Rock check dams installed at the basin on the north west of the site. Olsson has been on-site to get proctors. Will be out testing at the end of the week. Stewart Legg is the Project Manager for Olsson.
PW-Misc
Informational
05/10/2018
Tom Chandler 05/01/2018 11:14 AM Contractor cutting grade at the northwest corner of the site and placing fill at the sediment basin at the southwest corner of the site. Olsson testing today as well.
PW-Misc
Informational
05/10/2018
Tom Chandler 05/07/2018 3:49 PM Cutting grade on the north end of the site. Olsson was on-site 5/4/2018 and 5/5/2018 for testing of fill.
PW-Misc
Informational
05/10/2018
Tom Chandler 05/10/2018 4:32 PM Contractor grading and placing fill this week. Olsson testing has been on-site everyday this week.
PW-Misc
Informational
05/17/2018
Tom Chandler 05/17/2018 8:36 AM Contractor grading the east side of the site.
PW-Misc
Corrective Action Required
05/24/2018
Tom Chandler 05/24/2018 4:35 PM Contractor has been working on site grading on the south east section of the project.
Sanitary Sewer Construction Inspection Partial 5/17/2018 at 8:30 AM 05/17/2018
Informational
05/17/2018
Tom Chandler 05/17/2018 8:39 AM Contractor began sanitary sewer main construction today. Begin construction at MH 1-1.
Sanitary Sewer Construction Inspection Partial 5/17/2018 at 2:00 PM 05/23/2018
Informational
05/23/2018
There seems to be an issue with MH 1-2. The changes made to the manhole do not seem to allow for an acceptable invert to be installed. The outside drop was to be eliminated. The new flow lines seem to conflict with what was an acceptable solution. Had conversations with Kent Monter, Dawn Bell, and Ryan Elam. Waiting to confirm an acceptable solution.
Sanitary Sewer Construction Inspection Partial 5/18/2018 at 9:30 AM 05/23/2018
Informational
05/23/2018
Met with David Slaten and Jonathan Myers with ESS on-site to discuss MH 1-2. Jonathan agreed that an acceptable invert was not possible. He stated they would remove the base and install an acceptable base approved by Water Utilities.Waiting to hear back from Jeff Thorne on acceptable solution.
Sanitary Sewer Construction Inspection Partial 5/22/2018 at 9:00 AM 05/23/2018
Informational
05/23/2018
Began installing sanitary sewer main line 1 today at MH 1-3.
Sanitary Sewer Construction Inspection Partial 5/22/2018 at 2:00 PM 05/23/2018
Informational
05/23/2018
Installed sanitary sewer main line 1 up to MH 1-4. Installed service stubs for lots 9,10 and 11. Installed anode, tracer wire and trench checks as well.
Sanitary Sewer Construction Inspection Partial 5/23/2018 at 9:00 AM 05/24/2018
Informational
05/24/2018
Installed sanitary sewer main line 1 up to MH 1-5. Installed sanitary sewer main line 3 up to MH 3-1.
Miscellaneous PWORKS Inspection Passed 5/23/2018 at 9:00 AM 05/24/2018
PW-Clean mud from street
Resolved
04/19/2018
Clean all mud from the street. Preventative measures must be taken to prevent this from reoccurring. Tom Chandler 04/09/2018 10:58 AM Spoked to Travis Ruf on-site this morning about the project as well. Summit Custom Homes intentions are to work on-site with the approved plans including the on-site sanitary sewer main prior to constructing the off-site sanitary sewer main. There are (2) seperate engineers for the systems and minimum slopes for part of the system as well.
PW-Clean mud from street
Resolved
05/24/2018
Clean all mud from the street. Preventative measures must be taken to prevent this from reoccurring. Tom Chandler 05/23/2018 9:58 AM Mud tracked out onto Hook Rd. Contractor is shoveling off large chuncks of mud and will have a sweeper out later for the rest. Contacted Travis Ruf with Summit Homes as well. If this continues to be an issue a stop work order may be issued. Tom Chandler 05/24/2018 11:04 AM Contractor cleaned and swept road immediately. They spoke to all of the crews working on-site and sub-contractors delivering to the site to minimize any problems in the future of the construction project. Dan Harper visited the site yesterday at 2:00PM as well.
Sanitary Sewer Construction Inspection Partial 5/24/2018 at 9:00 AM 05/24/2018
Informational
05/24/2018
Tom Chandler 05/24/2018 11:02 AM Contractor installing sanitary sewer main line 1 & 3 this morning. Tom Chandler 05/24/2018 4:36 PM Installed sanitary sewer main line 1 up to station 15+50. Installed wyes, laterals, tracer wire and trench checks for all laterals up to that point. Installed sanitary sewer main line 3 up to station 13+00. Installed wyes, laterals, tracer wire and trench checks for all laterals to that point.
Erosion Control Inspection Passed 5/25/2018 at 8:30 AM 05/29/2018
Informational
05/29/2018
Tom Chandler 05/29/2018 7:16 AM Rained 3.5 inches overnight Thursday into Friday morning 5/25/2018. Site looks good and any repairs needed will be done on Tuesday 5/29/2018. Water was ponding on Hook road. Public Works operations came out to work on the shoulder in ROW to address this on Friday. The ponding had nothing to do with the developement project going on. Took pictures of existing condition that existed.
Grading/Excavation/Fill Inspection Partial 5/29/2018 at 10:30 AM 05/29/2018
PW-Misc
Informational
05/17/2018
Tom Chandler 04/19/2018 10:58 AM Begin excation of the sediment basin on the northeast corner of the site.
PW-Misc
Informational
05/17/2018
Tom Chandler 04/24/2018 1:39 PM Began construction of the sediment basin at the south west area of the site. Installed stand pipe and skimmer on the basin at the north east of the site.
PW-Misc
Informational
05/17/2018
Tom Chandler 04/25/2018 10:51 AM Stand pipe and skimmer installed on the sediment basin at the south west of the site. Rock check dams installed at the basin on the north west of the site. Olsson has been on-site to get proctors. Will be out testing at the end of the week. Stewart Legg is the Project Manager for Olsson.
PW-Misc
Informational
05/17/2018
Tom Chandler 05/01/2018 11:14 AM Contractor cutting grade at the northwest corner of the site and placing fill at the sediment basin at the southwest corner of the site. Olsson testing today as well.
PW-Misc
Informational
05/17/2018
Tom Chandler 05/07/2018 3:49 PM Cutting grade on the north end of the site. Olsson was on-site 5/4/2018 and 5/5/2018 for testing of fill.
PW-Misc
Informational
05/17/2018
Tom Chandler 05/10/2018 4:32 PM Contractor grading and placing fill this week. Olsson testing has been on-site everyday this week.
PW-Misc
Informational
05/17/2018
Tom Chandler 05/17/2018 8:36 AM Contractor grading the east side of the site.
PW-Misc
Informational
05/29/2018
Tom Chandler 05/29/2018 2:57 PM Contractor continues to grade/fill on south east section of site. Olsson on-site for testing of fill as well.
Sanitary Sewer Construction Inspection Partial 5/29/2018 at 2:00 PM 05/29/2018
Informational
05/29/2018
Tom Chandler 05/29/2018 3:00 PM Contractor installing sanitary sewer main lines 1 and 3. Installed main line 1 up to station 21+82. Installed MH 1-6. Installed service stubs for lots 3,4 and 95. Installed tracer wire and trench checks as well. Installed main line 3 up to station 13+28. Installed service stubs for lots 80-82 and 91-93. Installed tracer wire and trench checks as well. Olsson on-site for testing of backfill as well.
Sanitary Sewer Construction Inspection Partial 5/30/2018 at 10:00 AM 05/30/2018
Informational
05/30/2018
Tom Chandler 05/30/2018 4:49 PM Contractor installing sanitary sewer main line 1 and 3 today. Stacked out MH 1-6. Replacement manhole 1-2 was cored for 3 flow lines coming in. A-Lok boots installed as well.
Sanitary Sewer Construction Inspection Partial 5/30/2018 at 2:30 PM 05/30/2018
Informational
05/30/2018
Tom Chandler 05/30/2018 4:52 PM Installed replacement MH 1-2 this afternoon. Began installing main line 1 going towards MH 1-3. Installed main line 3 up to station 14+68. Installed service stubs for lots 83,84,89 and 90. Installed tracer wire and trench checks as well. Olsson on-site for testing of backfill in ROW and street crossings. Sanitary sewer marker tape being installed as well.
Sanitary Sewer Construction Inspection Partial 5/31/2018 at 10:45 AM 05/31/2018
Informational
05/31/2018
Tom Chandler 05/31/2018 5:06 PM Contractor installing sanitary sewer main line 3 and 4 today.
Sanitary Sewer Construction Inspection Partial 5/31/2018 at 2:30 PM 05/31/2018
Informational
05/31/2018
Tom Chandler 05/31/2018 5:07 PM Contractor installed line 3 up to station 16+03. Installed MH 3-2. Installed wyes and service stubs for lots 85-88. Installed tracer wire and trench checks as well. Installed line 4 up to station 11+28. Installed service wye and stub for lot 78. Installed tracer wire and trench check as well. Olsson on-site for testing as well.
Sanitary Sewer Construction Inspection Partial 6/1/2018 at 9:00 AM 06/01/2018
Informational
06/01/2018
Tom Chandler 06/01/2018 10:02 AM Installing sanitary sewer main line 4 today. Poured inverts this morning. Inverts have been completed for MH 1-3, 1-4, 1-5 and MH 3-1 and 3-2.
Sanitary Sewer Construction Inspection Partial 6/1/2018 at 2:30 PM 06/01/2018
Informational
06/01/2018
Tom Chandler 06/01/2018 4:34 PM Installed sanitary sewer main line 1 up to station 22+49. Installed service wye and stub for lot 1. Installed tracer wire and trench check as well. Installed main line 4 up to station 13+59. Installed MH 4-2. Installed service wyes and stubs for lots 41,42 and 75-77. Installed tracer wire and trench checks as well.
Sanitary Sewer Construction Inspection Partial 6/4/2018 at 9:00 AM 06/05/2018
Informational
06/05/2018
Working on sanitary sewer main line 4 and 1 this morning.
Sanitary Sewer Construction Inspection Partial 6/4/2018 at 2:45 PM 06/05/2018
Informational
06/05/2018
Installed sanitary sewer main line 4 up to station 16+35. Installed MH 4-3. Installed wyes and service stubs for lots 43-45 and lots 72-74. Installed tracer wire and trench checks as well. Installed sanitary sewer main up to MH 1-7 and finished lateral for lot 1. Begin installing sanitary sewer main line 2 and stopped at station 11+25. Installed service wye and stub for tract C.
Sanitary Sewer Construction Inspection Partial 6/5/2018 at 10:30 AM 06/05/2018
Informational
06/05/2018
Tom Chandler 06/05/2018 5:08 PM Working on sanitary sewer main line 2 and line 7 today.
Sanitary Sewer Construction Inspection Partial 6/5/2018 at 2:30 PM 06/05/2018
Informational
06/05/2018
Tom Chandler 06/05/2018 6:01 PM Installed sanitary sewer main line 7 up to station 11+70. Installed MH 7-1. Installed service wyes for lots 65-67. Installed main line 2 up to station 13+00. Olsson on-site all this week for testing of backfill as well.
Sanitary Sewer Construction Inspection Partial 6/6/2018 at 7:10 AM 06/06/2018
Informational
06/06/2018
Tom Chandler 06/06/2018 8:09 AM Contractor working on sanitary sewer main line 2 and 7 this morning. Alot of rock has been excavated from line 2. Spoke to contractor about proper backfill and provided copy of section 2100 of the Design and Construction manual.
Sanitary Sewer Construction Inspection Partial 6/6/2018 at 2:30 PM 06/07/2018
Informational
06/07/2018
Installed sanitary sewer main line 2 up to station 15+80. Installed service stubs for lots 96-100 as well. Installed tracer wire and trench check. Installed service stubs for lots 65-67 with tracer wire and trench checks. Installed sanitary sewer main line 4 up to station 17+00. Installed wyes for lots 46 and 47. Installed outside drop for MH 4-3.
Sanitary Sewer Construction Inspection Partial 6/7/2018 at 9:30 AM 06/07/2018
Informational
06/07/2018
Tom Chandler 06/07/2018 5:43 PM Installing sanitary sewer main line 2 and 4 today. Emailed Melissa with Olsson about utility located on property line. No easements at this time for those utilities. Proposing to move utilities and end of road to the west.
Sanitary Sewer Construction Inspection Partial 6/7/2018 at 2:30 PM 06/07/2018
Informational
06/07/2018
Tom Chandler 06/07/2018 5:47 PM Installed up to station 19+77 on sanitary sewer main line 4. Installed wyes for lots 31,49 and 64. Installed sanitary sewer main line 2 up to station 16+50. Installed MH 2-2. Poured inverts for MH 1-6, MH 2-1, MH 4-2 and MH 4-3. Poured cradle for drop MH 4-3.
Sanitary Sewer Construction Inspection Partial 6/8/2018 at 3:00 PM 06/09/2018
Informational
06/09/2018
06/08/2018 Brian Byrd was overseeing project in the morning. Contractor installed up to station 18+66 on line 2. Installed MH 2-3 and 2-4. Installed wye and service stub for lot 58 with tracer wire and trench check. Installed line 4 up to station 20+05. Installed service stubs for lots 31 and 49. Installed tracer wire and trench check as well.
Sanitary Sewer Construction Inspection Partial 6/9/2018 at 7:15 AM 06/09/2018
Informational
06/09/2018
Contractor working on sanitary sewer main line 2 and 6 this morning. Awaiting answer on where to install MH 4-4.
Sanitary Sewer Construction Inspection Partial 6/9/2018 at 1:00 PM 06/09/2018
Informational
06/09/2018
Tom Chandler 06/09/2018 1:38 PM Installed line 2 up to station 19+92. Installed MH 2-5. Installed wyes and service stubs for lots 56 and 57. Installed tracer wire and trench checks. Installed line 6 up to station 11+10. Installed wyes for lots 15,16 and 40. Installed service stubs for lot 15 and 40. Installed tracer wire and trench checks. Olsson on-site for backfill testing as well.
Sanitary Sewer Construction Inspection Partial 6/11/2018 at 10:45 AM 06/11/2018
Informational
06/11/2018
Tom Chandler 06/11/2018 11:17 AM Contractor workin on sanitary main line 2 and 6 today.
Storm Sewer Construction Inspection Partial 6/11/2018 at 10:45 AM 06/11/2018
Informational
06/11/2018
Tom Chandler 06/11/2018 11:19 AM Contractor has 3rd crew on-site to begin installation of the Storm sewer system.
Storm Sewer Construction Inspection Partial 6/11/2018 at 2:00 PM 06/11/2018
Informational
06/11/2018
Tom Chandler 06/11/2018 6:24 PM Installed 150 L/F of 18" HDPE. Did not install ES 1-1. Will continue on line 1 tomorrow. Backfilled and plugged end in case of rain.
Sanitary Sewer Construction Inspection Partial 6/11/2018 at 2:00 PM 06/11/2018
Informational
06/11/2018
Tom Chandler 06/11/2018 6:27 PM Installed sanitary sewer main line 2 up to station 21+40. Installed service wyes for lots 54,55,59 and 60. Installed service stubs and tracer wire along with trench checks as well. Backfilled and tested in road crossings. Installed sanitary sewer main line 6 up to station 13+30. Installed service wyes and laterals for lots 16-19. Installed tracer wire and trench checks. Backfilled testing by olsson as well.
Storm Sewer Construction Inspection Partial 6/12/2018 06/18/2018
Informational
06/18/2018
Brian Byrd was watching project today while I was gone. Contractor installed Storm line 1 up to station 13+48. Installed MH 1-2, CI 1-3 and CI 1-4. Installed 145 L/F of 18" HDPE and 38 L/F of 15" HDPE. Backfilled and tested in roadway.
Sanitary Sewer Construction Inspection Partial 6/12/2018 06/18/2018
Informational
06/18/2018
Brian Byrd was covering my projects while I was out of the office. Contractor installed sanitary sewer main line 2 up to station 23+ 60. Installed MH 2-5 and 2-6. Installed service wyes as well. Poured invert 2-5. Installed 98 L/F of 8" PVC. Installed sanitary sewer main line 6 up to station 15+ 25. Installed MH 6-1 and 6-2. Installed 150 L/F of 8" PVC.
Sanitary Sewer Construction Inspection Partial 6/13/2018 06/18/2018
Informational
06/18/2018
Brian Byrd was covering my projects while I was out of the office. Contractor installed service laterals for lots 20-22,50-53 and 61-63. Installed trench checks and tracer wire as well.
Sanitary Sewer Construction Inspection Partial 6/14/2018 06/18/2018
Informational
06/18/2018
Began installing sanitary sewer line 8. Installed 88 L/F of 8" PVC pipe and service wye for lot 71.
Sanitary Sewer Construction Inspection Partial 6/15/2018 06/18/2018
Informational
06/18/2018
Installed 70 L/F of 8" sanitary sewer line. Installed service wye for lot 70.
Storm Sewer Construction Inspection Partial 6/14/2018 06/18/2018
Informational
06/18/2018
Installing storm sewer line 3. Installed ES 3-1 and 42 L/F of 30" HDPE. Installed MH 3-2 and 134 L/F of 24" HDPE. Installed CI 3-3 and poured toe wall for ES 3-1.
Storm Sewer Construction Inspection Partial 6/15/2018 06/18/2018
Informational
06/18/2018
Installed 62 L/F of 18" HDPE and MH 3-4. Installed 34 L/F of 15" HDPE and CI 4-1.
Sanitary Sewer Construction Inspection Partial 6/16/2018 06/18/2018
Informational
06/18/2018
Installed 135 L/F of 8" PVC. Installed service wyes for lots 68 and 69. Installed service laterals for lots 68-71. Installed tracer wire and trench checks. Installed MH 8-1.
Storm Sewer Construction Inspection Partial 6/16/2018 06/18/2018
Informational
06/18/2018
Poured collars and inverts for MH 3-2 and CI 3-3 and CI 4-1.
Sanitary Sewer Construction Inspection Partial 6/18/2018 06/18/2018
Informational
06/18/2018
Tom Chandler 06/18/2018 4:35 PM Installed up to station 13+75 on sanitary sewer line 5. Installed service wyes for lots 35-39 and lots 23 and 24. Installed MH 5-1.
Storm Sewer Construction Inspection Partial 6/18/2018 06/18/2018
Informational
06/18/2018
Tom Chandler 06/18/2018 4:48 PM Installed FI 16-1 and installed 84 L/F of 15" RCP. Installed the base section of RB 16-2. Installed ES 14-1 and 101 L/F of 15" HDPE and CI 14-2 and CI 14-3. Poured collars and inverts as well. Rip rap not installed as this is a retention basin.
Sanitary Sewer Construction Inspection Partial 6/19/2018 06/23/2018
Informational
06/23/2018
Brian Byrd was covering the project today. Contractor installed 98 L/F of 8" SDR 26 PVC for MH 5-1 to MH 5-2. Installed service line for lot 25 and 35.
Sanitary Sewer Construction Inspection Partial 6/20/2018 06/23/2018
Informational
06/23/2018
Brian Byrd was covering project today. Contractor installed line 5 up to station 14+75. Installed service laterals for lots 26,33 and 34.
Sanitary Sewer Construction Inspection Partial 6/21/2018 at 2:30 PM 06/23/2018
Informational
06/23/2018
Tom Chandler 06/21/2018 Contractor installed line 5 up to station 17+04. Installed MH 5-2. Installed service laterals for lots 27 and 32. Tracer wire and trench checks installed as well.
Sanitary Sewer Construction Inspection Partial 6/22/2018 at 2:15 PM 06/23/2018
Informational
06/23/2018
Tom Chandler 06/23/2018 7:40 AM Contractor installed line 5 up to station 17+98. Installed MH 5-3. Installed service laterals for lots 29 and 30. Installed tracer wire and trench checks as well. Line 5 is complete.
Storm Sewer Construction Inspection Partial 6/19/2018 06/23/2018
Informational
06/23/2018
Brian Byrd was covering the project. Contractor installed Storm structure 5-3. Installed 106 L/F of 24" HDPE for MH 5-3 to CI 5-4 and installed 35 L/F of 18" HDPE to CI 5-5. Installed sturctures 5-3 thru 5-5. Installed 196 L/F of 30" HDPE from MH 5-3 to MH 6-0.
Storm Sewer Construction Inspection Partial 6/20/2018 06/23/2018
Informational
06/23/2018
Brian Byrd covering my project. Contractor installed 65 L/F of 30" HDPE to CI 6-1. Installed 43 L/F of 30" HDPE to CI 6-2 and 69 L/F of 30" HDPE TO FI 6-3. Poured collars and inverts at end of day.
Storm Sewer Construction Inspection Partial 6/21/2018 at 2:30 PM 06/23/2018
Informational
06/23/2018
Tom Chandler 06/21/2018 Contractor installed 140.5 L/F of 24" HDPE to FI 6-4. Installed 171.5 L/F of 24" HDPE to FI 6-5.
Storm Sewer Construction Inspection Partial 6/22/2018 at 2:15 PM 06/23/2018
Informational
06/23/2018
Tom Chandler 06/23/2018 8:13 AM Contractor poured collars and inverts this morning for structures on line 6. Installed 232 L/F of 24" HDPE to MH 6-6. Installed 32 L/F of 18" HDPE to CI 6-7. Poured collars and inverts in the afternoon for remaining structures.
Water Line - Construction Inspection Partial 6/25/2018 06/23/2018
Informational
06/23/2018
Tom Chandler 06/23/2018 8:19 AM Contractor to begin installing water main on Monday. Plans were given to Jay with ESS on Thursday afternoon 6/21/2018. Met with Jay and Jordan about requirements and specs. No questions at that time.
Erosion Control Inspection Partial 6/25/2018 at 8:20 AM 06/25/2018
PW-Misc
Informational
04/19/2018
Tom Chandler 04/19/2018 10:46 AM Installed some silt fence. Mulch berms and rock check dams will be installed this week as well.
Informational
06/25/2018
Tom Chandler 06/25/2018 11:28 AM Contractor not working today. Rained out. ESC devices installed and functioning properly.
Water Line - Construction Inspection Partial 7/2/2018 at 9:30 AM 07/02/2018
Informational
07/02/2018
Tom Chandler 07/02/2018 12:15 PM Talked to Reese with ESS this morning about water main line 1 along SW Arboridge Drive. Plans do not call for any bends to be installed. Informed him fittings would need to added if they could not install the line without exceeding allowable limits for deflection in the joints. Pipe shall not be deflected. He stated they had extra fittings on-site as well. Line 1 will be moved to the east to miss driveway across Hook road to the north for the tie-in to existing 8" water main.
Water Line - Construction Inspection Partial 7/5/2018 at 1:00 PM 07/05/2018
Informational
07/05/2018
Tom Chandler 07/05/2018 1:07 PM Contractor working on 8" water main line 2 today. Installed from station 13+75 to station 17+50. Installed tee and gate valve at station 15+11. Installed tee for straight set hydrant at station 17+30. Will install thrust blocks this afternoon. Installed tracer wire and marker tape. Sprayed bolts and wrapped all fittings with 12mil poly.
Water Line - Construction Inspection Partial 7/3/2018 07/05/2018
Informational
07/05/2018
Tom Chandler 07/03/2018 Began working on 8" water main line 2 today. Installed from station 11+00 to station 14+00. Installed 11.25 bend at station 11+19 with thrust block. Installed 22.5 bend at station 11+59 with thrust block. Installed 22.5 bend at station 12+42 with thrust block. Installed 8" tee at station 12+80 with thrust block. Installed 22.5 bend at station 13+13 with thrust block. Installed tee for straight set hydrant at station 13+59. Installed tracer wire and marker tape as well. Sprayed bolts and wrapped fittings with 12mil blue poly wrap.
Water Line - Construction Inspection Partial 7/5/2018 at 2:45 PM 07/05/2018
Informational
07/05/2018
Tom Chandler 07/05/2018 3:03 PM Hit rock on water main line 2 and stopped. Began working on 8" water main line 4 at station 10+00. Installed 22.5 bend at station 11+26. Installed tee at station 11+90. Installed tracer wire and marker tape as well.
Storm Sewer Construction Inspection Partial 6/26/2018 07/18/2018
Informational
07/18/2018
6/26/2018 Brian Byrd covering projects. Installed 167 L/F of 15" HDPE and CI 6-8. Installed 35 L/F of 18" HDPE and CI 13-1. Installed 171 L/F of 24" HDPE and CI 7-1. Poured collars and inverts.
Storm Sewer Construction Inspection Partial 6/27/2018 07/18/2018
Informational
07/18/2018
6/27/2018 Brian Byrd covering projects today. Installed 35 L/F of 24" HDPE and CI 7-2. Installed 118 L/F of 15" HDPE and CI 8-1. Poured collars and inverts.
Storm Sewer Construction Inspection Partial 6/28/2018 07/18/2018
Informational
07/18/2018
6/28/2018 Brian Byrd covering projects today. Installed 219 L/F of 15" HDPE and CI 7-3. Installed 151 L/F of 36" HDPE and CI 11-1. Poured collars and inverts.
Storm Sewer Construction Inspection Partial 6/29/2018 07/18/2018
Informational
07/18/2018
6/29/2018 Installed 332 L/F of 30" HDPE and CI 11-2 and CI 11-3. Will pour collars and inverts tomorrow.
Storm Sewer Construction Inspection Partial 6/30/2018 07/18/2018
Informational
07/18/2018
6/30/2018 Installed 43 L/F of 24" HDPE and CI 9-2. Installed 47 L/F of 18" HDPE and MH 9-3. Poured collars and inverts. Poured collars and inverts for CI 11-2 and CI 11-3 as well.
Storm Sewer Construction Inspection Partial 7/2/2018 07/19/2018
Informational
07/19/2018
7/2/2018 Installed 130 L/F of 24" HDPE and MH 10-1.
Storm Sewer Construction Inspection Partial 7/3/2018 07/19/2018
Informational
07/19/2018
7/3/2018 Installed 141 L/F of 18" HDPE and FI 9-4. Installed 270 L/F 24" HDPE and FI 10-2 and FI 10-3. Poured collars and inverts. Poured collars and inverts for MH 10-1 as well.
Storm Sewer Construction Inspection Partial 7/5/2018 07/19/2018
Informational
07/19/2018
7/5/2018 247 L/F of 18" HDPE and FI 9-5.
Storm Sewer Construction Inspection Partial 7/6/2018 07/19/2018
Informational
07/19/2018
7/6/2018 133 L/F of 15" HDPE and CI 12-1. Installed 138 L/F 15" HDPE and CI 9-6. Poured collars and inverts for 9-5, 9-6 and 12-1. Installed line 12.
Storm Sewer Construction Inspection Partial 7/9/2018 07/19/2018
Informational
07/19/2018
7/9/2018 Installed 254 L/F of 24" HDPE and MH 10-1 and FI 10-2. Poured collars and inverts.
Storm Sewer Construction Inspection Partial 7/10/2018 07/19/2018
Informational
07/19/2018
7/10/2018 Installed ES 15-1 and 102 L/F of 60" RCP. Installed DB 15-2 and 22 L/F of 12" RCP. Installed DB 15-3 and poured collars and inverts.
Miscellaneous PWORKS Inspection Partial 7/19/2018 at 10:00 AM 07/19/2018
Informational
07/19/2018
Tom Chandler 07/19/2018 10:58 AM Water Utilities finished test shutdown. Will install door hangers this afternoon for water shutdown on 7/23/2018 starting at 8:00AM.
Miscellaneous PWORKS Inspection Passed 7/20/2018 at 8:00 AM 07/20/2018
Informational
07/20/2018
Tom Chandler 07/20/2018 3:38 PM Door hangers have been completed for water shutdown on Monday 7/23/2018
Water Service Line - Abandonment Passed 7/23/2018 at 9:00 AM 07/23/2018
Informational
07/23/2018
Service line abandoned at the main with clamp provided by water utilities. Line pressured back up and inspected for leaks.
Water Line - Coliform Test 1 Partial 8/1/2018 at 9:30 AM 08/01/2018
Informational
08/01/2018
Tom Chandler 08/01/2018 12:09 PM Took day 1 samples. Will take day 2 samples tomorrow if day 1 passes.
Sanitary Sewer Construction Inspection Failed 8/2/2018 08/02/2018
PW-Sanitary Sewer Testing
Corrective Action Required
08/02/2018
Sanitary Sewer Testing needs to be completed. Tom Chandler 08/02/2018 11:21 AM Air/Mandrel testing failed on sections from MH 6-1 to MH 1-2, MH 6-1 to MH 5-1 and MH 6-1 to 6-2. Failed for sections MH 4-1 to MH 4-2 and sections from MH 2-1 to MH 2-2. These will need to be repaired and backfilled. Will need to wait the 30 day period and retest these sections. After the testing is complete a video inspection will be done by Water Utilities for final approval of the sanitary main.
Storm Sewer Construction Inspection Failed 8/2/2018 08/02/2018
PW-Install steps in storm box
Corrective Action Required
08/02/2018
Steps need to be installed for all storm boxes. Tom Chandler 08/02/2018 11:27 AM The steps installed on the storm sewer boxes do not meet specs according to the approved product list and need to be corrected.
Water Line - Coliform Test 1 Passed 8/2/2018 at 12:30 PM 08/02/2018
Informational
08/02/2018
Tom Chandler 08/02/2018 1:22 PM Day 1 water samples passed. Will take Day 2 samples this afternoon.
Water Line - Coliform Test 2 Partial 8/2/2018 at 1:30 PM 08/02/2018
Informational
08/02/2018
Tom Chandler 08/02/2018 1:24 PM Taking Day 2 samples this afternoon. Day 1 samples have passed.
Water Line - Construction Taps Removed Passed 8/8/2018 08/09/2018
Informational
08/09/2018
Construction taps removed and repair clamps supplied by water utilities were installed. Tested under pressure to check for leaks.
Water Line - Construction Inspection Passed 8/8/2018 08/09/2018
Informational
08/09/2018
Contractor performed tie-in to existing water main. All test have passed and emailed lab results to water utilities. Line was flushed after tie-in was completed.
Water Line - Coliform Test 2 Passed 8/3/2018 08/09/2018
Informational
08/09/2018
Day 2 samples passed. Contractor to tie-in water main next week.
Storm - Pipe Partial 8/10/2018 08/13/2018
PW-Misc
Informational
08/13/2018
John DiMauro 08/13/2018 3:15 PM Ron Paynter, Joe Starlin and I made two site visits AM & PM to inspect the under road storm drains. The crew had the trenches dug, the fabric installed and the 6" perforated pipe on site. When we left in the afternoon they were in the process of installing the rock bedding and pipe.
Pavement-Stabilized Subgrade Partial 8/13/2018 at 2:00 PM 08/14/2018
Informational
08/14/2018
Tom Chandler 08/14/2018 11:27 AM Project manager from ESS called in the morning to inform me that Seal-O-Matic was going to begin to subgrade stabilization later this morning. Went out to site and took video of the operation. Olsson testing on-site as well.
Sanitary Sewer - Mandrel Partial 7/25/2018 08/15/2018
Informational
08/15/2018
Notified contractor the 30 day period is complete and can begin testing.
Sanitary Sewer - Mandrel Partial 7/30/2018 08/15/2018
Informational
08/15/2018
7/30/2018 Began mandrel testing today. Brian Byrd verifying testing. Tested from MH 1-2 thru MH 1-7. Tested from MH 1-6 to MH 2-1. Tested from MH 2-1 thru MH 2-3. Tested from MH 2-2 to MH 7-1. Tested from MH 4-1 thru MH 4-4. All Mandrel test today passed.
Sanitary Sewer - Mandrel Failed 7/30/2018 08/16/2018
PW-Misc
Corrective Action Required
08/16/2018
7/30/2018 Mandrel test failed from MH 1-2 to MH 4-1.
Sanitary Sewer - Mandrel Partial 8/2/2018 08/16/2018
PW-Misc
Resolved
08/16/2018
7/30/2018 Mandrel test failed from MH 1-2 to MH 4-1. 8/2/2018 Line was dug up and repaired. Will test again in 30 days.
Sanitary Sewer - Mandrel Partial 7/31/2018 08/16/2018
Informational
08/16/2018
7/31/2018 Mandrel testing again today. Tested from MH 2-3 thru MH 2-6. Tested from MH 3-1 thru MH 3-2. Tested from MH 5-2 thru MH 5-3. These test all passed today.
Sanitary Sewer - Mandrel Failed 7/31/2018 08/16/2018
PW-Misc
Corrective Action Required
08/16/2018
7/31/2018 Mandrel test from MH 6-1 to MH 5-1 failed. Test from MH 1-2 to MH 6-1 failed and from MH 6-1 to MH 6-2 failed.
Sanitary Sewer - Mandrel Partial 8/3/2018 08/16/2018
PW-Misc
Resolved
08/16/2018
7/31/2018 Mandrel test from MH 6-1 to MH 5-1 failed. Test from MH 1-2 to MH 6-1 failed and from MH 6-1 to MH 6-2 failed. 8/3/2018 All failed line segments have been dug up and repaired. Will test again in 30 days.
Sanitary Sewer - Vacuum Partial 7/30/2018 08/16/2018
Informational
08/16/2018
7/30/2018 Tested MH 1-2 for 3 min. MH 1-3 for 3 min. MH 1-4 for 2.5 min. MH 1-6 for 3 min. MH 1-7 for 2.5 min. MH 2-1 for 2.5 min. MH 2-2 for 2.5 min. MH 4-1 for 2.5 min. MH 4-2 for 2.5 min. MH 4-3 for 3 min. MH 7-1 for 2.5 min and MH 8-1 for 2.5 min.
Sanitary Sewer - Vacuum Failed 7/30/2018 08/16/2018
PW-Misc
Corrective Action Required
08/16/2018
7/30/2018 Vacuum testing for MH 4-4 failed. Tested for 2.5 min.
Sanitary Sewer - Vacuum Partial 8/3/2018 08/16/2018
PW-Misc
Resolved
08/16/2018
7/30/2018 Vacuum testing for MH 4-4 failed. Tested for 2.5 min. 8/3/2018 Repairs have been made. Backfilled and tested again. Passed test.
Sanitary Sewer - Vacuum Partial 7/31/2018 08/16/2018
Informational
08/16/2018
7/31/2018 Vacuum testing again today. Tested MH 2-3 for 3 min. MH 2-4 for 2.5 min. MH 2-5 for 2.5 min. MH 2-6 for 2.5 min. MH 3-1 for 2.5 min. MH 3-2 for 2.5 min. MH 6-1 for 2.5 min. and MH 6-2 for 3 min.
Sanitary Sewer - Vacuum Failed 7/31/2018 08/16/2018
PW-Misc
Corrective Action Required
08/16/2018
7/31/2018 Vacuum testing failed for MH 5-1,MH 5-2 and MH 5-3.
Sanitary Sewer - Vacuum Passed 8/3/2018 08/16/2018
PW-Misc
Resolved
08/16/2018
7/31/2018 Vacuum testing failed for MH 5-1,MH 5-2 and MH 5-3. 8/3/2018 Repairs have been made and backfilled. Tested again for 2.5 minutes for each MH.
Sanitary Sewer - Air Test Partial 7/30/2018 08/16/2018
Informational
08/16/2018
7/30/2018 Air testing began today. Tested each segment from MH 1-2 thru MH 1-7 for 7 minutes and 34 seconds. Each segment passed. Tested segment from MH 1-6 to MH 2-1 for 9 minutes and 18 seconds and passed that segment. Tested from MH 4-2 to MH 4-3 for 7 minutes and 34 seconds and passed. Tested from MH 4-3 to MH 4-4 for 10 minutes and 48 seconds.Tested from MH 2-2 to MH 8-1 for 7 minutes and 34 seconds and passed. Tested from MH 4-3 to MH 7-1 for 7 minutes and 34 seconds and passed.
Sanitary Sewer - Air Test Failed 7/30/2018 08/16/2018
PW-Misc
Corrective Action Required
08/16/2018
7/30/2018 Air test failed from MH 2-1 to MH 2-2. Test failed from MH 1-2 to MH 4-1. Tested both sections for 7 minutes and 34 seconds.
Sanitary Sewer - Air Test Partial 8/2/2018 08/16/2018
PW-Misc
Resolved
08/16/2018
7/30/2018 Air test failed from MH 2-1 to MH 2-2. Test failed from MH 1-2 to MH 4-1. Tested both sections for 7 minutes and 34 seconds. 8/2/2018 Repaired broken wyes, backfilled and tested. Will test again in 30 days.
Sanitary Sewer - Air Test Partial 7/31/2018 08/16/2018
Informational
08/16/2018
7/31/2018 Air tested line segments from MH 2-2 thru MH 2-5 for 7 minutes and 34 seconds. All segments passed. Tested from MH 2-5 to MH 2-6 for 9 minutes 18 seconds and passed air test. Tested from MH 1-4 to MH 3-1 for 7 minutes 34 seconds and passed. Tested from MH 3-1 to MH 3-2 for 11 minutes and 48 seconds and passed. Tested from MH 6-1 to MH 5-1 for 7 minutes and 34 seconds and passed. Tested from MH 5-1 to MH 5-2 for 12 minutes and 30 seconds and passed. Tested from MH 5-3 for 7 minutes and 34 seconds and passed. Tested from MH 1-2 thru MH 6-2. Both segments were tested for 7 minutes and 34 seconds and passed.
Erosion Control Inspection Failed 8/17/2018 at 10:15 AM 08/17/2018
PW-Erosion and Sediment Control
Corrective Action Required
08/17/2018
John DiMauro 08/17/2018 11:16 AM Your project is in violation of the Erosion and Sediment control policy. There is debris, mud and silt running off site and onto SW Hook Rd. Please clean the debris and silt from the road and make all necessary corrections to the erosion control devices immediately.
Pavement-Stabilized Subgrade Partial 8/28/2018 at 9:15 AM 08/28/2018
Informational
08/28/2018
Tom Chandler 08/28/2018 3:59 PM Began installing cement stabilization again today. Olsson on-site for testing. Stabilization on SW Arbor Creek drive, SW Arborwood drive, SW Sugar Tree drive, SW Arbor Falls drive, SW Arborvalley drive completed today.
Pavement-Stabilized Subgrade Partial 9/4/2018 09/05/2018
Informational
09/05/2018
Tom Chandler 09/05/2018 1:41 PM 9" stabilized subgrade installed on Arboridge drive.
Pavement-Stabilized Subgrade Passed 9/5/2018 09/11/2018
Informational
09/11/2018
Tom Chandler 09/11/2018 11:33 AM Subgrade stabilization was completed. Olsson performed all testing as well. Will proof roll later prior to MODOT Type 5 installation.
Pavement-Aggregate Base Partial 9/10/2018 at 3:00 PM 09/11/2018
Informational
09/11/2018
Tom Chandler 09/11/2018 11:41 AM Proof rolled from station 10+50 to station 19+00 on SW Arbor Creek Dr. Passed inspection for that section only. The rest of site was not ready for proof roll.
Sanitary Sewer - Air Test Partial 9/14/2018 09/17/2018
Informational
09/17/2018
Tom Chandler 09/17/2018 7:13 AM Air tested lines that were repaired. Tested from MH 1-2 to MH 4-1, from MH 4-1 to MH 4-2, from MH 6-1 to MH 5-1 and from MH 2-1 to MH 2-2. All of these test passed.
PW-Sanitary Sewer Testing
Corrective Action Required
09/17/2018
Sanitary Sewer Testing needs to be completed.Tom Chandler 09/17/2018 7:16 AM Did not air test from MH 1-2 to MH 6-1 and from MH 6-1 to MH 6-2. Mandrel test failed in those sections.
Sanitary Sewer - Mandrel Partial 9/14/2018 09/17/2018
Informational
09/17/2018
Tom Chandler 09/17/2018 7:28 AM Mandrel tested from MH 1-2 to MH 4-1, from MH 4-1 to MH 4-2, from MH 6-1 to MH 5-1 and from MH 2-1 to MH 2-2. Those sections passed mandrel testing.
Sanitary Sewer - Mandrel Failed 9/14/2018 09/17/2018
PW-Misc
Corrective Action Required
09/17/2018
Tom Chandler 09/17/2018 7:31 AM Mandrel testing failed from MH 1-2 to MH 6-1 and from MH 6-1 to MH 6-2. Will need to repair and retest in 30 days after repairs have been made.
Curb - Proof Roll Passed 9/18/2018 at 3:15 PM 09/18/2018
Informational
09/18/2018
Tom Chandler 09/18/2018 4:13 PM Proof rolled for curbs this afternoon. Will begin pouring curbs in the morning.
Public Curb Inspection Partial 9/19/2018 at 9:00 AM 09/19/2018
Informational
09/19/2018
Tom Chandler 09/19/2018 9:28 AM Began installing curb today. KCMMB 4K from Gieger being installed. Olsson on-site for testing this morning as well. Curb machine placing curb and expansion joints installed as well. Will saw cut construction joints later. White cure being applied as well.
Pavement-Aggregate Base Passed 9/11/2018 at 1:00 PM 09/19/2018
Informational
09/19/2018
Tom Chandler 09/11/2018 Proof rolled the remainder of subgrade for the site. Passed proof roll inspection.
Public Curb Inspection Partial 9/19/2018 at 3:00 PM 09/19/2018
Informational
09/19/2018
Tom Chandler 09/19/2018 4:28 PM Poured approximately 200 yds of KCMMB 4K concrete curbs today. Placing all curb today with curb machine. Sprayed white cure and was saw cutting joints this afternoon. Will continue tomorrow.
Public Curb Inspection Partial 9/20/2018 09/21/2018
Informational
09/21/2018
Tom Chandler 09/20/2018 Installing CG-2 curb with machine. Olsson was on-site for testing as well. White cure being applied and will saw cut joints later as well.
Public Curb Inspection Partial 9/21/2018 09/21/2018
Informational
09/21/2018
Tom Chandler 09/21/2018 3:11 PM Forming curb returns today. Plan on pouring tomrrow.
Public Curb Inspection Partial 9/24/2018 09/25/2018
Informational
09/25/2018
Tom Chandler 09/25/2018 2:27 PM Worked on CG-1 curb and gutter yesterday and finsihed today. Will be working on curb returns the rest of the week. Olsson was on-site for testing as well.
Public Curb Inspection Partial 9/28/2018 10/04/2018
Informational
10/04/2018
Tom Chandler 10/04/2018 2:57 PM All curb and gutter installation has been completed. Curb returns completed and (7) day breaks have been received from the lab.
Grading/Excavation/Fill Inspection Partial 10/1/2018 10/04/2018
PW-Misc
Informational
05/29/2018
Tom Chandler 04/19/2018 10:58 AM Begin excation of the sediment basin on the northeast corner of the site.
PW-Misc
Informational
05/29/2018
Tom Chandler 04/24/2018 1:39 PM Began construction of the sediment basin at the south west area of the site. Installed stand pipe and skimmer on the basin at the north east of the site.
PW-Misc
Informational
05/29/2018
Tom Chandler 04/25/2018 10:51 AM Stand pipe and skimmer installed on the sediment basin at the south west of the site. Rock check dams installed at the basin on the north west of the site. Olsson has been on-site to get proctors. Will be out testing at the end of the week. Stewart Legg is the Project Manager for Olsson.
PW-Misc
Informational
05/29/2018
Tom Chandler 05/01/2018 11:14 AM Contractor cutting grade at the northwest corner of the site and placing fill at the sediment basin at the southwest corner of the site. Olsson testing today as well.
PW-Misc
Informational
05/29/2018
Tom Chandler 05/07/2018 3:49 PM Cutting grade on the north end of the site. Olsson was on-site 5/4/2018 and 5/5/2018 for testing of fill.
PW-Misc
Informational
05/29/2018
Tom Chandler 05/10/2018 4:32 PM Contractor grading and placing fill this week. Olsson testing has been on-site everyday this week.
PW-Misc
Informational
05/29/2018
Tom Chandler 05/17/2018 8:36 AM Contractor grading the east side of the site.
PW-Misc
Informational
05/29/2018
Tom Chandler 05/29/2018 2:57 PM Contractor continues to grade/fill on south east section of site. Olsson on-site for testing of fill as well.
PW-Misc
Informational
10/04/2018
Tom Chandler 10/04/2018 3:00 PM Contrator began backfilling of curb and gutters.
Miscellaneous PWORKS Inspection Passed 10/4/2018 at 11:00 AM 10/04/2018
Informational
10/04/2018
Tom Chandler 10/04/2018 3:03 PM Received complaints on Wednesday 10/3/2018 about dust leaving the site and poor visibilty on Hook road. Contractor was grading and there were extremely high winds in the afternoon. I was testing at another site all day on Wednesday and did not go by this site. I wasn't notified about the issue until Thursday 10/4/2018 mid morning. I talked to Jonathan Myers with ESS about the issue. They have a water truck on-site to minimize any issues. He understood that it is the contractors' responsibility to minimize dust,debris and silt from leaving the site during construction.
Pavement-Proof Roll Passed 10/18/2018 at 2:30 PM 10/19/2018
Informational
10/19/2018
Tom Chandler 10/19/2018 1:04 PM Proof rolled entire project. Asphalt to be installed beginning on Monday 10/22/2018.
Sanitary Sewer - Mandrel Failed 4/9/2019 04/09/2019
Misc
Corrective Action Required
04/09/2019
John DiMauro 04/09/2019 3:36 PM The inverts for both the dead end MH 6-3 and 6-2 are too high. They could not get the mandrel through. The crew is going to come back at a later date and grind the inverts down then retest at that time.
Sanitary Sewer - Mandrel Passed 4/18/2019 04/26/2019
Misc
Corrective Action Required
04/26/2019
John DiMauro 04/09/2019 3:36 PM The inverts for both the dead end MH 6-3 and 6-2 are too high. They could not get the mandrel through. The crew is going to come back at a later date and grind the inverts down then retest at that time.
Misc
Resolved
04/26/2019
The inverts were repaired and the mandrel has now passed.
Miscellaneous PWORKS Inspection Passed 04/26/2019
PW-Clean mud from street
Corrective Action Required
05/23/2018
Clean all mud from the street. Preventative measures must be taken to prevent this from reoccurring. Tom Chandler 05/23/2018 9:58 AM Mud tracked out onto Hook Rd. Contractor is shoveling off large chuncks of mud and will have a sweeper out later for the rest. Contacted Travis Ruf with Summit Homes as well. If this continues to be an issue a stop work order may be issued.
Sanitary Sewer Construction Inspection Passed 04/26/2019
Water Line - Construction Inspection Passed 04/26/2019
Sanitary Sewer - Mandrel Passed 11/23/2018 04/26/2019
PW-Misc
Corrective Action Required
09/17/2018
Tom Chandler 09/17/2018 7:31 AM Mandrel testing failed from MH 1-2 to MH 6-1 and from MH 6-1 to MH 6-2. Will need to repair and retest in 30 days after repairs have been made.
Sanitary Sewer - Air Test Passed 4/23/2019 04/26/2019
PW-Misc
Informational
04/26/2019
The air tests for all sanitary has passed for on-site has passed including the section that had sags and had to be dug up and re-tested. Steve Robbins 04/26/2019 3:29 PM
Public Curb Inspection Passed 10/24/2018 04/26/2019
Pavement-Proof Roll Passed 04/26/2019
Corrective Action Required
08/16/2018
Corrective Action Required
08/16/2018
Corrective Action Required
08/16/2018
Corrective Action Required
08/16/2018
Corrective Action Required
08/16/2018
Corrective Action Required
08/16/2018
Corrective Action Required
08/16/2018
Corrective Action Required
08/16/2018
Corrective Action Required
08/16/2018
Corrective Action Required
08/16/2018
Corrective Action Required
08/16/2018
Corrective Action Required
08/16/2018
Corrective Action Required
08/16/2018
Corrective Action Required
08/16/2018
Corrective Action Required
08/16/2018
Sanitary Sewer Construction Inspection Passed 8/31/2018 04/26/2019
PW-Sanitary Sewer Testing
Corrective Action Required
08/02/2018
Sanitary Sewer Testing needs to be completed. Tom Chandler 08/02/2018 11:21 AM Air/Mandrel testing failed on sections from MH 6-1 to MH 1-2, MH 6-1 to MH 5-1 and MH 6-1 to 6-2. Failed for sections MH 4-1 to MH 4-2 and sections from MH 2-1 to MH 2-2. These will need to be repaired and backfilled. Will need to wait the 30 day period and retest these sections. After the testing is complete a vidoe inspection will be done by Water Utilities for final approval of the sanitary main.
Storm Sewer Construction Inspection Passed 04/26/2019
PW-Install steps in storm box
Corrective Action Required
08/02/2018
Steps need to be installed for all storm boxes. Tom Chandler 08/02/2018 11:27 AM The steps installed on the storm sewer boxes do not meet specs according to the approved product list and need to be corrected.
Sidewalk Inspection Passed 4/14/2019 05/20/2019
Misc
Informational
05/14/2019
All the sidewalks appear to be installed and have passed ada standards.
Erosion Control Inspection Failed 5/15/2019 05/20/2019
PW-Erosion and Sediment Control
Corrective Action Required
08/17/2018
John DiMauro 08/17/2018 11:16 AM Your project is in violation of the Erosion and Sediment control policy. There is debris, mud and silt running off site and onto SW Hook Rd. Please clean the debris and silt from the road and make all necessary corrections to the erosion control devices immediately.
PW-Misc
Corrective Action Required
05/20/2019
We continue to get complaints from 1615 Hook Road. I have been out to take pictures , there is silt and straw coming onto the property of 1612 Hook. I have spoke with Emery Sapp and they were going to come out last week and do some clean-up and erosion control but did not make it out yet. Over the weekend they had more silt coming onto their property , I call Travis Ruf today and he said he would do their best to get a crew out this afternoon before the rain comes. The home owners are very concerned about the rain that is coming in. Steve Robbins 05/20/2019 4:13 PM
Erosion Control Inspection Failed 1/28/2020 01/28/2020
PW-Erosion and Sediment Control
Corrective Action Required
05/20/2019
John DiMauro 08/17/2018 11:16 AM Your project is in violation of the Erosion and Sediment control policy. There is debris, mud and silt running off site and onto SW Hook Rd. Please clean the debris and silt from the road and make all necessary corrections to the erosion control devices immediately.
PW-Misc
Corrective Action Required
05/20/2019
We continue to get complaints from 1615 Hook Road. I have been out to take pictures , there is silt and straw coming onto the property of 1612 Hook. I have spoke with Emery Sapp and they were going to come out last week and do some clean-up and erosion control but did not make it out yet. Over the weekend they had more silt coming onto their property , I call Travis Ruf today and he said he would do their best to get a crew out this afternoon before the rain comes. The home owners are very concerned about the rain that is coming in. Steve Robbins 05/20/2019 4:13 PM
PW-Erosion and Sediment Control
Corrective Action Required
01/28/2020
Your project is in violation of the Erosion and Sediment control policy. There are no inlet protection devices installed throughout the entire site. Install the proper erosion control devices to protect the storm water collection system from silt, mud & debris. Make corrections as soon as possible to avoid any stop work orders or freezing of permits on site.
Erosion Control Inspection Failed 1/28/2020 01/28/2020
Misc
Corrective Action Required
01/28/2020
Your project is in violation of the Erosion and Sediment control policy. There are no inlet protection devices installed throughout the entire site. Install the proper erosion control devices to protect the storm water collection system from silt, mud & debris. Make corrections as soon as possible to avoid any stop work orders or freezing of permits on site.
Erosion Control Inspection Failed 3/27/2020 03/27/2020
PW-Erosion and Sediment Control
Resolved
03/27/2020
John DiMauro 08/17/2018 11:16 AM Your project is in violation of the Erosion and Sediment control policy. There is debris, mud and silt running off site and onto SW Hook Rd. Please clean the debris and silt from the road and make all necessary corrections to the erosion control devices immediately.
PW-Misc
Resolved
03/27/2020
We continue to get complaints from 1615 Hook Road. I have been out to take pictures , there is silt and straw coming onto the property of 1612 Hook. I have spoke with Emery Sapp and they were going to come out last week and do some clean-up and erosion control but did not make it out yet. Over the weekend they had more silt coming onto their property , I call Travis Ruf today and he said he would do their best to get a crew out this afternoon before the rain comes. The home owners are very concerned about the rain that is coming in. Steve Robbins 05/20/2019 4:13 PM
PW-Erosion and Sediment Control
Resolved
03/27/2020
Your project is in violation of the Erosion and Sediment control policy. There are no inlet protection devices installed throughout the entire site. Install the proper erosion control devices to protect the storm water collection system from silt, mud & debris. Make corrections as soon as possible to avoid any stop work orders or freezing of permits on site.
Misc
Corrective Action Required
03/27/2020

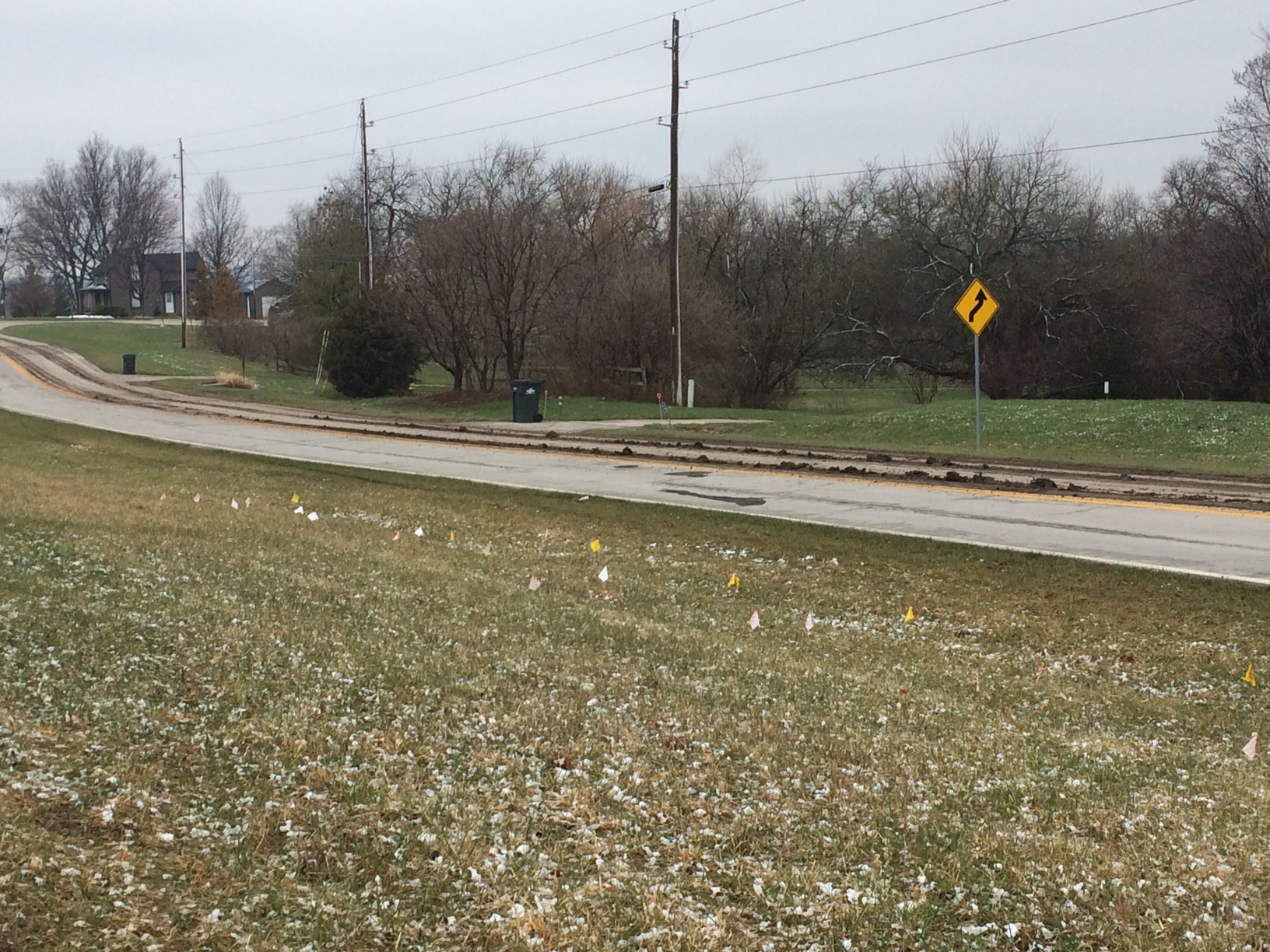

Erosion rock ditch checks failing across from house No. 1537 Arbor Falls. Immediate attention required.
Documents & Images
Date Uploaded File Type Document Name
03/23/2018 Receipt Receipt for transaction: 2018-001085
04/09/2018 IMG_1187
04/09/2018 IMG_1188
04/09/2018 IMG_1189
04/09/2018 Letter DE-Daily Inspection Summary
04/09/2018 Letter DE-Permit
04/11/2018 Letter DE-Daily Inspection Summary
04/19/2018 Letter DE-Daily Inspection Summary
05/01/2018 Letter DE-Daily Inspection Summary
05/07/2018 Letter DE-Daily Inspection Summary
05/10/2018 Letter DE-Daily Inspection Summary
05/24/2018 Letter DE-Daily Inspection Summary
05/29/2018 Letter DE-Daily Inspection Summary
05/29/2018 Letter DE-Daily Inspection Summary
05/30/2018 Letter DE-Daily Inspection Summary
05/31/2018 Letter DE-Daily Inspection Summary
06/01/2018 Letter DE-Daily Inspection Summary
06/01/2018 DOC060118-06012018162332
06/05/2018 Letter DE-Daily Inspection Summary
06/07/2018 Letter DE-Daily Inspection Summary
06/09/2018 Letter DE-Daily Inspection Summary
06/11/2018 Letter DE-Daily Inspection Summary
06/18/2018 Letter DE-Daily Inspection Summary
06/23/2018 Letter DE-Daily Inspection Summary
06/25/2018 Letter DE-Daily Inspection Summary
07/05/2018 Letter DE-Daily Inspection Summary
07/20/2018 Letter DE-Daily Inspection Summary
08/02/2018 Letter DE-Daily Inspection Summary
08/06/2018 DOC080618-08062018082403
08/09/2018 Letter DE-Daily Inspection Summary
08/13/2018 Letter DE-Daily Inspection Summary
08/16/2018 Letter DE-Daily Inspection Summary
08/17/2018 Letter DE-Daily Inspection Summary
08/28/2018 Letter DE-Daily Inspection Summary
09/05/2018 Letter DE-Daily Inspection Summary
09/17/2018 Letter DE-Daily Inspection Summary
09/18/2018 Letter DE-Daily Inspection Summary
09/19/2018 Letter DE-Daily Inspection Summary
09/21/2018 Letter DE-Daily Inspection Summary
09/25/2018 Letter DE-Daily Inspection Summary
10/04/2018 Letter DE-Daily Inspection Summary
10/04/2018 Letter DE-Daily Inspection Summary
10/19/2018 Letter DE-Daily Inspection Summary
04/09/2019 Letter DE-Daily Inspection Summary
04/26/2019 Letter DE-Daily Inspection Summary
04/26/2019 Letter DE-Daily Inspection Summary
04/29/2019 Letter DE-Punch List
04/29/2019 Letter DE-Certificate of Substantial Completion Multiple Lot
05/01/2019 Hawthorne Ridge Substantial Completion On-Site
05/20/2019 Letter DE-Daily Inspection Summary
05/20/2019 Letter DE-Daily Inspection Summary
01/28/2020 Letter INSPECTION SUMMARY
03/27/2020 Letter INSPECTION SUMMARY
03/27/2020 Letter INSPECTION SUMMARY
07/20/2020 Hawthorne Ridge Letter
06/16/2021 Hawthorne Ridge 1st Plat Maintenance Bond
02/08/2023 Letter DE-Certificate of Final Acceptance (Commercial)
02/08/2023 Hawthorn Ridge 1st Plat On-Site Final Acceptance
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
