Summary

PRSITE20225181
Development - Site
Final Completion
LIVING FAITH INC
DEVELOPMENT COMPLETE
LIVING FAITH PARKING LOT EXPANSION
10/13/2022
10/17/2022
01/12/2024
Locations
Contacts
LIVING FAITH INC, Address:PO BOX 1471
WIL-PAV INC, Address:12900 E KENTUCKY RD, Phone:(816) 836-1786
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 10/13/2022 10/17/2022
Dawn Bell
Fees
Paid Fees Amount Paid Owing Date Paid
9110073-Right of Way Permit Fee $85.00 $85.00 Paid 10/14/2022
9110068-Storm Sewer Inspection Fee $353.70 $353.70 Paid 10/14/2022
9110081-Paved Surface Inspection Fee $4,641.95 $4,641.95 Paid 10/14/2022
9110071-Site Grading Fee $832.64 $832.64 Paid 10/14/2022
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.

$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Site Visit Partial 10/26/2022
Misc
Informational
10/26/2022
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed.
Site Visit Partial 11/01/2022
Misc
Informational
10/26/2022
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet.
Erosion Control Inspection Partial 11/03/2022
Misc
Informational
11/03/2022
11-3-22 RH. Contractor started clearing trees and placing silt fence. Grading will continue for placing the silt fence.
Grading/Excavation/Fill Inspection Partial 11/04/2022
Misc
Informational
11/04/2022
11-4-22 RH. Site grading has started by removing vegetation before starting to fill for the parking lot.
Grading/Excavation/Fill Inspection Partial 11/07/2022
Misc
Informational
11/04/2022
11-4-22 RH. Site grading has started by removing vegetation before starting to fill for the parking lot. 11-7-22 RH. Site continues to be graded for parking lot.
Erosion Control Inspection Partial 11/07/2022
Misc
Informational
11/03/2022
11-3-22 RH. Contractor started clearing trees and placing silt fence. Grading will continue for placing the silt fence. 11-7-22 RH. Silt fence is up and in working order.
Grading/Excavation/Fill Inspection Partial 11/08/2022
Misc
Informational
11/07/2022
11-4-22 RH. Site grading has started by removing vegetation before starting to fill for the parking lot. 11-7-22 RH. Site continues to be graded for parking lot. 11-8-22 RH. Site continues to be cut down to grade and filled in certain areas. Contractor plans to finish grading today.
Grading/Excavation/Fill Inspection Partial 11/09/2022
Misc
Informational
11/08/2022
11-4-22 RH. Site grading has started by removing vegetation before starting to fill for the parking lot. 11-7-22 RH. Site continues to be graded for parking lot. 11-8-22 RH. Site continues to be cut down to grade and filled in certain areas. Contractor plans to finish grading today. 11-9-22 RH. Grading was completed and contractor started placing the Geogrid and aggregate.
Pavement-Aggregate Base Partial 11/09/2022
Misc
Informational
11/09/2022
11-9-22 RH. Geogrid was placed on subgrade with a 1 foot overlap. Aggregate was then brought in and started to be graded and rolled into place.
Pavement-Aggregate Base Partial 11/10/2022
Misc
Informational
11/09/2022
11-9-22 RH. Geogrid was placed on subgrade with a 1 foot overlap. Aggregate was then brought in and started to be graded and rolled into place. 11-10-22 RH. Aggregate continues to be placed and compacted with a flat drum roller.
Erosion Control Inspection Partial 11/14/2022
Misc
Informational
11/07/2022
11-3-22 RH. Contractor started clearing trees and placing silt fence. Grading will continue for placing the silt fence. 11-7-22 RH. Silt fence is up and in working order. 11-14-22 RH. Silt Fence is up and in working order.
Pavement-Aggregate Base Partial 11/14/2022
Misc
Informational
11/10/2022
11-9-22 RH. Geogrid was placed on subgrade with a 1 foot overlap. Aggregate was then brought in and started to be graded and rolled into place. 11-10-22 RH. Aggregate continues to be placed and compacted with a flat drum roller. 11-14-22 RH. Aggregate is placed and compacted. There is still some grading that needs to be done. Contractor is not on site today.
Pavement-Proof Roll Partial 11/17/2022
Misc
Informational
11/17/2022
11-17-22 RH. Aggregate is place and ready for proof roll but due to the cold temps aggregate is frozen and will need to de thaw before completing proof roll.
Erosion Control Inspection Partial 11/21/2022
Misc
Informational
11/14/2022
11-3-22 RH. Contractor started clearing trees and placing silt fence. Grading will continue for placing the silt fence. 11-7-22 RH. Silt fence is up and in working order. 11-14-22 RH. Silt Fence is up and in working order. 11-21-22 RH. Silt fence is up and in working order.
Pavement-Aggregate Base Partial 11/22/2022
Misc
Informational
11/14/2022
11-9-22 RH. Geogrid was placed on subgrade with a 1 foot overlap. Aggregate was then brought in and started to be graded and rolled into place. 11-10-22 RH. Aggregate continues to be placed and compacted with a flat drum roller. 11-14-22 RH. Aggregate is placed and compacted. There is still some grading that needs to be done. Contractor is not on site today. 11-22-22 RH. No work being completed today for parking lot.
Erosion Control Inspection Partial 11/28/2022
Misc
Informational
11/21/2022
11-3-22 RH. Contractor started clearing trees and placing silt fence. Grading will continue for placing the silt fence. 11-7-22 RH. Silt fence is up and in working order. 11-14-22 RH. Silt Fence is up and in working order. 11-21-22 RH. Silt fence is up and in working order. 11-28-22 RH. Silt fence is up and in working order.
Pavement-Proof Roll Partial 11/29/2022
Misc
Informational
11/17/2022
11-17-22 RH. Aggregate is place and ready for proof roll but due to the cold temps aggregate is frozen and will need to de thaw before completing proof roll. 11-29-22 RH. Proof roll passed the inspection other than one corner of lowest part of the parking lot. Contractor will let the area dry and re proof roll later. Curb construction will start tomorrow.
Pavement-Curb Construction Partial 11/30/2022
Misc
Informational
11/30/2022
11-30-22 RH. Curb construction had started by laying forms. Contractor started placing forms this morning. Contractor said they would cover area to let warm up before pouring.
Pavement-Curb Construction Partial 12/01/2022
Misc
Informational
12/01/2022
12-1-22 RH. Curbs are being formed up. Ground is still under 32 degrees so they are not pouring until temp is higher.
Pavement-Curb Construction Partial 12/02/2022
Misc
Informational
12/01/2022
12-1-22 RH. Curbs are being formed up. Ground is still under 32 degrees so they are not pouring until temp is higher. 12-2-22 RH. Forms were covered and concrete was going to be placed today.
Pavement-Curb Construction Partial 12/02/2022
Misc
Informational
12/02/2022
12-1-22 RH. Curbs are being formed up. Ground is still under 32 degrees so they are not pouring until temp is higher. 12-2-22 RH. Forms were covered overnight and concrete was is being placed today. Curbs will be recovered once completed.
Grading/Excavation/Fill Inspection Partial 12/02/2022
Misc
Informational
11/09/2022
11-4-22 RH. Site grading has started by removing vegetation before starting to fill for the parking lot. 11-7-22 RH. Site continues to be graded for parking lot. 11-8-22 RH. Site continues to be cut down to grade and filled in certain areas. Contractor plans to finish grading today. 11-9-22 RH. Grading was completed and contractor started placing the Geogrid and aggregate. 12-1-22 RH. Contractor started building up detention basin. 12-2-22 RH. Contractor has almost cut dention basin to grade. Contractor also modified inlet to flow into detention basin on the higher side due to pipe interfering with building up the wall of the detention basin.
Pavement-Curb Construction Partial 12/05/2022
Misc
Informational
12/02/2022
12-1-22 RH. Curbs are being formed up. Ground is still under 32 degrees so they are not pouring until temp is higher. 12-2-22 RH. Forms were covered overnight and concrete was is being placed today. Curbs will be recovered once completed. 12-5-22 RH. Crew continues to pour curb starting in the AM. Blankets were used on subgrade over the weekend so subgrade did not freeze. Contractor plans to finish up curb today.
Grading/Excavation/Fill Inspection Partial 12/05/2022
Misc
Informational
12/02/2022
11-4-22 RH. Site grading has started by removing vegetation before starting to fill for the parking lot. 11-7-22 RH. Site continues to be graded for parking lot. 11-8-22 RH. Site continues to be cut down to grade and filled in certain areas. Contractor plans to finish grading today. 11-9-22 RH. Grading was completed and contractor started placing the Geogrid and aggregate. 12-1-22 RH. Contractor started building up detention basin. 12-2-22 RH. Contractor has almost cut dention basin to grade. Contractor also modified inlet to flow into detention basin on the higher side due to pipe interfering with building up the wall of the detention basin. 12-5-22 RH. Contractor continues to cut basin down to grade.
Pavement-Proof Roll Partial 12/05/2022
Misc
Informational
11/29/2022
11-17-22 RH. Aggregate is place and ready for proof roll but due to the cold temps aggregate is frozen and will need to de thaw before completing proof roll. 11-29-22 RH. Proof roll passed the inspection other than one corner of lowest part of the parking lot. Contractor will let the area dry and re proof roll later. Curb construction will start tomorrow. 12-5-22 RH. Curb was re proof rolled and passed inspection. Rest of curb can be poured now.
Site Visit Partial 12/07/2022
Misc
Informational
11/01/2022
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today.
Erosion Control Inspection Partial 12/12/2022
Misc
Informational
11/28/2022
11-3-22 RH. Contractor started clearing trees and placing silt fence. Grading will continue for placing the silt fence. 11-7-22 RH. Silt fence is up and in working order. 11-14-22 RH. Silt Fence is up and in working order. 11-21-22 RH. Silt fence is up and in working order. 11-28-22 RH. Silt fence is up and in working order. 12-12-22 RH. Erosion control is in place and in working order.
Site Visit Partial 12/12/2022
Misc
Informational
12/07/2022
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today. 12-12-22 RH. No work on site today.
Erosion Control Inspection Partial 12/20/2022
Misc
Informational
12/12/2022
11-3-22 RH. Contractor started clearing trees and placing silt fence. Grading will continue for placing the silt fence. 11-7-22 RH. Silt fence is up and in working order. 11-14-22 RH. Silt Fence is up and in working order. 11-21-22 RH. Silt fence is up and in working order. 11-28-22 RH. Silt fence is up and in working order. 12-12-22 RH. Erosion control is in place and in working order. 12-20-22 RH. Erosion control is up and in working order.
Site Visit Partial 12/21/2022
Misc
Informational
12/12/2022
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today. 12-12-22 RH. No work on site today. 12-21-22 RH. No work on site today.
Erosion Control Inspection Partial 01/03/2023
Misc
Informational
12/20/2022
11-3-22 RH. Contractor started clearing trees and placing silt fence. Grading will continue for placing the silt fence. 11-7-22 RH. Silt fence is up and in working order. 11-14-22 RH. Silt Fence is up and in working order. 11-21-22 RH. Silt fence is up and in working order. 11-28-22 RH. Silt fence is up and in working order. 12-12-22 RH. Erosion control is in place and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order.
Erosion Control Inspection Partial 01/30/2023
Misc
Informational
01/03/2023
11-3-22 RH. Contractor started clearing trees and placing silt fence. Grading will continue for placing the silt fence. 11-7-22 RH. Silt fence is up and in working order. 11-14-22 RH. Silt Fence is up and in working order. 11-21-22 RH. Silt fence is up and in working order. 11-28-22 RH. Silt fence is up and in working order. 12-12-22 RH. Erosion control is in place and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order.
Site Visit Partial 02/17/2023
Misc
Informational
12/21/2022
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today. 12-12-22 RH. No work on site today. 12-21-22 RH. No work on site today. 2-17-23 RH. No work for development on site today.
Pavement-Curb Construction Partial 02/21/2023
Misc
Informational
12/05/2022
12-1-22 RH. Curbs are being formed up. Ground is still under 32 degrees so they are not pouring until temp is higher. 12-2-22 RH. Forms were covered overnight and concrete was is being placed today. Curbs will be recovered once completed. 12-5-22 RH. Crew continues to pour curb starting in the AM. Blankets were used on subgrade over the weekend so subgrade did not freeze. Contractor plans to finish up curb today. 2-21-23 RH. The final of the curb construction is formed up and pour will occur at 1pm.
Erosion Control Inspection Partial 02/22/2023
Misc
Informational
01/30/2023
11-3-22 RH. Contractor started clearing trees and placing silt fence. Grading will continue for placing the silt fence. 11-7-22 RH. Silt fence is up and in working order. 11-14-22 RH. Silt Fence is up and in working order. 11-21-22 RH. Silt fence is up and in working order. 11-28-22 RH. Silt fence is up and in working order. 12-12-22 RH. Erosion control is in place and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order.
Pavement-Curb Construction Partial 02/22/2023
Misc
Informational
02/21/2023
12-1-22 RH. Curbs are being formed up. Ground is still under 32 degrees so they are not pouring until temp is higher. 12-2-22 RH. Forms were covered overnight and concrete was is being placed today. Curbs will be recovered once completed. 12-5-22 RH. Crew continues to pour curb starting in the AM. Blankets were used on subgrade over the weekend so subgrade did not freeze. Contractor plans to finish up curb today. 2-21-23 RH. The final of the curb construction is formed up and pour will occur at 1pm. 2-22-23 RH. Curb was all poured for project.
Erosion Control Inspection Partial 02/27/2023
Misc
Informational
02/22/2023
11-3-22 RH. Contractor started clearing trees and placing silt fence. Grading will continue for placing the silt fence. 11-7-22 RH. Silt fence is up and in working order. 11-14-22 RH. Silt Fence is up and in working order. 11-21-22 RH. Silt fence is up and in working order. 11-28-22 RH. Silt fence is up and in working order. 12-12-22 RH. Erosion control is in place and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order.
Erosion Control Inspection Partial 3/3/2023 3/3/2023 03/03/2023
Misc
Informational
02/27/2023
11-3-22 RH. Contractor started clearing trees and placing silt fence. Grading will continue for placing the silt fence. 11-7-22 RH. Silt fence is up and in working order. 11-14-22 RH. Silt Fence is up and in working order. 11-21-22 RH. Silt fence is up and in working order. 11-28-22 RH. Silt fence is up and in working order. 12-12-22 RH. Erosion control is in place and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order.
Site Visit Partial 03/09/2023
Misc
Informational
02/17/2023
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today. 12-12-22 RH. No work on site today. 12-21-22 RH. No work on site today. 2-17-23 RH. No work for development on site today. 3-2-23 RH. No work being completed on site today for development. 3-9-23 RH. No work being completed on site today for development due to rain.
Pavement-Proof Roll Partial 03/14/2023
Misc
Informational
12/05/2022
11-17-22 RH. Aggregate is place and ready for proof roll but due to the cold temps aggregate is frozen and will need to de thaw before completing proof roll. 11-29-22 RH. Proof roll passed the inspection other than one corner of lowest part of the parking lot. Contractor will let the area dry and re proof roll later. Curb construction will start tomorrow. 12-5-22 RH. Curb was re proof rolled and passed inspection. Rest of curb can be poured now. 3-14-23 RH. Proof Roll was completed on parking lot and 3/4 of parking lot passed inspeciton. But due to wet conditions subgrade was oversatured and did not pass proof roll.
Erosion Control Inspection Partial 3/17/2023 3/17/2023 03/17/2023
Misc
Informational
03/03/2023
11-3-22 RH. Contractor started clearing trees and placing silt fence. Grading will continue for placing the silt fence. 11-7-22 RH. Silt fence is up and in working order. 11-14-22 RH. Silt Fence is up and in working order. 11-21-22 RH. Silt fence is up and in working order. 11-28-22 RH. Silt fence is up and in working order. 12-12-22 RH. Erosion control is in place and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order.
Site Visit Partial 3/21/2023 3/21/2023 03/21/2023
Misc
Informational
03/09/2023
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today. 12-12-22 RH. No work on site today. 12-21-22 RH. No work on site today. 2-17-23 RH. No work for development on site today. 3-2-23 RH. No work being completed on site today for development. 3-9-23 RH. No work being completed on site today for development due to rain. 3-21-23 RH. No wok being comopleted due to rain.
Erosion Control Inspection Partial 3/22/2023 3/22/2023 03/22/2023
Misc
Informational
03/17/2023
11-3-22 RH. Contractor started clearing trees and placing silt fence. Grading will continue for placing the silt fence. 11-7-22 RH. Silt fence is up and in working order. 11-14-22 RH. Silt Fence is up and in working order. 11-21-22 RH. Silt fence is up and in working order. 11-28-22 RH. Silt fence is up and in working order. 12-12-22 RH. Erosion control is in place and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order.
Site Visit Partial 3/24/2023 3/24/2023 03/24/2023
Misc
Informational
03/21/2023
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today. 12-12-22 RH. No work on site today. 12-21-22 RH. No work on site today. 2-17-23 RH. No work for development on site today. 3-2-23 RH. No work being completed on site today for development. 3-9-23 RH. No work being completed on site today for development due to rain. 3-21-23 RH. No wok being comopleted due to rain. 3-24-23 RH. No work for development today.
Site Visit Partial 3/27/2023 3/27/2023 03/27/2023
Misc
Informational
03/24/2023
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today. 12-12-22 RH. No work on site today. 12-21-22 RH. No work on site today. 2-17-23 RH. No work for development on site today. 3-2-23 RH. No work being completed on site today for development. 3-9-23 RH. No work being completed on site today for development due to rain. 3-21-23 RH. No wok being comopleted due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today.
Site Visit Partial 3/30/2023 3/30/2023 03/30/2023
Misc
Informational
03/27/2023
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today. 12-12-22 RH. No work on site today. 12-21-22 RH. No work on site today. 2-17-23 RH. No work for development on site today. 3-2-23 RH. No work being completed on site today for development. 3-9-23 RH. No work being completed on site today for development due to rain. 3-21-23 RH. No wok being comopleted due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. Now work being completed for development in the AM.
Site Visit Partial 3/31/2023 3/31/2023 03/31/2023
Misc
Informational
03/30/2023
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today. 12-12-22 RH. No work on site today. 12-21-22 RH. No work on site today. 2-17-23 RH. No work for development on site today. 3-2-23 RH. No work being completed on site today for development. 3-9-23 RH. No work being completed on site today for development due to rain. 3-21-23 RH. No wok being comopleted due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM.
Erosion Control Inspection Partial 4/3/2023 4/3/2023 04/03/2023
Misc
Informational
03/22/2023
11-3-22 RH. Contractor started clearing trees and placing silt fence. Grading will continue for placing the silt fence. 11-7-22 RH. Silt fence is up and in working order. 11-14-22 RH. Silt Fence is up and in working order. 11-21-22 RH. Silt fence is up and in working order. 11-28-22 RH. Silt fence is up and in working order. 12-12-22 RH. Erosion control is in place and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order.
Site Visit Partial 4/3/2023 4/3/2023 04/03/2023
Misc
Informational
03/31/2023
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today. 12-12-22 RH. No work on site today. 12-21-22 RH. No work on site today. 2-17-23 RH. No work for development on site today. 3-2-23 RH. No work being completed on site today for development. 3-9-23 RH. No work being completed on site today for development due to rain. 3-21-23 RH. No wok being comopleted due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No work for development in the AM.
Pavement-Stabilized Subgrade Passed 04/06/2023
Misc
Informational
04/06/2023
Contractor used geogrid for stabalation and was lapped correctly. Aggregate was placed over it and compacted.
Storm Sewer Construction Inspection Passed 04/06/2023
Misc
Informational
04/06/2023
Strom structure was placed at lower end of detention basin. Rip rap was placed in front and back of the outflow.
Pavement-Curb Construction Passed 04/06/2023
Misc
Informational
02/22/2023
12-1-22 RH. Curbs are being formed up. Ground is still under 32 degrees so they are not pouring until temp is higher. 12-2-22 RH. Forms were covered overnight and concrete was is being placed today. Curbs will be recovered once completed. 12-5-22 RH. Crew continues to pour curb starting in the AM. Blankets were used on subgrade over the weekend so subgrade did not freeze. Contractor plans to finish up curb today. 2-21-23 RH. The final of the curb construction is formed up and pour will occur at 1pm. 2-22-23 RH. Curb was all poured for project.
Piers/Caissons Inspection - Commercial Passed 4/7/2023 (1:00) 4/7/2023 04/07/2023
Misc
Corrective Action Required
04/07/2023
Inspected 13 light pole bases.
Pavement-Aggregate Base Passed 04/10/2023
Misc
Informational
11/22/2022
11-9-22 RH. Geogrid was placed on subgrade with a 1 foot overlap. Aggregate was then brought in and started to be graded and rolled into place. 11-10-22 RH. Aggregate continues to be placed and compacted with a flat drum roller. 11-14-22 RH. Aggregate is placed and compacted. There is still some grading that needs to be done. Contractor is not on site today. 11-22-22 RH. No work being completed today for parking lot.
Pavement-Proof Roll Passed 04/10/2023
Misc
Informational
03/14/2023
11-17-22 RH. Aggregate is place and ready for proof roll but due to the cold temps aggregate is frozen and will need to de thaw before completing proof roll. 11-29-22 RH. Proof roll passed the inspection other than one corner of lowest part of the parking lot. Contractor will let the area dry and re proof roll later. Curb construction will start tomorrow. 12-5-22 RH. Curb was re proof rolled and passed inspection. Rest of curb can be poured now. 3-14-23 RH. Proof Roll was completed on parking lot and 3/4 of parking lot passed inspeciton. But due to wet conditions subgrade was oversatured and did not pass proof roll. 4-7-23 RH. Proof Roll passed for parking lot
Pavement-Surface Partial 04/10/2023
Misc
Informational
04/10/2023
4-10-23 RH. Contractor is putting the asphalt base down for parking lot. Tac was placed along the curb.
Pavement-Surface Partial 4/11/2023 4/11/2023 04/11/2023
Misc
Informational
04/10/2023
4-10-23 RH. Contractor is putting the asphalt base down for parking lot. Tac was placed along the curb. 4-11-23 RH. Contractor will finish up base layer of asphalt today and then continue on by starting to place surface mix. Contractor had to stop early due to weather.
Pavement-Surface Passed 04/13/2023
Misc
Informational
04/11/2023
4-10-23 RH. Contractor is putting the asphalt base down for parking lot. Tac was placed along the curb. Contractor had to stop early due to weather. 4-11-23 RH. Contractor will finish up base layer of asphalt today and then continue on by starting to place surface mix. Surface was completed. 4-13-23 RH. Parking lot was striped today.
Grading/Excavation/Fill Inspection Passed 04/13/2023
Misc
Informational
12/05/2022
11-4-22 RH. Site grading has started by removing vegetation before starting to fill for the parking lot. 11-7-22 RH. Site continues to be graded for parking lot. 11-8-22 RH. Site continues to be cut down to grade and filled in certain areas. Contractor plans to finish grading today. 11-9-22 RH. Grading was completed and contractor started placing the Geogrid and aggregate. 12-1-22 RH. Contractor started building up detention basin. 12-2-22 RH. Contractor has almost cut dention basin to grade. Contractor also modified inlet to flow into detention basin on the higher side due to pipe interfering with building up the wall of the detention basin. 12-5-22 RH. Contractor continues to cut basin down to grade. Basin was completed.
ESC - (Vegetation/Ground Cover) Passed 4/13/2023 4/13/2023 04/13/2023
Misc
Informational
04/13/2023
4-13-23 RH. Contractor placed seed and straw around the entire site.
Site Visit Partial 04/13/2023
Misc
Informational
04/03/2023
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today. 12-12-22 RH. No work on site today. 12-21-22 RH. No work on site today. 2-17-23 RH. No work for development on site today. 3-2-23 RH. No work being completed on site today for development. 3-9-23 RH. No work being completed on site today for development due to rain. 3-21-23 RH. No wok being comopleted due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No work for development in the AM. 4-4-23 RH. Contractor set up light pole bases with conduit running out of the bases.
Underground Electrical Inspection - Commercial Partial 4/14/2023 4/14/2023 04/14/2023
Misc
Informational
04/14/2023
Inspected and OK to cover from NW most light pole to NE most light pole of the new S parking lot.
Piers/Caissons Inspection - Commercial Passed 4/18/2023 4/18/2023 04/18/2023
Misc
Informational
04/18/2023
4-18-23 RH. Conduit is running through the center of the light pole bases.
Erosion Control Inspection Partial 4/20/2023 4/20/2023 04/20/2023
Misc
Informational
04/03/2023
11-3-22 RH. Contractor started clearing trees and placing silt fence. Grading will continue for placing the silt fence. 11-7-22 RH. Silt fence is up and in working order. 11-14-22 RH. Silt Fence is up and in working order. 11-21-22 RH. Silt fence is up and in working order. 11-28-22 RH. Silt fence is up and in working order. 12-12-22 RH. Erosion control is in place and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order. 4-20-23 RH. Erosion control is up and in working order.
Site Visit Partial 04/21/2023
Misc
Informational
04/13/2023
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today. 12-12-22 RH. No work on site today. 12-21-22 RH. No work on site today. 2-17-23 RH. No work for development on site today. 3-2-23 RH. No work being completed on site today for development. 3-9-23 RH. No work being completed on site today for development due to rain. 3-21-23 RH. No wok being comopleted due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No work for development in the AM. 4-14-23 RH. Contractor set up light pole bases with conduit running out of the bases. 4-21-23 RH. No work on site in the AM for development.
ESC - (Vegetation/Ground Cover) Partial 04/24/2023
Misc
Informational
04/24/2023
4-24-23 RH. Vegetation needs to be replaced after lines were dug to the differnt light poles.
Site Visit Partial 4/26/2023 4/26/2023 04/26/2023
Misc
Informational
04/21/2023
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today. 12-12-22 RH. No work on site today. 12-21-22 RH. No work on site today. 2-17-23 RH. No work for development on site today. 3-2-23 RH. No work being completed on site today for development. 3-9-23 RH. No work being completed on site today for development due to rain. 3-21-23 RH. No wok being comopleted due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No work for development in the AM. 4-14-23 RH. Contractor set up light pole bases with conduit running out of the bases. 4-21-23 RH. No work on site in the AM for development. 4-26-23 RH. No work for development in the AM.
Site Visit Partial 04/27/2023
Misc
Informational
04/26/2023
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today. 12-12-22 RH. No work on site today. 12-21-22 RH. No work on site today. 2-17-23 RH. No work for development on site today. 3-2-23 RH. No work being completed on site today for development. 3-9-23 RH. No work being completed on site today for development due to rain. 3-21-23 RH. No wok being comopleted due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No work for development in the AM. 4-14-23 RH. Contractor set up light pole bases with conduit running out of the bases. 4-21-23 RH. No work on site in the AM for development. 4-26-23 RH. No work for development in the AM. 4-27-23 RH. No work for development in the AM.
Erosion Control Inspection Partial 05/01/2023
Misc
Informational
04/20/2023
11-3-22 RH. Contractor started clearing trees and placing silt fence. Grading will continue for placing the silt fence. 11-7-22 RH. Silt fence is up and in working order. 11-14-22 RH. Silt Fence is up and in working order. 11-21-22 RH. Silt fence is up and in working order. 11-28-22 RH. Silt fence is up and in working order. 12-12-22 RH. Erosion control is in place and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order. 4-20-23 RH. Erosion control is up and in working order. 5-1-23 RH. Erosion control is up and in working order.
Site Visit Partial 05/03/2023
Misc
Informational
04/27/2023
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today. 12-12-22 RH. No work on site today. 12-21-22 RH. No work on site today. 2-17-23 RH. No work for development on site today. 3-2-23 RH. No work being completed on site today for development. 3-9-23 RH. No work being completed on site today for development due to rain. 3-21-23 RH. No wok being comopleted due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No work for development in the AM. 4-14-23 RH. Contractor set up light pole bases with conduit running out of the bases. 4-21-23 RH. No work on site in the AM for development. 4-26-23 RH. No work for development in the AM. 4-27-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM.
Site Visit Partial 05/05/2023
Misc
Informational
05/03/2023
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today. 12-12-22 RH. No work on site today. 12-21-22 RH. No work on site today. 2-17-23 RH. No work for development on site today. 3-2-23 RH. No work being completed on site today for development. 3-9-23 RH. No work being completed on site today for development due to rain. 3-21-23 RH. No wok being comopleted due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No work for development in the AM. 4-14-23 RH. Contractor set up light pole bases with conduit running out of the bases. 4-21-23 RH. No work on site in the AM for development. 4-26-23 RH. No work for development in the AM. 4-27-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM.
ESC - (Vegetation/Ground Cover) Partial 05/10/2023
Misc
Informational
04/24/2023
4-24-23 RH. Vegetation needs to be replaced after lines were dug to the differnt light poles. 5-10-23 RH. Ground was regraded where electric is going.
Site Visit Partial 05/12/2023
Misc
Informational
05/05/2023
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today. 12-12-22 RH. No work on site today. 12-21-22 RH. No work on site today. 2-17-23 RH. No work for development on site today. 3-2-23 RH. No work being completed on site today for development. 3-9-23 RH. No work being completed on site today for development due to rain. 3-21-23 RH. No wok being comopleted due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No work for development in the AM. 4-14-23 RH. Contractor set up light pole bases with conduit running out of the bases. 4-21-23 RH. No work on site in the AM for development. 4-26-23 RH. No work for development in the AM. 4-27-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM. 5-12-23 RH. No work for development in the AM.
Site Visit Partial 05/15/2023
Misc
Informational
05/12/2023
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today. 12-12-22 RH. No work on site today. 12-21-22 RH. No work on site today. 2-17-23 RH. No work for development on site today. 3-2-23 RH. No work being completed on site today for development. 3-9-23 RH. No work being completed on site today for development due to rain. 3-21-23 RH. No wok being comopleted due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No work for development in the AM. 4-14-23 RH. Contractor set up light pole bases with conduit running out of the bases. 4-21-23 RH. No work on site in the AM for development. 4-26-23 RH. No work for development in the AM. 4-27-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM. 5-12-23 RH. No work for development in the AM. 5-15-23 RH. No work for development in the AM.
Erosion Control Inspection Partial 05/15/2023
Misc
Informational
05/01/2023
11-3-22 RH. Contractor started clearing trees and placing silt fence. Grading will continue for placing the silt fence. 11-7-22 RH. Silt fence is up and in working order. 11-14-22 RH. Silt Fence is up and in working order. 11-21-22 RH. Silt fence is up and in working order. 11-28-22 RH. Silt fence is up and in working order. 12-12-22 RH. Erosion control is in place and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order. 4-20-23 RH. Erosion control is up and in working order. 5-1-23 RH. Erosion control is up and in working order. 5-15-23 RH. Erosion control is up and in working order.
ESC - (Vegetation/Ground Cover) Partial 05/16/2023
Misc
Informational
05/10/2023
4-24-23 RH. Vegetation needs to be replaced after lines were dug to the differnt light poles. 5-10-23 RH. Ground was regraded where electric is going. 5-16-23 RH. Ground where electic was dug up needs to be reseeded.
ESC - (Vegetation/Ground Cover) Partial 05/18/2023
Misc
Informational
05/16/2023
4-24-23 RH. Vegetation needs to be replaced after lines were dug to the differnt light poles. 5-10-23 RH. Ground was regraded where electric is going. 5-16-23 RH. Ground where electic was dug up needs to be reseeded. 5-18-23 RH. Spoke with Wil Pave to get the site reseeded where ground was disturbed from the trenches of the electric.
Site Visit Partial 05/19/2023
Misc
Informational
05/15/2023
10-25-22 RH. Pre con meeting occurred with site superintendent. Project was discussed and work will begin at the beginning of November with silt fence being installed. 11-1-22 RH. Work has not started on site yet. 12-7-22 RH. No work on site today. 12-12-22 RH. No work on site today. 12-21-22 RH. No work on site today. 2-17-23 RH. No work for development on site today. 3-2-23 RH. No work being completed on site today for development. 3-9-23 RH. No work being completed on site today for development due to rain. 3-21-23 RH. No wok being comopleted due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No work for development in the AM. 4-14-23 RH. Contractor set up light pole bases with conduit running out of the bases. 4-21-23 RH. No work on site in the AM for development. 4-26-23 RH. No work for development in the AM. 4-27-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM. 5-12-23 RH. No work for development in the AM. 5-15-23 RH. No work for development in the AM. 5-19-23 RH. No work on site for development in the AM.
ESC - (Vegetation/Ground Cover) Partial 05/22/2023
Misc
Informational
05/18/2023
4-24-23 RH. Vegetation needs to be replaced after lines were dug to the differnt light poles. 5-10-23 RH. Ground was regraded where electric is going. 5-16-23 RH. Ground where electic was dug up needs to be reseeded. 5-18-23 RH. Spoke with Wil Pave to get the site reseeded where ground was disturbed from the trenches of the electric. 5-22-23 RH. Edge of parking lot still needs seeded.
Erosion Control Inspection Passed 6/5/2023 6/5/2023 06/05/2023
Misc
Informational
05/15/2023
11-3-22 RH. Contractor started clearing trees and placing silt fence. Grading will continue for placing the silt fence. 11-7-22 RH. Silt fence is up and in working order. 11-14-22 RH. Silt Fence is up and in working order. 11-21-22 RH. Silt fence is up and in working order. 11-28-22 RH. Silt fence is up and in working order. 12-12-22 RH. Erosion control is in place and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order. 4-20-23 RH. Erosion control is up and in working order. 5-1-23 RH. Erosion control is up and in working order. 5-15-23 RH. Erosion control is up and in working order.
Misc
Informational
06/05/2023
6-5-23 BR. Erosion is complete
Record Drawing Review Passed 11/22/2023 12/05/2023
Documents & Images
Date Uploaded File Type Document Name
10/14/2022 Receipt Receipt for transaction: 2022-008284
10/17/2022 Letter DE-Permit
10/17/2022 Approved Plans approved - Living faith PARKING LOT 10.17.22
10/26/2022 Letter INSPECTION SUMMARY
11/01/2022 Letter INSPECTION SUMMARY
11/03/2022 Letter INSPECTION SUMMARY
11/04/2022 Letter INSPECTION SUMMARY
11/07/2022 Letter INSPECTION SUMMARY
11/07/2022 Letter INSPECTION SUMMARY
11/08/2022 Letter INSPECTION SUMMARY
11/09/2022 Letter INSPECTION SUMMARY
11/09/2022 Letter INSPECTION SUMMARY
11/10/2022 Letter INSPECTION SUMMARY
11/14/2022 Letter INSPECTION SUMMARY
11/14/2022 Letter INSPECTION SUMMARY
11/17/2022 Letter INSPECTION SUMMARY
11/21/2022 Letter INSPECTION SUMMARY
11/22/2022 Letter INSPECTION SUMMARY
11/28/2022 Letter INSPECTION SUMMARY
11/29/2022 Letter INSPECTION SUMMARY
11/30/2022 Letter INSPECTION SUMMARY
12/01/2022 Letter INSPECTION SUMMARY
12/02/2022 Letter INSPECTION SUMMARY

12/02/2022 12-2-22 Concrete ticket for Curb
12/02/2022 Letter INSPECTION SUMMARY
12/02/2022 Letter INSPECTION SUMMARY
12/05/2022 Letter INSPECTION SUMMARY
12/05/2022 Letter INSPECTION SUMMARY
12/05/2022 Letter INSPECTION SUMMARY
12/07/2022 Letter INSPECTION SUMMARY
12/12/2022 Letter INSPECTION SUMMARY
12/12/2022 Letter INSPECTION SUMMARY
12/20/2022 Letter INSPECTION SUMMARY
12/21/2022 Letter INSPECTION SUMMARY
01/03/2023 Letter INSPECTION SUMMARY
01/30/2023 Letter INSPECTION SUMMARY
02/17/2023 Letter INSPECTION SUMMARY
02/21/2023 Letter INSPECTION SUMMARY
02/22/2023 Letter INSPECTION SUMMARY
02/22/2023 Letter INSPECTION SUMMARY
02/27/2023 Letter INSPECTION SUMMARY
03/03/2023 Letter INSPECTION SUMMARY
03/09/2023 Letter INSPECTION SUMMARY
03/14/2023 Letter INSPECTION SUMMARY
03/17/2023 Letter INSPECTION SUMMARY
03/21/2023 Letter INSPECTION SUMMARY
03/22/2023 Letter INSPECTION SUMMARY
03/24/2023 Letter INSPECTION SUMMARY
03/27/2023 Letter INSPECTION SUMMARY
10/03/2022 E8_1 POLE BASE 1 DETAIL
03/30/2023 Letter INSPECTION SUMMARY
03/31/2023 Letter INSPECTION SUMMARY
04/03/2023 Letter INSPECTION SUMMARY
04/03/2023 Letter INSPECTION SUMMARY
04/06/2023 Letter INSPECTION SUMMARY
04/06/2023 Letter INSPECTION SUMMARY
04/06/2023 Letter INSPECTION SUMMARY
04/07/2023 approved - E8.1 POLE BASE 1 DETAIL
04/07/2023 Letter INSPECTION SUMMARY
04/10/2023 Letter INSPECTION SUMMARY
04/10/2023 Letter INSPECTION SUMMARY
04/10/2023 Letter INSPECTION SUMMARY
04/11/2023 Letter INSPECTION SUMMARY

04/11/2023 asphalt Ticket base

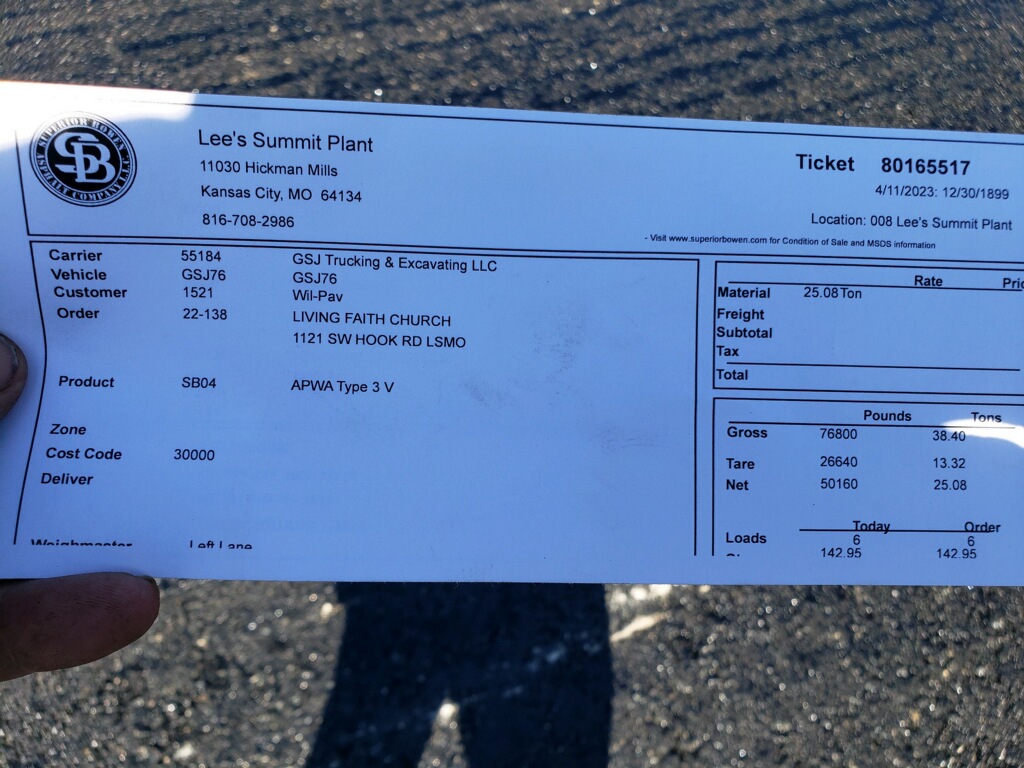

04/11/2023 Asphalt Surface Ticket
04/13/2023 Letter INSPECTION SUMMARY
04/13/2023 Letter INSPECTION SUMMARY
04/13/2023 Letter INSPECTION SUMMARY
04/13/2023 Letter INSPECTION SUMMARY
04/14/2023 Letter INSPECTION SUMMARY
04/18/2023 Letter INSPECTION SUMMARY
04/20/2023 Letter INSPECTION SUMMARY
04/21/2023 Letter INSPECTION SUMMARY
04/24/2023 Letter INSPECTION SUMMARY
04/26/2023 Asphalt Report
04/26/2023 Asphalt Compaction
04/26/2023 Letter INSPECTION SUMMARY
04/27/2023 Letter INSPECTION SUMMARY
05/01/2023 Letter INSPECTION SUMMARY
05/03/2023 Letter INSPECTION SUMMARY
05/05/2023 Letter INSPECTION SUMMARY
05/10/2023 Letter INSPECTION SUMMARY
05/12/2023 Letter INSPECTION SUMMARY
05/15/2023 Letter INSPECTION SUMMARY
05/15/2023 Letter INSPECTION SUMMARY
05/16/2023 Letter INSPECTION SUMMARY
05/18/2023 Letter INSPECTION SUMMARY
05/19/2023 Letter INSPECTION SUMMARY
05/22/2023 Letter INSPECTION SUMMARY
06/05/2023 Letter INSPECTION SUMMARY
11/15/2023 Plans As-Built C_202 Detention Basin Plan
11/15/2023 Plans As-BuiltC_300
12/05/2023 Letter INSPECTION SUMMARY
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
