Summary

PRSITE20201058
Development - Site
Final Acceptance
MID CONTINENT PUBLIC LIBRARY
DEVELOPMENT COMPLETE
Full site development for a library
04/27/2020
05/14/2020
01/18/2022
Locations
Contacts
MID CONTINENT PUBLIC LIBRARY, Address:15616 E US 24 HWY
JE DUNN CONSTRUCTION CO, Address:120 S CENTRAL AVE STE 350, Phone:(816) 474-8600

Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 04/27/2020 04/27/2020
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
9110073-Right of Way Permit Fee $80.00 $80.00 Paid 04/27/2020
91100C8-Sanitary Sewer Insp Fees $122.70 $122.70 Paid 04/27/2020
91100C9-Water Insp Fee $1,626.60 $1,626.60 Paid 04/27/2020
9110072-Water Test Fee $400.00 $400.00 Paid 04/27/2020
9110068-Storm Fee $6,013.95 $6,013.95 Paid 04/27/2020
9110081-Paved Surface Inspection Fee $25,956.60 $25,956.60 Paid 04/27/2020
9110071-Site Grading Fee $561.39 $561.39 Paid 04/27/2020
Outstanding Fees Amount Paid Owing Date Paid

$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Storm - Material Verification Passed 06/12/2020
Misc
Informational
06/12/2020
Inspected storm boxes, RCP piping , and materials all appears okay.
Storm - Pipe Partial 06/12/2020
Misc
Informational
06/12/2020
Approximately 20’ feet of 24” RCP was installed between existing storm box and newly installed storm box.
Storm - Outlet Structure Partial 06/12/2020
Misc
Informational
06/12/2020
Existing storm box collars was poured, A1 storm box was installed collars and inverts .
Storm - Outlet Structure Partial 06/15/2020
Misc
Informational
06/12/2020
Existing storm box collars was poured, A1 storm box was installed collars and inverts .
Misc
Informational
06/15/2020
A2 Storm box was installed on 6/15/20.
Storm - Pipe Partial 06/15/2020
Misc
Informational
06/12/2020
Approximately 20’ feet of 24” RCP was installed between existing storm box and newly installed storm box.
Misc
Informational
06/15/2020
SDI installed approximately 100’ of HDPE. 6/15/20
Storm - Pipe Partial 06/17/2020
Misc
Informational
06/15/2020
Approximately 20’ feet of 24” RCP was installed between existing storm box and newly installed storm box.
Misc
Informational
06/15/2020
SDI installed approximately 100’ of 24” HDPE. 6/15/20
Misc
Informational
06/17/2020
Contractor (SDI, She Digs It)installed approximately 150” of 24”HDPE . 6/16/20 Inspector John Di Mauro was onsite inspecting Storm Line A from Sta 11+25 to 12+75.
Storm - Outlet Structure Partial 06/17/2020
Misc
Informational
06/15/2020
Existing storm box collars was poured, A1 storm box was installed collars and inverts .
Misc
Informational
06/15/2020
A2 Storm box was installed on 6/15/20.
Misc
Informational
06/17/2020
A3 Storm box was placed but not completed 6/16/20.
Storm - Pipe Partial 06/17/2020
Misc
Informational
06/17/2020
Approximately 20’ feet of 24” RCP was installed between existing storm box and newly installed storm box.
Misc
Informational
06/17/2020
SDI installed approximately 100’ of 24” HDPE. 6/15/20
Misc
Informational
06/17/2020
Contractor (SDI, She Digs It)installed approximately 150” of 24”HDPE . 6/16/20 Inspector John Di Mauro was onsite inspecting Storm Line A from Sta 11+25 to 12+75.
Misc
Informational
06/17/2020
Contractor (SDI) installed approximately 206” of 24” HDPE. On Storm Line B from Sta 10+00 to 12+06 on 6/17/20.
Storm - Outlet Structure Partial 06/17/2020
Misc
Informational
06/17/2020
Existing storm box collars was poured, A1 storm box was installed collars and inverts .
Misc
Informational
06/17/2020
A2 Storm box was installed on 6/15/20.
Misc
Informational
06/17/2020
A3 Storm box was placed but not completed 6/16/20.
Misc
Informational
06/17/2020
B2 Storm box was was installed 6/17/20 invert and collar will be poured tomorrow.
Storm - Outlet Structure Partial 06/18/2020
Misc
Informational
06/17/2020
Existing storm box collars was poured, A1 storm box was installed collars and inverts .
Misc
Informational
06/17/2020
A2 Storm box was installed on 6/15/20.
Misc
Informational
06/17/2020
A3 Storm box was placed but not completed 6/16/20.
Misc
Informational
06/17/2020
B2 Storm box was was installed 6/17/20 invert and collar will be poured tomorrow.
Misc
Informational
06/18/2020
Contractor poured Inverts , collars, @ A2 & B2 and toewall @ B1 storm box. See project plan C 7.1, 7.0 & C 10.5 on toewall Section A-A. Contractor began installing B3 inverts and collars will be installed tomorrow 6/19/20 Friday.
Storm - Pipe Partial 06/18/2020
Misc
Informational
06/17/2020
Approximately 20’ feet of 24” RCP was installed between existing storm box and newly installed storm box.
Misc
Informational
06/17/2020
SDI installed approximately 100’ of 24” HDPE. 6/15/20
Misc
Informational
06/17/2020
Contractor (SDI, She Digs It)installed approximately 150” of 24”HDPE . 6/16/20 Inspector John Di Mauro was onsite inspecting Storm Line A from Sta 11+25 to 12+75.
Misc
Informational
06/17/2020
Contractor (SDI) installed approximately 206” of 24” HDPE. On Storm Line B from Sta 10+00 to 12+06 on 6/17/20.
Misc
Informational
06/18/2020
Contractor said the grade for storm pipe from B1 to B2 was installed @ .53% as design. The grade had to be adjust from B2 to B3 to hit the grading required, the asbuilt will reflect change.
Misc
Informational
06/18/2020
Contractor (SDI) installed Approximately 106’ of 24” HDPE from storm box B2 & B3.

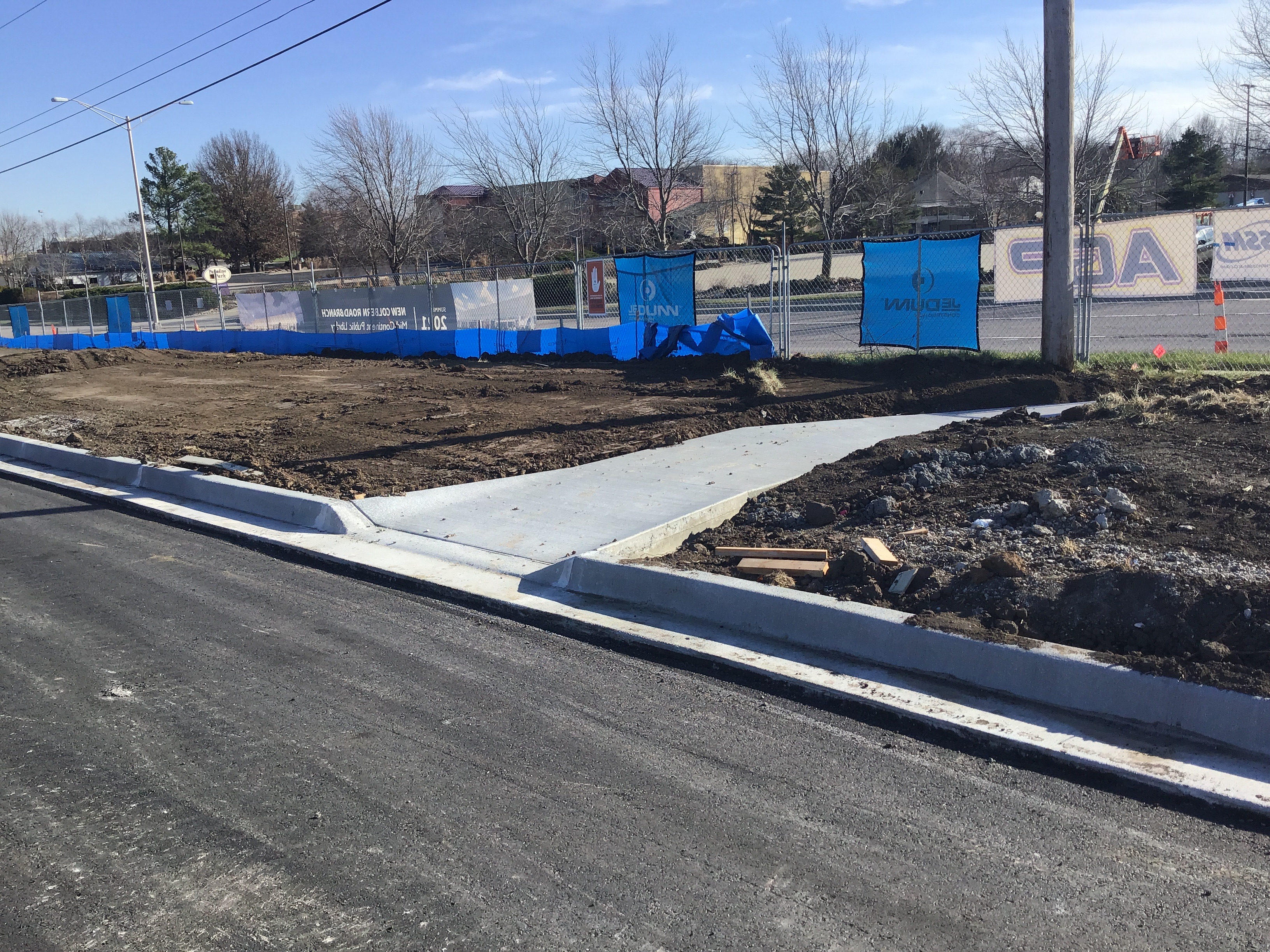

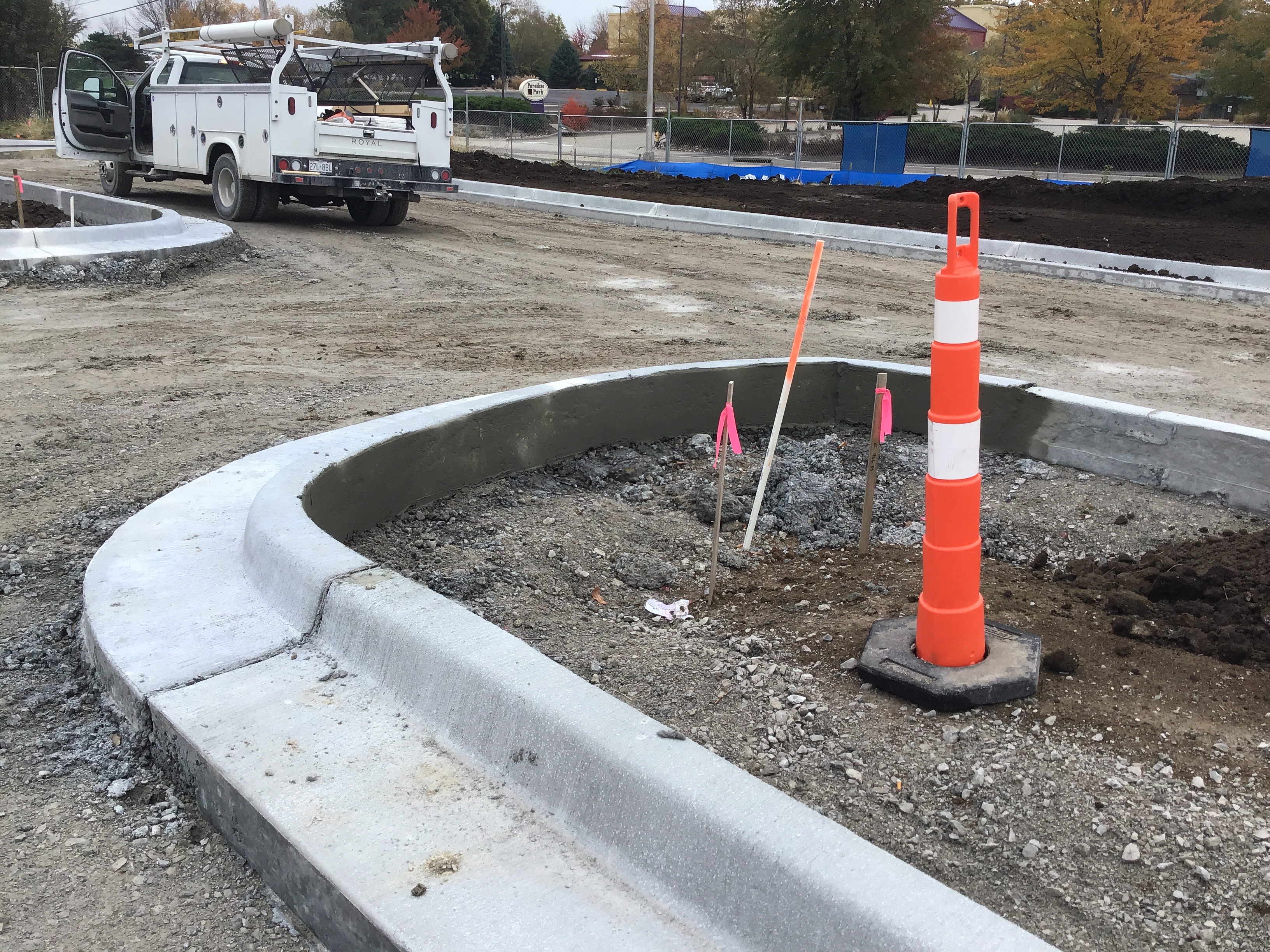

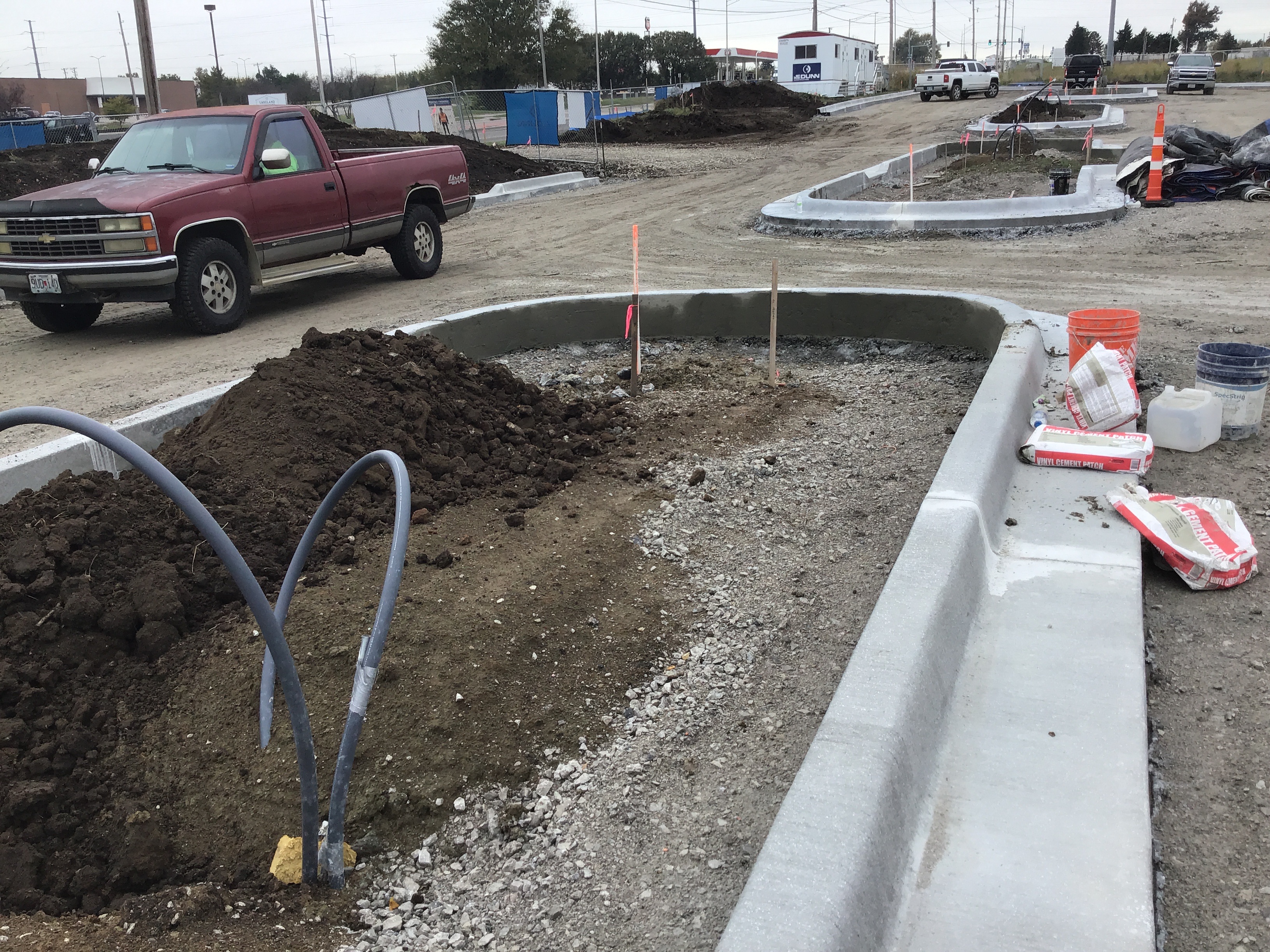

Sidewalk Inspection Passed 06/22/2020
Misc
Informational
06/22/2020
Contractor removed the sidewalk at the beginning of the project. Sidewalk was pour and restore back to original form including the new storm box A1.
Storm - Pipe Partial 06/22/2020
Misc
Informational
06/18/2020
Approximately 20’ feet of 24” RCP was installed between existing storm box and newly installed storm box.
Misc
Informational
06/18/2020
SDI installed approximately 100’ of 24” HDPE. 6/15/20
Misc
Informational
06/18/2020
Contractor (SDI, She Digs It)installed approximately 150” of 24”HDPE . 6/16/20 Inspector John Di Mauro was onsite inspecting Storm Line A from Sta 11+25 to 12+75.
Misc
Informational
06/18/2020
Contractor (SDI) installed approximately 206” of 24” HDPE. On Storm Line B from Sta 10+00 to 12+06 on 6/17/20.
Misc
Informational
06/18/2020
Contractor said the grade for storm pipe from B1 to B2 was installed @ .53% as design. The grade had to be adjust from B2 to B3 to hit the grading required, the asbuilt will reflect change.
Misc
Informational
06/22/2020
Contractor installed approximately 179’ of 15” HDPE on 6/19/20.
Storm - Pipe Partial 06/23/2020
Misc
Informational
06/22/2020
Approximately 20’ feet of 24” RCP was installed between existing storm box and newly installed storm box.
Misc
Informational
06/22/2020
SDI installed approximately 100’ of 24” HDPE. 6/15/20
Misc
Informational
06/22/2020
Contractor (SDI, She Digs It)installed approximately 150” of 24”HDPE . 6/16/20 Inspector John Di Mauro was onsite inspecting Storm Line A from Sta 11+25 to 12+75.
Misc
Informational
06/22/2020
Contractor (SDI) installed approximately 206” of 24” HDPE. On Storm Line B from Sta 10+00 to 12+06 on 6/17/20.
Misc
Informational
06/22/2020
Contractor said the grade for storm pipe from B1 to B2 was installed @ .53% as design. The grade had to be adjust from B2 to B3 to hit the grading required, the asbuilt will reflect change.
Misc
Informational
06/22/2020
Contractor installed approximately 179’ of 15” HDPE on 6/19/20. LINE C
Misc
Informational
06/23/2020
6-23-20 9:30am Contractor (SDI) installed approximately 100’ of 15” HDPE Line C . Concrete schedule to come at 12:00pm to pour Toe-wall, inverts & collars on Line C. Contractor poured concrete and shaped structures.

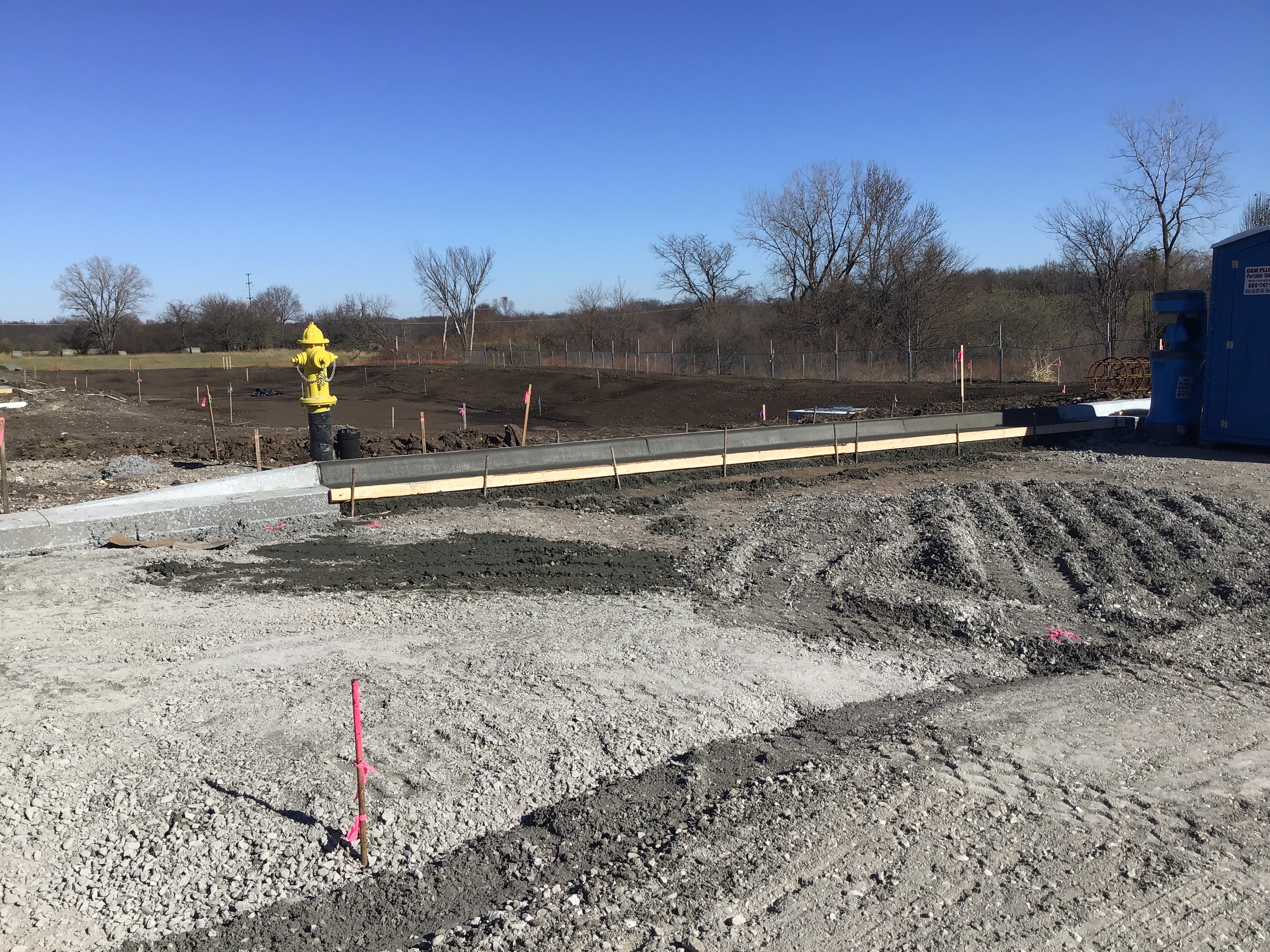

Roof Drain Partial 06/24/2020
Misc
Informational
06/24/2020
Contractor plans to install roof drain 10”/96’ & 18”/25’ HDPE pipe. See sheet C6.0
Roof Drain Partial 06/29/2020
Misc
Informational
06/24/2020
Contractor plans to install roof drain 10”/96’ & 18”/25’ HDPE pipe. See sheet C6.0
Misc
Informational
06/29/2020
6/29/20 Monday completed installation roof drains . See sheet C 6.0 ST-5 .
Storm - Outlet Structure Partial 06/29/2020
Misc
Informational
06/18/2020
Existing storm box collars was poured, A1 storm box was installed collars and inverts .
Misc
Informational
06/18/2020
A2 Storm box was installed on 6/15/20.
Misc
Informational
06/18/2020
A3 Storm box was placed but not completed 6/16/20.
Misc
Informational
06/18/2020
B2 Storm box was was installed 6/17/20 invert and collar will be poured tomorrow.
Misc
Informational
06/18/2020
Contractor poured Inverts , collars, @ A2 & B2 and toewall @ B1 storm box. See project plan C 7.1, 7.0 & C 10.5 on toewall Section A-A.
Misc
Informational
06/22/2020
Storm box B3 & B4 were installed and inverts and collars were poured.
Misc
Informational
06/29/2020
6/29/20 Contractor poured toe wall with special concrete mix 5000 psi @ Line A.
Sanitary Sewer Construction Inspection Partial 06/29/2020
Misc
Informational
06/29/2020
Contractor completed the Tie -in on the main sewer line with a 8”x4” wye & installed 4” service line as-per plan see C6.0 ( ss-1,ss-2, & ss-3). 6/29/20 Monday
Fire Line Construction Inspection Partial 07/01/2020
Misc
Informational
07/01/2020
6-30-20 Contractor began to install the fire line approximately Siamese 6” twin fire lines coming from the north in of the building 90 degree bends on both lines. Approximately 100’ of 6” Fire Line was layed.
Misc
Informational
07/01/2020
7-1-20 Contractor installed approximately 180’ of 6” PVC Fire Line. The outside 6” line stop and 90 degree crossing over the inside 6” line to the proposed bldg for the future fire hook up. Two 11 1/2 deg bends and Fire hydrant. Backing blocks were poured behind hydrant tee and two 11 1/2 bends and a temporary straddle block was poured where contractor stopped with mega lugs.
Water Line - Construction Inspection Partial 07/01/2020
Misc
Informational
07/01/2020
2” Blue poly domestic water line was layed approximately 100’ on 6-30-20 and 180’ 7-1-20. It layed just to the outside of the Fire Line.
Misc
Informational
07/06/2020
7/6/20 Monday & sunny contractor installed 6” PVC pipe on (Fire Lane) approximately 210’ . Contractor will e-mail picture of water line for additional documentation of project.
Fire Line Construction Inspection Partial 07/07/2020
Misc
Informational
07/01/2020
6-30-20 Contractor began to install the fire line approximately Siamese 6” twin fire lines coming from the north in of the building 90 degree bends on both lines. Approximately 100’ of 6” Fire Line was layed.
Misc
Informational
07/07/2020
7-6-20 Monday 210’ of 6” PVC was installed and a 6”x6” tee . 7-7-20 Tuesday contractor installed approximately 50’ of 6” PVC with 2/45 deg bends leading to a Hydrant assembly at the end of line. See project plans sheet C6.0 Coming out of the 6”x6” tee five foot 6” PVC and then 45 deg bend and then another piece of pipe & a 45 deg bend. Contractor will submit drawing as-built of this field change.
Water Line - Construction Inspection Partial 07/07/2020
Misc
Informational
07/01/2020
2” Blue poly domestic water line was layed approximately 100’ on 6-30-20 and 180’ 7-1-20. Its layed just to the outside of the Fire Line.
Misc
Informational
07/07/2020
7-7-20 Tuesday continued to run 2” Blue poly domestic water line approximately 100’ .
Storm - Pipe Partial 07/16/2020
Misc
Informational
06/23/2020
Approximately 20’ feet of 24” RCP was installed between existing storm box and newly installed storm box.
Misc
Informational
06/23/2020
SDI installed approximately 100’ of 24” HDPE. 6/15/20
Misc
Informational
06/23/2020
Contractor (SDI, She Digs It)installed approximately 150” of 24”HDPE . 6/16/20 Inspector John Di Mauro was onsite inspecting Storm Line A from Sta 11+25 to 12+75.
Misc
Informational
06/23/2020
Contractor (SDI) installed approximately 206” of 24” HDPE. On Storm Line B from Sta 10+00 to 12+06 on 6/17/20.
Misc
Informational
06/23/2020
Contractor said the grade for storm pipe from B1 to B2 was installed @ .53% as design. The grade had to be adjust from B2 to B3 to hit the grading required, the asbuilt will reflect change.
Misc
Informational
06/23/2020
Contractor installed approximately 179’ of 15” HDPE on 6/19/20. LINE C
Misc
Informational
06/23/2020
6-23-20 9:30am Contractor (SDI) installed approximately 100’ of 15” HDPE Line C . Concrete schedule to come at 12:00pm to pour Toe-wall, inverts & collars on Line C.
Misc
Informational
07/16/2020
7/16/20 Thursday ST-6 Area Drains ( 8” HDPE and Nyloplast catch basin ) ST-6a 45’ LF of 8” HDPE to 8” wye. HDPE 8” wye to ST-6b 8’ LF of 8” HDPE & HDPE 8” wye 54 LF of 8” HDPE to storm box B4.
Storm - Outlet Structure Partial 07/16/2020
Misc
Informational
07/16/2020
Misc
Informational
07/16/2020
7/16/20 Thursday B4 storm box contractor (SDI) had to cut in the box to run 8” HDPE area drain pipe. Contractor poured collar for B4 storm box.
Fire Line Construction Inspection Partial 07/17/2020
Misc
Informational
07/07/2020
6-30-20 Contractor began to install the fire line approximately Siamese 6” twin fire lines coming from the north in of the building 90 degree bends on both lines. Approximately 100’ of 6” Fire Line was layed.
Misc
Informational
07/07/2020
7-6-20 Monday 210’ of 6” PVC was installed and a 6”x6” tee . 7-7-20 Tuesday contractor installed approximately 50’ of 6” PVC with 2/45 deg bends leading to a Hydrant assembly at the end of line. See project plans sheet C6.0 Coming out of the 6”x6” tee five foot 6” PVC and then 45 deg bend and then another piece of pipe & a 45 deg bend. Contractor will submit drawing as-built of this field change.
Misc
Informational
07/17/2020
7/17/20 Friday tie in fire line to existing line with a 6” coupling w/mega lugs.
Water Line - Construction Inspection Partial 07/17/2020
Misc
Informational
07/07/2020
2” Blue poly domestic water line was layed approximately 100’ on 6-30-20 and 180’ 7-1-20. Its layed just to the outside of the Fire Line.
Misc
Informational
07/07/2020
7-7-20 Tuesday continued to run 2” Blue poly domestic water line approximately 100’ .
Misc
Informational
07/17/2020
7/7/20 Friday connected the 2” Blue poly domestic line to existing copper line.
Backflow Preventer and Vault Partial 08/04/2020
Misc
Informational
08/04/2020
8/4/20 Monday Contractor (SDI) is installing Backflow Preventer as-built will reflect the change. They were unable to make new lid fit the old Backflow Preventer box so replacement was the sensible and was actually the original plan. I will continue to monitor progress throughout the day.
Driveway Inspection Partial 08/05/2020
Misc
Informational
08/05/2020

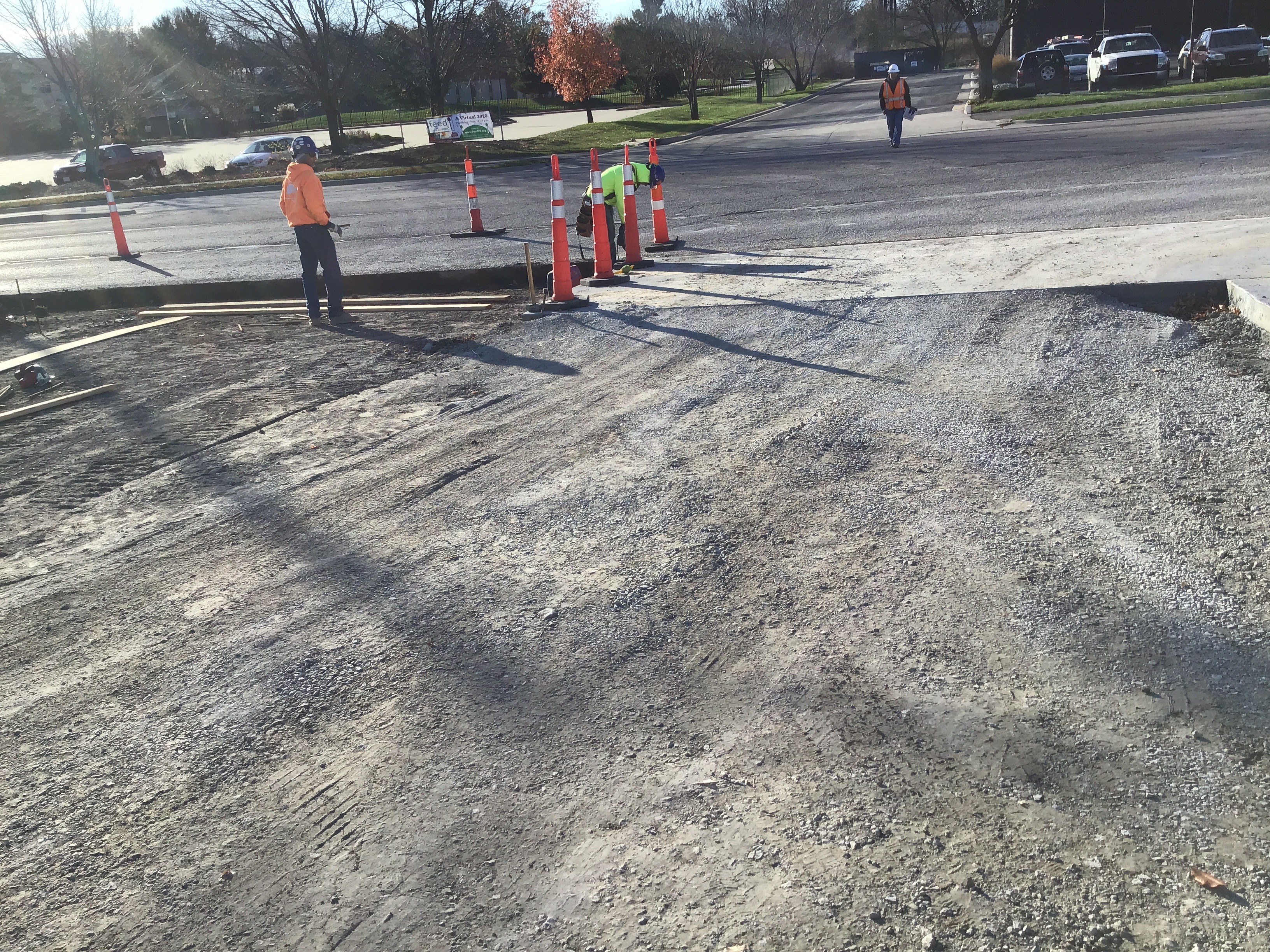

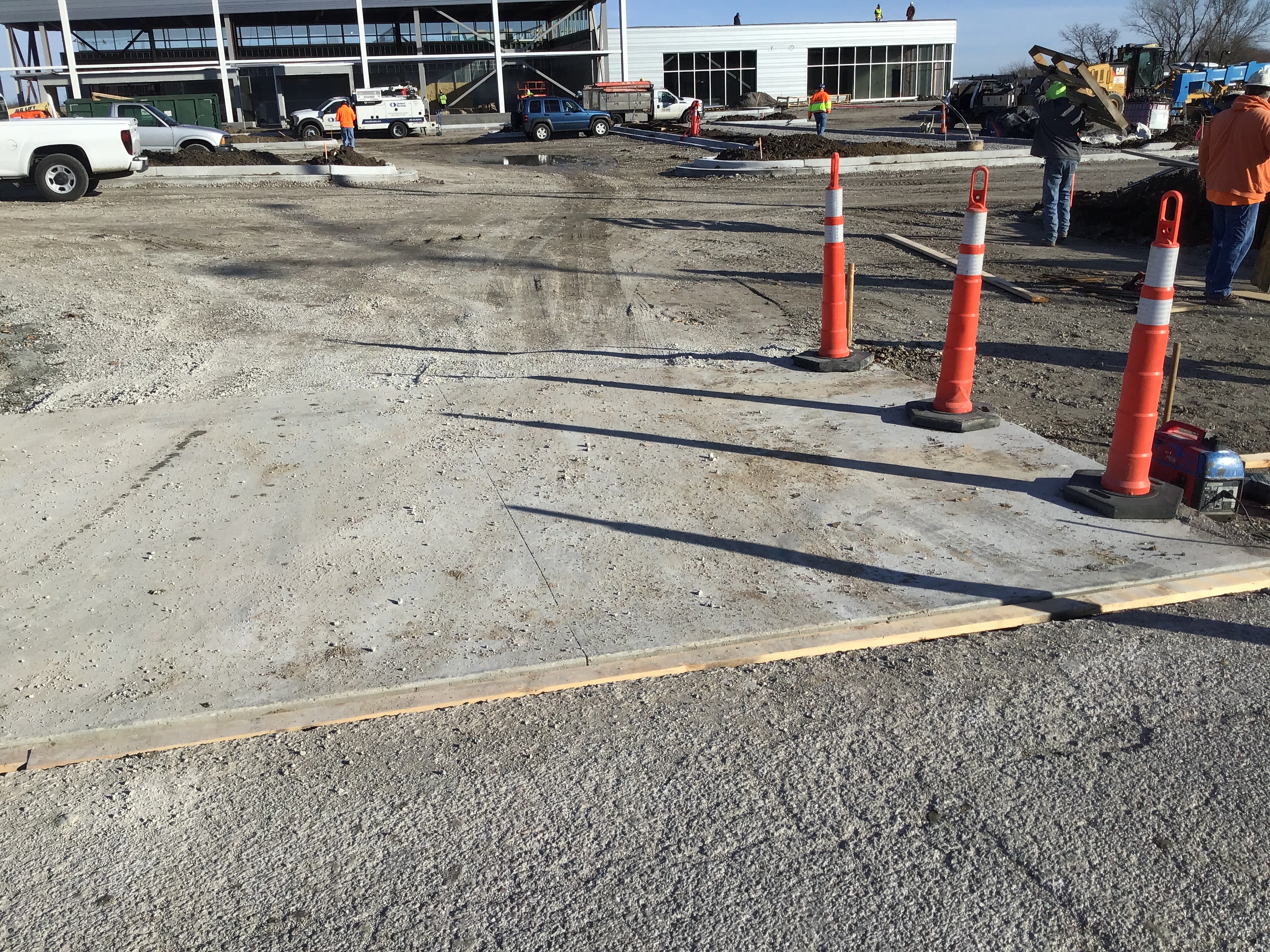

Contractor began to chemically treat parking lot area and driveway for site per plan see C10.6. ( Asphalt Pavement ( Light Traffic) & (Heavy Traffic) with aggregate base section & PCC Drive Pavement Section).
Driveway Inspection Partial 08/17/2020
Misc
Informational
08/05/2020
Contractor began to chemically treat parking lot area and driveway for site per plan see C10.6. ( Asphalt Pavement ( Light Traffic) & (Heavy Traffic) with aggregate base section & PCC Drive Pavement Section).
Misc
Informational
08/17/2020
8/17/20 Monday 11:43AM Contractor began installing 6” Type 5 MODOT Base per LS Section 5200 last Thursday and is still in the process of installation.

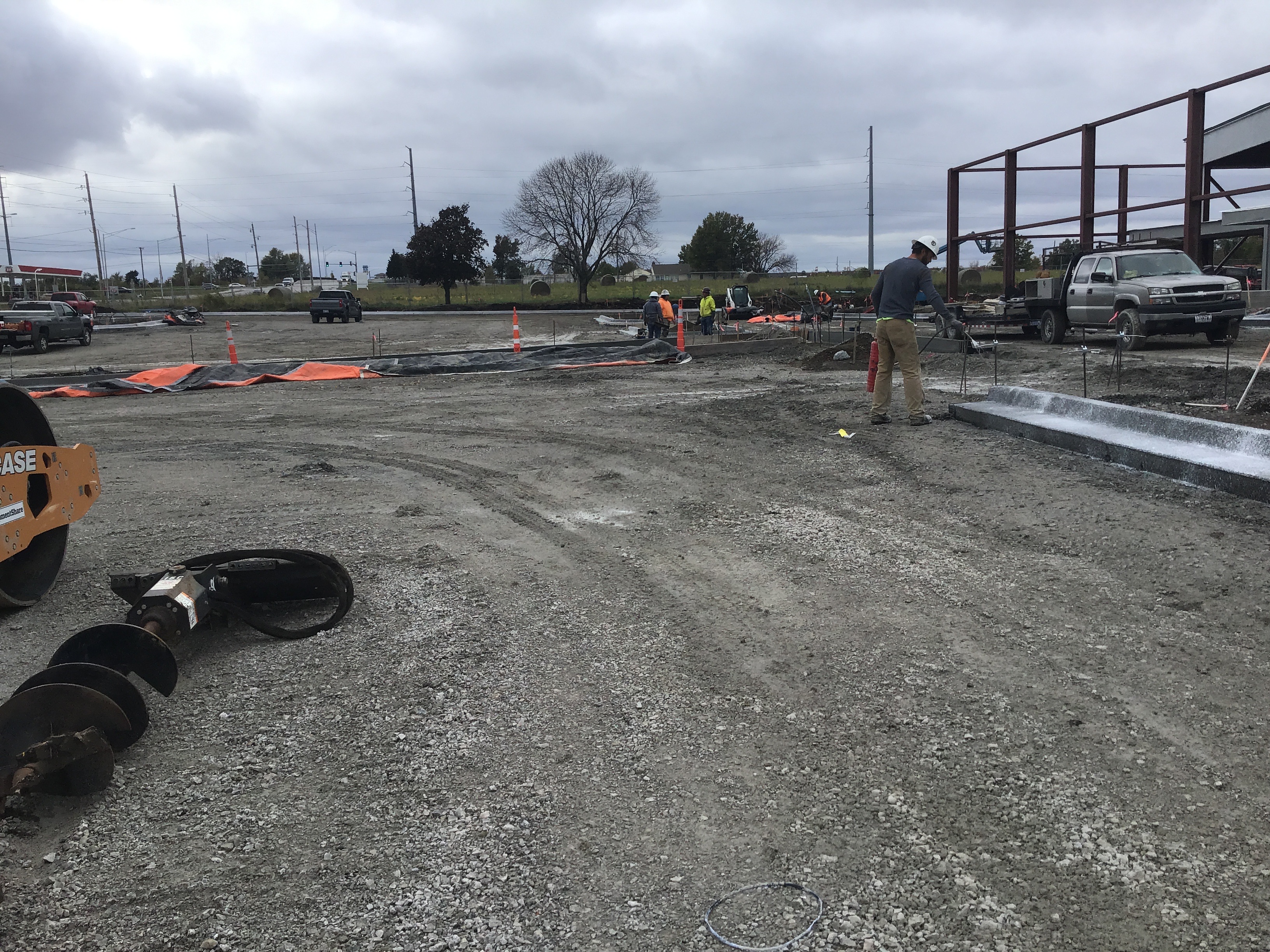

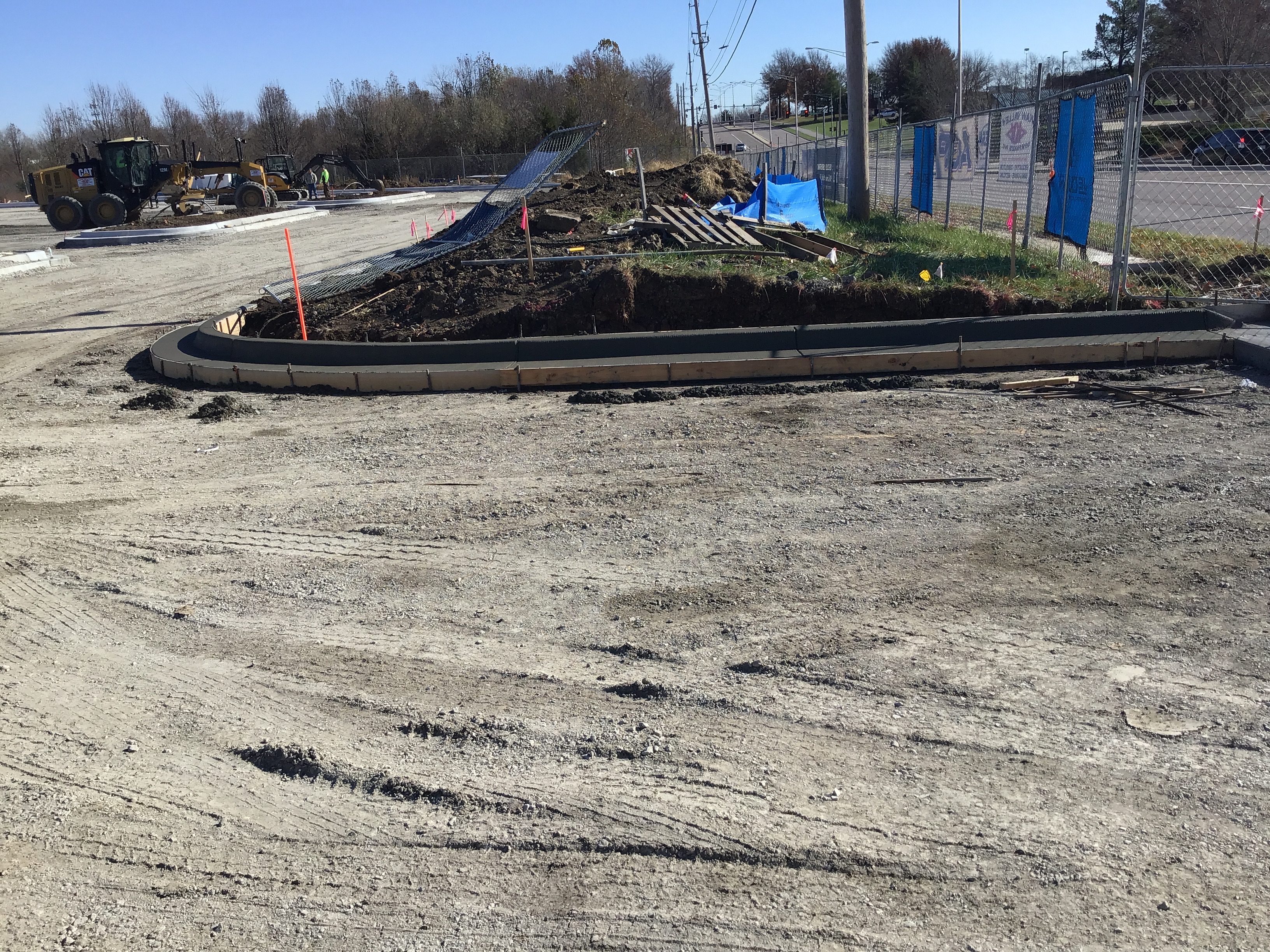

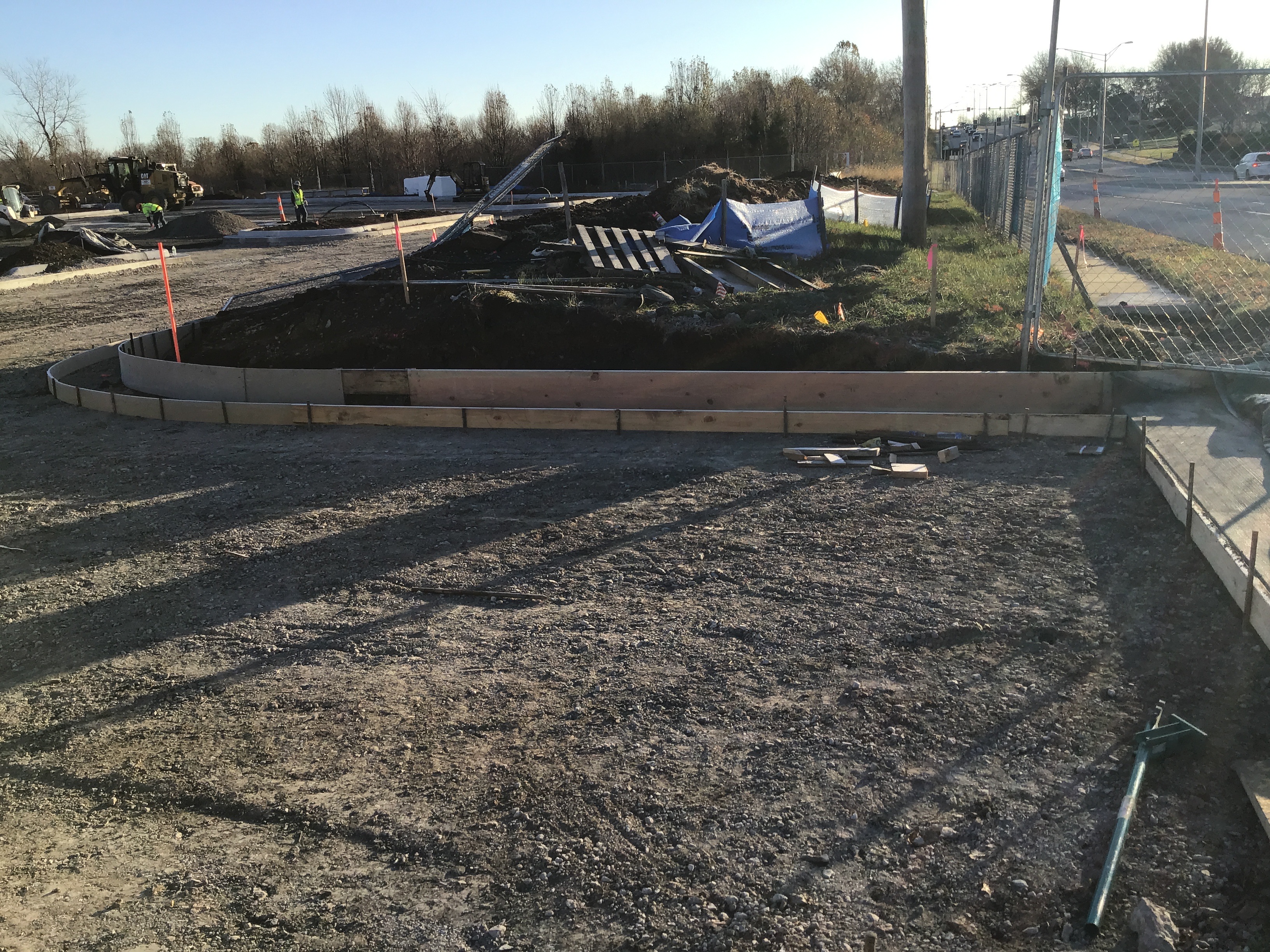

Site Visit Partial 08/26/2020
Misc
Informational
06/25/2020

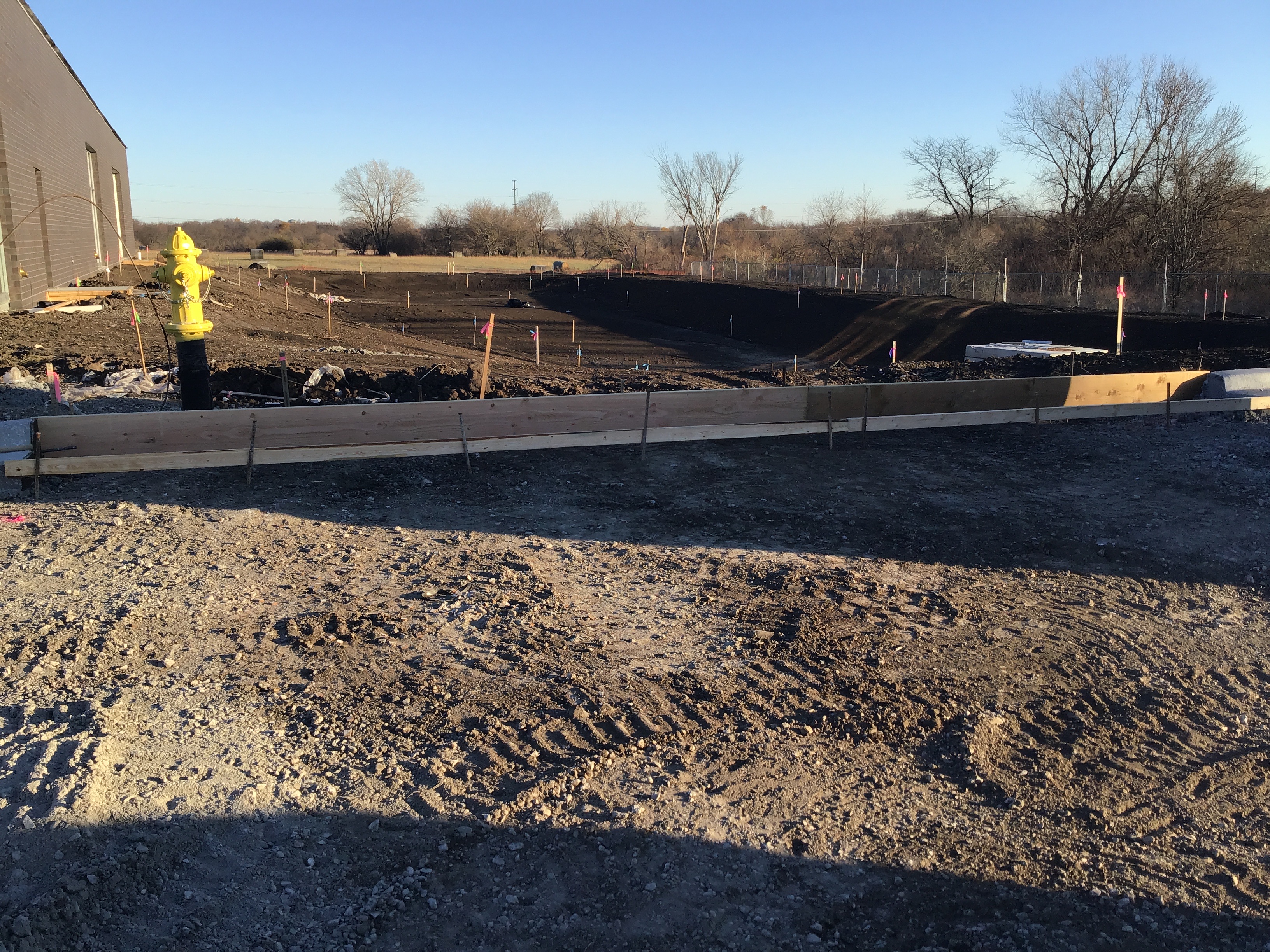

Visit site it appears that contractor (SDI) just did some land Excavation.
Misc
Informational
08/26/2020
8/26/20 Wednesday Contractor has halt work on parking lot until further progress on Library. All other utilities have been installed. Parking, final grading, and vegetation are the last items needed.
Fire Line - Flush Passed 09/30/2020
Misc
Informational
07/17/2020
7/17/20 Friday Contractor (SDI) flushed fire line to blow off any possible debris.
Fire Line - Flush Passed 09/30/2020
Misc
Informational
07/17/2020
7/17/20 Friday Contractor (SDI) flushed fire line to blow off any possible debris.
Curb - Proof Roll Passed 10/21/2020
Misc
Informational
10/21/2020
10/21/20 Wednesday PSI was the third party that also inspected curb proof roll, inspection was passed inspection.
Public Curb Inspection Partial 10/21/2020
Misc
Informational
10/21/2020
10/21/20 Wednesday Contractor poured curbs in parking lots. 3:45PM
Public Curb Inspection Partial 10/23/2020
Misc
Informational
10/21/2020
10/21/20 Wednesday Contractor poured curbs in parking lots. 3:45PM
Misc
Informational
10/23/2020
10/22/20 Friday Contractor has been pouring the curbs for the pass three days. Today I inform the contractor that they need to have blankets on site due to the cold weather condition. Temperatures will drop to 33 degrees and the wind chill will make the temperatures drop to 30 degrees.
Public Curb Inspection Partial 10/28/2020
Misc
Informational
10/23/2020
10/21/20 Wednesday Contractor poured curbs in parking lots. 3:45PM
Misc
Informational
10/23/2020
10/22/20 Friday Contractor has been pouring the curbs for the pass three days. Today I inform the contractor that they need to have blankets on site due to the cold weather condition. Temperatures will drop to 33 degrees and the wind chill will make the temperatures drop to 30 degrees.
Misc
Informational
10/28/2020
10/28/20 Wednesday Contractor patched honey combs on island curbs. KAW Valley filled islands in with soil.

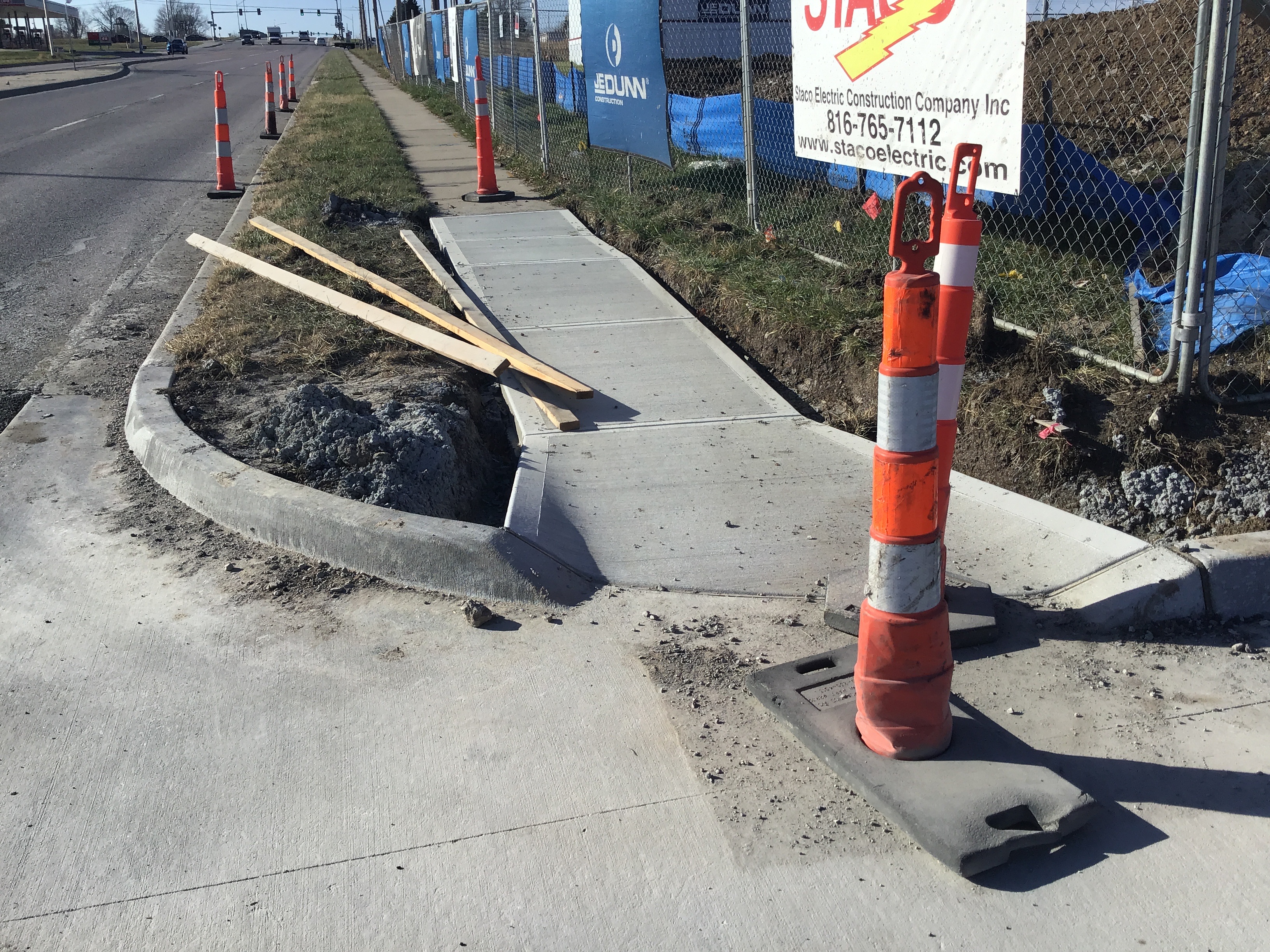

Driveway Inspection Partial 11/12/2020
Misc
Informational
11/12/2020
11/12/20 Thursday Contractor has installed the Westside of approach. Contractor began excavation and forming of Eastside of approach to match sidewalk.
Driveway Inspection Partial 11/13/2020
Misc
Informational
08/17/2020

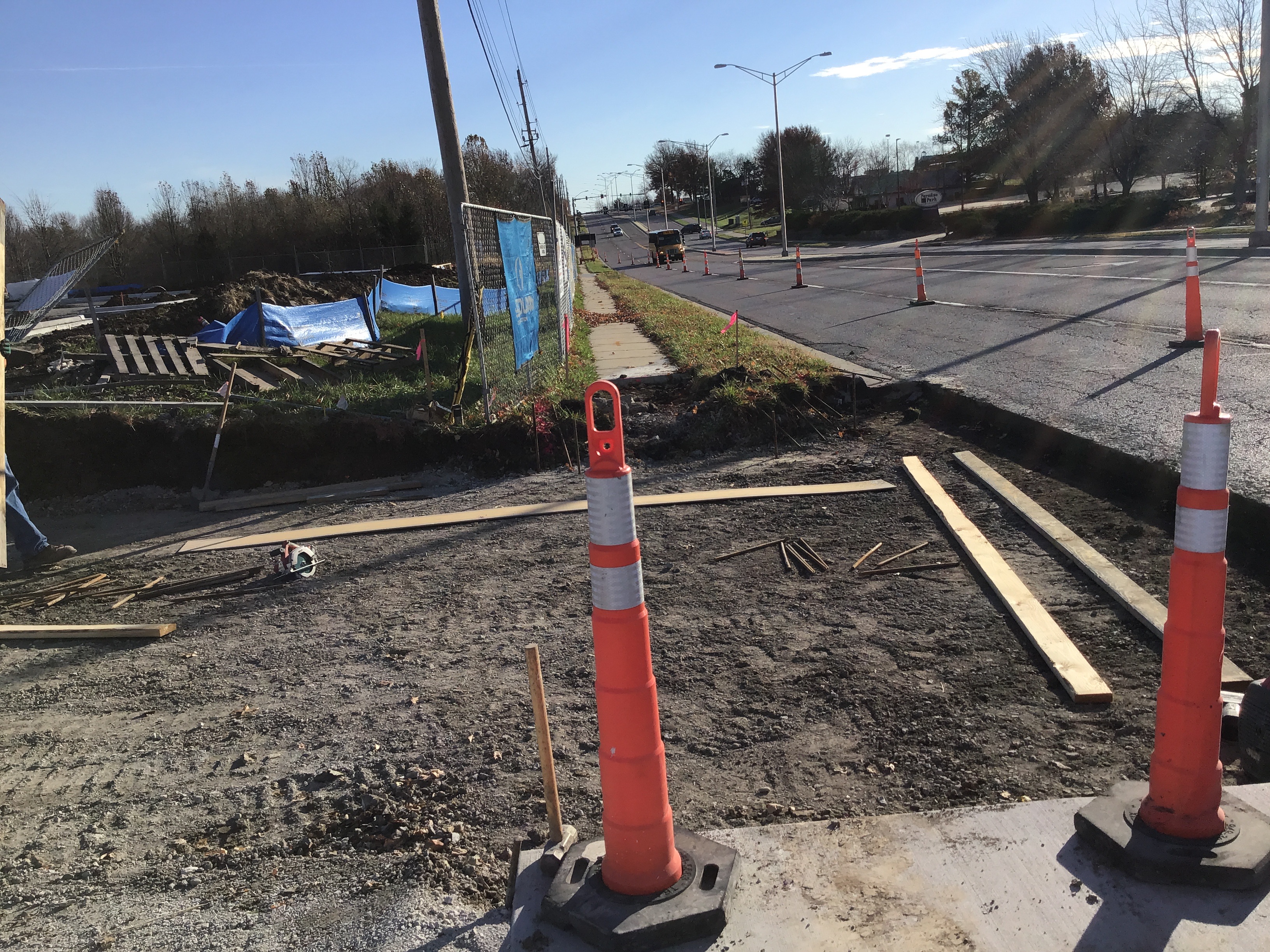

Contractor began to chemically treat parking lot area and driveway for site per plan see C10.6. ( Asphalt Pavement ( Light Traffic) & (Heavy Traffic) with aggregate base section & PCC Drive Pavement Section).
Misc
Informational
08/17/2020
8/17/20 Monday 11:43AM Contractor began installing 6” Type 5 MODOT Base per LS Section 5200 last Thursday and is still in the process of installation.
Misc
Informational
11/13/2020
11/13/20 Friday Contractor poured concrete driveway approach on the Eastside to complete driveway. Blankets were placed over the driveway.
Public Curb Inspection Partial 11/13/2020
Misc
Informational
10/28/2020
10/21/20 Wednesday Contractor poured curbs in parking lots. 3:45PM
Misc
Informational
10/28/2020
10/22/20 Friday Contractor has been pouring the curbs for the pass three days. Today I inform the contractor that they need to have blankets on site due to the cold weather condition. Temperatures will drop to 33 degrees and the wind chill will make the temperatures drop to 30 degrees.
Misc
Informational
10/28/2020
10/28/20 Wednesday Contractor patched honey combs on island curbs. KAW Valley filled islands in with soil.
Misc
Informational
11/13/2020

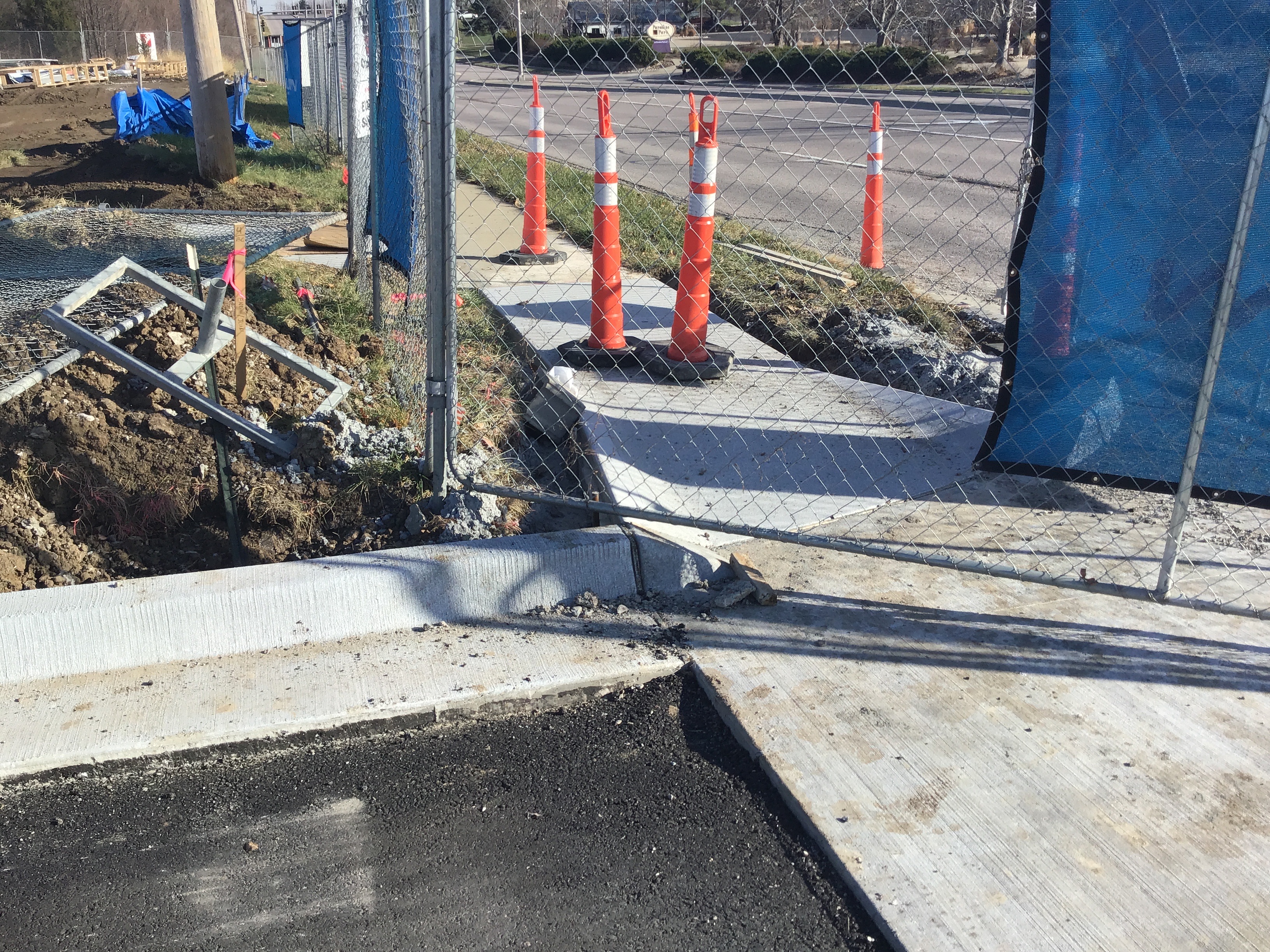

11/13/20 Friday Contractor poured approximately 20’ of curb on the Northeast end of parking lot & the curb radius to the Eastside of the driveway approach.
ADA Inspection Partial 11/20/2020
Misc
Informational
11/20/2020
11/20/20 Friday Talked with contractor ( JE DUNN) with Tom Taylor about the installation of ADA ramp. Contractor is schedule to pour ADA ramp, & sidewalk today.

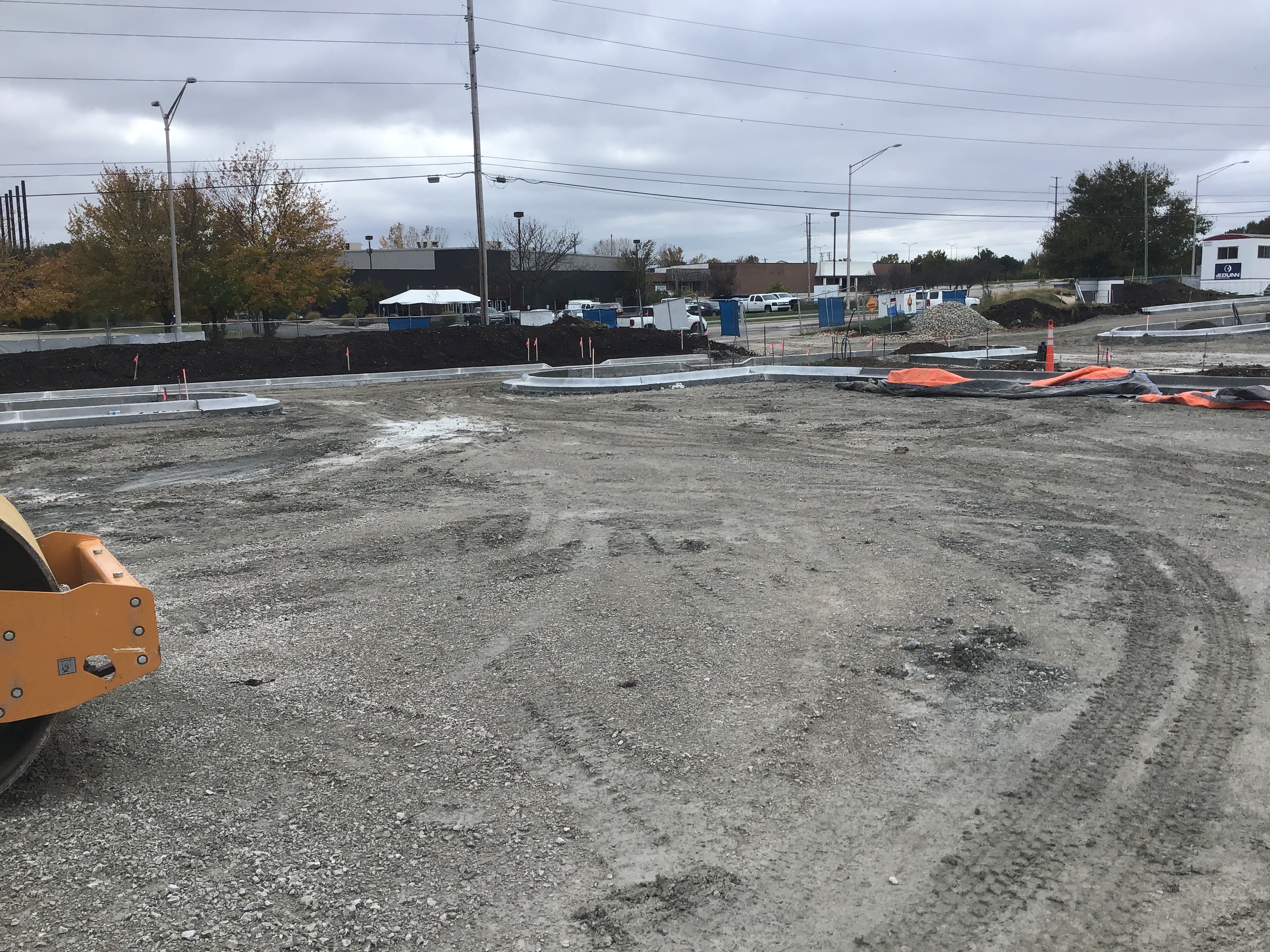

Pavement-Aggregate Base Partial 12/01/2020
Misc
Informational
12/01/2020

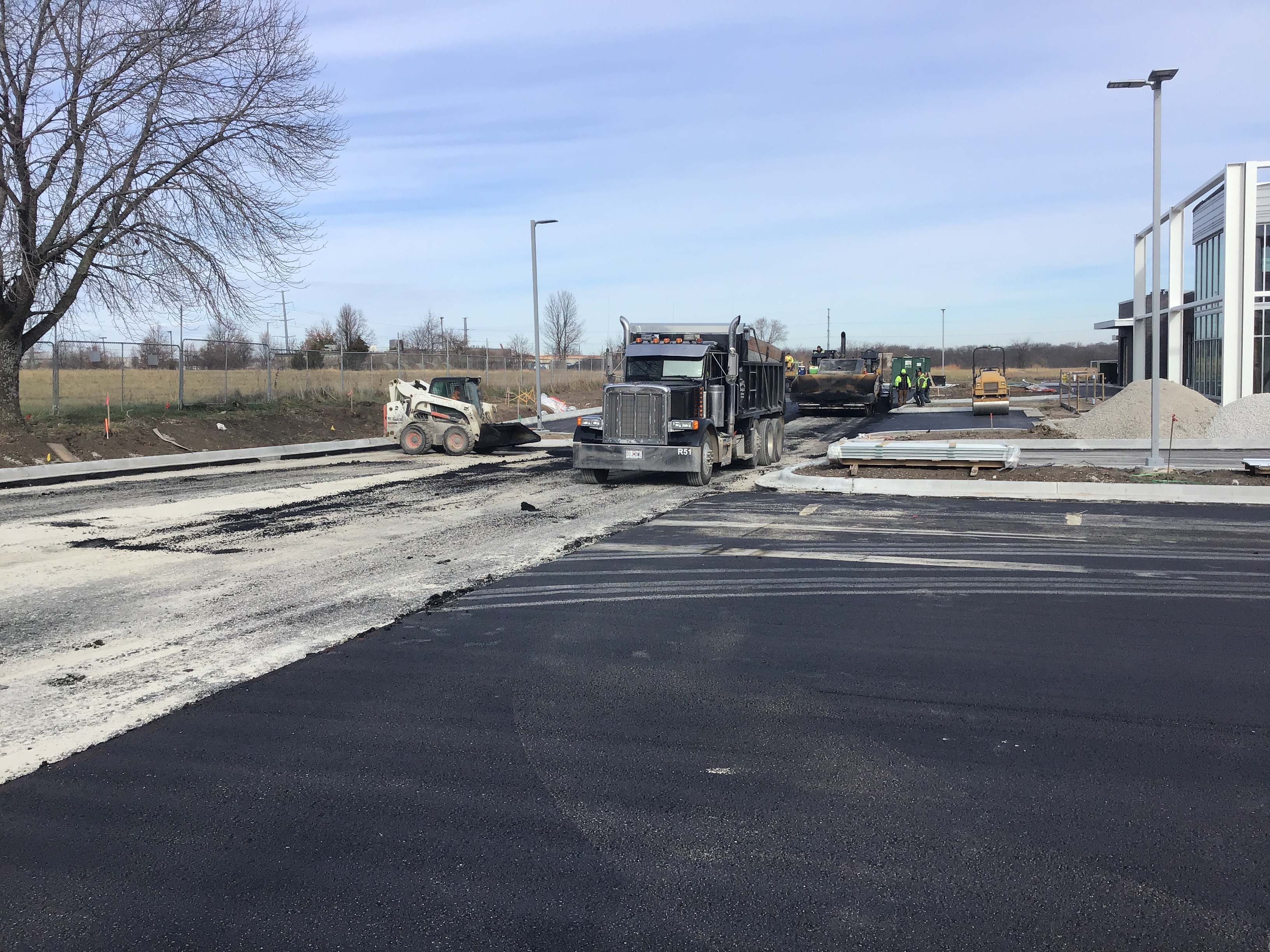

12/1/20 Tuesday 8:30 am Contractor began laying base asphalt as-per plan.
Pavement-Aggregate Base Partial 12/01/2020
Misc
Informational
12/01/2020
12/1/20 Tuesday 8:30 AM Contractor began laying base asphalt as-per plan. Hanrahan Asphalt Paving Co., INC. did the work and PSI performed the testing of the product. PSI inspector is satisfied with result as of 12:15 PM 12/1/20. Contractor layed approximately 1200 Tons of asphalt.
Pavement-Aggregate Base Partial 12/02/2020
Misc
Informational
12/01/2020
12/1/20 Tuesday 8:30 AM Contractor began laying base asphalt as-per plan. Hanrahan Asphalt Paving Co., INC. did the work and PSI performed the testing of the product. PSI inspector is satisfied with result as of 12:15 PM 12/1/20.
Misc
Informational
12/02/2020
12/2/20 Wednesday 10:49 AM Contractor continued laying Type -2 base asphalt.
ADA Inspection Passed 12/02/2020
Misc
Informational
11/20/2020
11/20/20 Friday Talked with contractor ( JE DUNN) with Tom Taylor about the installation of ADA ramp. Contractor is schedule to pour ADA ramp, & sidewalk today.
Misc
Informational
12/02/2020
12/02/20 Wednesday 1:44 PM Worked was completed on 11/24 or 11/25 (Inspector was on vacation) on ADA ramps one to the Westside, Eastside, ADA leading to the parking lot.
Record Drawing Review Passed 4/23/2021 04/29/2021
Misc
Informational
04/29/2021
Contractor delivered As Built to the City of Lee’s Summit of detention base and Mass Grading, this was match through field inspection variance fell within allowable tolerance as verified by inspector .
Sewer Service Inspection Passed 01/18/2022
Storm - Pipe Passed 01/18/2022
Misc
Informational
07/16/2020
Approximately 20’ feet of 24” RCP was installed between existing storm box and newly installed storm box.
Misc
Informational
07/16/2020
SDI installed approximately 100’ of 24” HDPE. 6/15/20
Misc
Informational
07/16/2020
Contractor (SDI, She Digs It)installed approximately 150” of 24”HDPE . 6/16/20 Inspector John Di Mauro was onsite inspecting Storm Line A from Sta 11+25 to 12+75.
Misc
Informational
07/16/2020
Contractor (SDI) installed approximately 206” of 24” HDPE. On Storm Line B from Sta 10+00 to 12+06 on 6/17/20.
Misc
Informational
07/16/2020
Contractor said the grade for storm pipe from B1 to B2 was installed @ .53% as design. The grade had to be adjust from B2 to B3 to hit the grading required, the asbuilt will reflect change.
Misc
Informational
07/16/2020
Contractor installed approximately 179’ of 15” HDPE on 6/19/20. LINE C
Misc
Informational
07/16/2020
6-23-20 9:30am Contractor (SDI) installed approximately 100’ of 15” HDPE Line C . Concrete schedule to come at 12:00pm to pour Toe-wall, inverts & collars on Line C.
Misc
Informational
07/16/2020
7/16/20 Thursday ST-6 Area Drains ( 8” HDPE and Nyloplast catch basin ) ST-6a 45’ LF of 8” HDPE to 8” wye. HDPE 8” wye to ST-6b 8’ LF of 8” HDPE & HDPE 8” wye 54 LF of 8” HDPE to storm box B4.
Fire Line Construction Inspection Passed 01/18/2022
Misc
Informational
07/17/2020
6-30-20 Contractor began to install the fire line approximately Siamese 6” twin fire lines coming from the north in of the building 90 degree bends on both lines. Approximately 100’ of 6” Fire Line was layed.
Misc
Informational
07/17/2020
7-6-20 Monday 210’ of 6” PVC was installed and a 6”x6” tee . 7-7-20 Tuesday contractor installed approximately 50’ of 6” PVC with 2/45 deg bends leading to a Hydrant assembly at the end of line. See project plans sheet C6.0 Coming out of the 6”x6” tee five foot 6” PVC and then 45 deg bend and then another piece of pipe & a 45 deg bend. Contractor will submit drawing as-built of this field change.
Misc
Informational
07/17/2020
7/17/20 Friday tie in fire line to existing line with a 6” coupling w/mega lugs.
Water Line - Construction Inspection Passed 01/18/2022
Misc
Informational
07/17/2020
2” Blue poly domestic water line was layed approximately 100’ on 6-30-20 and 180’ 7-1-20. Its layed just to the outside of the Fire Line.
Misc
Informational
07/17/2020
7-7-20 Tuesday continued to run 2” Blue poly domestic water line approximately 100’ .
Misc
Informational
07/17/2020
7/7/20 Friday connected the 2” Blue poly domestic line to existing copper line.
Backflow Preventer and Vault Passed 01/18/2022
Misc
Informational
08/04/2020

8/4/20 Monday Contractor (SDI) is installing Backflow Preventer as-built will reflect the change. They were unable to make new lid fit the old Backflow Preventer box so replacement was the sensible and was actually the original plan. I will continue to monitor progress throughout the day.
Pavement-Aggregate Base Passed 01/18/2022
Misc
Informational
12/02/2020
12/1/20 Tuesday 8:30 AM Contractor began laying base asphalt as-per plan. Hanrahan Asphalt Paving Co., INC. did the work and PSI performed the testing of the product. PSI inspector is satisfied with result as of 12:15 PM 12/1/20.
Misc
Informational
12/02/2020
12/2/20 Wednesday 10:49 AM Contractor continued laying Type -2 base asphalt.
Documents & Images
Date Uploaded File Type Document Name
04/27/2020 Receipt Receipt for transaction:2020-001743
04/28/2020 Approved Plans APPROVED CONSTRUCTION DOCUMENTS - MCPL - COLBERN RD - Rev 1 reduced
05/14/2020 Letter DE-Permit
06/12/2020 Letter INSPECTION SUMMARY
06/12/2020 Letter INSPECTION SUMMARY
06/12/2020 Letter INSPECTION SUMMARY
06/15/2020 Letter INSPECTION SUMMARY
06/15/2020 Letter INSPECTION SUMMARY
06/15/2020 Letter INSPECTION SUMMARY
06/17/2020 Letter INSPECTION SUMMARY
06/17/2020 Letter INSPECTION SUMMARY
06/17/2020 Letter INSPECTION SUMMARY
06/17/2020 Letter INSPECTION SUMMARY
06/18/2020 Letter INSPECTION SUMMARY
06/18/2020 Letter INSPECTION SUMMARY
06/18/2020 Letter INSPECTION SUMMARY
06/18/2020 Letter INSPECTION SUMMARY
06/22/2020 Letter INSPECTION SUMMARY
06/22/2020 Letter INSPECTION SUMMARY
06/23/2020 Letter INSPECTION SUMMARY
06/23/2020 Letter INSPECTION SUMMARY
06/24/2020 Letter INSPECTION SUMMARY
06/24/2020 Letter INSPECTION SUMMARY
06/29/2020 Letter INSPECTION SUMMARY
06/29/2020 Letter INSPECTION SUMMARY
06/29/2020 Letter INSPECTION SUMMARY
07/01/2020 Letter INSPECTION SUMMARY
07/01/2020 Letter INSPECTION SUMMARY
07/01/2020 Letter INSPECTION SUMMARY
07/06/2020 Letter INSPECTION SUMMARY
07/07/2020 Letter INSPECTION SUMMARY
07/07/2020 Letter INSPECTION SUMMARY
07/16/2020 Letter INSPECTION SUMMARY
07/16/2020 Letter INSPECTION SUMMARY
07/17/2020 Letter INSPECTION SUMMARY
07/17/2020 Letter INSPECTION SUMMARY
07/17/2020 Letter INSPECTION SUMMARY
07/17/2020 Letter INSPECTION SUMMARY
08/05/2020 Letter INSPECTION SUMMARY
08/05/2020 Letter INSPECTION SUMMARY
08/05/2020 Letter INSPECTION SUMMARY
08/17/2020 Letter INSPECTION SUMMARY
08/26/2020 Letter INSPECTION SUMMARY
10/21/2020 Letter INSPECTION SUMMARY
10/21/2020 Letter INSPECTION SUMMARY
10/21/2020 Letter INSPECTION SUMMARY
10/21/2020 Letter INSPECTION SUMMARY

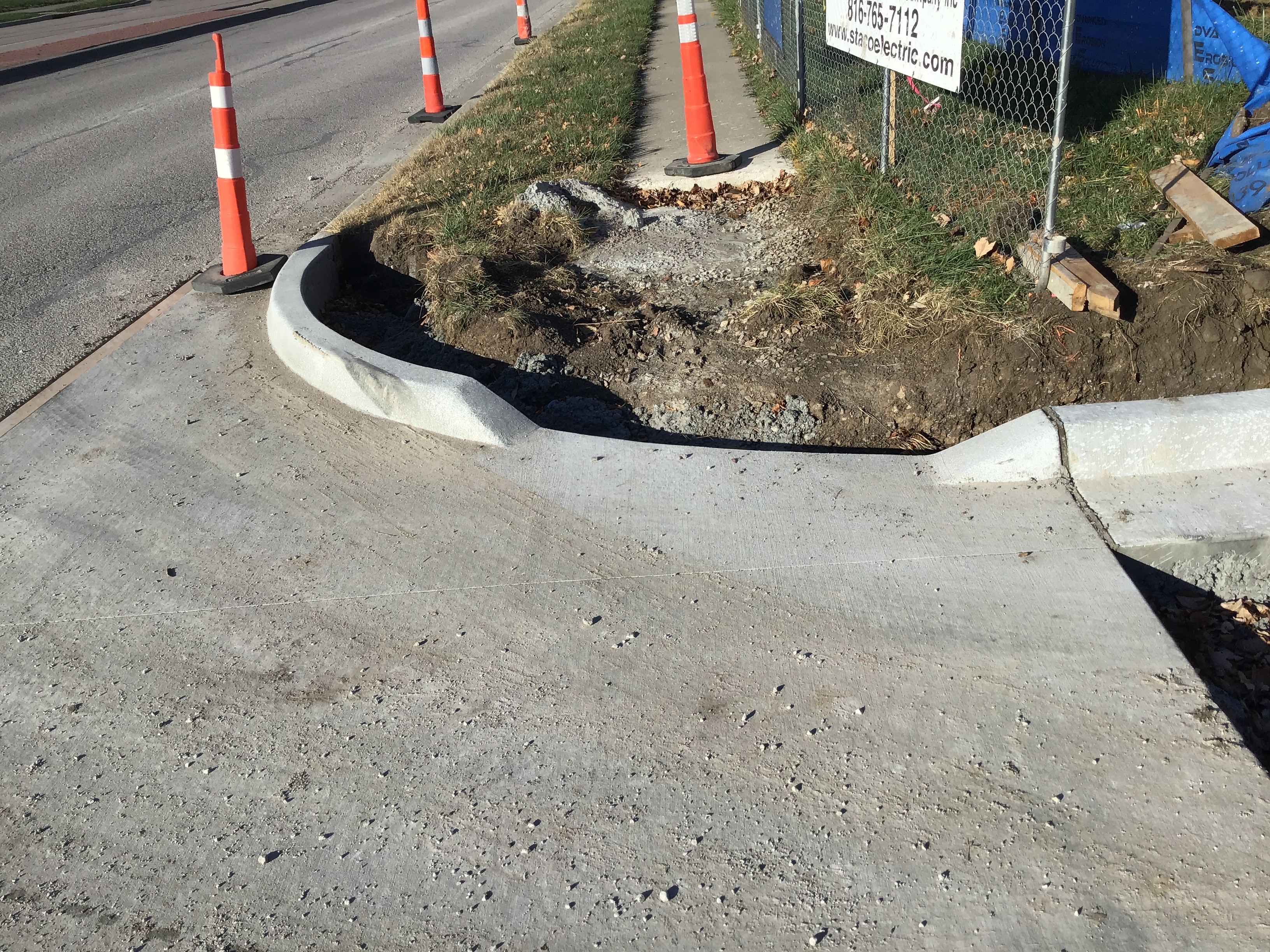

10/23/2020 Letter INSPECTION SUMMARY
10/23/2020 image.jpg
10/23/2020 image.jpg0
10/28/2020 image.jpg1
10/28/2020 image.jpg2
10/28/2020 Letter INSPECTION SUMMARY
10/28/2020 Letter INSPECTION SUMMARY
11/12/2020 image.jpg3
11/12/2020 image.jpg4
11/12/2020 image.jpg5
11/12/2020 image.jpg6
11/12/2020 Letter INSPECTION SUMMARY
11/13/2020 image.jpg7
11/13/2020 image.jpg8
11/13/2020 image.jpg9
11/13/2020 Letter INSPECTION SUMMARY
11/13/2020 Letter INSPECTION SUMMARY
11/13/2020 image.jpg10
11/13/2020 image.jpg11
11/13/2020 Letter INSPECTION SUMMARY
11/20/2020 Letter INSPECTION SUMMARY
12/01/2020 image.jpg12
12/01/2020 Letter INSPECTION SUMMARY
12/01/2020 Letter INSPECTION SUMMARY
12/01/2020 image.jpg13
12/01/2020 Letter INSPECTION SUMMARY
12/01/2020 Letter INSPECTION SUMMARY
12/02/2020 image.jpg14
12/02/2020 Letter INSPECTION SUMMARY
12/02/2020 image.jpg15
12/02/2020 image.jpg16
12/02/2020 image.jpg17
12/02/2020 Letter INSPECTION SUMMARY
04/20/2021 Plans WP10 COLBERN ROAD BRANCH DETENTION AS-BUILTS
04/28/2021 Letter DE-Certificate of Substantial Completion Multiple Lot
04/28/2021 Letter DE-Punch List
04/29/2021 Letter INSPECTION SUMMARY
04/29/2021 Letter INSPECTION SUMMARY
05/06/2021 Plans 21.04.27 WP10 COLBERN ROAD BRANCH DETENTION AS-BUILTS
01/18/2022 Letter DE-Certificate of Final Acceptance (Commercial)
01/31/2022 Letter INSPECTION SUMMARY
01/31/2022 Letter INSPECTION SUMMARY
01/31/2022 Letter INSPECTION SUMMARY
01/31/2022 Letter INSPECTION SUMMARY
01/31/2022 Letter INSPECTION SUMMARY
01/31/2022 Letter INSPECTION SUMMARY
01/31/2022 Letter INSPECTION SUMMARY
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
