Permit Application Status

PRSITE20192599

In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary

PRSITE20192599
Development - Site
Final Acceptance
ER PROPERTIES LLC
DEVELOPMENT COMPLETE
Attic Storage - a climate controlled storage facility located at 920 NE Deerbrook St.
09/12/2019
09/20/2019
04/06/2021
Locations
Contacts
ER PROPERTIES LLC, Address:720 S ROGERS RD
Reviews

There are no reviews for this permit application.

Fees
Paid Fees Amount Paid Owing Date Paid
8350015-Water Meter Fee $469.90 $469.90 Paid 09/12/2019
9110073-Right of Way Permit Fee $80.00 $80.00 Paid 09/12/2019
91100C8-Sanitary Sewer Insp Fees $37.02 $37.02 Paid 09/12/2019
91100C9-Water Insp Fee $444.36 $444.36 Paid 09/12/2019
9110072-Water Test Fee $200.00 $200.00 Paid 09/12/2019
9110068-Storm Fee $133.50 $133.50 Paid 09/12/2019
9110081-Paved Surface Inspection Fee $3,506.04 $3,506.04 Paid 09/12/2019
9110071-Site Grading Fee $375.96 $375.96 Paid 09/12/2019
8331401-Water Tap Fee $5,795.00 $5,795.00 Paid 09/12/2019
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.

$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Water Line - Construction Inspection Partial 1/30/2020 01/30/2020
Informational
01/30/2020
Water Main and Fire line was installed on project. 6" Water Main was relocated to reduce the amount of fitting and allow for assessable exaccess to water line if repairs are required. Installation of line include Fire hydrant that is still located in the same coordinates as per plans. Contractor will reflect field changes in as built. A 12"X6" Tee will need to be install to continue construction on water line for the project. A test shut has been schedule for 1/30/20 to prepare for installation of fitting.
Misc
Informational
02/20/2020
Contractor installed the 2/45 deg bends and 6’ foot length of 6” PVC to complete installation of water main. Line was chlorinated @ 3:00pm.
Water Line - Construction Inspection Passed 02/19/2020
Misc
Informational
02/19/2020
Water main tie in 12”X6” Tee with two 12” sleeves and 6” valve assembly. Night time tie in started at 1:30am Wednesday February, 19. Water main back in service @ 3:30 am, Line was flushed.
Water Line - Construction Inspection Partial 02/20/2020
Misc
Informational
02/20/2020
Contractor installed 2/45 deg bends and 6’ length of 6” PVC pipe to finish installation of water main. The line for the project was Chlorinated @ 3:00 pm 2/20/20 , so it will be de chlorinated no earlier than 3:00pm 2/21/20.
Water Line - Construction Inspection Partial 02/21/2020
Misc
Informational
02/21/2020
Contractor De-chlorinated water main. Hydro test will happen next week.
Water Line - Hydrostatic Test Passed 2/26/2020 02/26/2020
Informational
02/26/2020
Hydrostatic test passed two hour inspection.
Sanitary Sewer - Wye / Insert-A-Tee Installation Passed 4/7/2020 04/07/2020
Misc
Informational
04/07/2020
The contractors installed a wye on the main. I appeared to be at no more than 45 and not less that 30.
Water Line - Construction Inspection Partial 4/9/2020 04/09/2020
Misc
Informational
02/20/2020
Contractor installed 2/45 deg bends and 6’ length of 6” PVC pipe to finish installation of water main. The line for the project was Chlorinated @ 3:00 pm 2/20/20 , so it will be de chlorinated no earlier than 3:00pm 2/21/20.
Misc
Informational
04/09/2020
The tap for the water service line was done by the water dept. this morning. The contractor has connected the copper service line to the main and ran it to the meter pit with copper and also has 10 feet of copper comiing out of the meter pit. They were covering the line with rock and then backfilling.
Water Line - Construction Inspection Partial 04/14/2020
Misc
Informational
04/09/2020
Contractor De-chlorinated water main. Hydro test will happen next week.
Misc
Informational
04/14/2020
Contractor did pass hydrostatic test.
Misc
Informational
04/14/2020
Bacteria slash Coliform was taken 4/14/20 at 8:10 am. Atttic Storage of Lee’s Summit .
Water Line - Construction Inspection Partial 04/15/2020
Misc
Informational
04/14/2020
Contractor De-chlorinated water main. Hydro test will happen next week.
Misc
Informational
04/14/2020
Contractor did pass hydrostatic test.
Misc
Informational
04/14/2020
Bacteria slash Coliform was taken 4/14/20 at 8:10 am. Atttic Storage of Lee’s Summit .
Misc
Informational
04/15/2020
2nd Bacteria slash Coliform sample was taken 4/15/20 at 8:10 Atttic Storage of Lee’s Summit.
Site Visit Partial 04/24/2020
Misc
Informational
04/24/2020
Contractor working but not on things that require inspection. Erosion control passed.
Erosion Control Inspection Passed 05/28/2020
Misc
Informational
05/28/2020
Erosion control is still in place.
Site Visit Partial 11/19/2020
Misc
Informational
04/24/2020
Contractor working but not on things that require inspection. Erosion control passed.
Misc
Informational
11/19/2020
11/19/20 Thursday Talked with a foreman from Strickland Const. and gave him my contact info. They are planning to lay asphalt base sometime next week. He was informed that a proof roll was required.
Pavement-Stabilized Subgrade Passed 12/10/2020
Misc
Informational
12/10/2020
Proof Roll subgrade passed test.
Pavement-Proof Roll Passed 12/10/2020
Misc
Informational
12/10/2020
Proof Roll for pavement passed.
Erosion Control Inspection Partial 12/17/2020
Misc
Informational
12/17/2020
12/17/20 Thursday 10:30AM Rip-rap was installed approximately 4 months ago on the Northside of Building and it meets specifications. Curby’s Lawn and Garden has planted trees, bush and blew straw for soil stabilization. Inspector will check site throughout the Winter season to ensure soil stabilization remains effective.
ESC - (Vegetation/Ground Cover) Partial 12/17/2020
Misc
Informational
12/17/2020
12/17/20 Thursday 11:06AM Contractor installed trees and bushes on the Eastside of Building. Soil was covered with straw.
Pavement-Surface Partial 12/17/2020
Misc
Informational
12/17/2020
12/15/20 Thursday 11:15AM Contractor was forming prepare driveway and parking stall areas for concrete pour.
Pavement-Surface Partial 12/18/2020
Misc
Informational
12/17/2020
12/15/20 Thursday 11:15AM Contractor was forming prepare driveway and parking stall areas for concrete pour.
Misc
Informational
12/18/2020

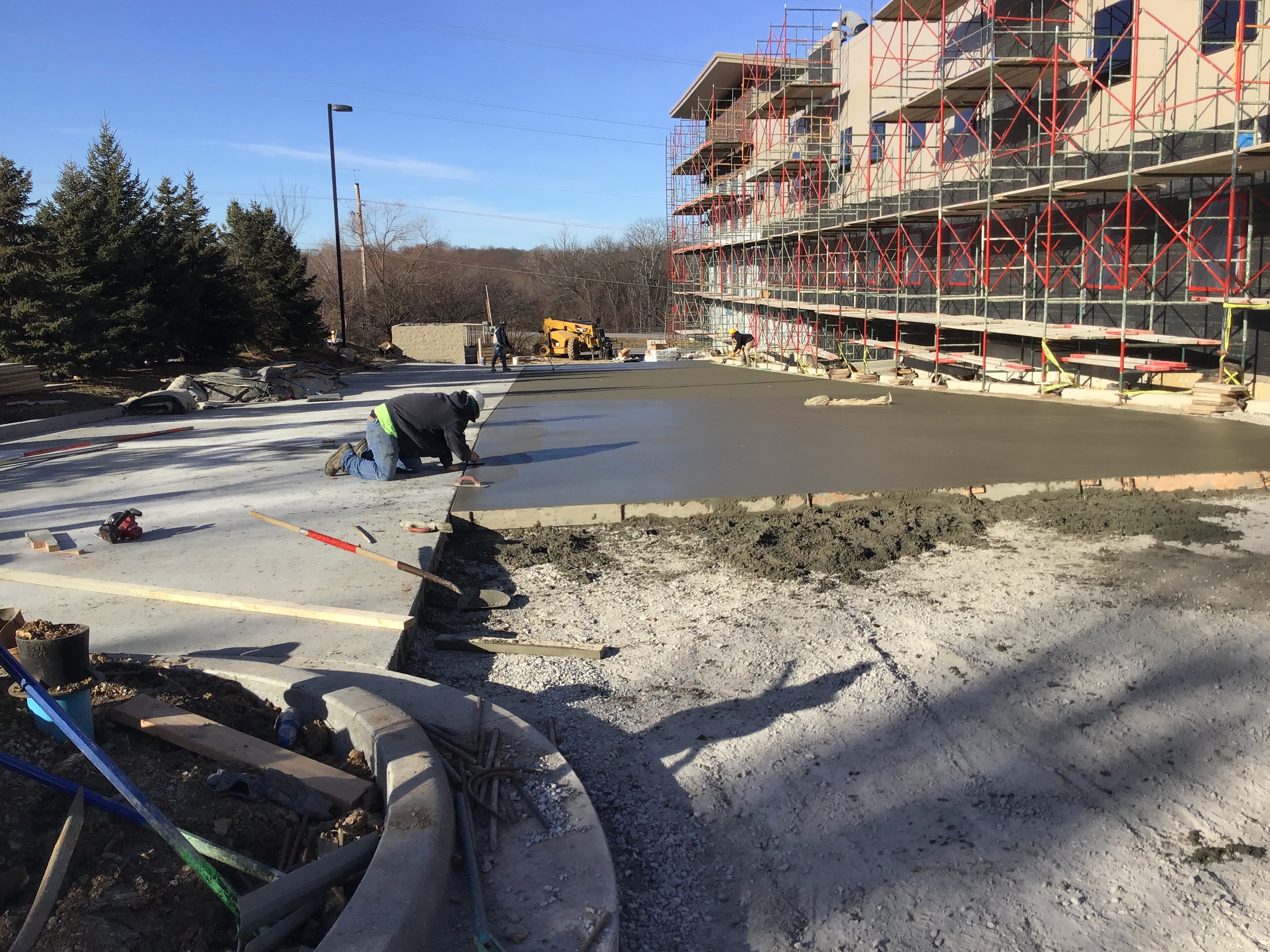

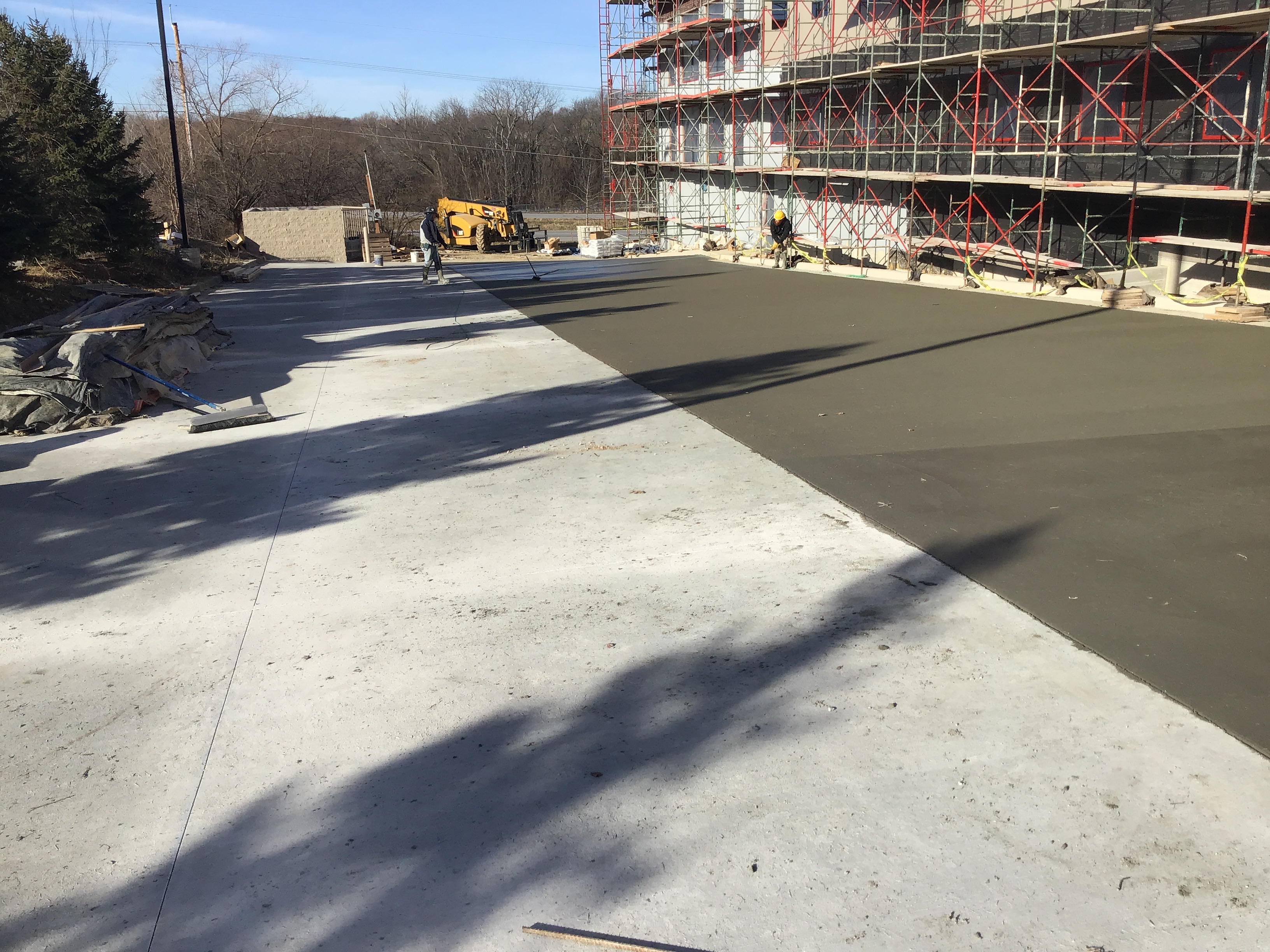

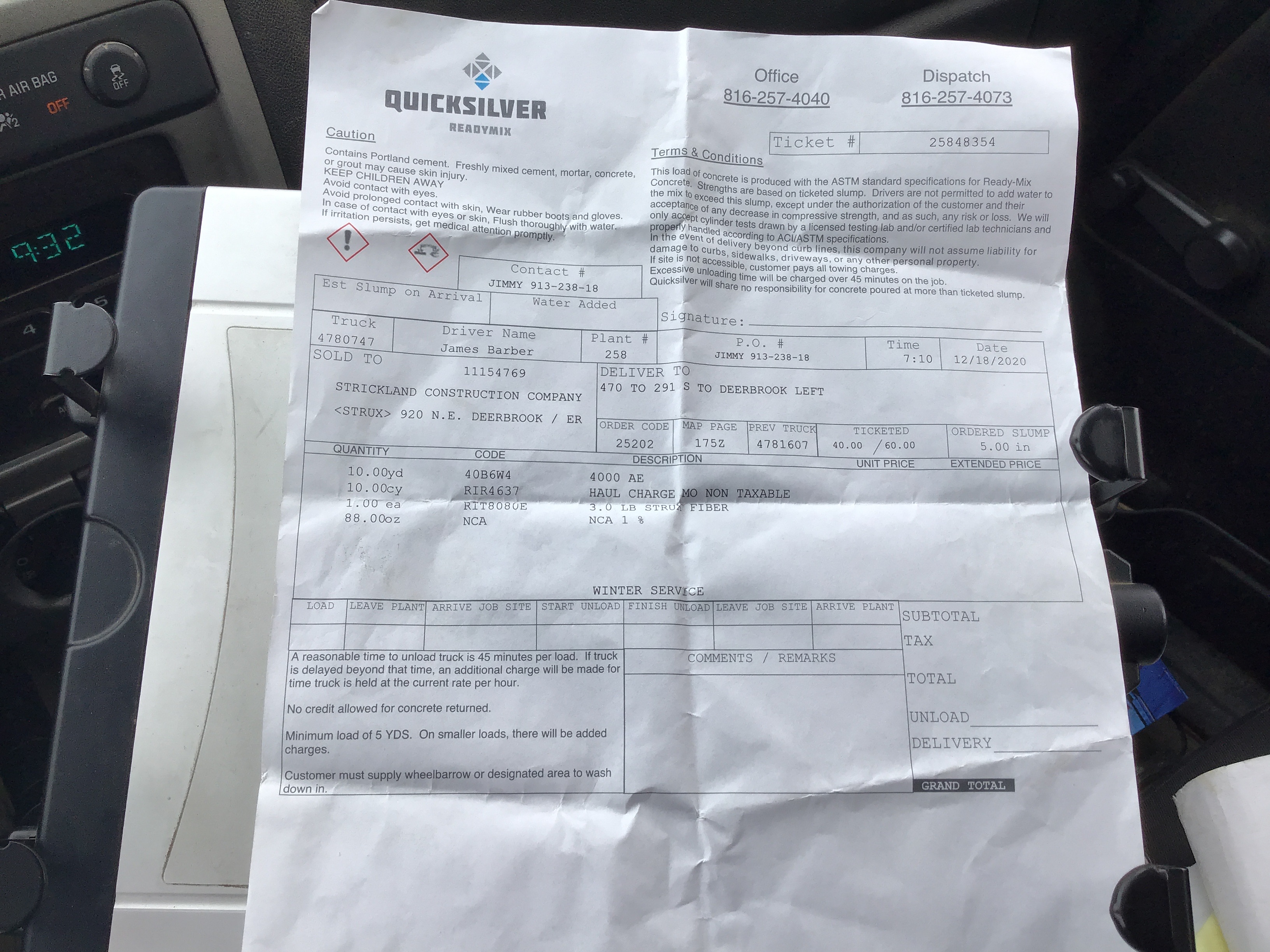

12/18/20 Friday 9:15AM Contractor began pour concrete parking lot @ 7:00AM. Due to cold weather and contractor will use blankets. Contractor has come to an agreement that he will send pictures to Inspector John M. Jackson and supervisor Steve Robinson of Blankets covering concrete.
Pavement-Surface Partial 12/18/2020
Misc
Informational
12/18/2020
12/15/20 Thursday 11:15AM Contractor was forming prepare driveway and parking stall areas for concrete pour.
Misc
Informational
12/18/2020
12/1/20 Friday 9:15AM Contractor began pour concrete parking lot @ 7:00AM. Due to cold weather and contractor will use blankets. Contractor has come to an agreement that he will send pictures to Inspector John M. Jackson and supervisor Steve Robinson of Blankets covering concrete.
Misc
Informational
12/18/2020
THE ABOVE DATE IS 12/18/20 NOT 12/1/20 12/18/20 Friday 3:50PM Contractor sent pictures of the blankets covering concrete that was poured earlier this morning.
Pavement-Surface Partial 12/21/2020
Misc
Informational
12/18/2020
12/15/20 Thursday 11:15AM Contractor was forming prepare driveway and parking stall areas for concrete pour.
Misc
Informational
12/18/2020
12/1/20 Friday 9:15AM Contractor began pour concrete parking lot @ 7:00AM. Due to cold weather and contractor will use blankets. Contractor has come to an agreement that he will send pictures to Inspector John M. Jackson and supervisor Steve Robinson of Blankets covering concrete.
Misc
Informational
12/18/2020
THE ABOVE DATE IS 12/18/20 NOT 12/1/20 12/18/20 Friday 3:50PM Contractor sent pictures of the blankets covering concrete that was poured earlier this morning.
Misc
Informational
12/21/2020
12/22/20 Monday 10:00AM Contractor (Strickland Const.) Poured the drive on the SW side to the SE corner of Storage Building.
Misc
Informational
12/21/2020
12/21/20 Monday is the correct date for the above inspection also see Pictures form this date of poured drive area.
Pavement-Surface Partial 12/22/2020
Misc
Informational
12/21/2020
12/15/20 Thursday 11:15AM Contractor was forming prepare driveway and parking stall areas for concrete pour.
Misc
Informational
12/21/2020
12/1/20 Friday 9:15AM Contractor began pour concrete parking lot @ 7:00AM. Due to cold weather and contractor will use blankets. Contractor has come to an agreement that he will send pictures to Inspector John M. Jackson and supervisor Steve Robinson of Blankets covering concrete.
Misc
Informational
12/21/2020
THE ABOVE DATE IS 12/18/20 NOT 12/1/20 12/18/20 Friday 3:50PM Contractor sent pictures of the blankets covering concrete that was poured earlier this morning.
Misc
Informational
12/21/2020
12/22/20 Monday 10:00AM Contractor (Strickland Const.) Poured the drive on the SW side to the SE corner of Storage Building.
Misc
Partial Correction
12/22/2020
12/22/220 Tuesday 7:25AM Temperatures were below freezing and blankets were not covering concrete That was poured. (Yesterday report correct date was 12/21/20 Monday)
Water Line - Construction Inspection Passed 04/05/2021
Misc
Informational
04/15/2020
Contractor De-chlorinated water main. Hydro test will happen next week.
Misc
Informational
04/15/2020
Contractor did pass hydrostatic test.
Misc
Informational
04/15/2020
Bacteria slash Coliform was taken 4/14/20 at 8:10 am. Atttic Storage of Lee’s Summit .
Misc
Informational
04/15/2020
2nd Bacteria slash Coliform sample was taken 4/15/20 at 8:10 Atttic Storage of Lee’s Summit.
ESC - (Vegetation/Ground Cover) Passed 04/05/2021
Misc
Informational
12/17/2020
12/17/20 Thursday 11:06AM Contractor installed trees and bushes on the Eastside of Building. Soil was covered with straw.
Pavement-Stabilized Subgrade Passed 04/05/2021
Misc
Informational
12/10/2020
Proof Roll subgrade passed test.
Erosion Control Inspection Passed 04/05/2021
Documents & Images
Date Uploaded File Type Document Name
09/12/2019 Receipt Receipt for transaction: 2019-006194
09/20/2019 Letter DE-Permit
09/20/2019 SIGN PERMIT
01/30/2020 Letter INSPECTION SUMMARY

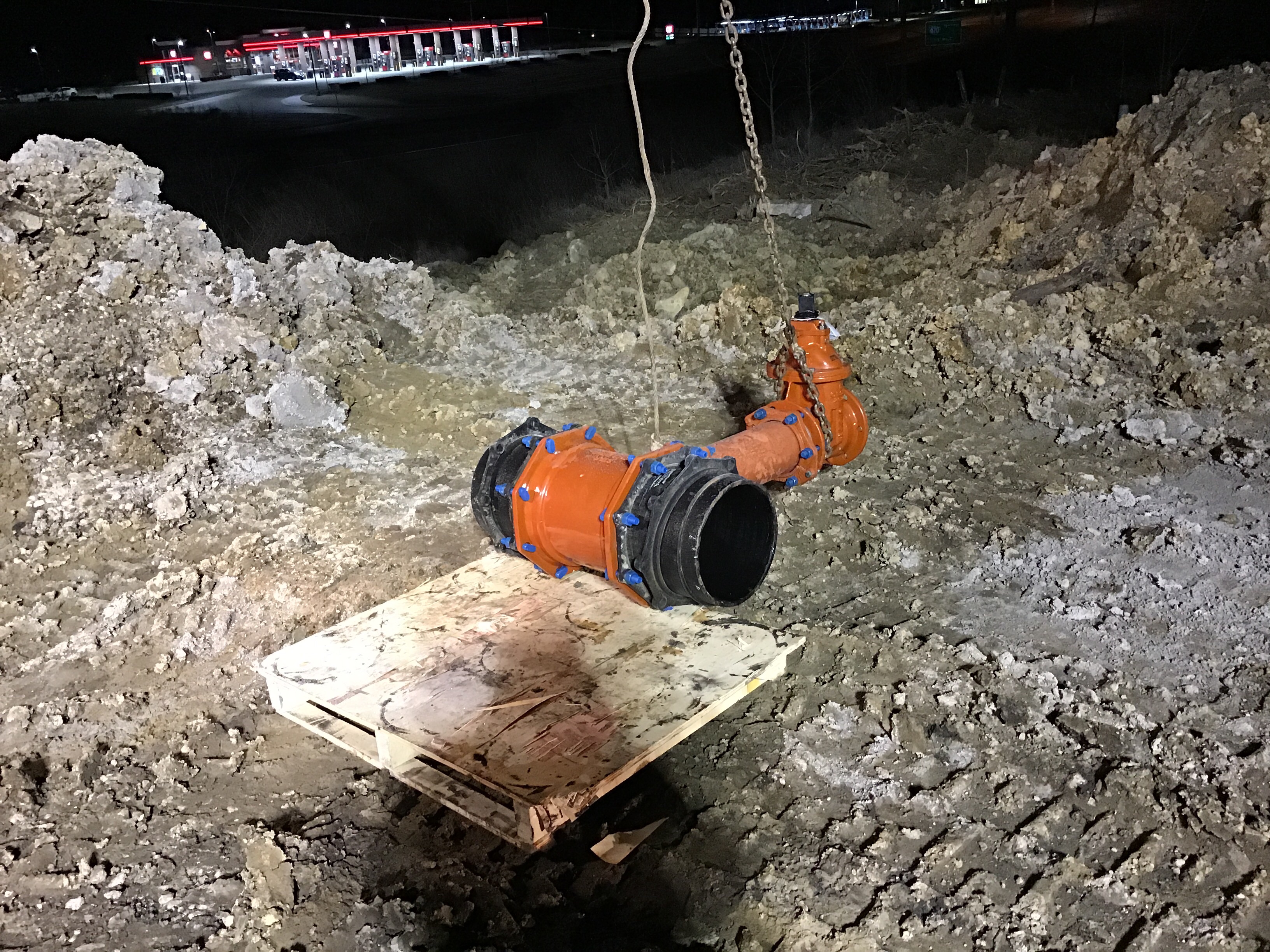

02/19/2020 12”x6” tee
02/19/2020 12” sleeves

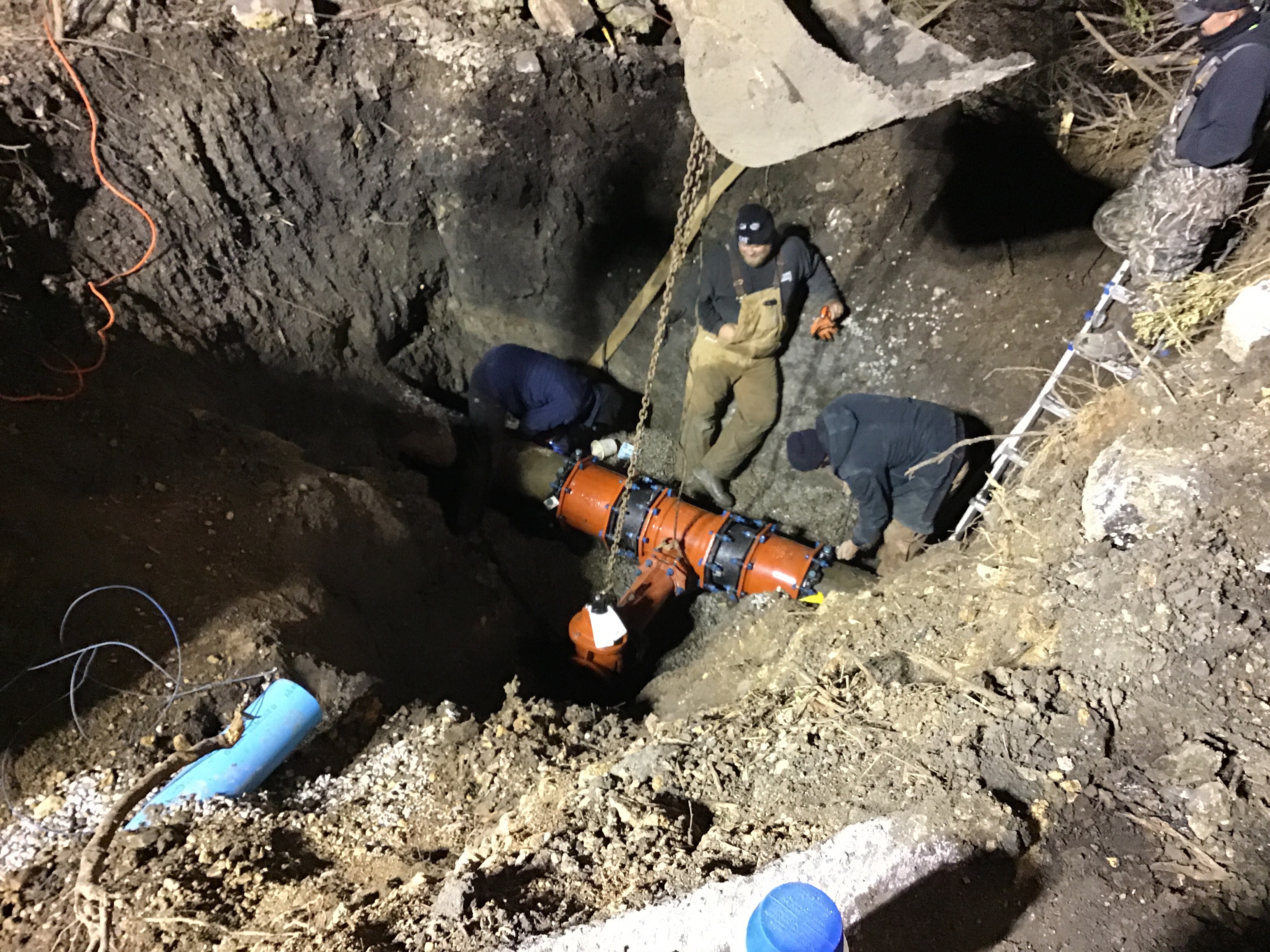

02/19/2020 Tie in complete
02/20/2020 Letter INSPECTION SUMMARY
02/20/2020 Letter INSPECTION SUMMARY
02/20/2020 Letter INSPECTION SUMMARY
02/20/2020 Letter INSPECTION SUMMARY
02/20/2020 Letter INSPECTION SUMMARY
02/20/2020 Letter INSPECTION SUMMARY
02/21/2020 Letter INSPECTION SUMMARY
02/21/2020 Letter INSPECTION SUMMARY
02/26/2020 Letter INSPECTION SUMMARY
04/07/2020 Letter DE-Daily Inspection Summary
04/07/2020 Letter DE-Daily Inspection Summary
04/09/2020 Letter DE-Daily Inspection Summary
04/14/2020 Letter INSPECTION SUMMARY
04/14/2020 Letter INSPECTION SUMMARY
04/14/2020 Letter INSPECTION SUMMARY
04/14/2020 Letter INSPECTION SUMMARY
04/14/2020 Letter INSPECTION SUMMARY

04/14/2020 Toe Walls for the intake side of Storm line #300
04/15/2020 Letter INSPECTION SUMMARY
04/24/2020 Letter INSPECTION SUMMARY
05/28/2020 Letter INSPECTION SUMMARY
11/19/2020 Letter INSPECTION SUMMARY
11/19/2020 Letter INSPECTION SUMMARY
11/19/2020 Letter INSPECTION SUMMARY
12/10/2020 Letter INSPECTION SUMMARY
12/10/2020 Letter INSPECTION SUMMARY
12/10/2020 Letter INSPECTION SUMMARY
12/10/2020 image.jpg
12/10/2020 Letter INSPECTION SUMMARY
12/17/2020 Letter INSPECTION SUMMARY
12/17/2020 Letter INSPECTION SUMMARY
12/17/2020 Letter INSPECTION SUMMARY
12/18/2020 Letter INSPECTION SUMMARY
12/18/2020 image.jpg0
12/18/2020 Letter INSPECTION SUMMARY
12/18/2020 Letter INSPECTION SUMMARY
12/21/2020 image.jpg1
12/21/2020 image.jpg2
12/21/2020 Letter INSPECTION SUMMARY
12/21/2020 Letter INSPECTION SUMMARY
12/22/2020 Letter INSPECTION SUMMARY
02/09/2021 Letter DE-Certificate of Substantial Completion Multiple Lot
02/09/2021 Letter DE-Punch List
04/06/2021 Letter DE-Certificate of Final Acceptance (Commercial)
04/06/2021 Attic Storage Final Acceptance
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
