Summary


PRSITE20180561
Development - Site
Final Acceptance
CELTIC INVESTMENT GROUP LLC
DEVELOPMENT COMPLETE
Full site development
03/09/2018
05/22/2018
01/06/2020
Locations
Contacts
CELTIC INVESTMENT GROUP LLC, Address:1120 SE BROADWAY
TPC INTERIORS INC, Address:1120 SE BROADWAY DR, Phone:(816) 406-3620
HG CONSULT, INC, Address:9007 PINE ST, Phone:(816) 759-2285
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 03/09/2018 03/16/2018
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
91100C8-Sanitary Sewer Insp Fees $60.75 $60.75 Paid 03/15/2018
91100C9-Water Insp Fee $102.00 $102.00 Paid 03/15/2018
9110072-Water Test Fee $200.00 $200.00 Paid 03/15/2018
9110068-Storm Fee $194.73 $194.73 Paid 03/15/2018
9110081-Paved Surface Inspection Fee $2,908.47 $2,908.47 Paid 03/15/2018
9110071-Site Grading Fee $198.10 $198.10 Paid 03/15/2018
91100C9-Water Insp Fee $600.00 $600.00 Paid 04/19/2019
$702.00
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Site Visit Partial 5/22/2018 at 9:15 AM 05/22/2018
PW-Misc
Informational
05/22/2018
John DiMauro 05/22/2018 10:27 AM I met with the contractor on site to deliver the plans, get the permit signed and go over the plans.
Erosion Control Inspection Partial 5/22/2018 at 10:25 AM 05/22/2018
PW-Misc
Informational
05/22/2018
John DiMauro 05/22/2018 10:30 AM The silt fence is installed according to the plans. The crew is installing the construction entrance at this time. I will return to further inspect the ESC devices.
Erosion Control Inspection Partial 5/23/2018 at 8:35 AM 05/24/2018
PW-Misc
Informational
05/22/2018
John DiMauro 05/22/2018 10:30 AM The silt fence is installed according to the plans. The crew is installing the construction entrance at this time. I will return to further inspect the ESC devices.
PW-Misc
Informational
05/24/2018
John DiMauro 05/24/2018 3:50 PM The construction entrance is installed according to the plans.
Water Line - Construction Inspection Partial 7/13/2018 at 2:30 PM 07/13/2018
PW-Main inspection
Informational
07/13/2018
John DiMauro 07/13/2018 2:43 PM The plumbing crew installed the riser for the fire line and stubbed it out of the building. I verified material and the kicker poured behind the riser.
Fire Line Construction Inspection Partial 9/27/2018 09/28/2018
Informational
09/28/2018
The crew tied on the building stub for the fire line and ran it out to where the future backflow assembly will be. They just capped the end of the pipe and they will install the backflow at a later date.
Sewer Service Inspection Partial 10/2/2018 at 8:15 AM 10/02/2018
Informational
10/02/2018
John DiMauro 10/02/2018 8:35 AM The contractor has the 4" sewer service line tied onto the existing service lateral stub near the main. The line is ran up to the building. There appears to be sufficient rock under the pipe. I will return for further inspection once the contractor ties onto the building stub and is ready to backfill.
Sewer Service Inspection Partial 10/2/2018 at 2:05 PM 10/02/2018
Informational
10/02/2018
John DiMauro 10/02/2018 2:21 PM The contractor has the 4" sanitary sewer service line installed from the main to the stub at the building. There appears to be sufficient rock bedding and the install appears to match the plans.
Storm Sewer Construction Inspection Partial 10/30/2018 10/30/2018
Misc
Informational
10/30/2018
The contractor installed approximately 45’ of the HDPE storm pipe from the area inlet to the storm box at the road. There appears to be sufficient aggregate supporting the pipe. I will return for further inspection of the collars once they have been installed.
Storm Sewer Construction Inspection Partial 10/31/2018 12/17/2018 11/16/2018
Misc
Informational
10/30/2018
The contractor installed approximately 45’ of the HDPE storm pipe from the area inlet to the storm box at the road. There appears to be sufficient aggregate supporting the pipe. I will return for further inspection of the collars once they have been installed.
Misc
Informational
11/16/2018
The contractor poured the inverts and collars for the storm inlet. The install appears to match the approved plans.
Storm Sewer Construction Inspection Partial 11/21/2018
Misc
Informational
11/16/2018
The contractor installed approximately 45’ of the HDPE storm pipe from the area inlet to the storm box at the road. There appears to be sufficient aggregate supporting the pipe. I will return for further inspection of the collars once they have been installed.
Misc
Informational
11/16/2018
The contractor poured the inverts and collars for the storm inlet. The install appears to match the approved plans.
Misc
Informational
11/21/2018
The contractor installed the flared end section and toe wall for the outlet structure.

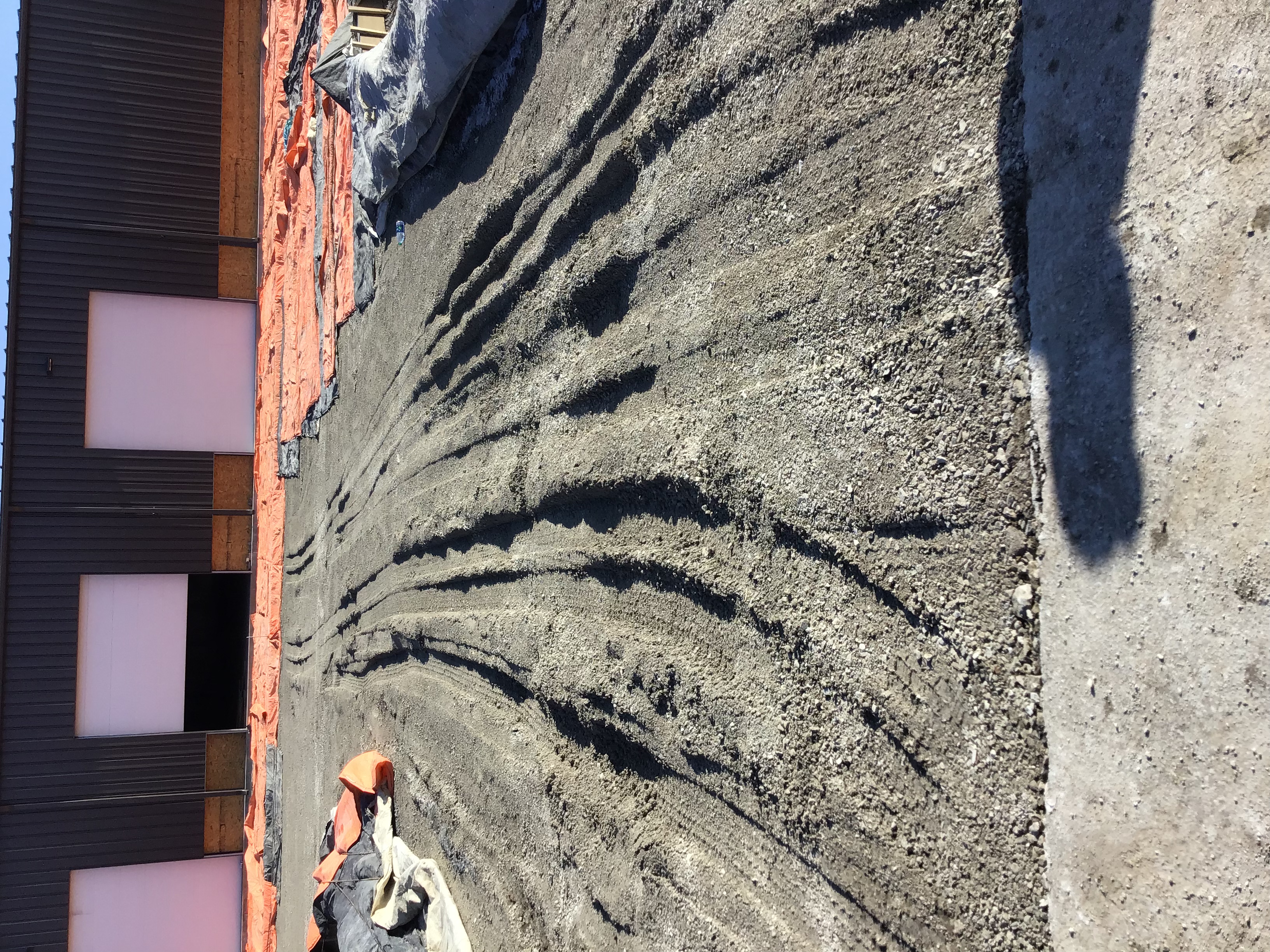

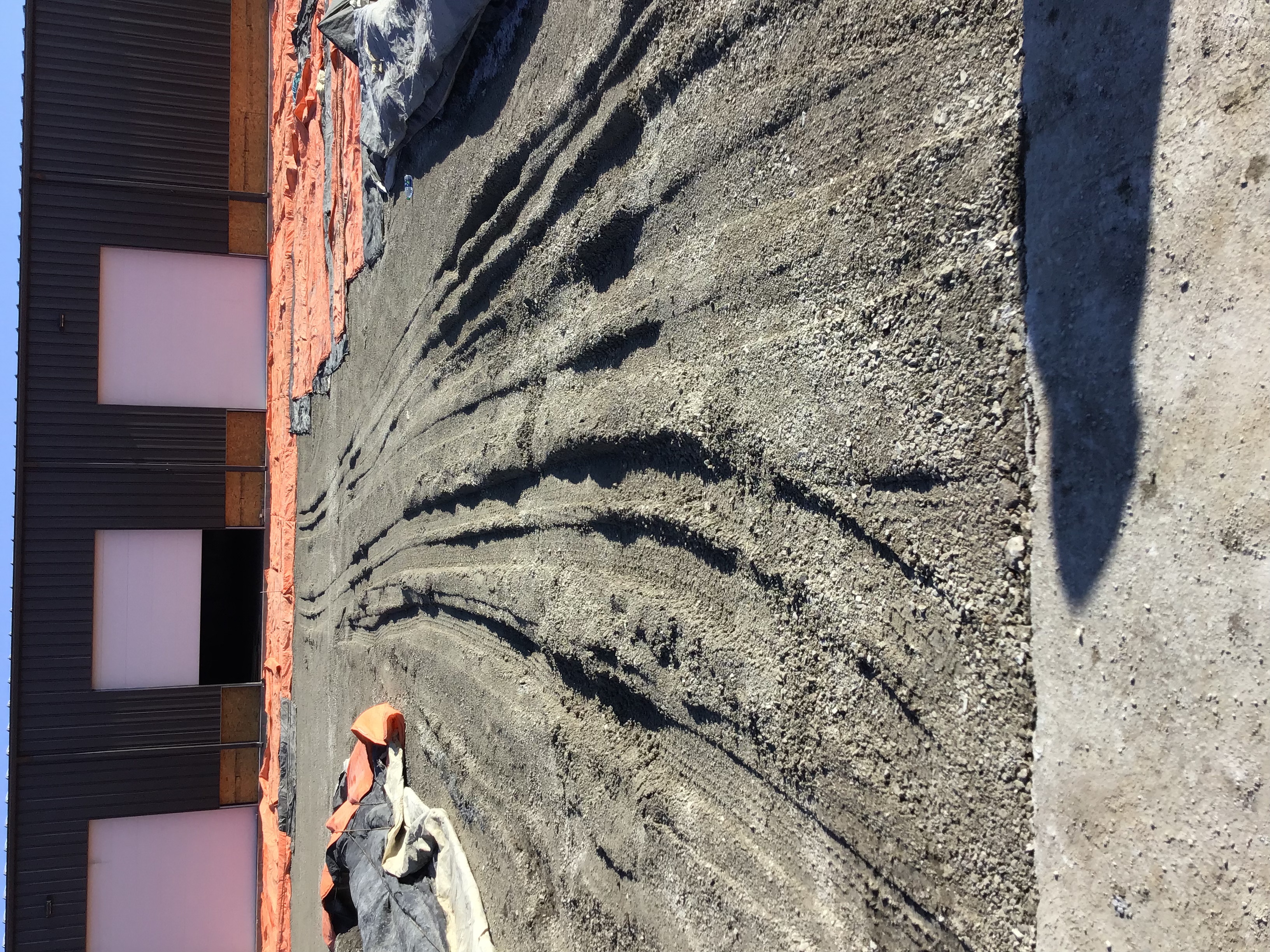

Proof roll parking lot Failed 12/10/2018 12/10/2018
Misc
Corrective Action Required
12/10/2018
The proof roll for the parking lot failed. There was significant rutting under the truck. I do not recommend pouring concrete on this parking lot subgrade at this time.
Driveway Inspection Partial 04/22/2019
Misc
Informational
04/22/2019
Both commercial driveways are formed up and have 8 inches of compacted gravel.
Sidewalk Inspection Partial 04/25/2019
Misc
Informational
04/25/2019
The crew has the sidewalk and ADA ramp sections formed up. There appears to be sufficient compacted aggregate. Will return for further inspection.
Sidewalk Inspection Partial 04/25/2019
Misc
Informational
04/25/2019
PRE POUR INSPECTION ADA Ramp inspection. Will return for a post pour inspection.
Water - Material Verification Passed 5/29/2019 05/29/2019
Misc
Informational
05/29/2019
Correct materials were verified on site and meet our Lee Summit Approved Materials list.
Fire Line Construction Inspection Partial 5/29/2019 05/29/2019
Misc
Informational
05/29/2019
Advanced Fire and Protection crew cut into water main and installed a T for a fire line and back flow preventer according to Spec. Crew still needs to attach fire line to building and has thrust block remaining
Fire Line Construction Inspection Passed 5/31/2019 05/31/2019
Misc
Informational
05/29/2019
Advanced Fire and Protection crew cut into water main and installed a T for a fire line and back flow preventer according to Spec. Crew still needs to attach fire line to building and has thrust block remaining
Misc
Informational
05/31/2019
Advanced Fire Protection finished the install of the fire line from the back flow preventer to the existing fire line connected to the building. I verified the correct materials and that the install met the City of Lee’s Summit specs. Photos are attached.
Fire Line - Hydrostatic Test Passed 06/03/2019
Misc
Informational
06/03/2019
Advantage Fire performed the Hydro test on the fire line. I observed the gauge hold 205 psi for two hours. Test Passed.
Fire Line - Flush Passed 06/03/2019
Misc
Informational
06/03/2019
I observed Advantage Fire perform the high velocity flush of the fire line.
Site Visit Complete 06/20/2019
PW-Misc
Informational
05/22/2018
John DiMauro 05/22/2018 10:27 AM I met with the contractor on site to deliver the plans, get the permit signed and go over the plans.
Water Line - Construction Inspection Passed 06/20/2019
PW-Main inspection
Informational
07/13/2018
John DiMauro 07/13/2018 2:43 PM The plumbing crew installed the riser for the fire line and stubbed it out of the building. I verified material and the kicker poured behind the riser.
Storm Sewer Construction Inspection Passed 06/20/2019
Misc
Informational
11/21/2018
The contractor installed approximately 45’ of the HDPE storm pipe from the area inlet to the storm box at the road. There appears to be sufficient aggregate supporting the pipe. I will return for further inspection of the collars once they have been installed.
Misc
Informational
11/21/2018
The contractor poured the inverts and collars for the storm inlet. The install appears to match the approved plans.
Misc
Informational
11/21/2018
The contractor installed the flared end section and toe wall for the outlet structure.
Proof roll parking lot Passed 06/20/2019
Misc
Corrective Action Required
12/10/2018
The proof roll for the parking lot failed. There was significant rutting under the truck. I do not recommend pouring concrete on this parking lot subgrade at this time.
Sewer Service Inspection Passed 06/20/2019
Driveway Inspection Passed 06/20/2019
Misc
Informational
04/22/2019
Both commercial driveways are formed up and have 8 inches of compacted gravel.
Sidewalk Inspection Passed 06/20/2019
Misc
Informational
04/25/2019
PRE POUR INSPECTION ADA Ramp inspection. Will return for a post pour inspection.
Water - Material Verification Passed 06/20/2019
Documents & Images
Date Uploaded File Type Document Name
03/15/2018 Receipt Receipt for transaction: 2018-000974
05/22/2018 Letter DE-Permit
05/22/2018 Letter DE-Daily Inspection Summary
05/24/2018 Letter DE-Daily Inspection Summary
07/13/2018 Letter DE-Daily Inspection Summary
09/28/2018 Letter DE-Daily Inspection Summary
10/02/2018 Letter DE-Daily Inspection Summary
10/02/2018 Letter DE-Daily Inspection Summary

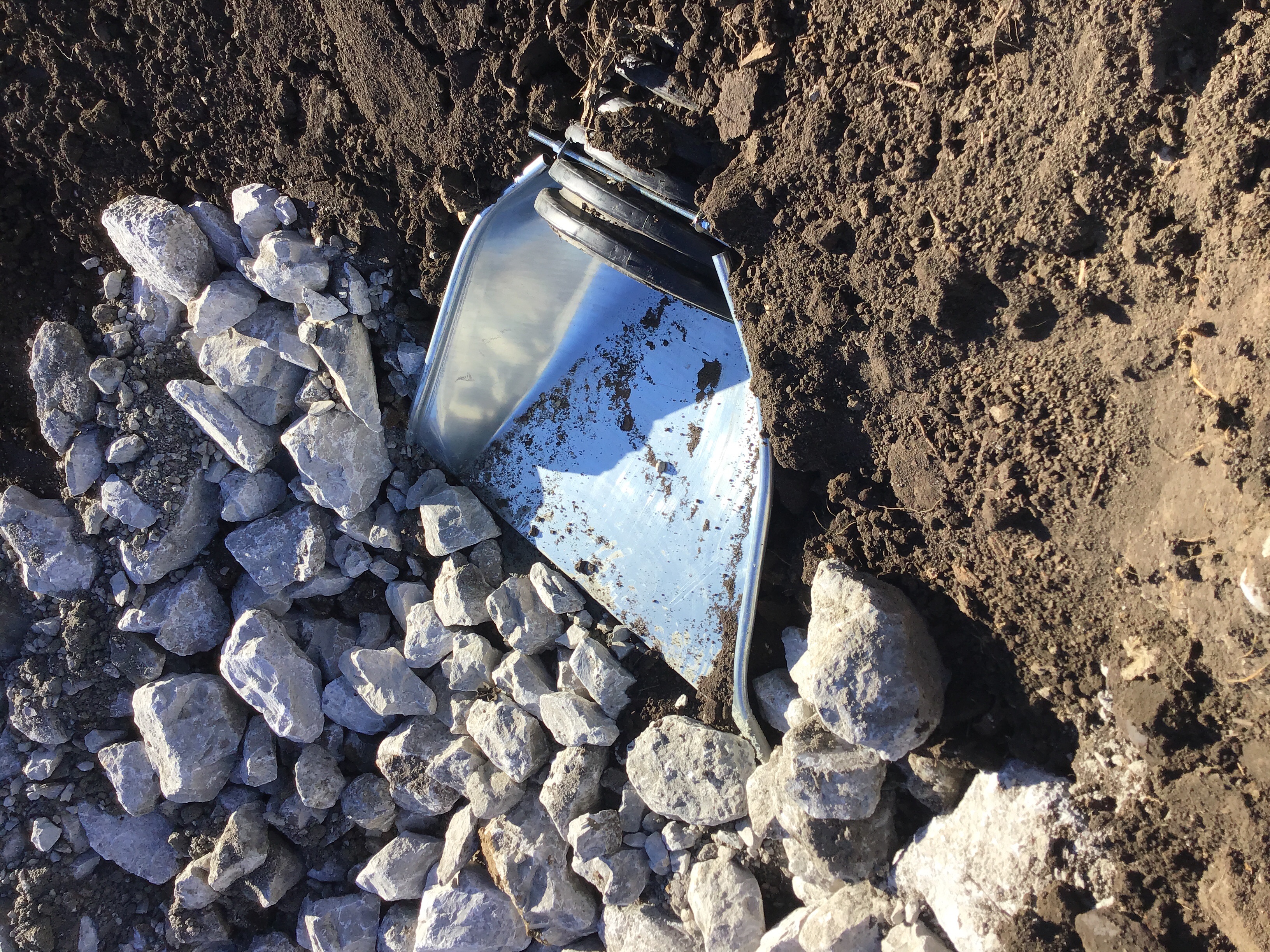

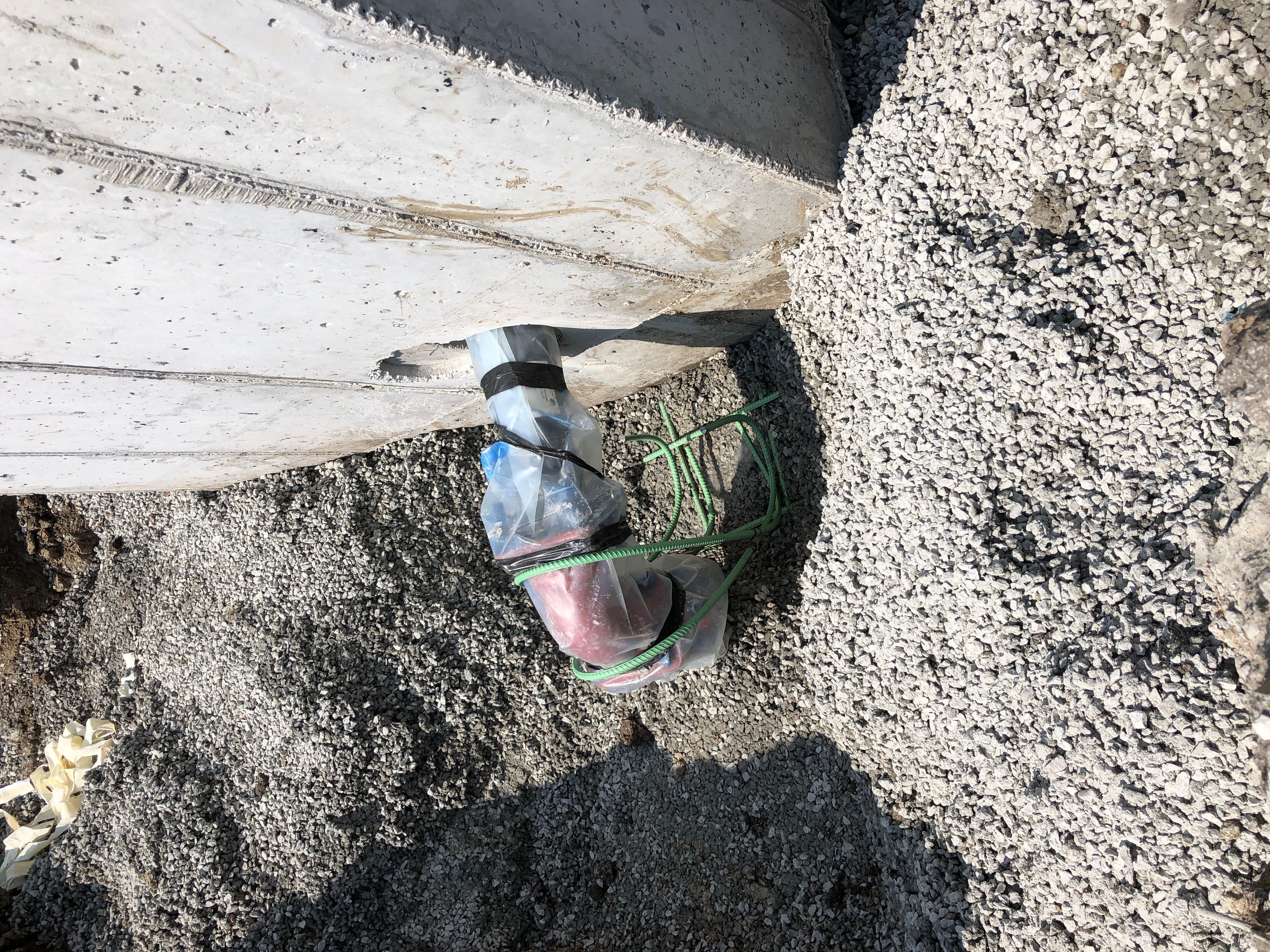

10/30/2018 image

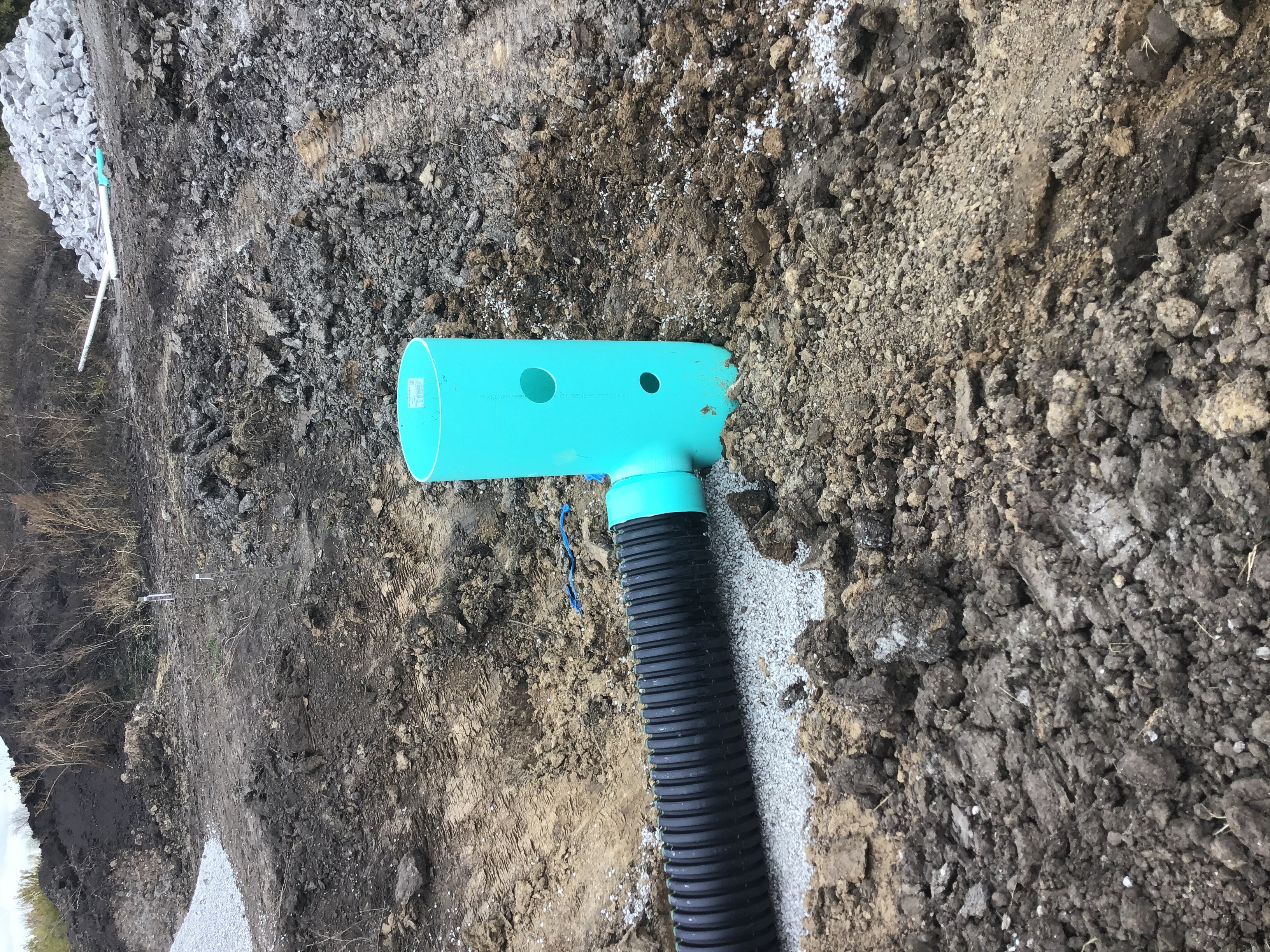

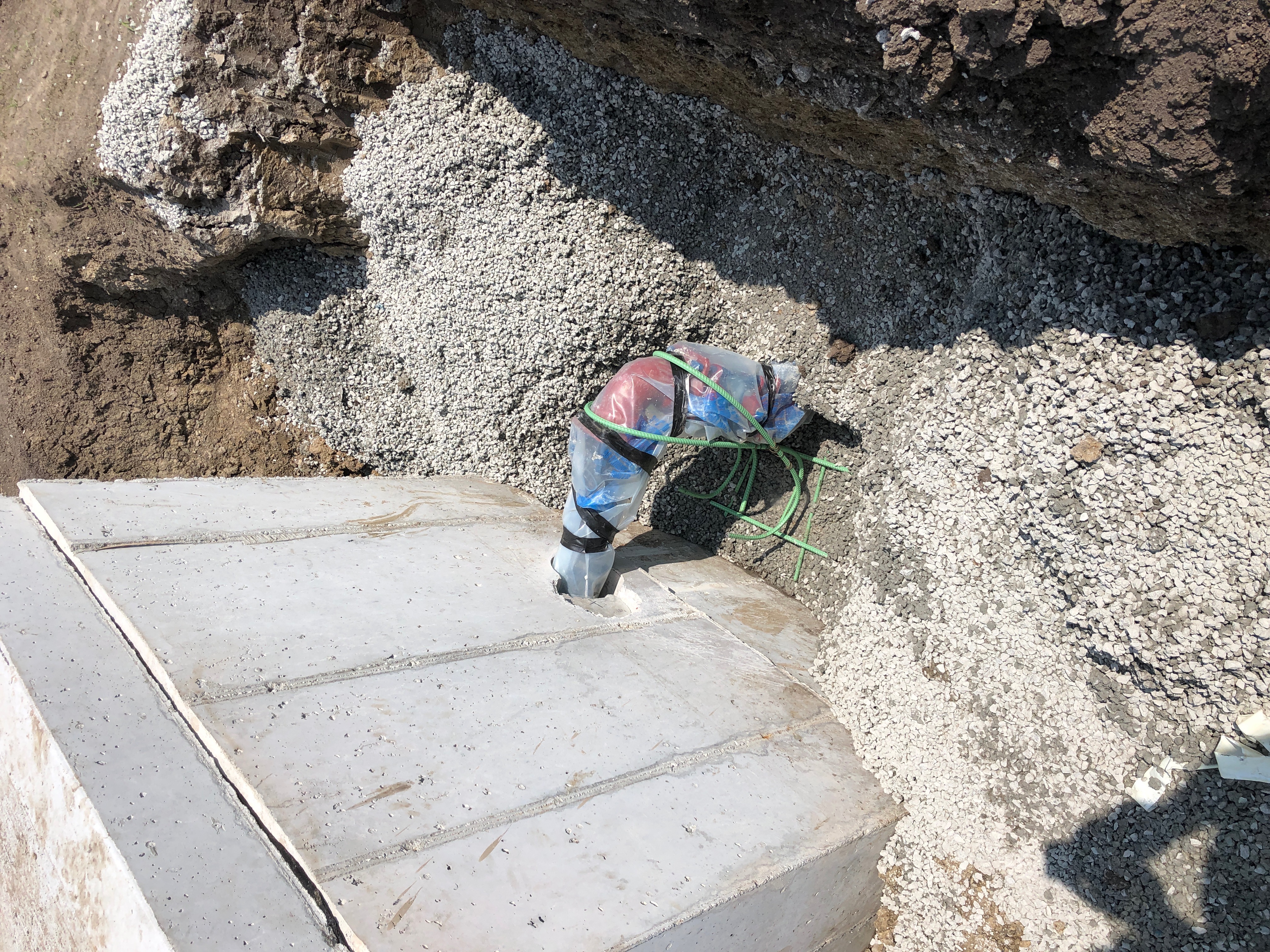

10/30/2018 image0

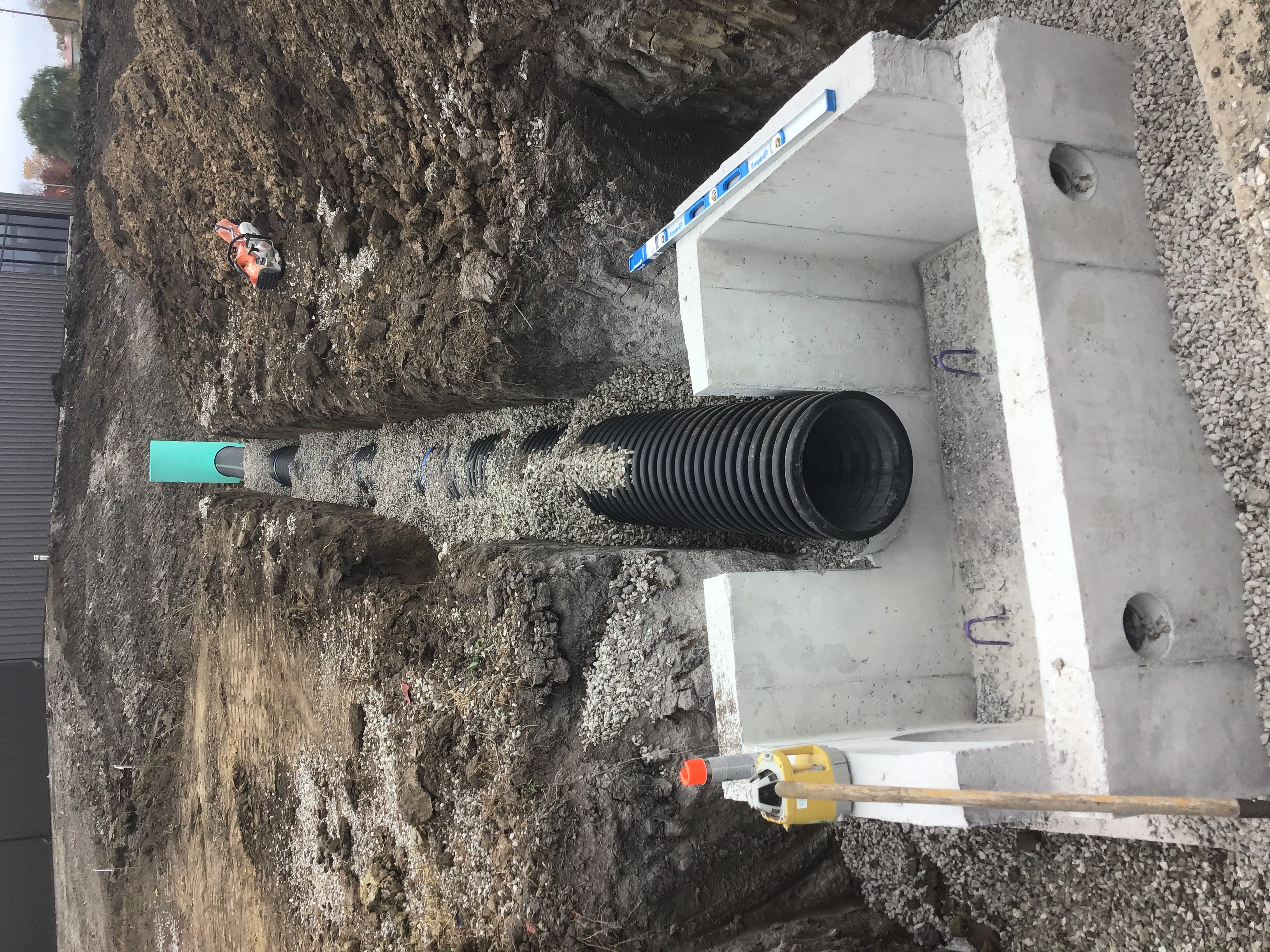

10/30/2018 image1
10/30/2018 Letter Inspection Summary

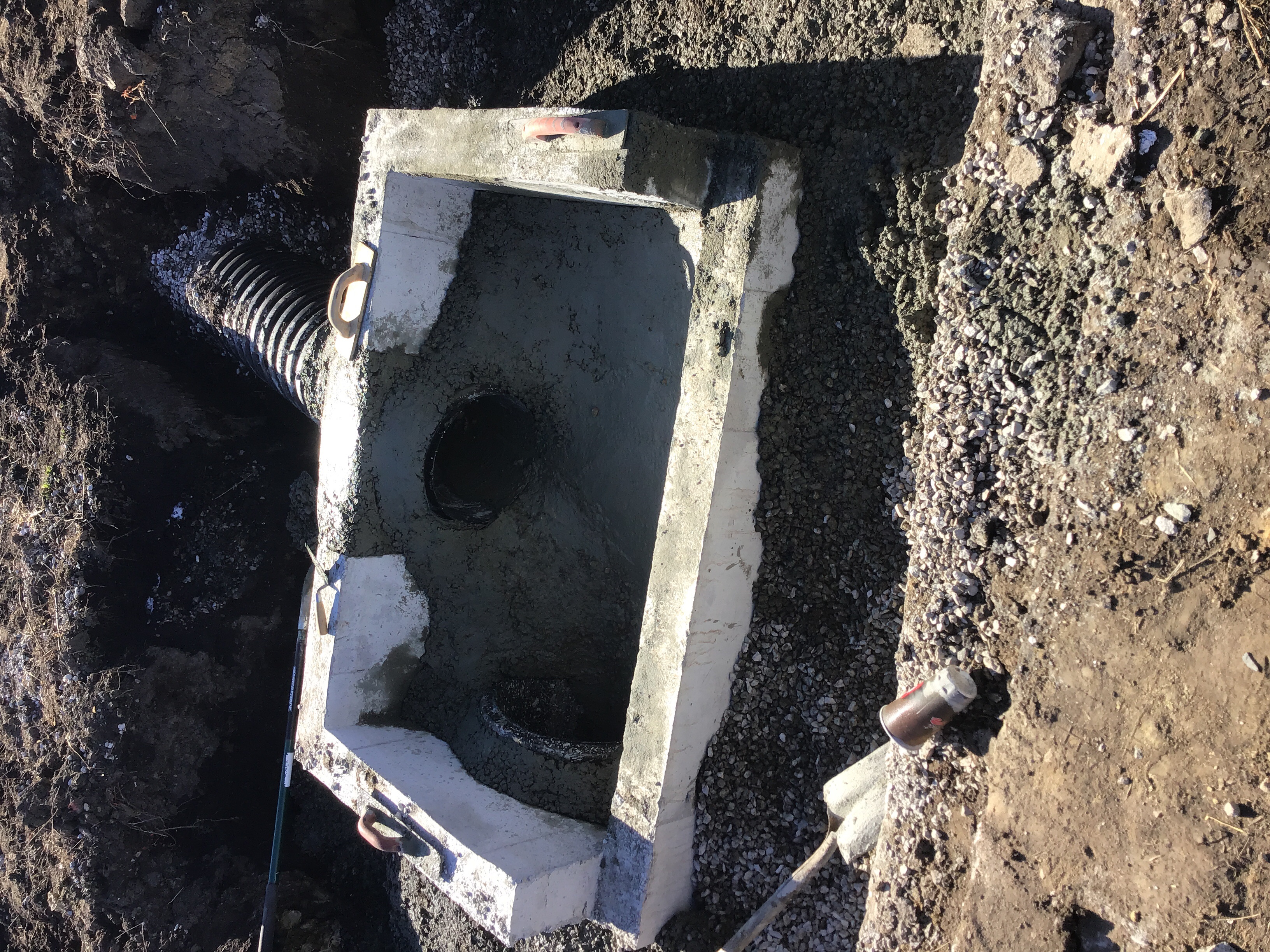

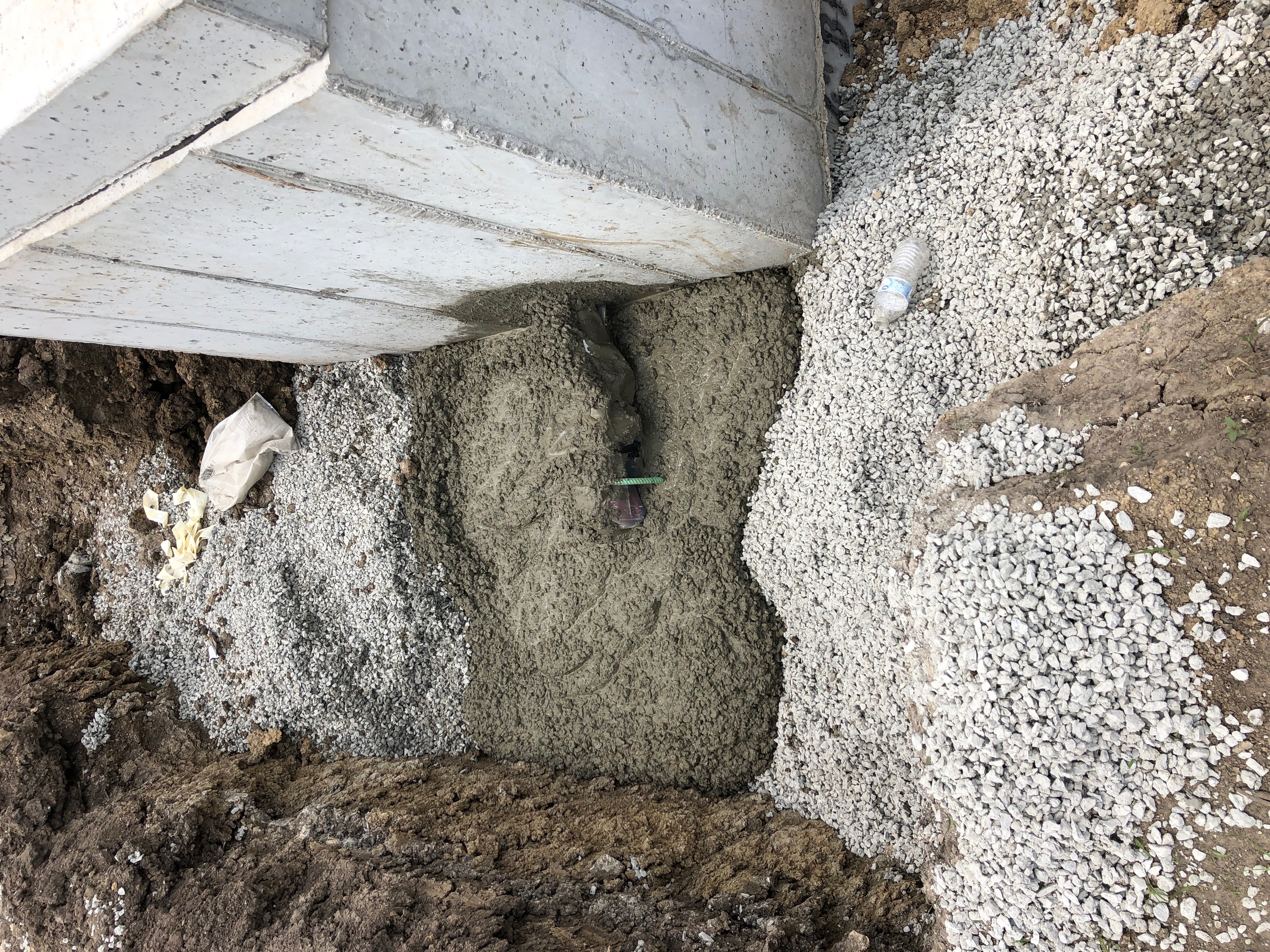

11/16/2018 image2

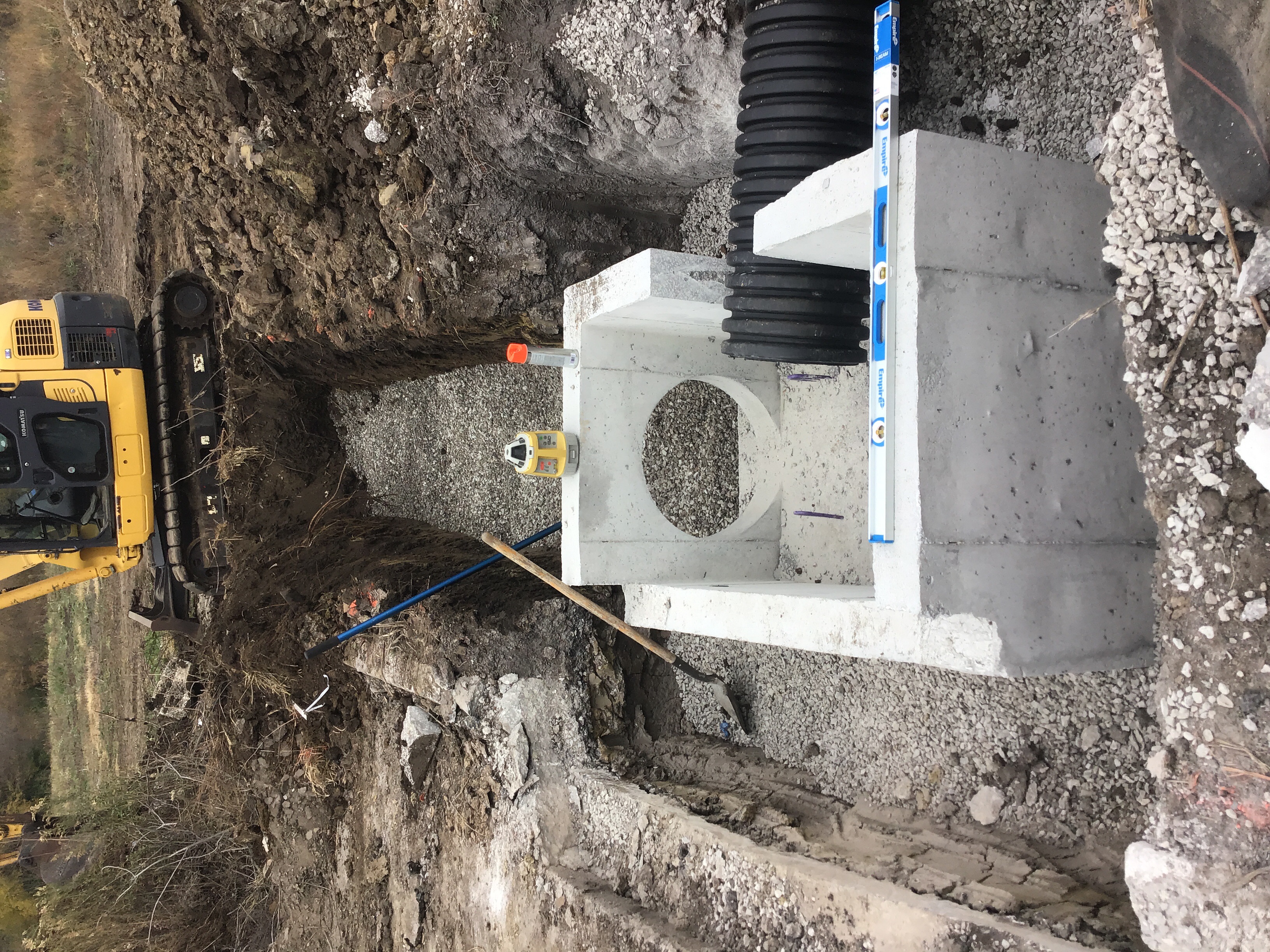

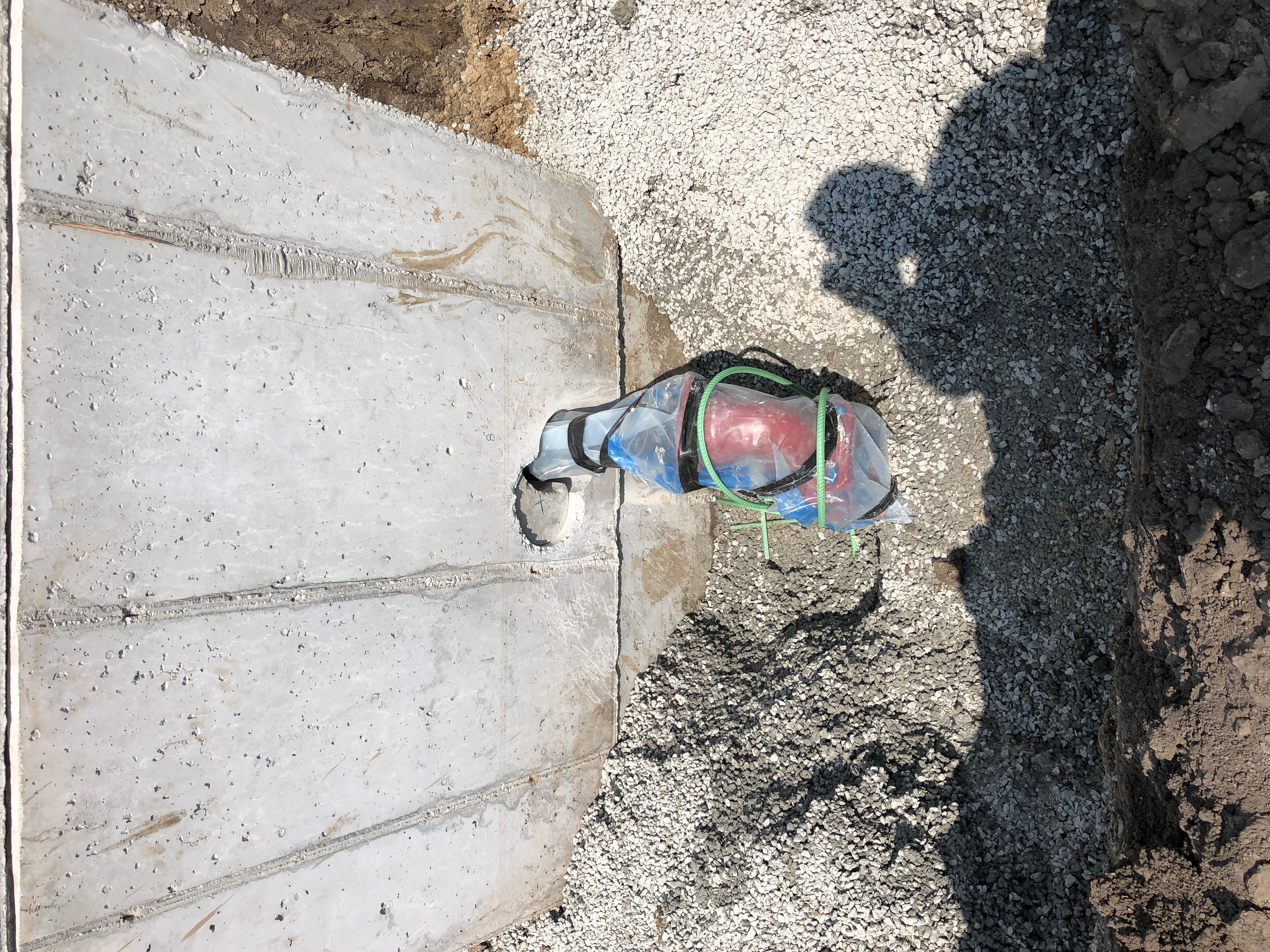

11/16/2018 image3
11/16/2018 Letter INSPECTION SUMMARY

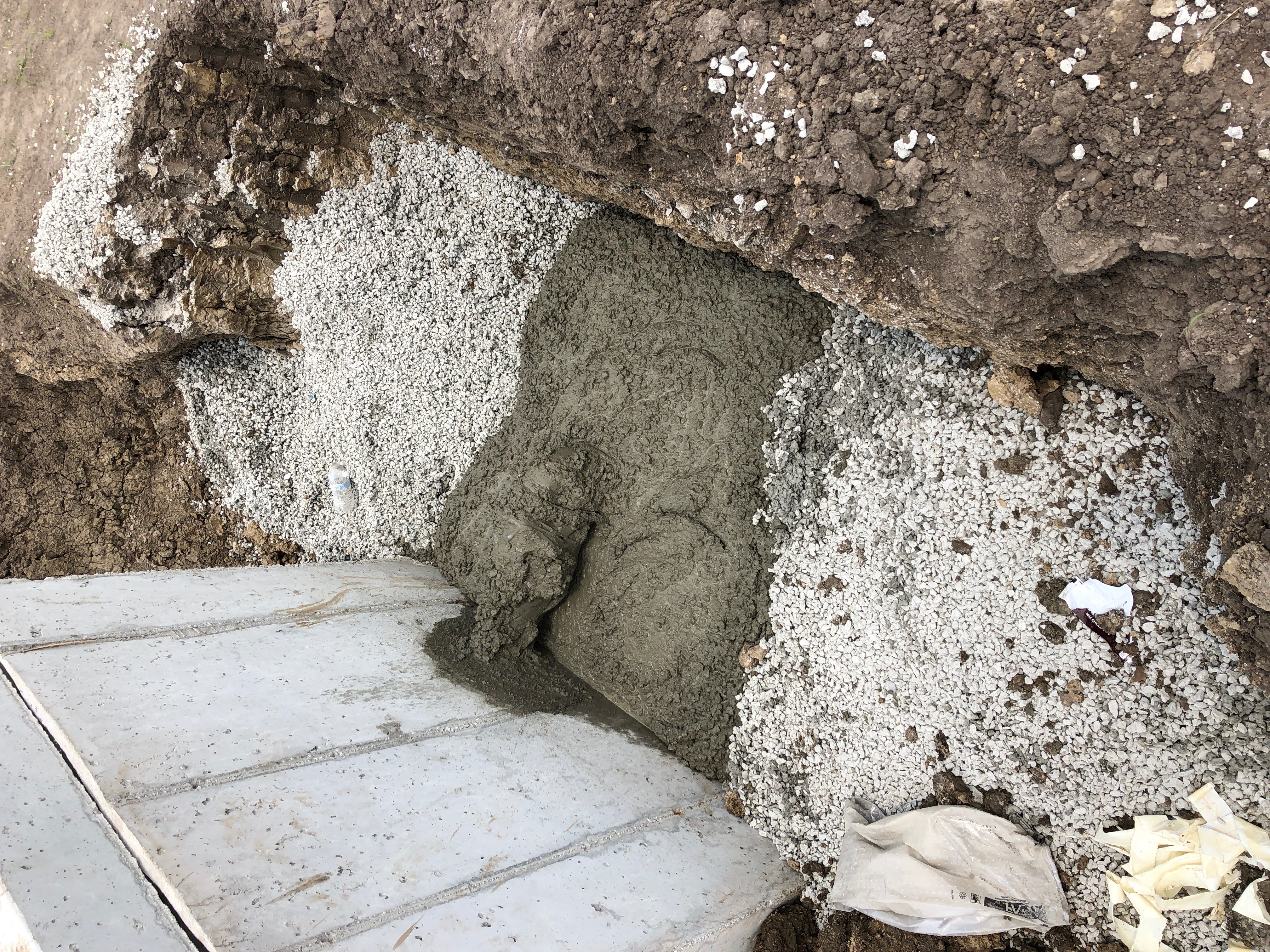

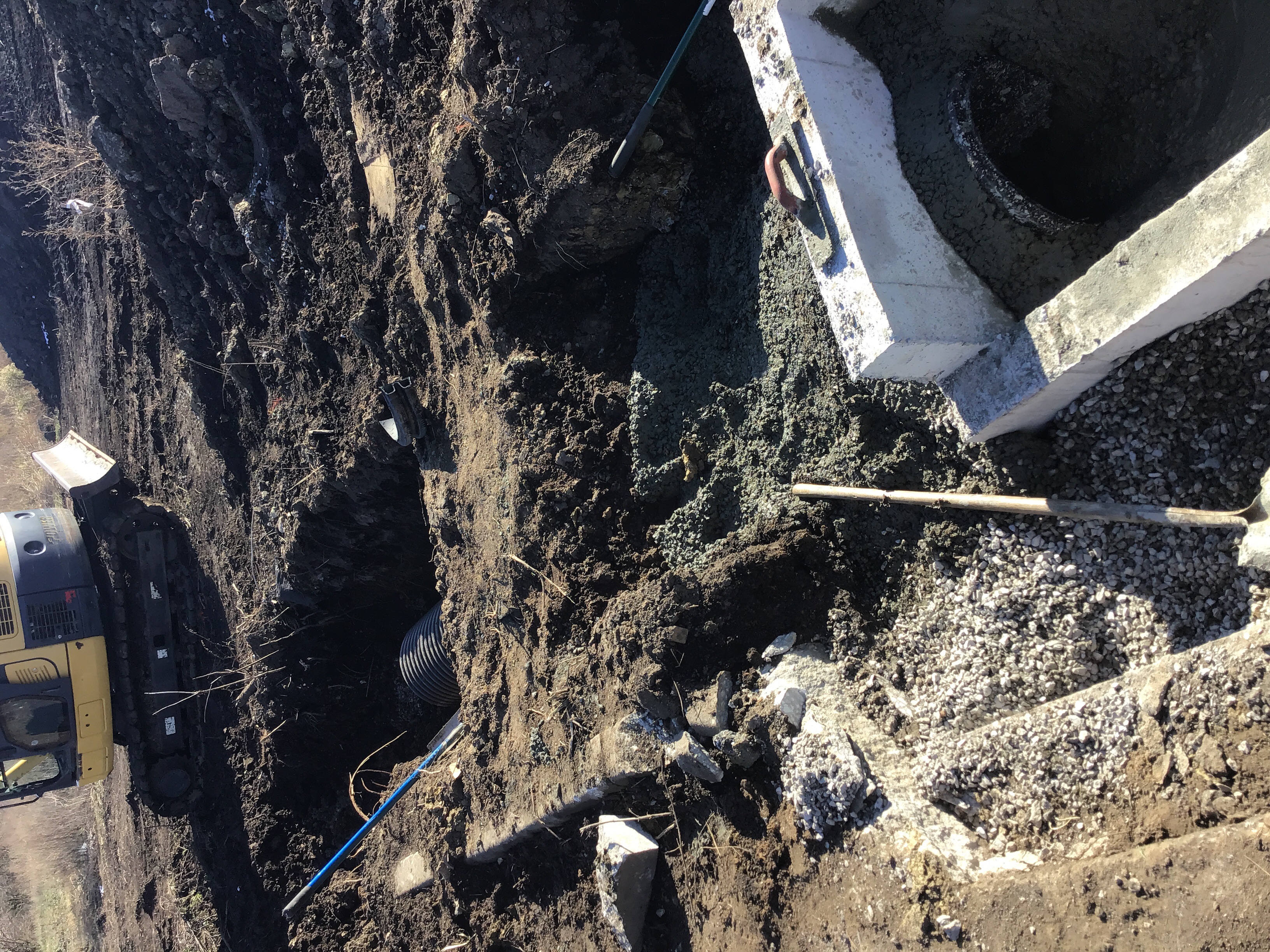

11/21/2018 image4

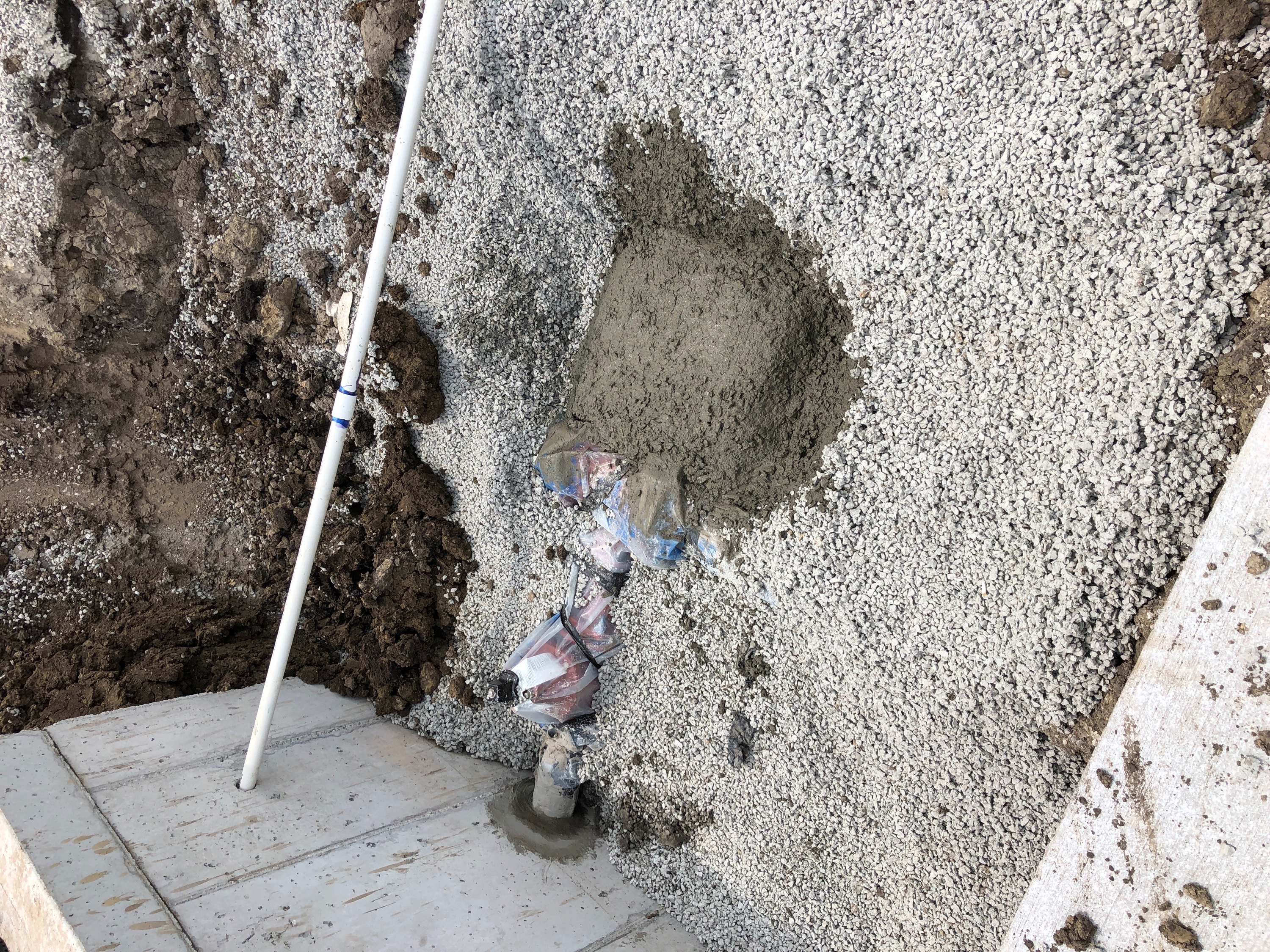

11/21/2018 image5
11/21/2018 Letter INSPECTION SUMMARY
12/10/2018 Proof roll parking lot 1
12/10/2018 Proof roll parking lot 2
12/10/2018 Letter INSPECTION SUMMARY
04/19/2019 Receipt Receipt for transaction: 2019-001517
04/22/2019 Letter INSPECTION SUMMARY
04/25/2019 Letter INSPECTION SUMMARY
04/25/2019 Letter INSPECTION SUMMARY
04/25/2019 Letter INSPECTION SUMMARY
05/29/2019 Letter INSPECTION SUMMARY
05/29/2019 Letter INSPECTION SUMMARY
05/29/2019 Letter INSPECTION SUMMARY
05/29/2019 Letter INSPECTION SUMMARY
05/31/2019 7D5912F8-F001-4687-BE90-16E731A017FB
05/31/2019 66808FFB-3B31-46E9-8216-958054EA4758
05/31/2019 66E70C97-6DB0-4B4E-8108-07F0A202BE46
05/31/2019 1EDDEFDC-A790-4543-A34D-FBC0F5C47873
05/31/2019 1E26D90B-B41E-4B54-91BD-D56C99CC6031
05/31/2019 A7C3F9F1-3B94-4155-A1FA-86B8AD7DD92F
05/31/2019 Letter INSPECTION SUMMARY
06/03/2019 Letter INSPECTION SUMMARY
06/03/2019 Letter INSPECTION SUMMARY
06/20/2019 Letter DE-Certificate of Substantial Completion Multiple Lot
06/20/2019 Letter DE-Punch List
06/26/2019 TPC Interiors Substantial Completion and Punch List
08/12/2019 Letter DE-Certificate of Final Acceptance (Commercial)
08/12/2019 TCP Interiors Inc. Final Acceptance
08/12/2019 TCP Interiors Inc. Final Affidavit and Agreement
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
