Permit Application Status

PRSITE20174026


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary



PRSITE20174026
Development - Site
Final Acceptance
LSMOB OWNER LLC
DEVELOPMENT COMPLETE
Full commercial site development
12/14/2017
08/27/2018
09/06/2022
Locations
Contacts
EXCEL CONSTRUCTORS, INC, Address:8041 W 47TH ST, Phone:(913) 261-1000
SHAFER KLINE & WARREN INC, Address:11250 CORPORATE AVE, Phone:(913) 888-7800
LSMOB OWNER LLC, Address:11715 ADMINISTRATION DR STE 200
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 08/22/2018
Development Center
Fees
Paid Fees Amount Paid Owing Date Paid
91100C8-Sanitary Sewer Insp Fees $88.80 $88.80 Paid 08/22/2018
91100C9-Water Insp Fee $529.50 $529.50 Paid 08/22/2018
9110068-Storm Fee $2,144.55 $2,144.55 Paid 08/22/2018
9110081-Paved Surface Inspection Fee $20,751.33 $20,751.33 Paid 08/22/2018
9110071-Site Grading Fee $1,350.03 $1,350.03 Paid 08/22/2018
9110072-Water Test Fee $200.00 $200.00 Paid 08/22/2018
8331401-Water Tap Fee $22,738.00 $22,738.00 Paid 09/21/2018
8350015-Water Meter Fee $2,307.98 $2,307.98 Paid 09/21/2018
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Erosion Control Inspection Partial 9/13/2018 09/14/2018
Informational
09/14/2018
John Jackson 09/14/2018 7:54 AM SILT FENCE WAS INSTALLED ACCORDING TO PLANS.
Storm - Pipe Partial 9/13/2018 at 1:30 PM 09/18/2018
Informational
09/18/2018
Removed the existing pipe and inlet according to plans.John Jackson 09/18/2018 3:21 PM

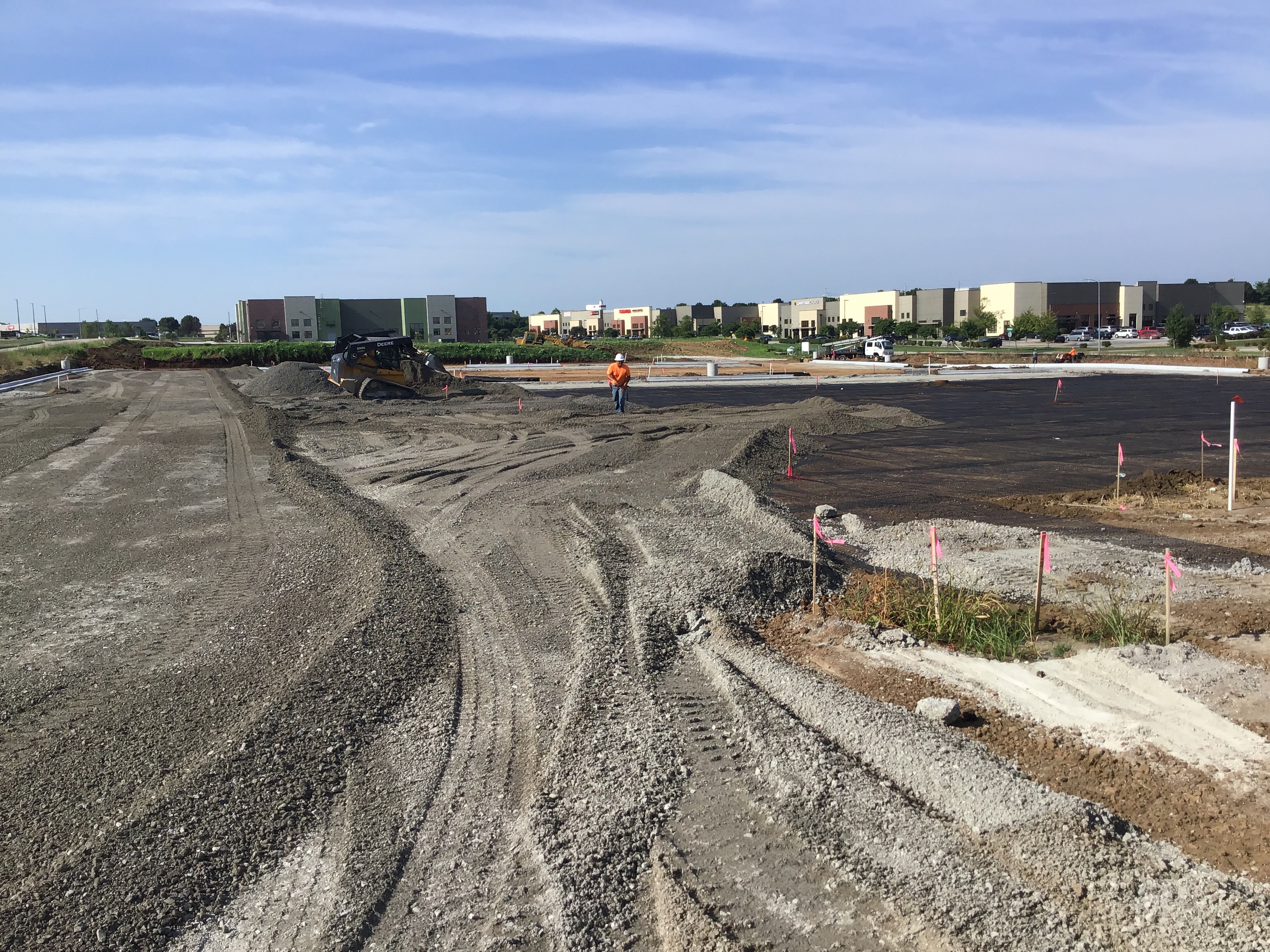

Grading/Excavation/Fill Inspection Partial 9/18/2018 09/18/2018
Informational
09/18/2018
Contractor continued to grade site for the last few working days 9/13/19 to 9/18/19John Jackson 09/18/2018 3:28 PM
Grading/Excavation/Fill Inspection Partial 9/19/2018 09/20/2018
Informational
09/20/2018
Contractor continues to grade and stabilize site for building construction.John Jackson 09/20/2018 3:48 PM
Grading/Excavation/Fill Inspection Partial 9/20/2018 09/21/2018
Informational
09/21/2018
Continued gradding and ground stabilization. John Jackson 09/21/2018 9:38 AM
Grading/Excavation/Fill Inspection Partial 9/21/2018 09/21/2018
Informational
09/21/2018
Continued gradding and ground stabilization. John Jackson 09/21/2018 9:35 AM
Storm - Pipe Partial 9/28/2089 09/28/2018
Informational
09/28/2018
Contractor cut opening in existing curb inlet to installed approximately 60' feet 18" on storm line 20. Installed curb inlet for storm lines 20 & 30 with inverts. John Jackson 09/28/2018 3:41 PM
Storm - Pipe Partial 11/1/2018 10/02/2018
Informational
10/02/2018
Contractor installed approximately 70' feet of 18" HDPE storm pipe on line 10 & a 4'X4' junction box at station 10+12.74. Curb inlet at station 10+00 was modifed according to field plans and approx. 12' feet 24" HDPE storm pipe was connect to newly installed junction box. John Jackson 10/02/2018 7:26 AM
Storm - Pipe Partial 10/2/2018 10/03/2018
Informational
10/03/2018
Contractor layed Approximately 60' feet of 24" HDPE piping out of the newly installed 4'X4' junction box on storm line 10. John Jackson 10/03/2018 6:46 AM
Storm - Pipe Partial 10/3/2018 10/03/2018
Informational
10/04/2018
Contractor continued moditication of existing Curb Inlets as per (plans see details 1-5/sheet C23). Contractor backfilled excavation around Curb Imlets & recently installed Piping. John Jackson 10/04/2018 7:11 AM
Storm - Pipe Partial 10/3/2018 10/04/2018
Informational
10/04/2018
Contractor continued modication of existing Curb Inlets as per (plans see details 1-5/sheet C23). Contractor backfilled excauation around Curb Inlets & recently installed Piping. John Jackson 10/04/2018 7:25 AM
Storm - Pipe Partial 10/4/2018 10/05/2018
Informational
10/05/2018
Contractor installed 30' feet of HDPE 24" on Storm Line 11 & new 4'X4" Field Inlet @ Sta 16+35.09. Contractor continued to modify existing tops of Curb Inlets. John Jackson 10/05/2018 8:00 AM
Storm - Pipe Partial 10/5/2018 10/05/2018
Informational
10/05/2018
Contractor completed the pouring of inverts Curb Inlet/Junction Box that were newly installed or modified according to consturtion plans.
Water Line - Construction Inspection Partial 6/5/2019 06/04/2019
Misc
Informational
06/04/2019
Contractor (Rainbow Cons.) located 8” water main line to install 8”valve, 6” valve, & 6” fire line valve. LS Water Dept. tested valves to shut line down for valve assemble install 6/5/19.
Informational
06/05/2019
Valve assembly was installed and measured.John Jackson 06/05/2019 5:04 PM
Water Line - Fire Hydrant Partial 6/5/2019 06/05/2019
Informational
06/05/2019
Hydrant assmebly was partialy installed.
Water Line - Construction Inspection Partial 6/7/2019 06/07/2019
Informational
06/07/2019
Rainbow Construction installed approximately 122' of 6" PVC and 117' of 4" PVC water pipe line. 6" line is the Fire Main and the 4" is the demostic service line.
Water Line - Fire Hydrant Partial 6/7/2019 06/07/2019
Informational
06/07/2019
Contractor continued the installation of hydrant.
Water Line - Thrust Restraint Partial 6/7/2019 06/07/2019
Informational
06/07/2019
Thurst block were poured for the two 8"x6" tees and a straddle block on the 6" and 6" reduce 4" lines coming out of the DIP Tees. Thrust blocks were poured behind hydrant assembly.
Water Line - Construction Inspection Partial 06/13/2019
Misc
Informational
06/05/2019
Rainbow Cons. I installed 8” valve and 2 /6” valve for domestic and fire lane. Hyrdrant assembly installed as per newer approved set of plans.
Water Line - Construction Inspection Partial 06/13/2019
Misc
Informational
06/13/2019
Water lines of the 4” domestic and 6” Fire line were chlorinated during construction 6/10/19. Contractor dechlorinated both lines today 6/13/19. 2” Water meter was installed with PVC vault.
Sanitary Sewer Construction Inspection Partial 06/13/2019
Misc
Informational
06/13/2019
Contractor installed 1 stick of 6” SDR-26 sanitary sewer main. 4’ Section of pipe was encased in concrete for future installation of roof storm drain piping go over the top of 6” sanitary sewer main.
Sidewalk Inspection Passed 06/13/2019
Misc
Informational
06/13/2019
6’X5’ Sidewalk was replaced because it was removed when new Fire Hydrant was installed as per plan.
Sanitary Sewer Construction Inspection Partial 06/17/2019
Misc
Informational
06/17/2019
Approximately 50’ of 6” Sanitary was installed and 6”x 8” Wye was installed on existing main .
Water Line - Hydrostatic Test Partial 06/17/2019
Misc
Informational
06/17/2019
2 hour Hydrostatic test passed on 4” domestic line and fire line. Tested at 150 psi for domestic and 200 psi . Bacteria test was done on both lines and sample were drop off at laboratory .
Water Line - Coliform Test 2 Partial 06/18/2019
Misc
Informational
06/18/2019
2 second sample taken from a 4” domestic & 6” fire line.
Water Line - Coliform Test 1 Partial 06/18/2019
Misc
Informational
06/18/2019
Sample taken from the 4” domestic & 6” fire line at 11:40 AM 6/17/19 .
Misc
Informational
06/18/2019
Sample taken from the 4” domestic & 6” fire line at 11:40 AM 6/17/19 .

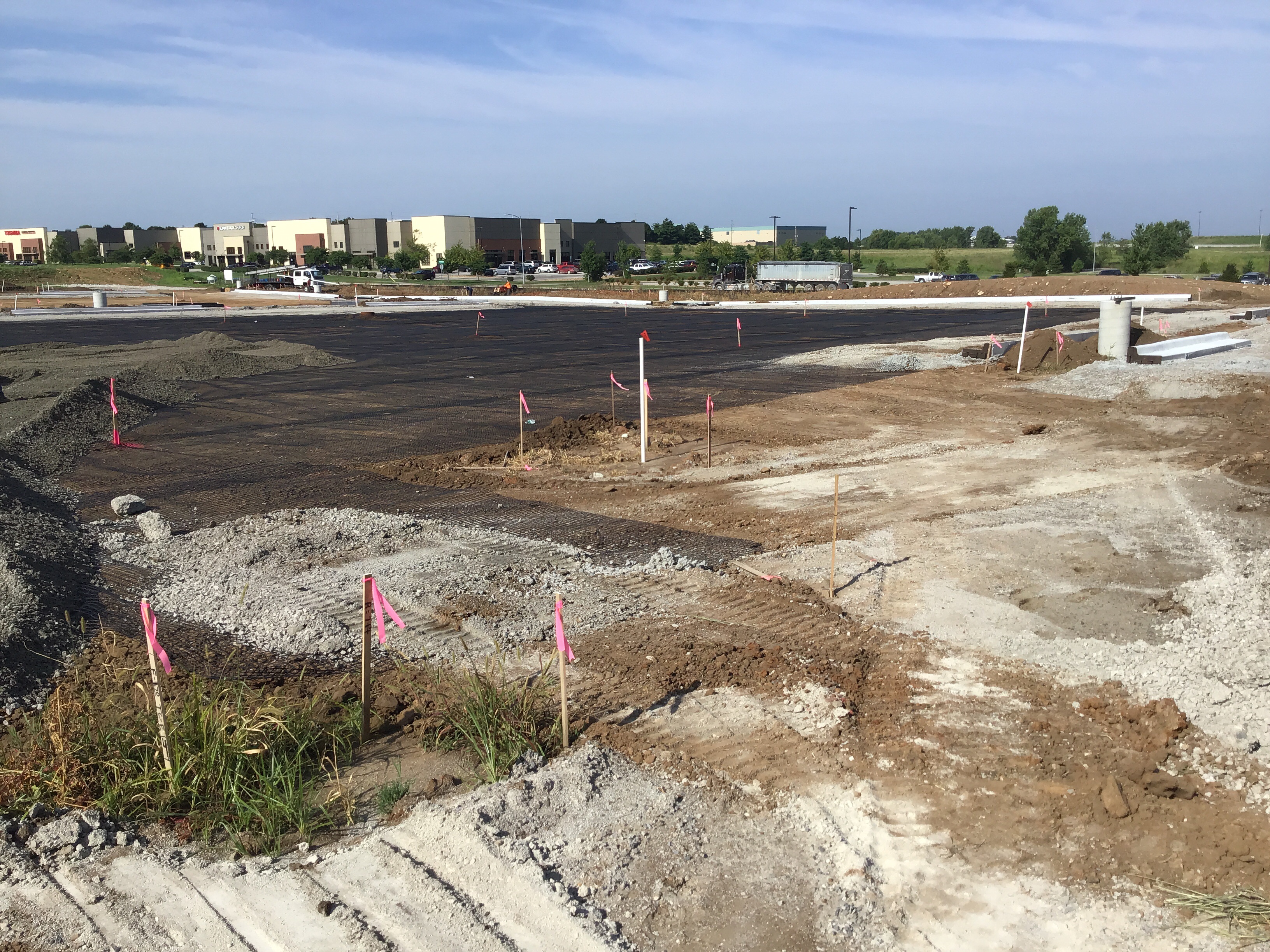

Proof roll parking lot Partial 7/12/2019 07/12/2019
Informational
07/12/2019
Proof roll passed .
Informational
08/23/2019
Proof roll passed on the two parking lot entrance.
Curb - Proof Roll Passed 7/12/2019 07/16/2019
Informational
07/12/2019
Curb proof roll passed for untreated soil 2 large areas of concern one was approximately a 10' X 1' East side of lot and the second infront of the a storm sewer on the west side . contractor will take off soil at least 6" and place geogrid in and install under three rock to grade. 2 small area less than 3' in length contractor will stabilize those areas and retest all areas of concern .
Misc
Informational
07/16/2019
Areas of concern were excavated 2 layers of Geogrid placed to stabilize areas . Curb proof roll passed . 7/16/19
Pavement-Stabilized Subgrade Partial 07/25/2019
Misc
Informational
07/25/2019
Contractor layed out Geogrid and hauled in Rule 5 rock /AB3 to stabilize subgrade of parking lot area.
Site Visit Partial 08/30/2019
Misc
Informational
08/30/2019
8-30-19 11:4am Rain. There is no activity on site at this time. They will need to add some erosion control to the site entrance.
Pavement-Surface Partial 09/06/2019
Corrective Action Required
09/06/2019
Contractor layed base level asphalt on parking lot 9/3/19 and finish 9/4/19. As per plans.
Storm - Pipe Partial 09/09/2019
Misc
Informational
09/09/2019
Contractor installed 25’ HDPE of 30” pipe and Nyoplast 30” reduce to 18” at Sta 11+09 Storm Line 10 approximately 35’ of 18”HDPE. Nyoplast 18” installed Sta 11+42 Storm Line 10. 9/9/19.
Storm - Pipe Partial 09/16/2019
Misc
Informational
09/16/2019
Contractor installed 55’ of 18” HPDE storm pipe. 1/15” Nyloplast Drain Basin @ 10e and 2/24” Nyloplast Drain Basin @ 10F & 10G. 9/11/19
Misc
Informational
10/07/2019
Contractor has restarted installing 15” HPDE storm pipe line 10. Approximately 28’ of HPDE. Contractor will begin installation again on Wednesday 10/9/19.
Driveway Inspection Passed 09/16/2019
Misc
Informational
09/16/2019
2 Driveway formed and poured two driveway entrance on NE MC Blaine Drive.
Sidewalk Inspection Passed 09/16/2019
Misc
Informational
09/16/2019

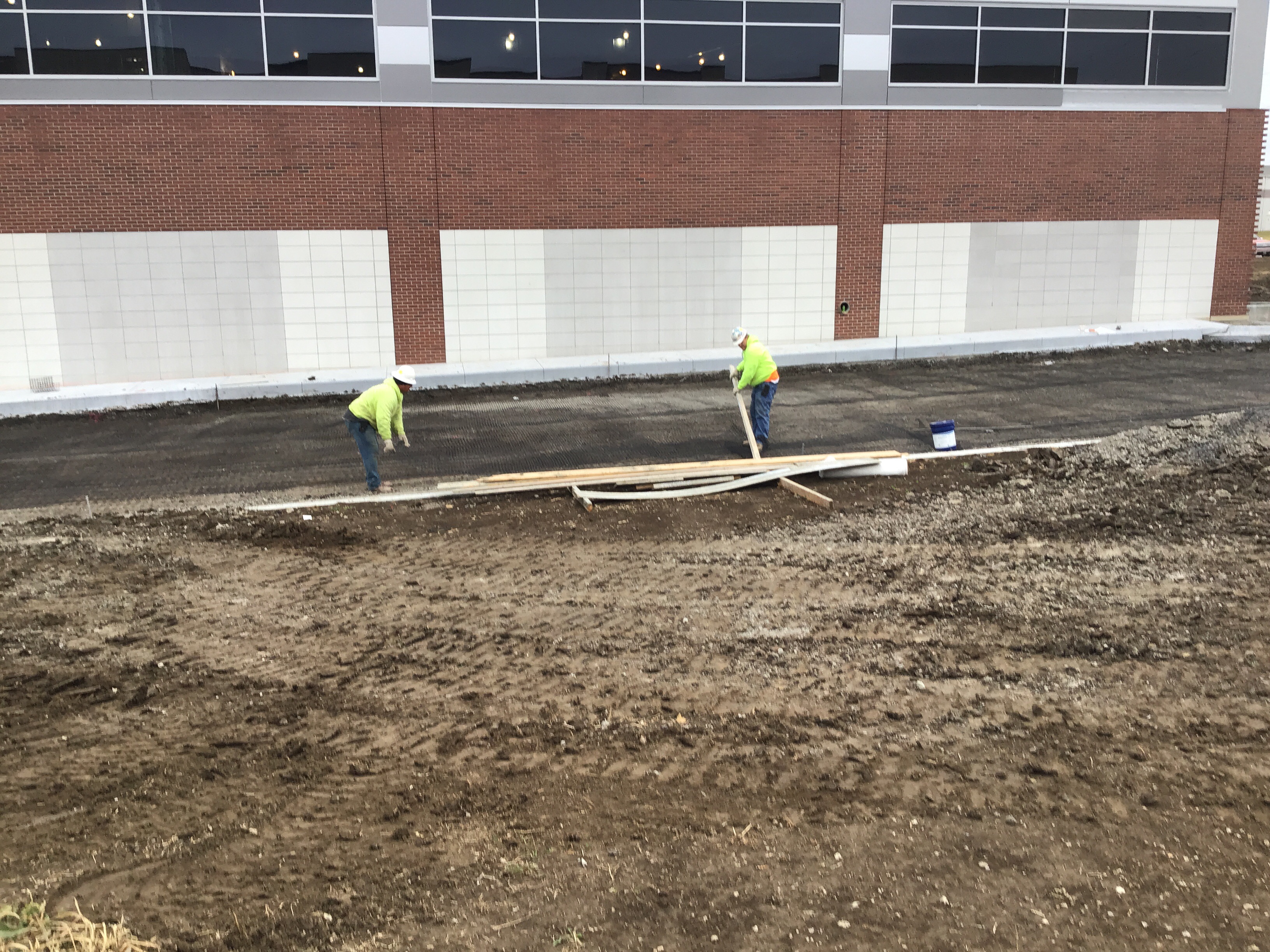

Sidewalks that were form on 9/13/19 were poured on 9/16/19. Contractor completed 500’ of sidewalk along NE Mc Blaine Drive.
Sidewalk Inspection Partial 09/20/2019
Misc
Informational
09/17/2019
Contractor installed forms and materials for future concrete pour. 9/17/19
Misc
Informational
09/20/2019
Contractor continued the installation of sidewalk.
Sidewalk Inspection Partial 09/24/2019
Misc
Informational
09/24/2019
Contractor continued to poured concrete.
Driveway Inspection Partial 10/02/2019
Misc
Informational
10/02/2019
Contractor continued to pour curb and sidewalks on the Northside of project or NE Jones Industrail Drive. ADA ramp was installed at the corner of NE Jones Industrial Dr & NE McBaine Dr. Contractor cured sidewalks and curbs installed. Contractor installed ADA ramp sidewalk and curbs 3:20 PM.

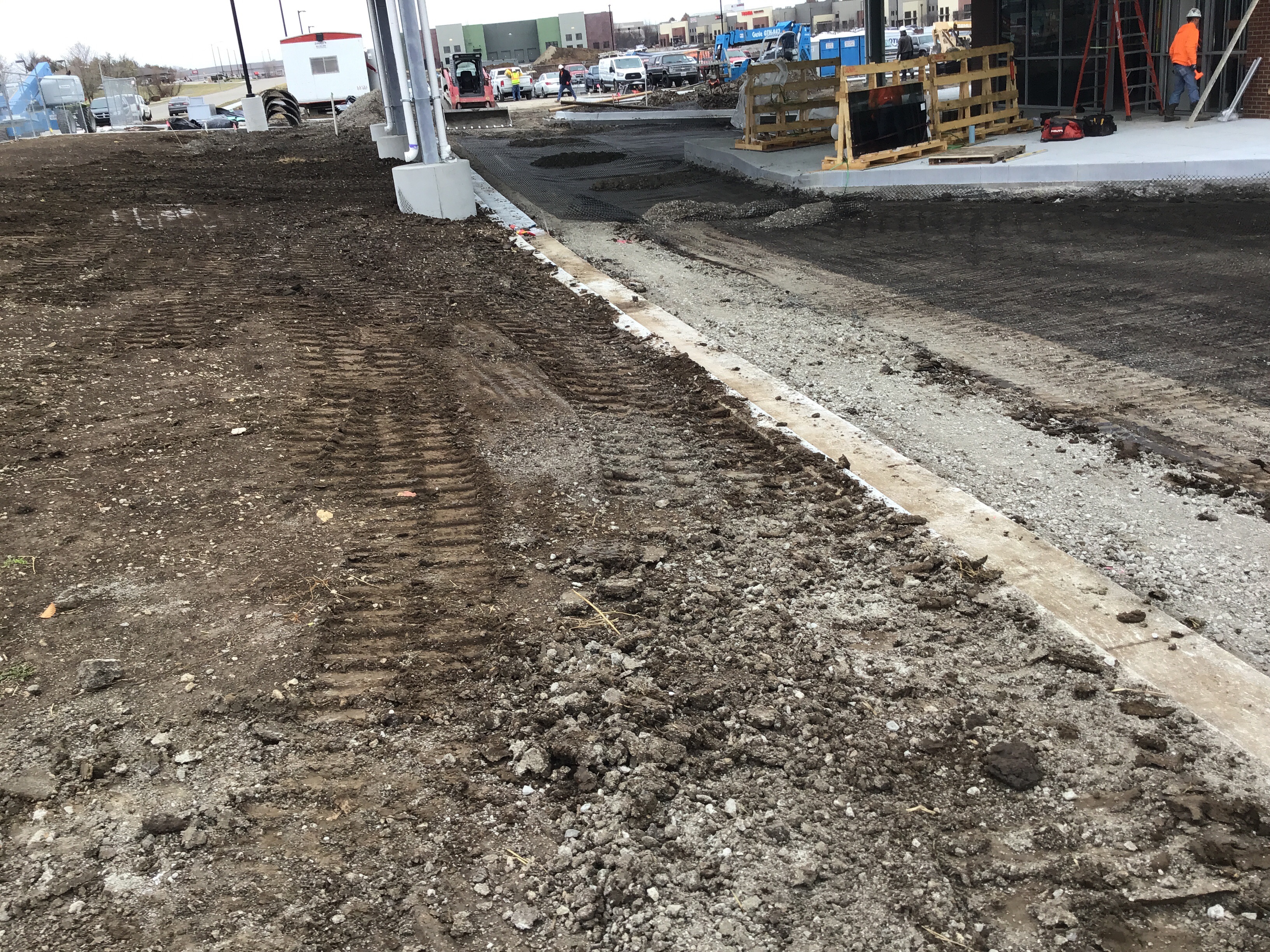

Pavement-Curb Construction Partial 11/14/2019
Misc
Informational
08/22/2019
Curbs in parking lot along the island area was completed. Curbs were poured approximately about a month ago.
Misc
Informational
11/14/2019
Contractor began installing curbs around the building.
Pavement-Stabilized Subgrade Partial 11/21/2019
Misc
Informational
07/25/2019
Contractor layed out Geogrid and hauled in Rule 5 rock /AB3 to stabilize subgrade of parking lot area.
Misc
Informational
11/21/2019
Street - Surface Course Partial 12/23/2019 at 12:30 PM 12/23/2019
Misc
Informational
12/23/2019
The contractor is installing surface asphalt today. After discussion with Dan Harper and Ryan Elam we have decided to let the contractors install the surface before the temperature is at 50degrees. The asphalt arrive at about 9:40 this morning and the temperature was approximately 43 degree's. I checked 2 trucks and the temperature was about 310 upon arrival and was being laid at about 285-290. I also came back again in the afternoon at 12:30 and checked several trucks coming in and everything appeared to be going well as the outside temperature was 56 degrees at 12:30. We also let the contractors know that we do not accept asphalt at below 50 degrees and that this is a one time thing and we will not do this on a public road and are only allowing it because it is private. I spoke with the asphalt company and they are going to warranty all the work being done as they think that 40 degree's is good enough for surface. The contractors are planning on working tomorrow as the temps are suppose to be in the 60's. I let them know this will be overtime pay because of the holiday and John Jackson will be working .
Street - Surface Course Partial 12/24/2019 12/24/2019
Informational
12/24/2019
Began laying asphalt on 12/23/19 finished approximately 40% that day. Contractor expected to complete 12/24/19 around noon. Do to owners insist and the owner taking responsibilty for final product asphalt was layed at 40 degrees and rising rather than our APWA standards of 50 degrres and rising.
Street - Surface Course Passed 12/24/2019
Misc
Informational
12/24/2019
Surface asphalt was completed 12/24/19 I collected the tickets from 12/23 to 12/24.
Water - Material Verification Passed 01/23/2020
Water Line - Thrust Restraint Passed 01/23/2020
Water Line - Construction Taps Removed Passed 01/23/2020
Sanitary - Material Verification Passed 01/23/2020
Water Line - Valve Passed 01/23/2020
Sanitary Sewer - Air Test Passed 01/23/2020
Sanitary Sewer - Mandrel Passed 01/23/2020
Sanitary Sewer - Vacuum Passed 01/23/2020
Sanitary Sewer - Invert Passed 01/23/2020
Curb - Proof Roll Passed 01/23/2020
Pavement-Proof Roll Passed 01/23/2020
Water - Material Verification Passed 01/23/2020
Pavement-Stabilized Subgrade Passed 01/23/2020
Pavement-Curb Construction Passed 01/23/2020
Driveway Inspection Passed 01/23/2020
Misc
Informational
10/02/2019
Contractor continued to pour curb and sidewalks on the Northside of project or NE Jones Industrail Drive. ADA ramp was installed at the corner of NE Jones Industrial Dr & NE McBaine Dr. Contractor cured sidewalks and curbs installed.
Sidewalk Inspection Passed 01/23/2020
Misc
Informational
09/24/2019
Contractor continued to poured concrete.
Misc
Informational
11/14/2019
Storm - Pipe Passed 01/23/2020
Misc
Informational
09/16/2019
Contractor installed 25’ HDPE of 30” pipe and Nyoplast 30” reduce to 18” at Sta 11+09 Storm Line 10 approximately 35’ of 18”HDPE. Nyoplast 18” installed Sta 11+42 Storm Line 10. 9/9/19.
Misc
Informational
10/07/2019
Site Visit Complete 01/23/2020
Misc
Informational
08/30/2019
8-30-19 11:4am Rain. There is no activity on site at this time. They will need to add some erosion control to the site entrance.
Pavement-Aggregate Base Passed 01/23/2020
Proof roll parking lot Passed 01/23/2020
Sanitary Sewer Construction Inspection Passed 01/23/2020
Misc
Informational
06/18/2019
Approximately 50’ of 6” Sanitary was installed and 6”x 8” Wye was installed on existing main .
Curb - Compression Strength Passed 01/23/2020
Sanitary Sewer Construction Inspection Passed 01/23/2020
Misc
Informational
06/18/2019
Approximately 50’ of 6” Sanitary was installed and 6”x 8” Wye was installed on existing main .
Water Line - Coliform Test 1 Passed 01/23/2020
Misc
Informational
06/18/2019
Sample taken from the 4” domestic & 6” fire line at 11:40 AM 6/17/19 .
Misc
Informational
06/18/2019
Sample taken from the 4” domestic & 6” fire line at 11:40 AM 6/17/19 .
Water Line - Coliform Test 2 Passed 01/23/2020
Water Line - Hydrostatic Test Passed 01/23/2020
Misc
Informational
06/17/2019
2 hour Hydrostatic test passed on 4” domestic line and fire line. Tested at 150 psi for domestic and 200 psi . Bacteria test was done on both lines and sample were drop off at laboratory .
Water Line - Construction Inspection Passed 01/23/2020
Misc
Informational
06/13/2019
Water lines of the 4” domestic and 6” Fire line were chlorinated during construction 6/10/19. Contractor dechlorinated both lines today 6/13/19. 2” Water meter was installed with PVC vault.
Water Line - Fire Hydrant Passed 01/23/2020
Grading/Excavation/Fill Inspection Passed 01/23/2020
Erosion Control Inspection Passed 01/23/2020
Sewer Service Inspection Passed 01/23/2020
Water Service Inspection Passed 01/23/2020
Informational
09/21/2018
Continued gradding and ground stabilization.John Jackson 09/21/2018 7:11 AM
Storm - Material Verification Passed 01/23/2020
Sanitary Sewer Construction Inspection Passed 01/23/2020
Storm - Material Verification Passed 01/23/2020
Sanitary - Material Verification Passed 01/23/2020
Water - Material Verification Passed 01/23/2020
Storm - Inlets Clean Passed 01/23/2020
Sidewalk Inspection Partial 11/15/2021 11/15/2021 11/15/2021
Misc
Informational
11/15/2021
11-15-21 AN forms are in place and aggregate is present and compacted. Had the crew adjust the forms because the slope was greater then 2%
Commercial Curb Inspection Partial 11/15/2021 11/15/2021 11/15/2021
Misc
Informational
11/15/2021
11-15-21 AN crew formed up curbs and began pouring on the east side of the building (street ) and the small section of curb in front of the building. Still need to do curb on the south side of parking lot.
Sidewalk Inspection Passed 12/2/2021 12/2/2021 12/02/2021
Misc
Informational
11/15/2021
11-15-21 AN forms are in place and aggregate is present and compacted. Had the crew adjust the forms because the slope was greater then 2%
Misc
Informational
12/02/2021
12-2-21 AN sidewalk looks good and meets Ada spec
Commercial Curb Inspection Passed 12/2/2021 12/2/2021 12/02/2021
Misc
Informational
11/15/2021
11-15-21 AN crew formed up curbs and began pouring on the east side of the building (street ) and the small section of curb in front of the building. Still need to do curb on the south side of parking lot.
Misc
Informational
12/02/2021
12-2-21 AN all curbs look good and completed
ESC - (Vegetation/Ground Cover) Partial 12/27/2021 12/27/2021 12/27/2021
Misc
Informational
12/27/2021
12-27-21 AN. Landscaper have started to get vegetation and adding/replacing trees
ESC - (Vegetation/Ground Cover) Passed 1/3/2022 1/3/2022 01/14/2022
Misc
Informational
01/14/2022
1-14-22 AN It appears that all the vegetation and ground cover has been completed.
Documents & Images
Date Uploaded File Type Document Name
08/22/2018 Receipt Receipt for transaction: 2018-005910
08/23/2018 Letter DE-Permit
09/14/2018 Letter DE-Daily Inspection Summary
09/18/2018 Letter DE-Daily Inspection Summary
09/18/2018 Letter DE-Daily Inspection Summary
09/21/2018 Letter DE-Daily Inspection Summary
09/21/2018 Letter DE-Daily Inspection Summary
09/21/2018 Receipt Receipt for transaction: 2018-006502
09/28/2018 Letter DE-Daily Inspection Summary
10/02/2018 Letter DE-Daily Inspection Summary
10/03/2018 Letter DE-Daily Inspection Summary
10/04/2018 Letter DE-Daily Inspection Summary
10/05/2018 Letter DE-Daily Inspection Summary
10/05/2018 Letter DE-Daily Inspection Summary
10/05/2018 Letter DE-Daily Inspection Summary
02/12/2019 Lee's Summit Surgical Center Sign Permit
06/04/2019 image
06/04/2019 Letter INSPECTION SUMMARY
06/05/2019 Letter DE-Daily Inspection Summary

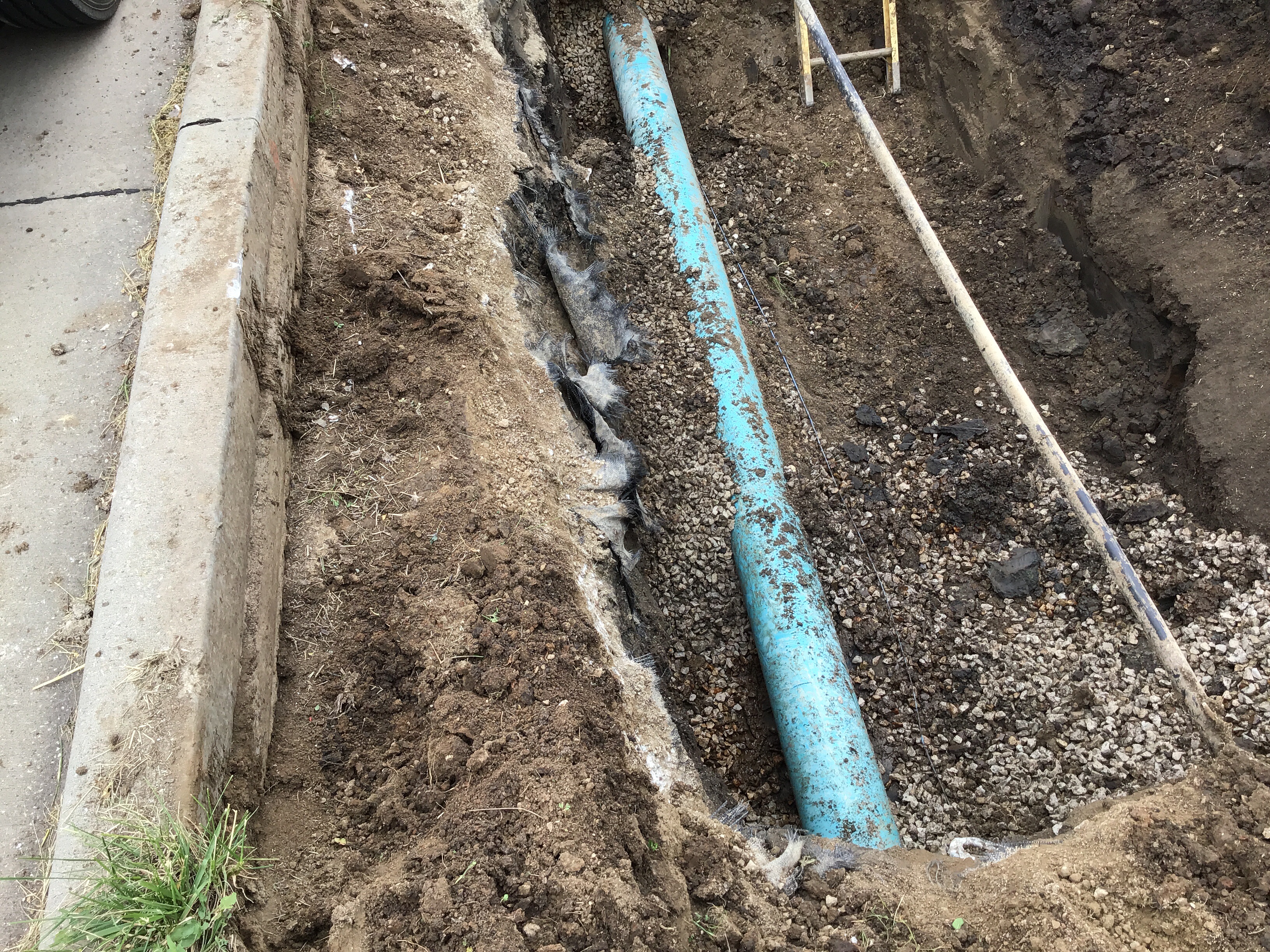

06/07/2019 Photo - Google Photos of water thurst & straddle blocks
06/07/2019 Letter DE-Daily Inspection Summary
06/13/2019 Letter INSPECTION SUMMARY
06/13/2019 Letter INSPECTION SUMMARY
06/17/2019 Letter INSPECTION SUMMARY
06/17/2019 Letter INSPECTION SUMMARY
06/17/2019 Letter DE-Daily Inspection Summary
06/17/2019 Letter INSPECTION SUMMARY
06/17/2019 Letter INSPECTION SUMMARY
06/18/2019 Letter INSPECTION SUMMARY
06/18/2019 Letter INSPECTION SUMMARY
07/12/2019 Letter DE-Daily Inspection Summary
07/16/2019 Letter INSPECTION SUMMARY
07/16/2019 Letter INSPECTION SUMMARY
07/16/2019 Letter DE-Daily Inspection Summary
07/16/2019 Letter INSPECTION SUMMARY
07/16/2019 Letter INSPECTION SUMMARY
07/16/2019 Letter INSPECTION SUMMARY
07/16/2019 Letter INSPECTION SUMMARY
07/16/2019 Letter DE-Daily Inspection Summary
07/16/2019 Letter INSPECTION SUMMARY
07/16/2019 Letter DE-Daily Inspection Summary
07/16/2019 Letter INSPECTION SUMMARY
07/16/2019 Letter INSPECTION SUMMARY
07/25/2019 image0
07/25/2019 image Subgrade
08/22/2019 Letter INSPECTION SUMMARY
08/22/2019 Letter INSPECTION SUMMARY
08/30/2019 Letter INSPECTION SUMMARY
09/06/2019 Letter DE-Daily Inspection Summary
09/16/2019 Letter INSPECTION SUMMARY
09/16/2019 Letter INSPECTION SUMMARY
09/16/2019 Letter INSPECTION SUMMARY
09/17/2019 Letter INSPECTION SUMMARY
09/24/2019 Letter INSPECTION SUMMARY
10/07/2019 Letter INSPECTION SUMMARY
11/21/2019 image1
11/21/2019 image Geo Mat 2
12/23/2019 Letter DE-Daily Inspection Summary
12/24/2019 Letter INSPECTION SUMMARY
12/24/2019 Letter INSPECTION SUMMARY
12/24/2019 Letter INSPECTION SUMMARY
05/21/2020 Letter DE-Punch List
05/21/2020 Letter DE-Certificate of Substantial Completion Multiple Lot
11/15/2021 Letter INSPECTION SUMMARY
11/15/2021 Letter INSPECTION SUMMARY
12/02/2021 Letter INSPECTION SUMMARY
12/02/2021 Letter INSPECTION SUMMARY
12/27/2021 Letter INSPECTION SUMMARY
01/14/2022 Letter INSPECTION SUMMARY
09/06/2022 Letter DE-Certificate of Final Acceptance (Commercial)
09/06/2022 Lee's Summit Surgical Center Final Acceptance
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
