Permit Application Status

PRCOM20225301


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary
PRCOM20225301
Building Permit - Commercial
Certificate of Occupancy
LEES SUMMIT SCHOOL DIST R 7
ADDITION COMMERCIAL
ADDITION TO EXISTING ROBOTICS FACILITY - INCLUDES INTERIOR ALTERATIONS TO ADJACENT SPACES
10/21/2022
12/09/2022
05/03/2024
01/26/2024
Locations
Contacts
LEES SUMMIT SCHOOL DIST R 7, Address:600 MILLER
MULTISTUDIO, Address:4200 PENNSYLVANIA AVE
Newkirk Novak Construction Partners, Inc., Address:15345 W 87TH ST PKWY, Phone:(913) 312-9535
Arrowhead Electric Inc, Address:1101 W Main St Suite B, Phone:(816) 656-0555
EDWARDS MCDOWELL INC, Address:400 E 10TH AVE, Phone:(816) 221-7878
QUESTEC MECHANICAL INC, Address:1390 E BOONE INDUSTRIAL DR, SUITE 260, Phone:(573) 875-0260
Spencer Brown, Phone:(913) 312-9541
Reviews
Review Type Outcome Est. Completion Date Completed
Alarm Plan Review Released for Construction 08/03/2023 08/02/2023
Jim Eden
Construction documents for fire alarm systems
Corrective Action Required
08/02/2023

/27/202372018 IFC 907.1.1- Construction documents. Construction documents for fire alarm systems shall be submitted for review and approval prior to system installation. Construction documents shall include, but not be limited to, all of the following: 1. .A floor plan which indicates the use of all rooms. 2. Locations of alarm-initiating and notification appliances. 3. Alarm control and trouble signaling equipment. 4. Annunciation. 5. Power connection. 6. Battery calculations. 7. Conductor type and sizes. 8. Voltage drop calculations. 9. Manufacturers, model numbers and listing information for equipment, devices and materials. 10. Details of ceiling height and construction. 11. The interface of fire safety control functions. Stamped plans received 07/27/2023.
Installation acceptance testing
Corrective Action Required
08/02/2023

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. Call (816) 969-1300 to schedule a test.
Building Plan Review Approved 11/21/2022 12/08/2022
Mike Weisenborn
Final Development Plan
Resolved
12/08/2022

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is informational. 11/14/22 - Acknowledged in letter.
Planning - Screening of ground mounted equipment
Resolved
11/18/2022

Unified Development Ordinance Article 8, Section 8.180.F Ground mounted equipment – Ground mounted equipment shall be totally screened from view by landscaping or masonry wall up to a height of the units to be screened. Action required: Make needed corrections to drawings that provide details as to how mechanical equipment will be screened from all 4 sides per referenced UDO section. 11/14/22 - pending approval from Planning 11/18/22 - planning addressed at FDP
NEC Article 210.63 Heating, air-conditioning and refrigeration outlet
Resolved
11/14/2022

2017 NEC Article 210.63 Heating, Air-Conditioning, and Refrigeration Equipment Outlet. A 125-volt, single-phase, 15- or 20-ampere-rated receptacle outlet shall be installed at an accessible location for the servicing of heating, air-conditioning, and refrigeration equipment. The receptacle shall be located on the same level and within 25 feet of the heating, air-conditioning, and refrigeration equipment. The receptacle outlet shall not be connected to the load side of the equipment disconnecting means. Action required: Provide receptacle near new ground mounted hvac equipment or provide verification of existing.
IMC 403.2.1 Recirculation of air
Resolved
11/14/2022

2018 IMC 403.2.1 Recirculation of air, item #3. Where mechanical exhaust is required by Note b in Table 403.3.1.1, recirculation of air from such spaces shall be prohibited. Recirculation of air that is contained completely within such spaces shall not be prohibited. Where recirculation of air is prohibited, all air supplied to such spaces shall be exhausted, including any air in excess of that required by Table 403.3.1.1. Action required: Exhaust air from restrooms is not to be recirculated but control point RD-CO appears to allow such a thing. Redesign or clarify to demonstrate compliance. 11/14/22 - 100% outside air
Final Development Plan Review Approved 11/25/2022 11/23/2022
Mike Weisenborn
LSHS - ROBOTICS FACILITY EXPANSION
Licensed Contractors Approved 11/21/2022 11/23/2022
Joe Frogge
LC - General Contractor
Resolved
11/14/2022

Lee's Summit Code of Ordinance, Section7-130.10 - Business License. It shall be unlawful for any person to engage in the construction contracting business without first obtaining a business license as required under the applicable provisions of Chapter 28 of the Lee's Summit Code of Ordinances. Action required: Either a Class A or Class B license is required. Provide the company name of the licensed general contractor and an email address & phone number for the on-site contact which is where inspection reports will be sent.
LC - MEP Subs
Resolved
11/23/2022

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors. 11/14/22 - Arrowhead Electric not licensed with us
Fire Plan Review Approved 11/21/2022 11/15/2022
Ben Hicks
Duct smoke detectors
Resolved
11/15/2022

2018 IFC 907.3.1 Duct smoke detectors. Smoke detectors installed in ducts shall be listed for the air velocity, temperature and humidity present in the duct. Duct smoke detectors shall be connected to the building's fire alarm control unit when a fire alarm system is rquired by Section 907.2. Activation of a duct smoke detector shall initiate a visible and audible supervisory signal at a constantly attended location and shall perform the intended fire safety function in accordance with theis code and the International Mechanical Code. Duct smoke detectors shall not be used as a substitute for required open area detection.
Illumination required
Resolved
11/15/2022

2018 IFC 1008.1 Illumination required. The means of egress, shall be illuminated at all times the building space served by the means of egress is occupied.
Fire Plan Review Rejected 11/04/2022 11/01/2022
Ben Hicks
Duct smoke detectors
Corrective Action Required
11/01/2022

2018 IFC 907.3.1 Duct smoke detectors. Smoke detectors installed in ducts shall be listed for the air velocity, temperature and humidity present in the duct. Duct smoke detectors shall be connected to the building's fire alarm control unit when a fire alarm system is rquired by Section 907.2. Activation of a duct smoke detector shall initiate a visible and audible supervisory signal at a constantly attended location and shall perform the intended fire safety function in accordance with theis code and the International Mechanical Code. Duct smoke detectors shall not be used as a substitute for required open area detection.
Illumination required
Corrective Action Required
11/01/2022

2018 IFC 1008.1 Illumination required. The means of egress, shall be illuminated at all times the building space served by the means of egress is occupied.
Building Plan Review Rejected 11/04/2022 10/28/2022
Joe Frogge
Final Development Plan
Corrective Action Required
10/28/2022

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is informational.
Planning - Screening of ground mounted equipment
Corrective Action Required
10/28/2022

Unified Development Ordinance Article 8, Section 8.180.F Ground mounted equipment – Ground mounted equipment shall be totally screened from view by landscaping or masonry wall up to a height of the units to be screened. Action required: Make needed corrections to drawings that provide details as to how mechanical equipment will be screened from all 4 sides per referenced UDO section.
NEC Article 210.63 Heating, air-conditioning and refrigeration outlet
Corrective Action Required
10/28/2022

2017 NEC Article 210.63 Heating, Air-Conditioning, and Refrigeration Equipment Outlet. A 125-volt, single-phase, 15- or 20-ampere-rated receptacle outlet shall be installed at an accessible location for the servicing of heating, air-conditioning, and refrigeration equipment. The receptacle shall be located on the same level and within 25 feet of the heating, air-conditioning, and refrigeration equipment. The receptacle outlet shall not be connected to the load side of the equipment disconnecting means. Action required: Provide receptacle near new ground mounted hvac equipment or provide verification of existing.
IMC 403.2.1 Recirculation of air
Corrective Action Required
10/28/2022

2018 IMC 403.2.1 Recirculation of air, item #3. Where mechanical exhaust is required by Note b in Table 403.3.1.1, recirculation of air from such spaces shall be prohibited. Recirculation of air that is contained completely within such spaces shall not be prohibited. Where recirculation of air is prohibited, all air supplied to such spaces shall be exhausted, including any air in excess of that required by Table 403.3.1.1. Action required: Exhaust air from restrooms is not to be recirculated but control point RD-CO appears to allow such a thing. Redesign or clarify to demonstrate compliance.
Licensed Contractors Rejected 11/04/2022 10/28/2022
Joe Frogge
LC - General Contractor
Corrective Action Required
10/28/2022

Lee's Summit Code of Ordinance, Section7-130.10 - Business License. It shall be unlawful for any person to engage in the construction contracting business without first obtaining a business license as required under the applicable provisions of Chapter 28 of the Lee's Summit Code of Ordinances. Action required: Either a Class A or Class B license is required. Provide the company name of the licensed general contractor and an email address & phone number for the on-site contact which is where inspection reports will be sent.
LC - MEP Subs
Corrective Action Required
10/28/2022

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors.
Fees
Paid Fees Amount Paid Owing Date Paid
9110078-Valuation Fee for Addition to Commercial $4,900.00 $4,900.00 Paid 12/09/2022
$3,679.50
7232302-Commercial License Tax Fee $1,839.75 $1,839.75 Paid 10/24/2022
$1,839.75
9110081-Paved Surface Inspection Fee $1,023.68 $1,023.68 Paid 12/09/2022
9110068-Storm Fee $288.60 $288.60 Paid 12/09/2022
91100C8-Sanitary Sewer Insp Fees $1,096.20 $1,096.20 Paid 12/09/2022
9110071-Site Grading Fee $204.00 $204.00 Paid 12/09/2022
9110069-After Hours Inspections (Public Works)(Per Hour) $150.00 $150.00 Paid 08/21/2023
9110069-After Hours Inspections (Public Works)(Per Hour) $400.00 $400.00 Paid 08/21/2023
9110069-After Hours Inspections (Public Works)(Per Hour) $100.00 $100.00 Paid 08/21/2023
9110078-Temporary Occupancy Fee $50.00 $50.00 Paid 08/23/2023
9110078-Temporary Occupancy Fee $50.00 $50.00 Paid 09/20/2023
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Sanitary Sewer Construction Inspection Partial 12/27/2022
Misc
Informational
12/27/2022

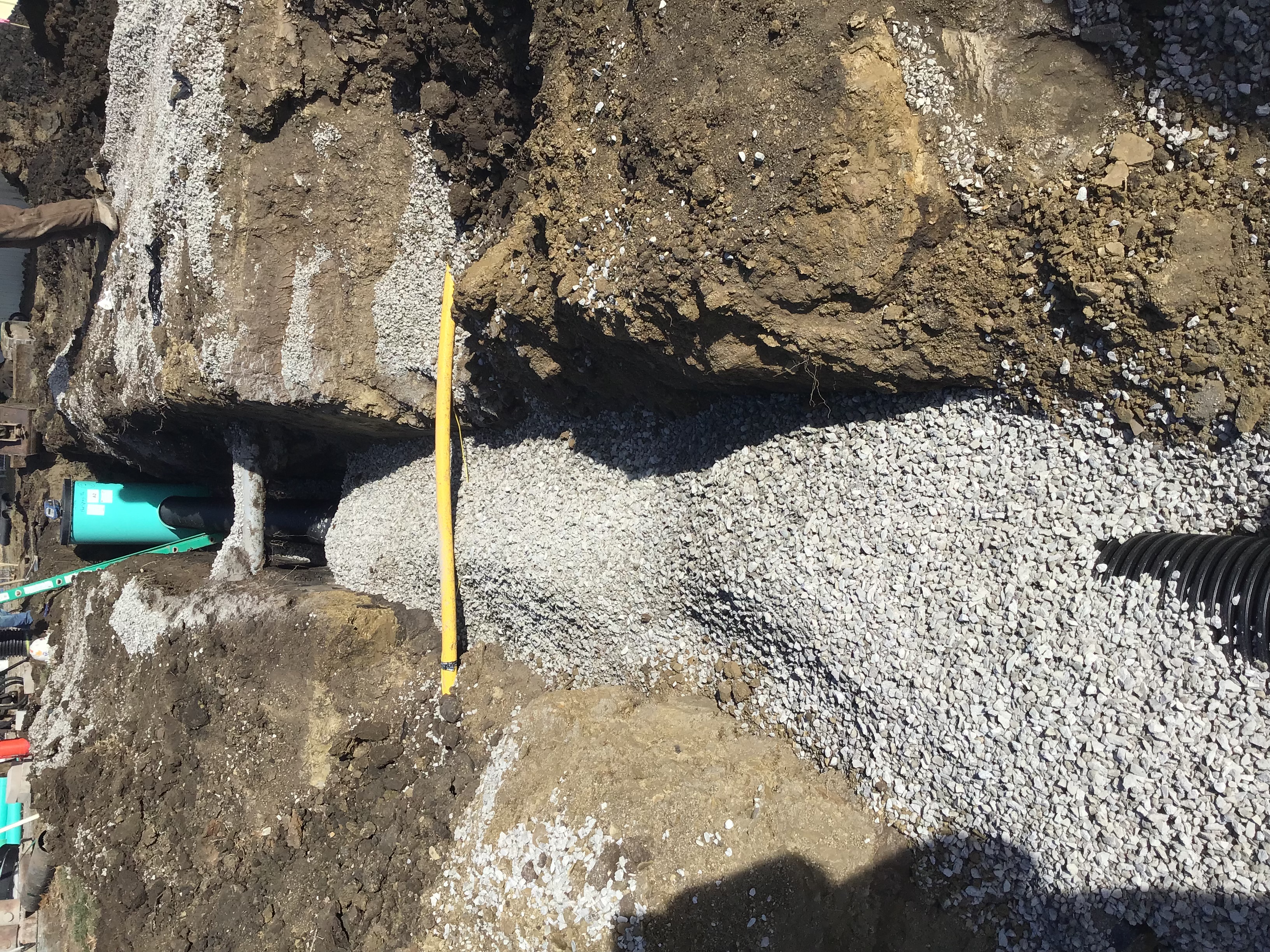

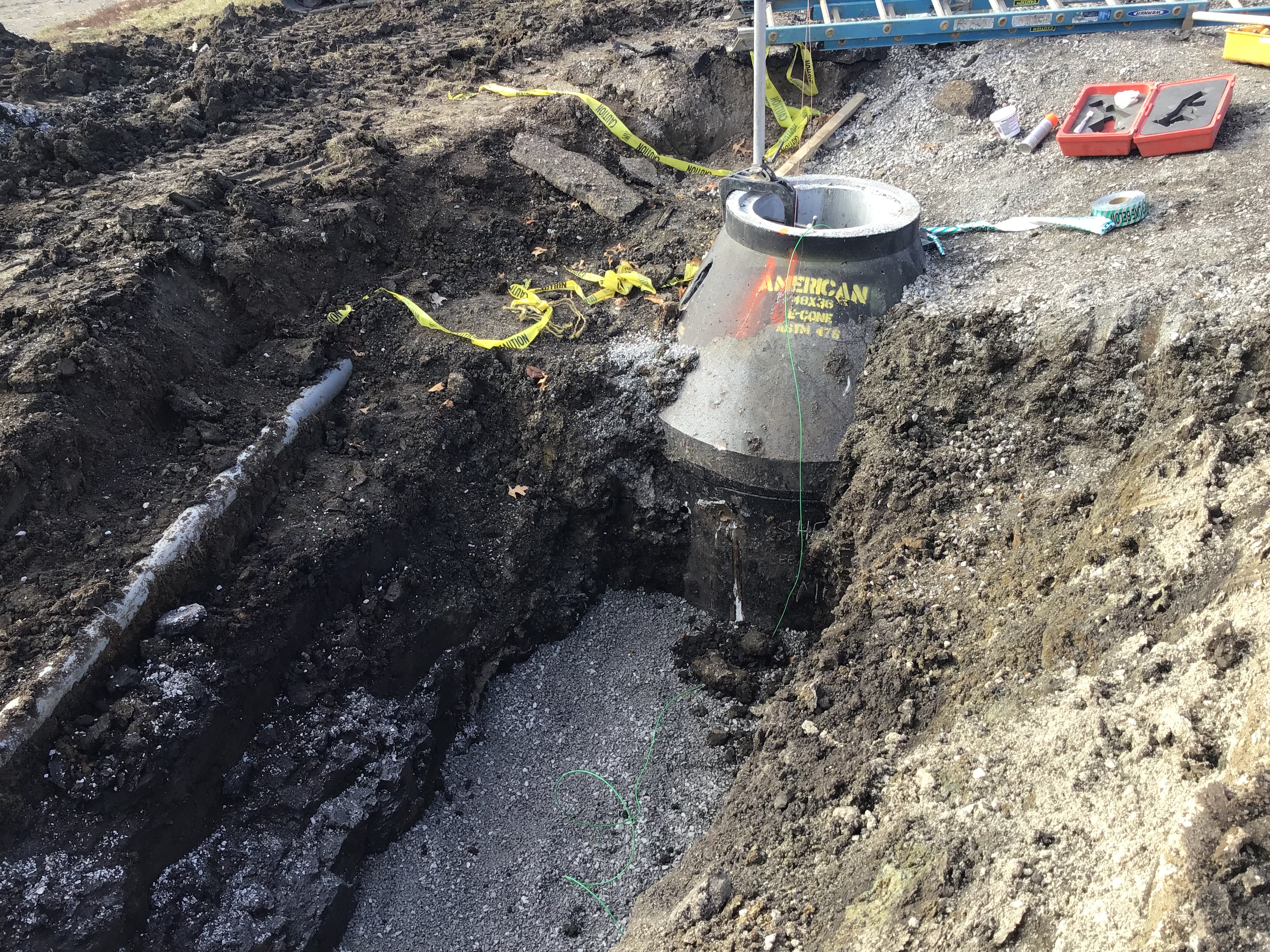

12/27/22 Tuesday ( She Digs It SDI ) Contractor installing MH A1 @STA 3+23.74 4’ sanitary sewer doghouse manhole see detail 706, C790-C. 12/28/22 Wednesday ( SDI ) Contractor have installed approximately 200’ of 8” SDR-26 sanitary sewer and MH A2. 01/04/23 Wednesday JMJ ( SDI ) Contractor continued to install 8” PVC SDR-26 @ 0.81% grade from MH A2, also installing trace wire and tape. Progress is slow due to existing service lines in pathway. 01/05/23 Thursday JMJ ( SDI ) Talked with Supervisor & Lee’s Summit Water representative and was told to have contractor test sewer sanitary line mandrel, pressure test, and vacuum test. Contractor is schedule to pour invert for MH A2 , collar was already pour around 12/29/22 with MH A1. Contractor will connect to 6” DIP service lateral as per plan. MH A2 to A3 will be mandrel after installation. Approximately 70’ of 8” PVC 26-SDR, 8”X6”wye, max adapter from 6” DIP & 22.5 deg bend with 4’ to the wye. Testing of sanitary line will occur on Monday of next week. 01/09/23 Monday JMJ (SDI ) Contractor has unearth an issue with possibly an existing live gas main is in the path of the 8” sanitary main that is to be installed. 01/11/23 Wednesday JMJ ( SDI ) Contractor installed storm box A1 yesterday. Nyloplast A2 was this morning A3 & A4 this afternoon. See Storm Sewer Plans & Profile ( C600-C ). Approximately 60’ of 10” HDPE corrugated storm pipe. Serta Tees were installed as-per plan. 01/26/23 Thursday JMJ ( SDI ) Contractor schedule to pour flowable fill in abandon sewer line.
Gas Service Inspection - Commercial Passed 12/30/2022 12/30/2022 12/30/2022
Misc
Resolved
12/30/2022
Storm Sewer Construction Inspection Partial 1/10/2023 1/10/2023 01/10/2023
Misc
Informational
01/10/2023

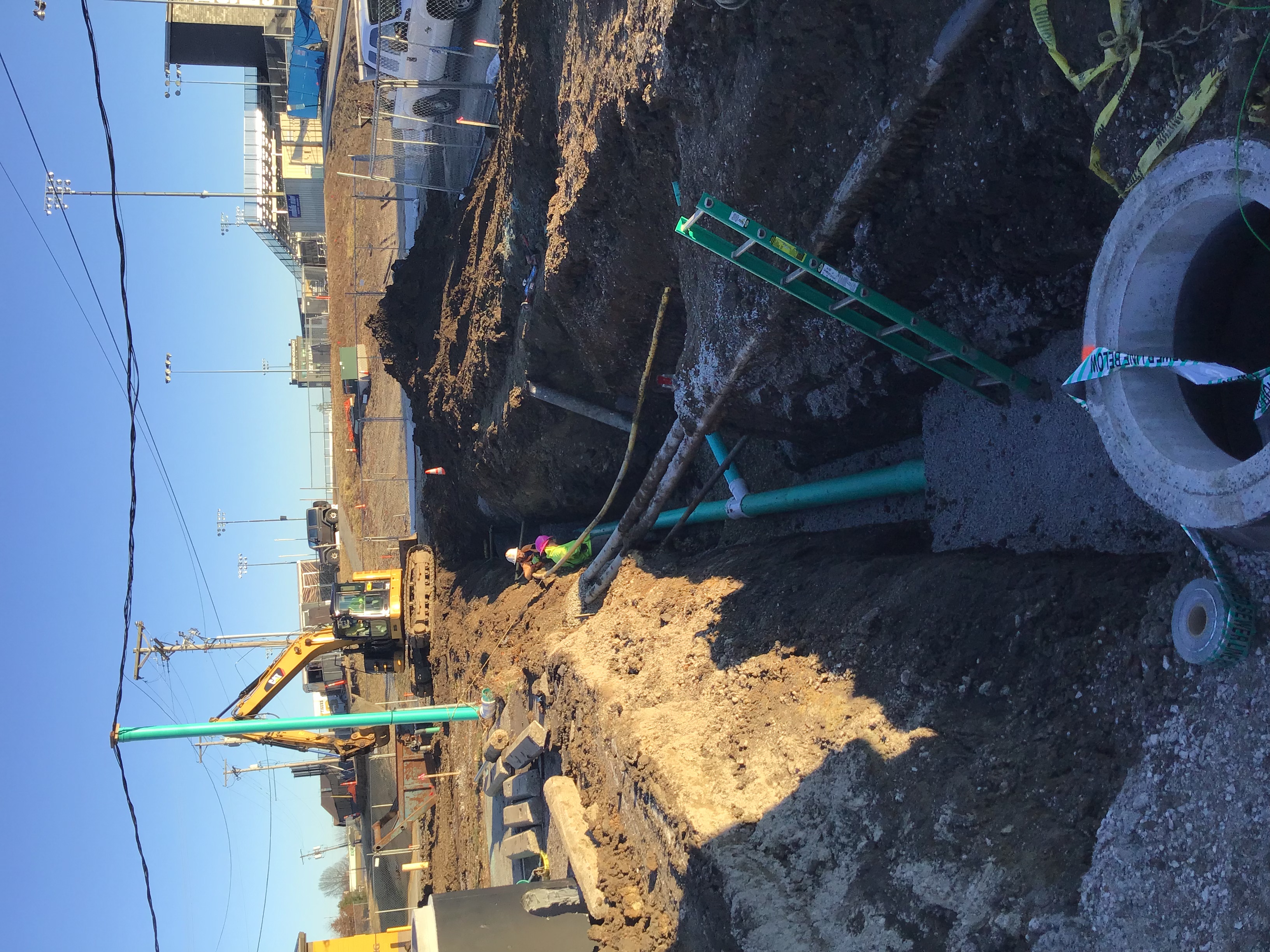

01/10/23 Tuesday ( SDI ) Contractor installed storm box A1 and poured collar & inverts. Excavation was backfilled.
Miscellaneous Inspection Partial 1/12/2023 1/12/2023 01/12/2023
Misc
Informational
01/12/2023

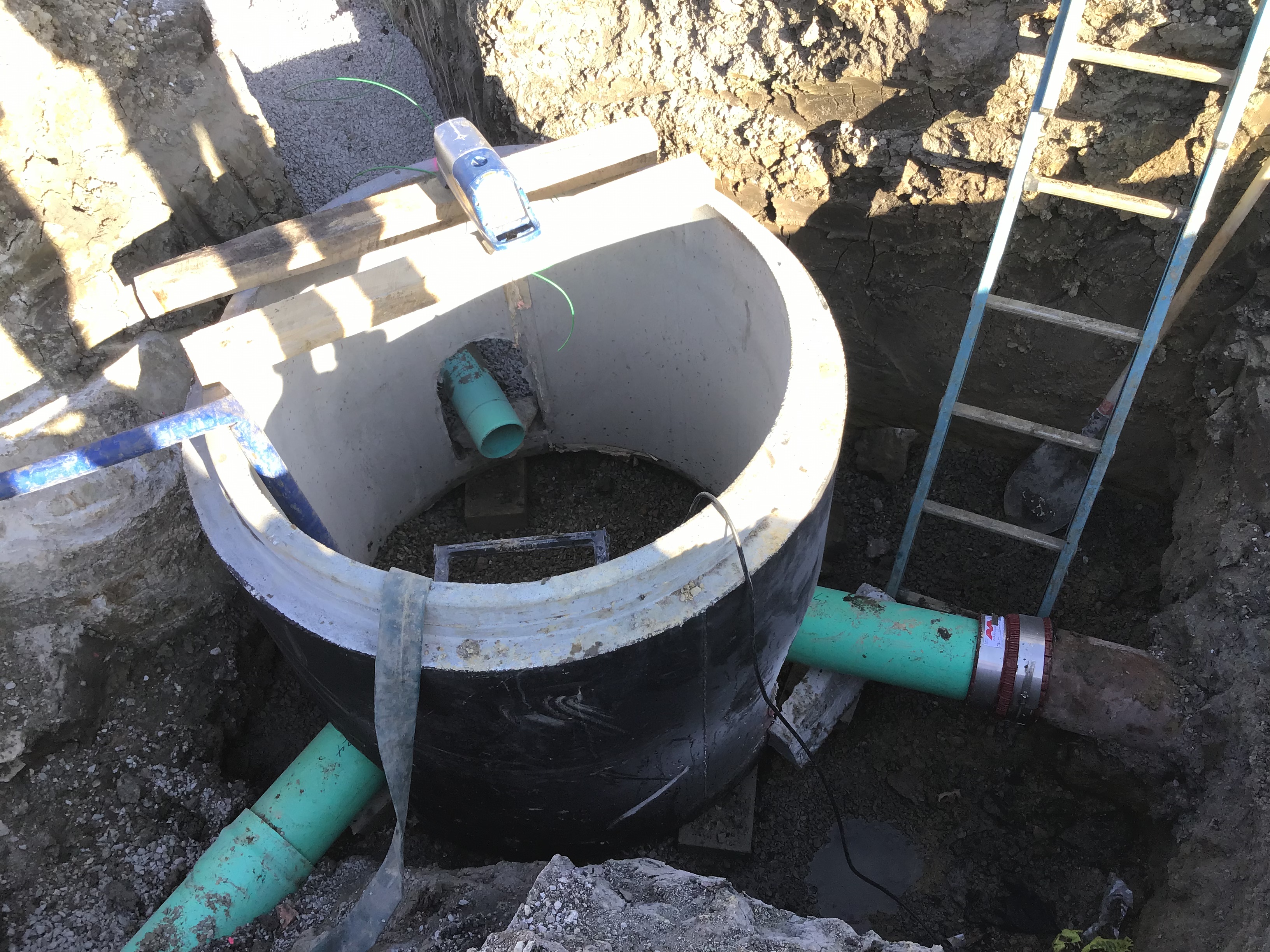

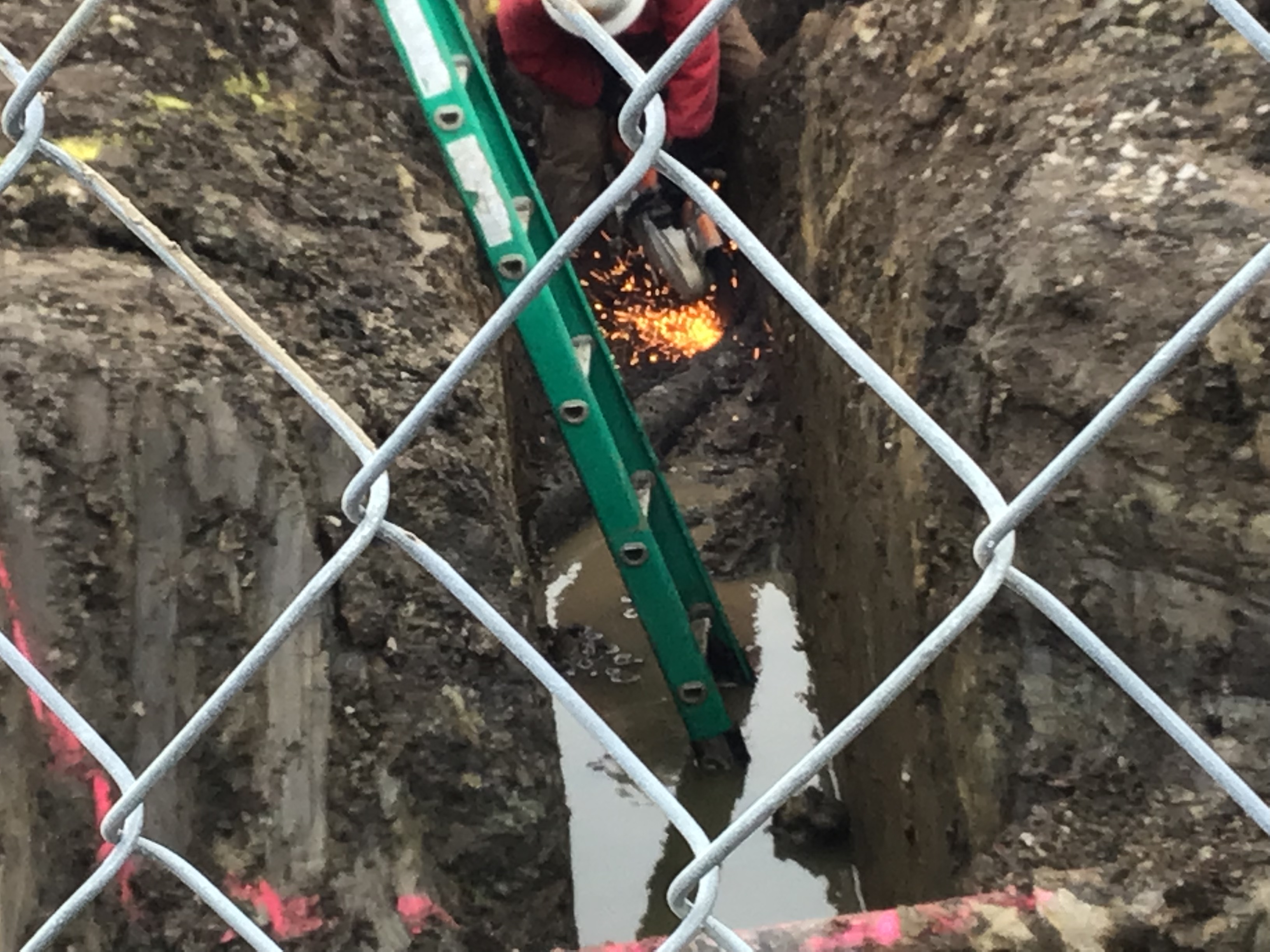

01/12/23 Thursday JMJ ( SDI ) Contractor is following a gas line ( that is in the path of sanitary main installation ) to verify if it is active.
Sanitary Sewer Construction Inspection Partial 1/12/2023 1/12/2023 01/12/2023
Misc
Informational
12/27/2022
12/27/22 Tuesday ( She Digs It SDI ) Contractor installing MH A1 @STA 3+23.74 4’ sanitary sewer doghouse manhole see detail 706, C790-C. 01/12/23 Thursday ( SDI ) Contract removing abandoned gas main so they can continued the installation of 8” sanitary main.
Sanitary Sewer Construction Inspection Partial 1/16/2023 1/16/2023 01/16/2023
Misc
Informational
01/12/2023
12/27/22 Tuesday ( She Digs It SDI ) Contractor installing MH A1 @STA 3+23.74 4’ sanitary sewer doghouse manhole see detail , C790-C. 01/12/23 Thursday ( SDI ) Contract removing abandoned gas main so they can continued the installation of 8” sanitary main. 01/16/23 Monday ( SDI ) Contractor was able to install MH A3@STA 6+34.92 sanitary running newly installed sanitary line. Contractor connected to the existing main with a max adapter also began to install approximately 63’ sewer service line see C700-C.
Sanitary Sewer Construction Inspection Partial 1/16/2023 1/16/2023 01/16/2023
Misc
Informational
01/16/2023
12/27/22 Tuesday ( She Digs It SDI ) Contractor installing MH A1 @STA 3+23.74 4’ sanitary sewer doghouse manhole see detail , C790-C. 01/12/23 Thursday ( SDI ) Contract removing abandoned gas main so they can continued the installation of 8” sanitary main. 01/16/23 Monday ( SDI ) Contractor was able to install MH A3@STA 6+34.92 sanitary running newly installed sanitary line. Contractor connected to the existing main with a max adapter also began to install approximately 63’ sewer service line see C700-C. Contractor poured floor of Dog House sanitary as-per project details.
Storm Sewer Construction Inspection Partial 1/9/2023 1/9/2023 01/16/2023
Misc
Informational
01/10/2023
01/10/23 Tuesday ( SDI ) Contractor installed storm box A1 and poured collar & inverts. Excavation was backfilled. 01/16/23 Monday ( SDI ) Contractor poured invert and collars on storm box.
Sanitary Sewer Construction Inspection Partial 1/17/2023 1/17/2023 01/17/2023
Misc
Informational
01/16/2023
12/27/22 Tuesday ( She Digs It SDI ) Contractor installing MH A1 @STA 3+23.74 4’ sanitary sewer doghouse manhole see detail , C790-C. 01/12/23 Thursday ( SDI ) Contract removing abandoned gas main so they can continued the installation of 8” sanitary main. 01/16/23 Monday ( SDI ) Contractor was able to install MH A3@STA 6+34.92 sanitary running newly installed sanitary line. Contractor connected to the existing main with a max adapter also began to install approximately 63’ sewer service line see C700-C. Contractor poured floor of Dog House sanitary as-per project details. 01/17/23 Tuesday JMJ ( SDI ) Contractor installed approximately 53’ of lateral coming form MH A3 & 32’ of the lateral before MH A3. Contractor backfilled excavation.
Erosion Control Inspection Partial 1/18/2023 1/18/2023 01/18/2023
Misc
Informational
01/18/2023
01/18/23 Wednesday JMJ Erosion control passed inspection.
Water Service Inspection Partial 1/20/2023 1/20/2023 01/20/2023
Misc
Informational
01/20/2023

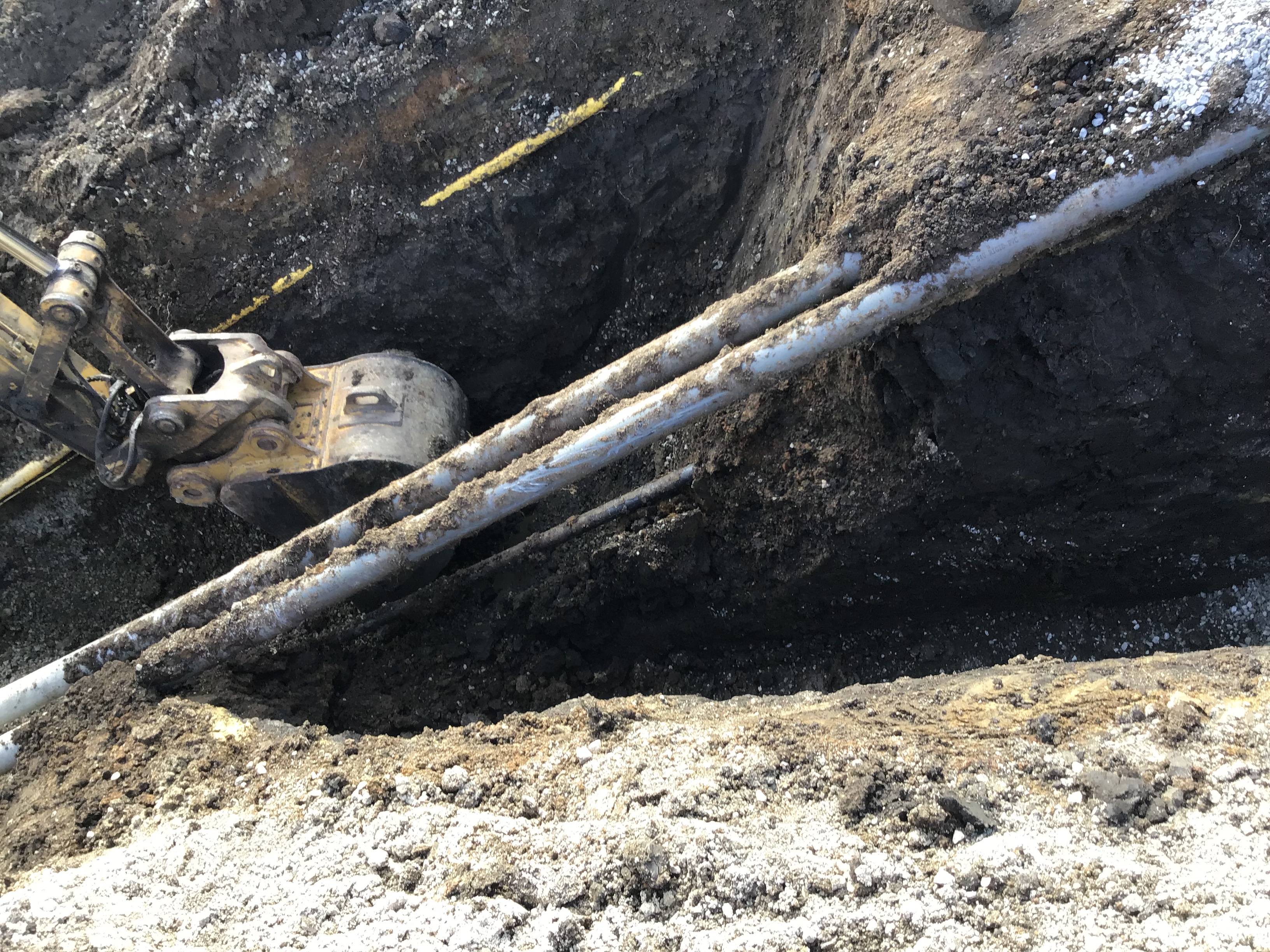

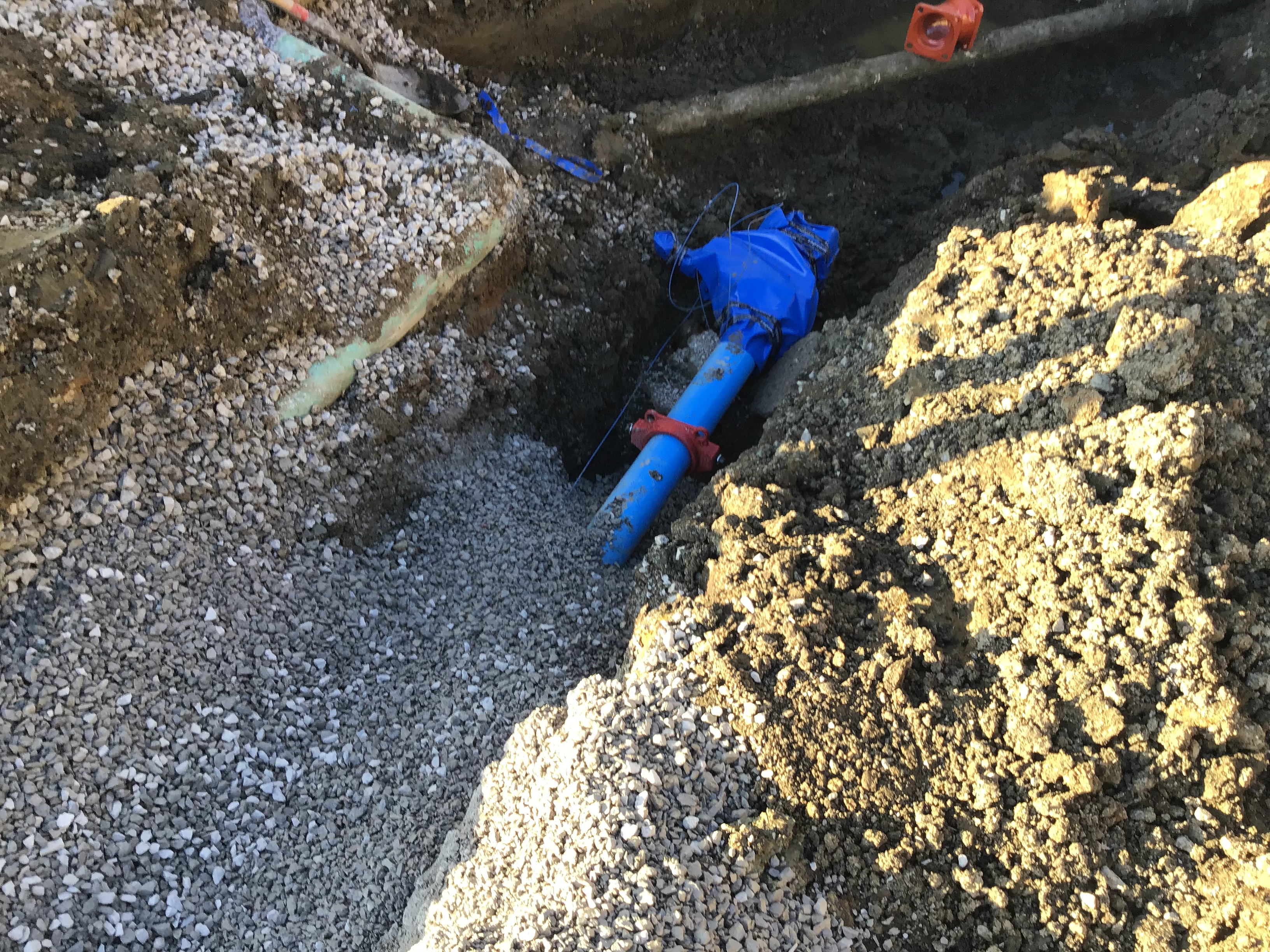

01/20/23 Friday JMJ ( SDI ) Contractor installing 4” & 6” water domestic and fire main ( See C500-C ) 81,83, & 85.
Water Service Inspection Partial 1/20/2023 1/20/2023 01/20/2023
Misc
Informational
01/20/2023
01/20/23 Friday JMJ ( SDI ) Contractor installing 4” & 6” water domestic and fire main ( See C500-C ) 81,83, & 85. Approximately 60’ of 4” PVC was installed with 4’X4’ tee 45 deg bend, and straddle block ring. Contractor will continue construction of water main next week.
Water Service Inspection Partial 1/23/2023 1/23/2023 01/23/2023
Misc
Informational
01/20/2023
01/20/23 Friday JMJ ( SDI ) Contractor installing 4” & 6” water domestic and fire main ( See C500-C ) 81,83, & 85. Approximately 60’ of 4” PVC was installed with 4’X4’ tee 45 deg bend, and straddle block ring. Contractor will continue construction of water main next week. 01/23/23 Monday JMJ ( SDI ) Contractor poured backing and straddle blocks on 4” main. Around 10:30AM.
Underslab Plumbing Inspection - Commercial Partial 1/23/2023 1/23/2023 01/23/2023
Misc
Informational
01/23/2023
-Sanitary tie in to existing building ok
Water Line - Hydrostatic Test Passed 1/24/2023 1/24/2023 01/24/2023
Misc
Informational
01/24/2023
01/24/23 Tuesday JMJ ( SDI ) Hydrostatic test pass @ 150psi.
Sanitary Sewer - Mandrel Passed 1/24/2023 1/24/2023 01/24/2023
Misc
Informational
01/24/2023
01/24/23 Tuesday JMJ ( SDI ) Mandrel test passed for MH A3 to A2 & A1 to A2.
Sanitary Sewer - Vacuum Passed 1/24/2023 1/24/2023 01/24/2023
Misc
Informational
01/24/2023
01/24/23 Tuesday JMJ ( SDI ) Vacuum Test pass for MH A2.
Sanitary Sewer - Air Test Passed 1/24/2023 1/24/2023 01/24/2023
Misc
Informational
01/24/2023
01/24/23 Tuesday JMJ ( SDI ) 8” Sanitary main line passed Air Test as-per Specifications.
Water Service Inspection Partial 1/25/2023 1/25/2023 01/25/2023
Misc
Informational
01/23/2023
01/20/23 Friday JMJ ( SDI ) Contractor installing 4” & 6” water domestic and fire main ( See C500-C ) 81,83, & 85. Approximately 60’ of 4” PVC was installed with 4’X4’ tee 45 deg bend, and straddle block ring. Contractor will continue construction of water main next week. 01/23/23 Monday JMJ ( SDI ) Contractor poured backing and straddle blocks on 4” main. Around 10:30AM. 01/25/23 Wednesday JMJ ( SDI ) Chlorinated the approximately 60’ of 4” water line yesterday and de-chlorinated today. Tomorrow we will take the first bacterial water sample.
Water Line - Coliform Test 1 Partial 1/26/2023 1/26/2023 01/26/2023
Misc
Informational
01/26/2023
01/26/23 Thursday JMJ ( SDI ) Collected first sample for the appropriate 60’ of 4” PVC water main today.
Water Line - Coliform Test 1 Passed 1/30/2023 1/30/2023 01/30/2023
Misc
Informational
01/26/2023
01/26/23 Thursday JMJ ( SDI ) Collected first sample for the appropriate 60’ of 4” PVC water main today. 01/30/23 Monday JMJ ( SDI ) Sample passed.
Water Line - Coliform Test 2 Partial 1/30/2023 1/30/2023 01/30/2023
Misc
Informational
01/30/2023
01/30/23 Monday JMJ ( SDI-Floyd ) Sample #2 was collected and taken Keystone lab for bacteria testing.
Water Service Inspection Partial 2/3/2023 2/3/2023 02/03/2023
Misc
Informational
01/25/2023
01/20/23 Friday JMJ ( SDI ) Contractor installing 4” & 6” water domestic and fire main ( See C500-C ) 81,83, & 85. Approximately 60’ of 4” PVC was installed with 4’X4’ tee 45 deg bend, and straddle block ring. Contractor will continue construction of water main next week. 01/23/23 Monday JMJ ( SDI ) Contractor poured backing and straddle blocks on 4” main. Around 10:30AM. 01/25/23 Wednesday JMJ ( SDI ) Chlorinated the approximately 60’ of 4” water line yesterday and de-chlorinated today. Tomorrow we will take the first bacterial water sample. 02/03/23 Friday JMJ ( SDI ) Contractor tied into the existing 4" water with reducer 3"X4", 2-4"/45 deg bends, & 4" sleeve, approximately 18' of water at this point South side of building. Second location 3"X4"X4" tee, 45 deg, 3"X4" reducer, & 4" sleeve. Contractor poured straddle block and backing blocks for fittings. Contractor installed 3" poly water line to for temporary connection for Workshop/Robotics Center. Contractor flush water line for 20mins when restoring water.
Erosion Control Inspection Residential Partial 3/3/2023 3/3/2023 03/03/2023
Misc
Informational
03/03/2023
03/03/23 Friday Erosion control Inspector will inform GC about the clean up needed of Parking Lot between the new site for the expansion of robotic building and NW end of Lee's Summit attached building (gym & classrooms). Construction vehicle are carrying mud and soil on tires.
Water Line - Construction Inspection Passed 3/17/2023 3/17/2023 03/17/2023
Misc
Informational
03/17/2023
03/17/23 Friday JMJ ( She Digs It ) Contractor relocated the fire hydrant that was installed by Rodriguez Construction in a recent construction phase. Contractor installed 6"X6" Tee and 6" gate valve all fitting mega lugged or anchored. Backing blocks poured behind 6"X6" Tee and anchor for hydrant.
In-wall Inspection Partial 5/11/2023 5/11/2023 05/11/2023
Misc
Corrective Action Required
05/11/2023
The following areas approved: Building E: 112, 121, 122
Above Ceiling Inspection Failed 5/24/2023 05/24/2023
Misc
Corrective Action Required
05/24/2023
Building E: -Secure all mc within 12" of boxes -Provide ceiling tie wires at opposite corners of all light fixtures -Support low voltage off of grid
Above Ceiling Inspection Partial 5/25/2023 5/25/2023 05/25/2023
Misc
Resolved
05/25/2023
Building E: -Secure all mc within 12" of boxes -Provide ceiling tie wires at opposite corners of all light fixtures -Support low voltage off of grid
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
05/25/2023
Building E complete
Occupancy Inspection - Codes Commercial Failed 5/26/2023 5/26/2023 05/26/2023
Misc
Informational
05/26/2023
Phase one: Building E- -Coaches offices E121, E122 and Locker room E112 OK to occupy
Pavement-Stabilized Subgrade Partial 6/7/2023 6/7/2023 06/07/2023
Misc
Informational
06/07/2023
06/0723 Wednesday JMJ (GC Je Dunn, Subcontractor Midwest Excavation ) Je Dunn called me know that contractor would need a proof roll but this week not that they had been work on parking again starting this week? I will attempt to gain all information of what has been done thus far. Contractor had left site when inspector went site for inspection.
In-wall Inspection Partial 6/13/2023 6/13/2023 06/13/2023
Misc
Corrective Action Required
05/11/2023
The following areas approved: Building E: 112, 121, 122 Building D: 103-install bonding screw and jumpers at all metallic boxes. OK for vapor barrier
In-wall Inspection Partial 6/15/2023 6/15/2023 06/15/2023
Misc
Corrective Action Required
06/13/2023
The following areas approved: Building E: 112, 121, 122 Building D: 103
Occupancy Inspection - Codes Commercial Failed 6/15/2023 6/15/2023 06/15/2023
Misc
Informational
05/26/2023
Phase one: Building E- -Coaches offices E121, E122, Locker room E112, E102 weight room OK to occupy
Pavement-Proof Roll Passed 6/20/2023 (10:00) 6/20/2023 06/20/2023
Misc
Informational
06/20/2023
6-20-23 BR Proof roll has pass and now ready for asphalt.
Pavement-Aggregate Base Partial 6/21/2023 6/21/2023 06/21/2023
Misc
Informational
06/21/2023
06/21/23 Wednesday JMJ (Musselman & Hall Contractors) Contractor laying base asphalt type 1-01 RC approximately 305tons.Contractor working through lunch time.
Pavement-Aggregate Base Partial 6/22/2023 6/22/2023 06/22/2023
Misc
Informational
06/21/2023
06/21/23 Wednesday JMJ (Musselman & Hall Contractors) Contractor laying base asphalt type 1-01 RC. Contractor working through lunch time. 06/22/23 Thursday JMJ (Musselman & Hall Contractors) Contractor continue installation of base asphalt near the entrance side near SE Browning Ave LSHS Robotics parking lot. Also See PRCOM20210104 Pavement-Aggregate Base for all area asphalted.
Miscellaneous Inspection Partial 6/23/2023 6/23/2023 06/23/2023
Misc
Informational
01/12/2023
01/12/23 Thursday JMJ ( SDI ) Contractor is following a gas line ( that is in the path of sanitary main installation ) to verify if it is active.
Misc
Informational
06/23/2023
06/23/23 Friday JMJ (Musselman & Hall) Contractor is milling the parking lot to prepare for surface asphalt.
Driveway Inspection Partial 6/29/2023 6/29/2023 06/29/2023
Misc
Informational
06/29/2023
06/29/23 Thursday JMJ ( Epic Concrete ) Forms and materials passed pre-inspection for driveway approach @ Robotics LSHS and Building "B" Gym. Building "B" Gym driveway approach is connect with permit 20225301.
Driveway Inspection Partial 6/30/2023 6/30/2023 06/30/2023
Misc
Informational
06/29/2023
06/29/23 Thursday JMJ ( Epic Concrete ) Forms and materials passed pre-inspection for driveway approach @ Robotics LSHS and Building "B" Gym. Building "B" Gym driveway approach is connect with permit 20225301.
Misc
Informational
06/30/2023
06/30/23 Friday JMJ ( Epic Concrete ) Driveway was poured and marked for construction cuts, approach for building "B" Gym driveway will be formed and graded on Monday 07/03/23 (permit 20225301).
Pavement-Surface Partial 07/08/2023
Misc
Informational
07/08/2023
07/08/23 Saturday JMJ ( Mussel & Hall ) Contractor is planning to complete type 3 surface layer on the Robotics & Building "B" Gym parking lot and possibly the Student Drop-Off Drive Area @ the SW side Lee's Summit School. Contractor had to broom parking lot off due to the rains of last night to prepare for asphalt surface coat. CFS is on site to take density test of surface asphalt also see PRCOM20210104. Temperatures ranged from the low 70's to the mid 70's
Pavement-Surface Partial 07/08/2023
Misc
Informational
07/08/2023
07/08/23 Saturday JMJ ( Musselman & Hall ) Contractor is planning to complete type 3-01RC surface layer on the Robotics & Building "B" Gym parking lot and possibly the Student Drop-Off Drive Area @ the SW side Lee's Summit School. Contractor had to broom parking lot off due to the rains of last night to prepare for asphalt surface coat Temperature ranged from the low to the mid 70's. Contractor laid approximately 426 tons of type 3-01RC asphalt between the Robotics & Building "B" Gym parking locations. Inspector will check the near the entrance of Building "B" Gym parking lot to see if the is suitable for a base pavement on 07/10/23 Monday. Contractor will continue working in other locations that require pavement. Third party tester was CFS all areas passed, but rear parking and driveway area of Building "B" Gym were on the lower spectrum of passing.
Pavement-Surface Partial 07/08/2023
Misc
Informational
07/08/2023
07/08/23 Saturday JMJ ( Musselman & Hall ) (CFS-third party testing ) Contractor is planning to complete type 3-01RC surface layer on the Robotics & Building "B" Gym parking lot and possibly the Student Drop-Off Drive Area @ the SW side of Lee's Summit School. Contractor had to broom parking lot off due to the rains of last night to prepare for asphalt surface coat. Temperature ranged from the low to mid 70's. Approximately 426 ton of type 3-01RC asphalt was laid today @ the Robotics & Building "B" Gym parking lot. As-per CFS tester all areas passed, but the rear drive-lane and parking lot area was on the low spectrum of passing. Contractor was unable to complete laying asphalt for parking lot Building "B" Gym because of an area near the entrance was saturated and retaining a puddle of water. This area may have to be reestablish to finish paving the parking lot. Inspector will check area to determine if any additional measure will be required for base pavement to be laid. Contractor plans to moved to other areas on the project that require surface pavement, the first of next week.
Water Service Inspection Passed 7/11/2023 07/11/2023
Misc
Informational
07/11/2023
07/11/23 Tuesday JMJ (Questec) 3" water main install to the building completed from work done approximately 6 months ago. 3"gate valve to 2' of 3" pipe, 90 deg bend to 3.5' of 3" pipe, 90 deg bend to approximately 10' of 3" pipe (4' outside & 6' inside). A 90 deg bend turn to the inside 3" butter fly valve and flange on the end. All work appears to be acceptable.
Storm Sewer Construction Inspection Partial 7/11/2023 7/11/2023 07/11/2023
Misc
Informational
01/16/2023
01/10/23 Tuesday ( SDI ) Contractor installed storm box A1 and poured collar & inverts. Excavation was backfilled. 01/16/23 Monday ( SDI ) Contractor poured invert and collars on storm box.
Misc
Informational
07/11/2023
07/11/23 Tuesday (Rodriguez-Kevin) Contractor continued the installation of storm drains F5 nyloplastic and F7 area drain were installed Southeast of LSHS.
Sanitary Sewer Construction Inspection Partial 7/11/2023 7/11/2023 07/11/2023
Misc
Informational
01/17/2023
12/27/22 Tuesday ( She Digs It SDI ) Contractor installing MH A1 @STA 3+23.74 4’ sanitary sewer doghouse manhole see detail , C790-C. 01/12/23 Thursday ( SDI ) Contract removing abandoned gas main so they can continued the installation of 8” sanitary main. 01/16/23 Monday ( SDI ) Contractor was able to install MH A3@STA 6+34.92 sanitary running newly installed sanitary line. Contractor connected to the existing main with a max adapter also began to install approximately 63’ sewer service line see C700-C. Contractor poured floor of Dog House sanitary as-per project details. 01/17/23 Tuesday JMJ ( SDI ) Contractor installed approximately 53’ of lateral coming form MH A3 & 32’ of the lateral before MH A3. Contractor backfilled excavation.
Misc
Informational
07/11/2023
07/11/23 Tuesday JMJ (Rodriguez- Kevin) contractor installed 3" riser to sanitary to raise to the required elevation for the surface layer that will be installed next week (Bus & Student drop-off area).
Sidewalk Inspection Partial 7/11/2023 7/11/2023 07/11/2023
Misc
Informational
07/11/2023
07/11/23 Tuesday JMJ (Epic Concrete) Contractor poured approximately 30yd of KCMMB GR 4K S from Fordyce. All appears to be in accordance with specification (Southwest area Bus & Student drop-off area).
Underslab Plumbing Inspection - Commercial Passed 7/13/2023 7/13/2023 07/13/2023
Misc
Resolved
07/13/2023
-Sanitary tie in to existing building ok
Pavement-Proof Roll Partial 7/14/2023 7/14/2023 07/14/2023
Misc
Informational
07/14/2023
07/14/23 Friday JMJ (Mid-States Excavating, Inc.) Proof roll of the stabilize subgrade passed .
Pavement-Proof Roll Passed 7/20/2023 07/20/2023
Misc
Informational
07/14/2023
07/14/23 Friday JMJ (Mid-States Excavating, Inc.) Proof roll of the stabilize subgrade passed . 07/20/23 Thursday proof roll passed.
Pavement-Aggregate Base Partial 7/20/2023 7/20/2023 07/20/2023
Misc
Informational
06/22/2023
06/21/23 Wednesday JMJ (Musselman & Hall Contractors) Contractor laying base asphalt type 1-01 RC. Contractor working through lunch time. 06/22/23 Thursday JMJ (Musselman & Hall Contractors) Contractor continue installation of base asphalt near the entrance side near SE Browning Ave LSHS Robotics parking lot. Also See PRCOM20210104 Pavement-Aggregate Base for all area asphalted. 07/20/23 Thursday JMJ ( Hanrahan Asphalt-Dakota ) Contractor is asphalting type 2 recycle at the South end of the Robotics that connected to Gym Building "B" parking lot.
Pavement-Surface Partial 7/20/2023 7/20/2023 07/20/2023
Misc
Informational
07/08/2023
07/08/23 Saturday JMJ ( Musselman & Hall ) (CFS-third party testing ) Contractor is planning to complete type 3-01RC surface layer on the Robotics & Building "B" Gym parking lot and possibly the Student Drop-Off Drive Area @ the SW side of Lee's Summit School. Contractor had to broom parking lot off due to the rains of last night to prepare for asphalt surface coat. Temperature ranged from the low to mid 70's. Approximately 426 ton of type 3-01RC asphalt was laid today @ the Robotics & Building "B" Gym parking lot. As-per CFS tester all areas passed, but the rear drive-lane and parking lot area was on the low spectrum of passing. Contractor was unable to complete laying asphalt for parking lot Building "B" Gym because of an area near the entrance was saturated and retaining a puddle of water. This area may have to be reestablish to finish paving the parking lot. Inspector will check area to determine if any additional measure will be required for base pavement to be laid. Contractor plans to moved to other areas on the project that require surface pavement, the first of next week. 07/20/23 Thursday JMJ ( Hanrahan Asphalt- Dakota ) Contractor finishing the asphalting for ( Musselman & Hall ) approximately 50'X50' area Southside of Robotic building. Two lifts of type 3-01RC asphalt mix.
Occupancy Inspection - Codes Commercial Failed 7/28/2023 7/28/2023 07/28/2023
Misc
Informational
06/15/2023
Phase one: Building E- -Coaches offices E121, E122, Locker room E112, E102, E111 weight room OK to occupy
Occupancy Inspection - Engineering Temporary C of O 8/11/2023 8/11/2023 08/10/2023
Misc
Informational
08/10/2023
1. Pavement mill along NW Browning Street where excavation occurred during the construction of project 2 Vegetation in small environmental detention area North of parking lot off NW Browning Street.
Occupancy Inspection - Codes Commercial Failed 8/11/2023 8/11/2023 08/11/2023
Misc
Informational
07/28/2023
Phase one: Building E Complete **OK to bring in and set up equipment
Occupancy Inspection - Engineering Temporary C of O 8/21/2023 8/21/2023 08/21/2023
Misc
Informational
08/10/2023
1. Pavement mill along NW Browning Street where excavation occurred during the construction of project 2 Vegetation in small environmental detention area North of parking lot off NW Browning Street.
Occupancy Inspection - Codes Commercial Failed 8/21/2023 8/21/2023 08/21/2023
Misc
Informational
08/11/2023
Phase one: Building E Complete **OK to bring in and set up equipment
Occupancy Inspection - Water Utilities Passed 6/15/2023 6/15/2023 08/21/2023
Occupancy Inspection - Planning Passed 8/11/2023 8/21/2023 08/21/2023
Occupancy Inspection - Codes Commercial Ready for Temp CO 8/23/2023 08/23/2023
Misc
Corrective Action Required
08/23/2023
Complete corrections for all other departments -Paint exterior metallic gas piping with corrosion resistant paint -Install permanent electrical panels in building E
Occupancy Inspection - Fire Passed 8/21/2023 8/21/2023 08/24/2023
Occupancy Inspection - Codes Commercial Ready for Temp CO 09/20/2023
Misc
Corrective Action Required
08/23/2023
Complete corrections for all other departments -Paint exterior metallic gas piping with corrosion resistant paint -Install permanent electrical panels in building E
Occupancy Inspection - Engineering Passed 9/21/2023 01/26/2024
Misc
Resolved
01/26/2024
1. Pavement mill along NW Browning Street where excavation occurred during the construction of project 2 Vegetation in small environmental detention area North of parking lot off NW Browning Street.
Misc
Resolved
01/26/2024
Needed for Final Occupancy 1. Vegetation in the detention basin area. Check back in 30 days.
Occupancy Inspection - Codes Commercial Full C of O 1/26/2024 01/26/2024
Misc
Resolved
01/26/2024
Complete corrections for all other departments -Install permanent electrical panels in building D
Documents & Images
Date Uploaded File Type Document Name
10/21/2022 Application Form Commercial Permit Application_LSHS_Signed
10/21/2022 Plans 220909_LSHS Bid Set_REDUX
10/21/2022 Specifications LSR7 Robotics & GiC Project Manual - VOLUME 1 OF 3
10/21/2022 Specifications LSR7 Robotics & GiC Project Manual - VOLUME 2 OF 3
10/21/2022 Specifications LSR7 Robotics & GiC Project Manual - VOLUME 3 OF 3
11/01/2022 Letter Fire Building Plan Review
11/04/2022 Letter DS P/R Corrections Document
11/11/2022 Engineer Report/Study 22-5546 Lee's Summit High School Robotics Additions-Geotech
11/11/2022 Plans 220909_LSHS Permit Set
11/11/2022 Letter Lee's Summit HS Permit Responses
11/11/2022 Letter LSR7 Robotics - ASI 001-ISS 003 - LSHS Narrative
11/15/2022 Letter Fire Building Plan Review
11/18/2022 Letter License Tax Bill
11/23/2022 Letter 22_1123_Lee Summit HS Permit Comments
11/23/2022 Approved Plans APPROVED LSHS ROBOTICS ADDITION
12/09/2022 Receipt Receipt for transaction: 2022-009393
12/09/2022 Letter DS Building Permit

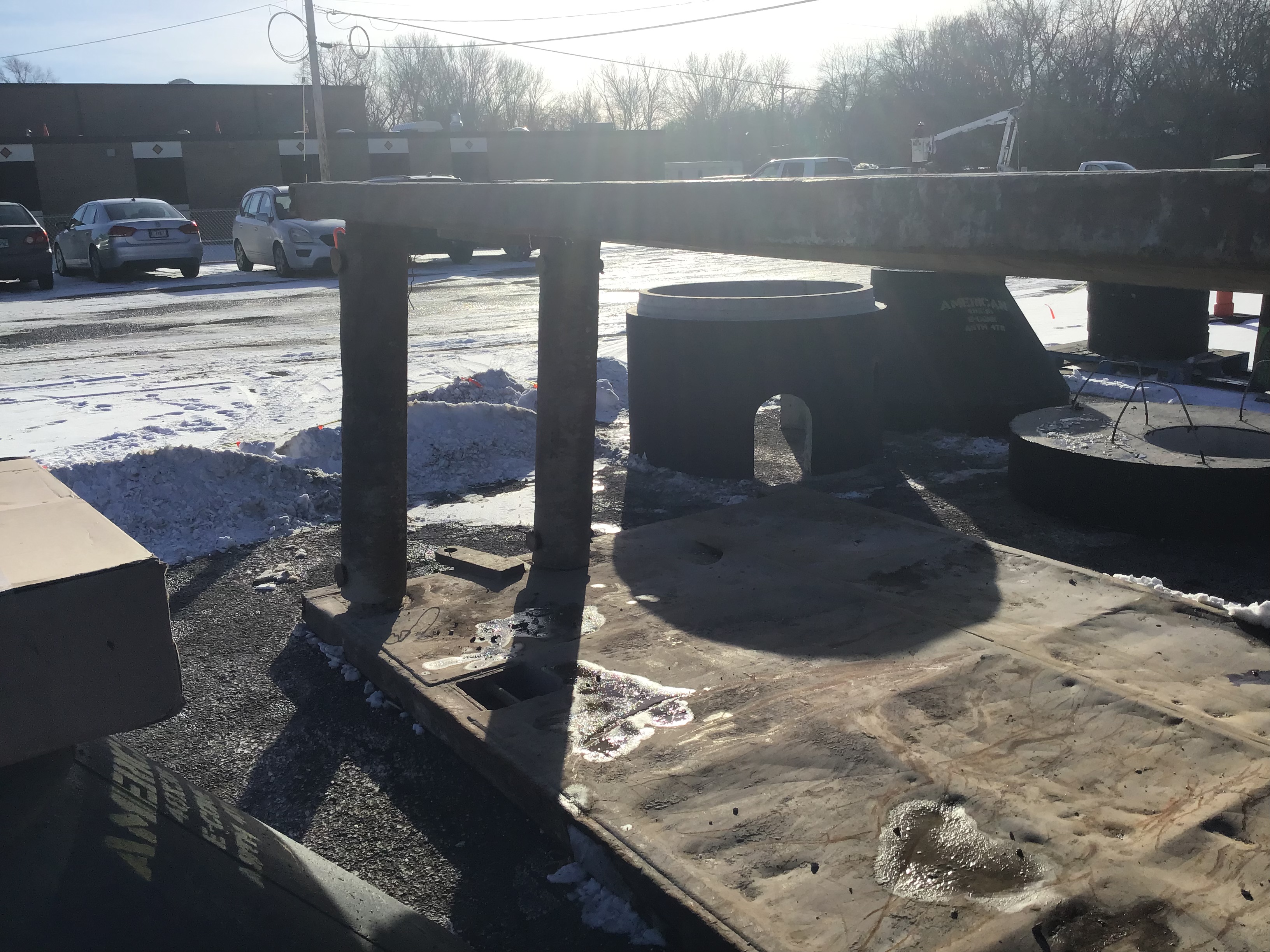

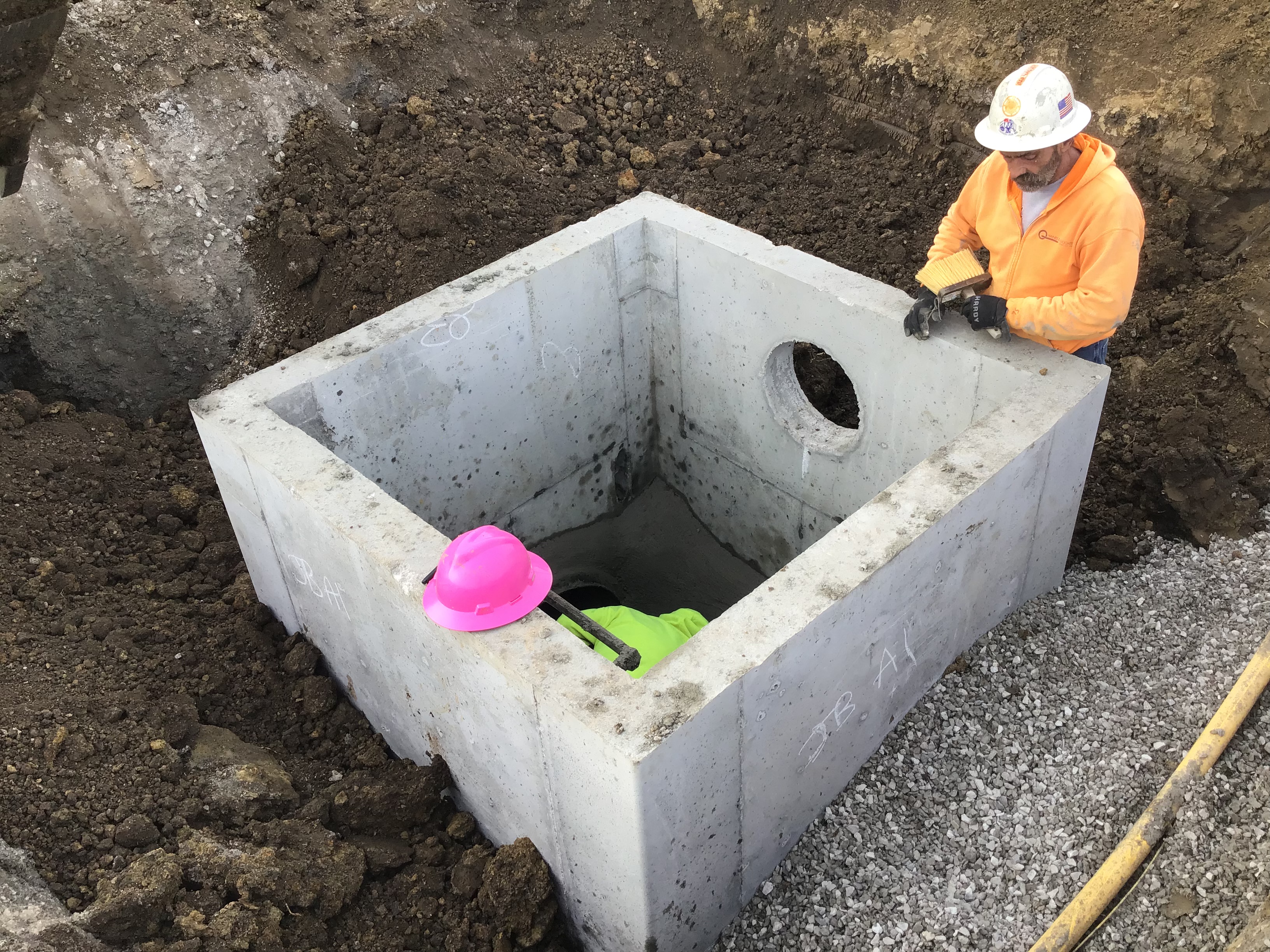

12/27/2022 Doghouse MH A1 & Shoring Cubicle
12/27/2022 8” Sanitary Main Connecting into Existing
12/27/2022 Letter INSPECTION SUMMARY
12/28/2022 Letter INSPECTION SUMMARY
12/30/2022 Letter INSPECTION SUMMARY
01/04/2023 MH A2
01/04/2023 Existing Service Lines
01/05/2023 8” Sanitary and 8”X6”Tee to 6” DIP Sanitary

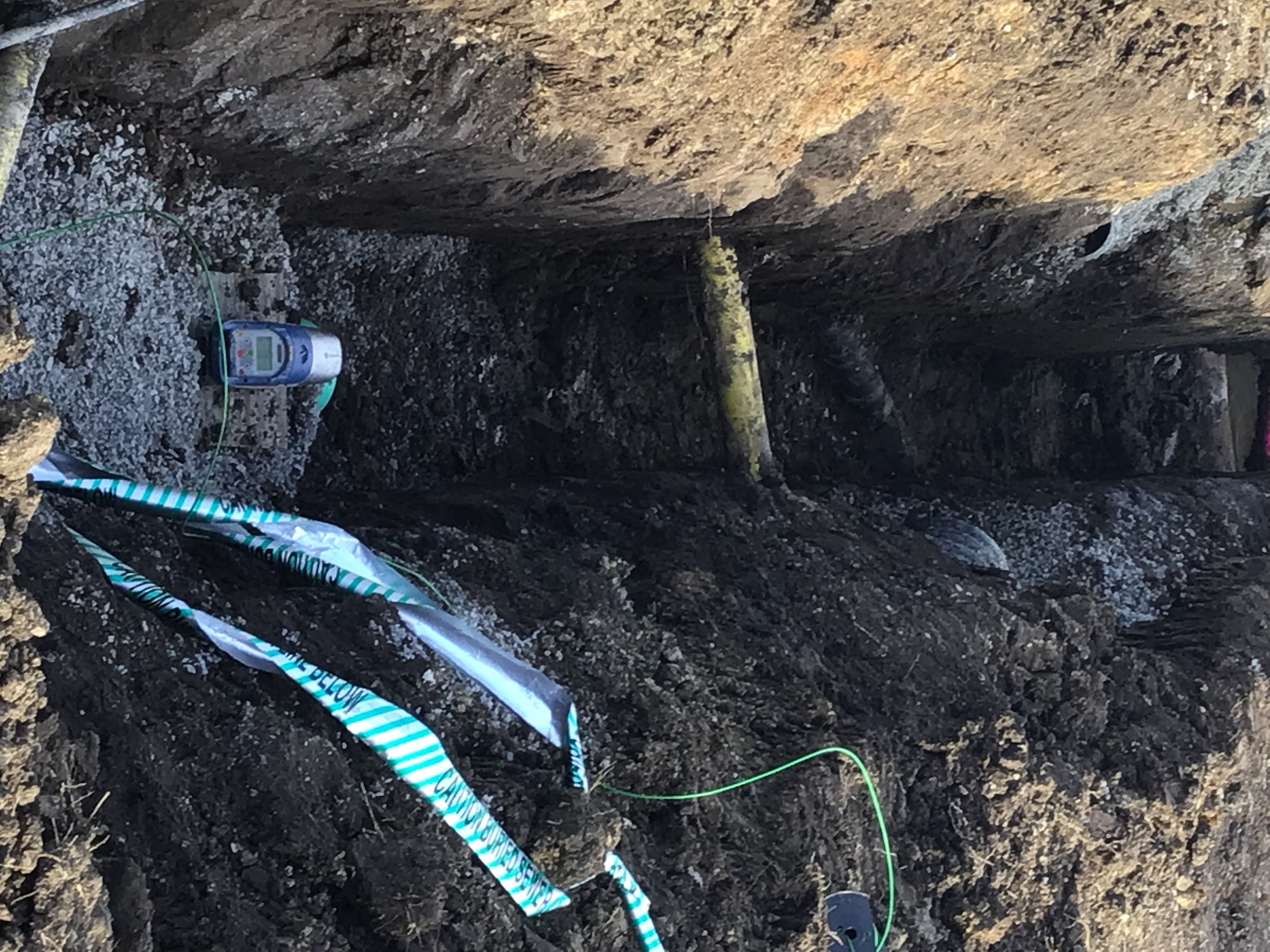

01/09/2023 8” Sanitary and Existing Gas Main @ Same Elevation
01/09/2023 Letter Fire Building Plan Review

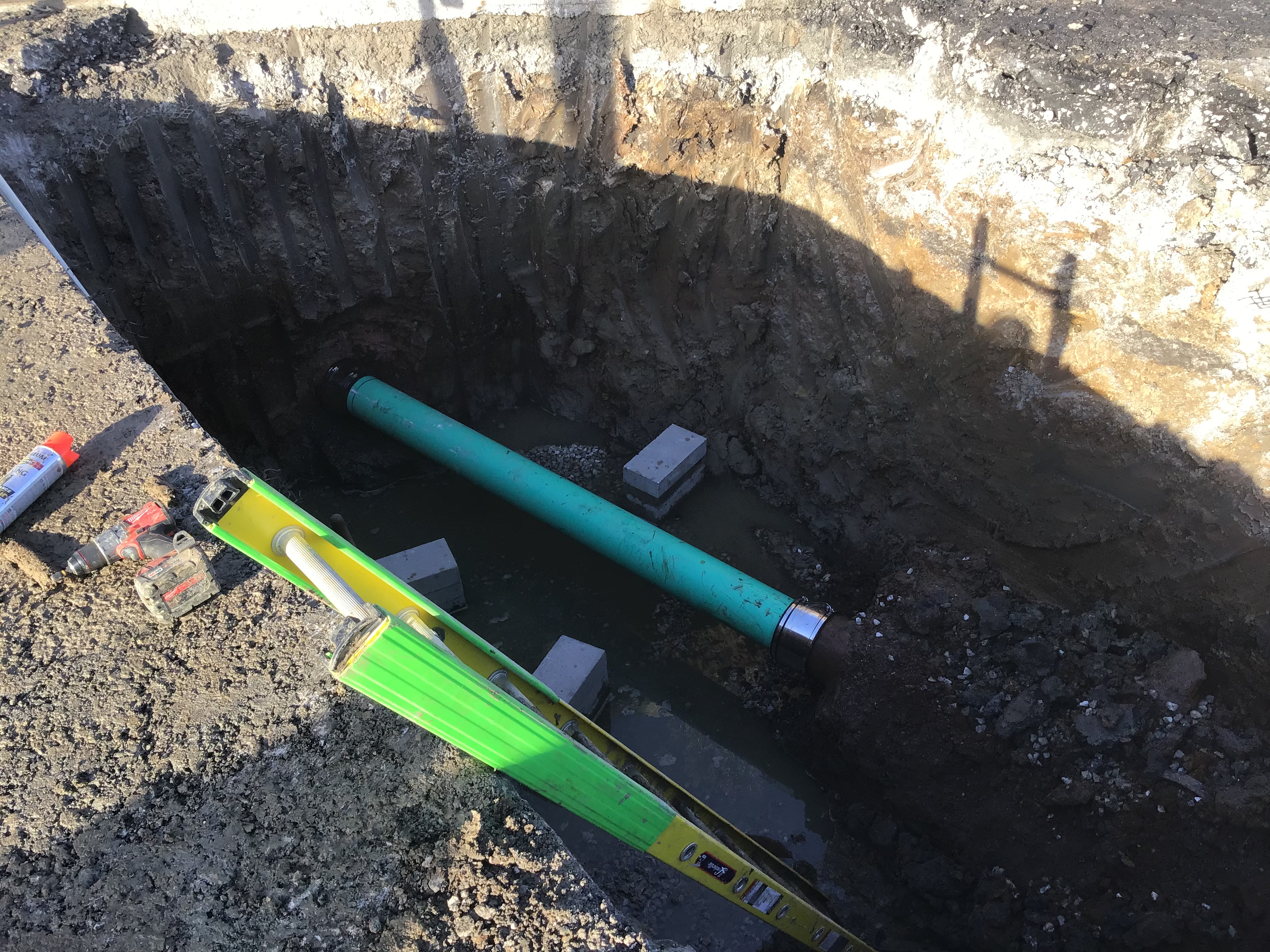

01/10/2023 Storm Box A1
01/10/2023 Letter INSPECTION SUMMARY
01/11/2023 10” Storm Line & A2
01/12/2023 Letter INSPECTION SUMMARY
01/12/2023 Letter INSPECTION SUMMARY
01/12/2023 Removal Abandoned Gas Main to clear path for 8” Sanitary
01/12/2023 Letter INSPECTION SUMMARY
01/16/2023 Letter INSPECTION SUMMARY
01/16/2023 A3
01/16/2023 MH A3
01/16/2023 Letter INSPECTION SUMMARY
01/16/2023 Letter INSPECTION SUMMARY
01/16/2023 Letter INSPECTION SUMMARY
01/17/2023 Letter INSPECTION SUMMARY
01/18/2023 Letter INSPECTION SUMMARY
01/20/2023 Letter INSPECTION SUMMARY
01/20/2023 4”X4” Tee

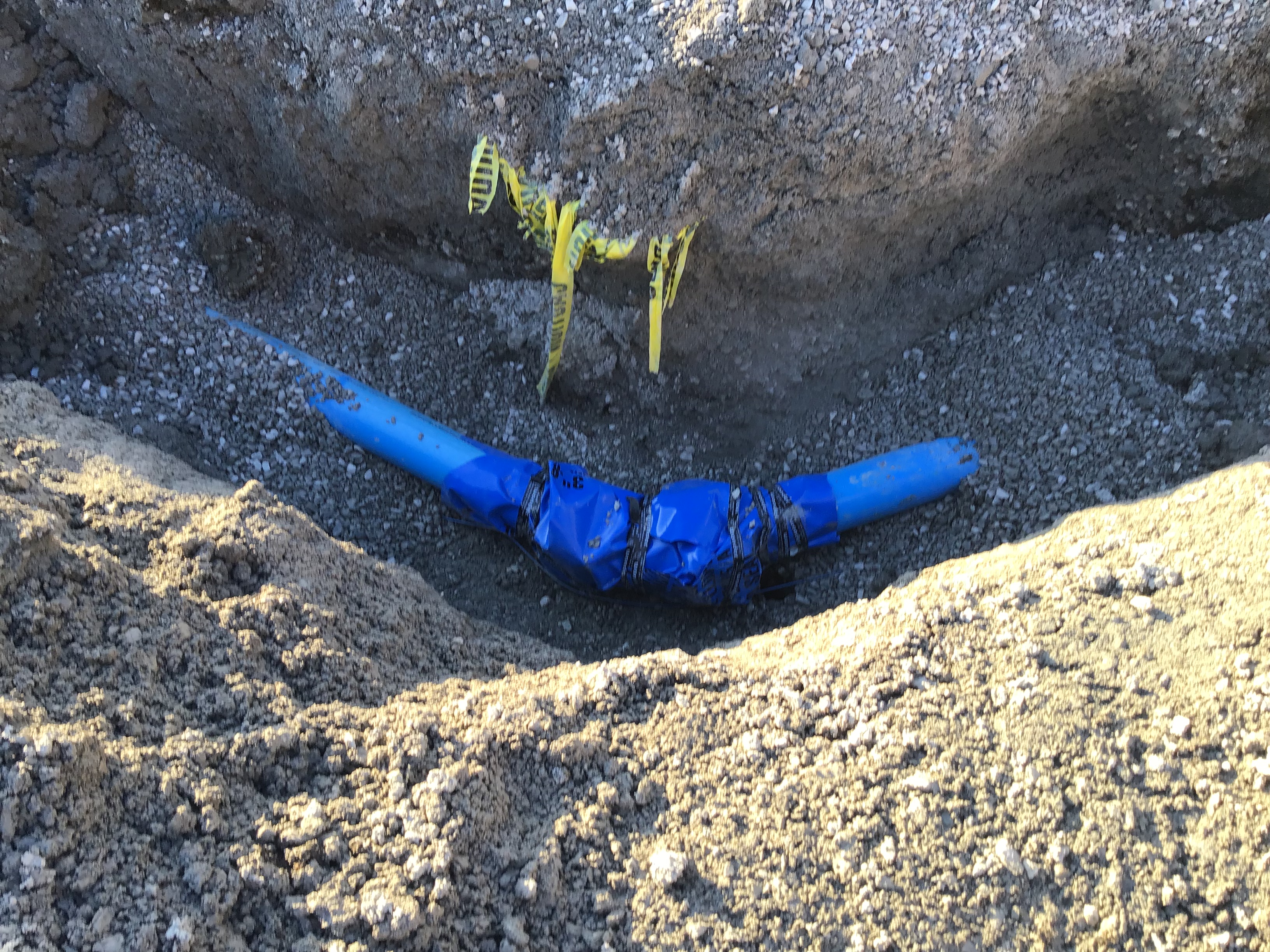

01/20/2023 45 Deg Bend
01/20/2023 Letter INSPECTION SUMMARY
01/23/2023 Letter INSPECTION SUMMARY
01/23/2023 Letter INSPECTION SUMMARY

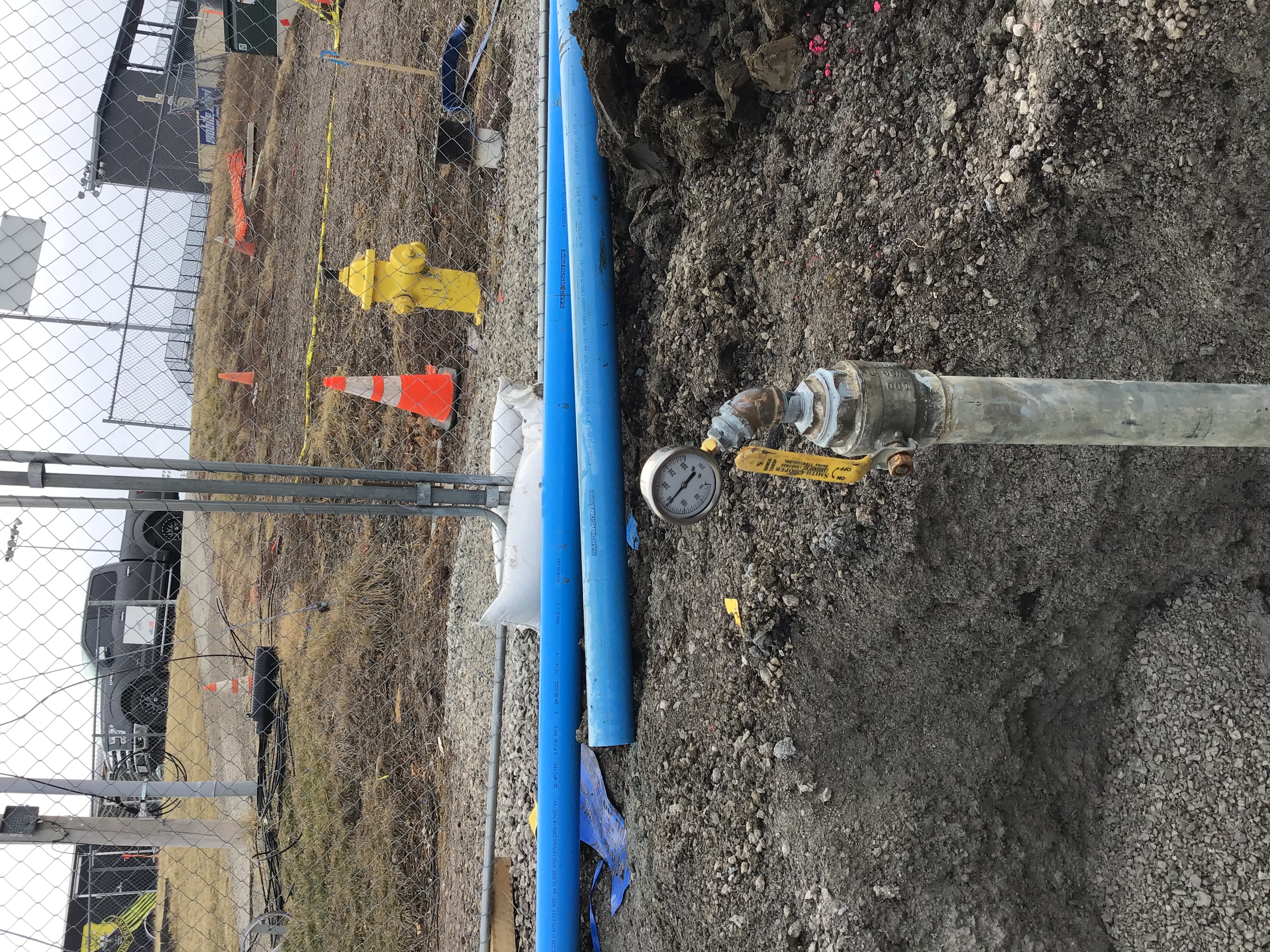

01/24/2023 Gauge Reading 150psi
01/24/2023 Letter INSPECTION SUMMARY
01/24/2023 Letter INSPECTION SUMMARY
01/24/2023 Letter INSPECTION SUMMARY
01/24/2023 Letter INSPECTION SUMMARY
01/25/2023 Letter INSPECTION SUMMARY
01/26/2023 Letter INSPECTION SUMMARY
01/30/2023 Letter INSPECTION SUMMARY
01/30/2023 Letter INSPECTION SUMMARY
02/03/2023 1st Location LSR7 Robotics Tie-In
02/03/2023 2nd Location LSR7 Tie-in
02/03/2023 Letter INSPECTION SUMMARY
02/03/2023 Letter INSPECTION SUMMARY
03/03/2023 Letter INSPECTION SUMMARY
03/17/2023 Hydrant Relocation
03/17/2023 Concrete Ticket for Hydrant Relocation
03/17/2023 Letter INSPECTION SUMMARY
05/11/2023 Letter INSPECTION SUMMARY
05/24/2023 Letter INSPECTION SUMMARY
05/25/2023 Letter INSPECTION SUMMARY
05/26/2023 Letter INSPECTION SUMMARY
05/31/2023 23030927 Lees Summit HS Robotics Bldg-FA-set sealed
06/07/2023 LSH Robotics Parking Lot #1 060723
06/07/2023 LSH Robotics Parking Lot # 2
06/07/2023 Letter INSPECTION SUMMARY
06/13/2023 Letter INSPECTION SUMMARY
06/15/2023 Letter INSPECTION SUMMARY
06/15/2023 Letter INSPECTION SUMMARY
06/20/2023 Letter INSPECTION SUMMARY
06/21/2023 Letter INSPECTION SUMMARY
06/21/2023 Letter INSPECTION SUMMARY
06/22/2023 Letter INSPECTION SUMMARY
06/23/2023 Letter INSPECTION SUMMARY
06/29/2023 Letter INSPECTION SUMMARY
06/30/2023 Letter INSPECTION SUMMARY
07/08/2023 Letter INSPECTION SUMMARY
07/08/2023 Letter INSPECTION SUMMARY
07/08/2023 Letter INSPECTION SUMMARY
07/08/2023 Fwd Asphalt Tickets (First Last ) Robotic Building B Gym Parking Lot
07/08/2023 Letter INSPECTION SUMMARY
07/11/2023 Letter INSPECTION SUMMARY
07/11/2023 Letter INSPECTION SUMMARY
07/11/2023 Letter INSPECTION SUMMARY
07/11/2023 Letter INSPECTION SUMMARY
07/11/2023 Letter INSPECTION SUMMARY
07/11/2023 Letter INSPECTION SUMMARY
07/13/2023 Letter INSPECTION SUMMARY
07/14/2023 Letter INSPECTION SUMMARY
07/20/2023 Letter INSPECTION SUMMARY
07/20/2023 Letter INSPECTION SUMMARY
07/20/2023 Letter INSPECTION SUMMARY
07/28/2023 Letter INSPECTION SUMMARY
08/02/2023 Plans 23030927 Lees Summit HS Robotics Bldg-FA-set sealed
08/02/2023 Letter Fire (Alarm) Plan Review Notice
08/02/2023 23030927 Lees Summit HS Robotics Bldg-FA-set sealed0 APPROVED
08/04/2023 3RD Party Insp Report SI Final Letter LSHS
08/10/2023 Letter INSPECTION SUMMARY
08/11/2023 Letter INSPECTION SUMMARY
08/21/2023 Letter INSPECTION SUMMARY
08/21/2023 Letter INSPECTION SUMMARY
08/21/2023 Letter INSPECTION SUMMARY
08/21/2023 Receipt Receipt for transaction:2023-006475
08/23/2023 Certificate/License Codes Temporary Certificate of Occupancy
08/23/2023 Receipt Receipt for transaction:2023-006546
09/20/2023 LSHS TCOExtension Request Form
09/20/2023 Certificate/License Codes Temporary Certificate of Occupancy
09/20/2023 Receipt Receipt for transaction:2023-007206
01/26/2024 Letter INSPECTION SUMMARY
01/26/2024 Letter Codes Final Certificate of Occupancy
01/26/2024 Letter Field Certificate of Occupancy
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
