Permit Application Status

PRCOM20172513


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary
PRCOM20172513
Building Permit - Commercial
Certificate of Occupancy
PARROT PROPERTIES INC
NEW MULTI-FAMILY
BUILDING #6 NEW 2 STORY APARTMENT BUILDING FOUNDATION PERMIT - PRCOM20181901
07/24/2017
01/07/2019
04/22/2020
Locations
Contacts
CITYSCAPE CONSTRUCTION VIEW HIGH LLC, Address:10 W CARMEL DR STE 200, Phone:(317) 574-1600 Ext:100
STANDARD HEATING & COOLING TOO LLC, Address:2006 E PRAIRIE CIRCLE , Phone:(913) 782-5409
STANDARD ELECTRIC TOO LLC, Address:2006 E PRAIRIE CIRCLE, Phone:(913) 782-5409
GARRISON PLUMBING, Address:15430 S MAHAFFIE ST STE 102, Phone:(913) 768-1311
SGN+A ARCHITECTS, Address:315 W PONCE DE LEON AVE #755, Phone:(404) 373-7370
LATIMER SOMMERS & ASSOCIATES PA, Address:3639 SW SUMMERFIELD DR STE A, Phone:(785) 233-3232
PARROT PROPERTIES INC, Address:11303 VIEW HIGH DR
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 07/25/2018 06/19/2018
Joe Frogge
Final Development Plan Review Approved 08/07/2018 02/16/2018
Joe Frogge
Building Plan Review Approved 08/07/2018 02/16/2018
Joe Frogge
Special Inspections Review Approved 08/24/2017
Joe Frogge
Fees
Paid Fees Amount Paid Owing Date Paid
Valuation Fee for New Multi-Family $6,564.16 $6,564.16 Paid 01/07/2019
8331507-Sewer Connection Fee $3,000.00 $3,000.00 Paid 01/07/2019
Not Ready Inspection Fee $50.00 $50.00 Paid Not payable online 12/06/2019
Outstanding Fees Amount Paid Owing Date Paid
Not Ready Inspection Fee $50.00 $0.00 $50.00 Not Paid


$50.00    Add Fees to My Cart
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Footing Inspection - Commercial Partial 3/20/2019 3/20/2019 03/20/2019
Misc
Partial Correction
03/20/2019
SOUTH, EAST AND WEST SECTIONS APPROVED
Underslab Plumbing Inspection - Commercial Partial 4/11/2019 4/11/2019 04/11/2019
Misc
Corrective Action Required
04/11/2019
partial - lower south east end
Sewer Service Inspection Passed 4/12/2019 4/12/2019 04/12/2019
Underslab Plumbing Inspection - Commercial Partial 4/19/2019 04/19/2019
Rated Assembly Inspection Failed 7/24/2019 7/24/2019 07/24/2019
SECOND FLOOR
Corrective Action Required
07/24/2019
Prerock failed nail pattern and backing for rock
FIRST FLOOR
Corrective Action Required
07/24/2019
Failed- nail pattern and screw pattern
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
07/24/2019
Rated Assembly Inspection Failed 7/30/2019 7/30/2019 07/30/2019
Misc
Corrective Action Required
07/30/2019
incomplete- fire coillars not installed correctly. holes in pre-rock, nail pattern incomplete . fix all issues and reschedule
All Rough Inspection - Commercial Failed 7/30/2019 7/30/2019 07/30/2019
Misc
Corrective Action Required
07/30/2019
Support NM cable, serivce entrance cable per code, 4.5ft o.c. throughout. *Secure NM within 8" of boxes. *Check bundling code for electrcial above house panel. *220 electcial hanging from ceiling at furnace box out in corridor. *Garage #7 rock top of plumbing chase. *106- strap top plates cut for sprinkler. *Fire caulk at all DBL wall areas between floor levels. -Draft stop penetrations 1000 sq ft. *108- pre rock nail pattern *Strap plates top plates at LVL kitchen wall all units alike. *208 fire collars incomplete. *207-plumbing protection plates at kitchen sink Strap all DWV mid story throughout. *support flex duct i attic with 2" material. *3000 sq ft draft stip atic. *102- nail plates at bathrooms in corners ( check all units) *garage #2 from east rock DWV chase. *Garage #3 box out plumbing and rock chase. *Garagae 4-5 support DWV 48" o.c. *support SE cables. *#6 garage DWV into floor ceiling no fire collar. **no rock furnace room box out 2nd floor east corridor. *202 strap dwv mid story **201-same **203-no dryer boxes inwalls. fix back to back puddy pads. See rated assemebly on dryer boxes, dead spaces, fire collars. these items are incomplete and or installed incorrectly. Dryer boxes are not 5 sided- units missing dryer boxes. do not cover. *
All Rough Inspection - Commercial Failed 8/6/2019 8/6/2019 08/06/2019
Misc
Corrective Action Required
07/30/2019
*Check bundling code for electrcial above house panel. *220 electcial hanging from ceiling at furnace box out in corridor. *Garage #7 rock top of plumbing chase. *106- strap top plates cut for sprinkler. NOT SEALED AT TOP PLATE *Fire caulk at all DBL wall areas between floor levels NOT COMPLETE. -Draft stop penetrations 1000 sq ft. *108- pre rock nail pattern INCOMPLETE *Strap plates top plates at LVL kitchen wall all units alike.INCOMPLETE *208 fire collars incomplete. *207- Strap all DWV mid story throughout. *support flex duct i attic with 2" material. COMMON AREAS:*3000 sq ft draft stip atic. *garage #2 from east rock DWV chase. *Garage #3 box out plumbing and rock chase. *#6 garage DWV into floor ceiling no fire collar. **no rock furnace room box out 2nd floor east corridor. *202 strap dwv mid story **201-no dryer boxes inwalls. **203-no dryer boxes inwalls. See rated assemebly on dryer boxes, dead spaces, fire collars. these items are incomplete and or installed incorrectly. Dryer boxes are not 5 sided- units missing dryer boxes. do not cover. *PREROCKROOMS201,203,205,207.OK(EXECPT DRYER BOX 201,203).
All Rough Inspection - Commercial Failed 8/26/2019 8/26/2019 08/26/2019
Misc
Corrective Action Required
08/06/2019
*Garage #7 rock top of plumbing chase open gaps ,5 from the west. *106- strap top plates cut for sprinkler. NOT SEALED AT TOP PLATE -Draft stop penetrations 1000 sq ft. *108- pre rock nail pattern INCOMPLETE collar cut in half, hole on lower rock between hallways. 206 collar cut in 1/2. *207-dryer boxes in corridor walls 205,207.. *support flex duct i attic with 2" material room 207 main duct in great room. COMMON AREAS:*3000 sq ft draft stip atic. **no rock furnace room box out 2nd floor east corridor. HEAT DUCT REMOVED LYING ON THE FLOOR. **201-no dryer boxes inwalls. INCOMPLETE **203-no dryer boxes in wallsINCOMPLETE *PREROCKROOMS201,203,205,207.OK(EXECPT DRYER BOX 201,203)
All Rough Inspection - Commercial Passed 9/6/2019 9/6/2019 09/06/2019
Misc
Resolved
09/06/2019
*Garage #7 rock top of plumbing chase open gaps ,5 from the west. *106- strap top plates cut for sprinkler. NOT SEALED AT TOP PLATE -Draft stop penetrations 1000 sq ft. *108- pre rock nail pattern INCOMPLETE collar cut in half, hole on lower rock between hallways. 206 collar cut in 1/2. *207-dryer boxes in corridor walls 205,207.. *support flex duct i attic with 2" material room 207 main duct in great room. COMMON AREAS:*3000 sq ft draft stip atic. **no rock furnace room box out 2nd floor east corridor. HEAT DUCT REMOVED LYING ON THE FLOOR. **201-no dryer boxes inwalls. INCOMPLETE **203-no dryer boxes in wallsINCOMPLETE *PREROCKROOMS201,203,205,207.OK(EXECPT DRYER BOX 201,203)
Rated Assembly Inspection Failed 9/13/2019 9/13/2019 09/13/2019
Misc
Corrective Action Required
07/30/2019
incomplete- fire coillars not installed correctly. holes in pre-rock, nail pattern incomplete . fix all issues and reschedule
Miscellaneous Correction
Corrective Action Required
09/13/2019
** Ridged channel was over spaced ** 12” o.c. Max
Rated Assembly Inspection Not Ready 9/16/2019 9/16/2019 09/16/2019
Misc
Corrective Action Required
09/13/2019
incomplete- fire coillars not installed correctly. holes in pre-rock, nail pattern incomplete . fix all issues and reschedule
Miscellaneous Correction
Corrective Action Required
09/13/2019
** Ridged channel was over spaced ** 12” o.c. Max
Rated Assembly Inspection Partial 10/4/2019 10/7/2019 10/07/2019
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
09/16/2019
RC- throughout approved. Nail pattern all units approved.
Miscellaneous Correction
Resolved
10/07/2019
** Ridged channel was over spaced ** 12” o.c. Max
Rated Assembly Inspection Failed 10/23/2019 10/23/2019
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
10/07/2019
RC- throughout approved. Nail pattern all units approved.
Misc
Corrective Action Required
10/23/2019
Failed- see red marks in west corridor 1st & 2nd floor. Screw pattern , screws to close to edge of rock, screw pattern over 16” O>C> on studs. Screw pattern anywhere from 10” to 14”. Remove sheetrock on HVAC in corridor for inspection of firewall. 2nd floors Recall when ready.
Rated Assembly Inspection Passed 11/4/2019 11/4/2019 11/04/2019
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
10/23/2019
RC- throughout approved. units and corridors ok
Misc
Resolved
11/04/2019
Failed- see red marks in west corridor 1st & 2nd floor. Screw pattern , screws to close to edge of rock, screw pattern over 16” O>C> on studs. Screw pattern anywhere from 10” to 14”. Remove sheetrock on HVAC in corridor for inspection of firewall. Recall when ready.
Electrical Service Inspection Passed 1/8/2020 1/8/2020 01/08/2020
Sprinkler - Hydrostatic Test Passed 02/21/2020
Alarm Test Not Ready 3/20/2020 03/20/2020
Sprinkler - Flow Test Not Ready 3/20/2020 03/20/2020
Alarm Test Failed 3/23/2020 03/23/2020
Sprinkler - Flow Test Passed 3/23/2020 03/23/2020
Alarm Test Passed 3/26/2020 03/26/2020
Miscellaneous Inspection Partial 4/6/2020 04/06/2020
Misc
Resolved
04/08/2020
Occupancy Inspection - Fire Passed 4/2/2020 4/8/2020 04/08/2020
Miscellaneous Inspection Passed 4/8/2020 04/08/2020
Occupancy Inspection - Codes Commercial Failed 4/2/2020 4/8/2020 04/08/2020
Misc
Corrective Action Required
04/08/2020
- G6-12 SELF CLOSING DOOR - - G6-8 REPAIR CEILING - - G6-9 HANDRAIL - - G6-6 COMPLETE FURR OUT - - G6-1 SELF CLOSING DOOR - - 201 ANTI TIP DEVICE RANGE - - FIRE ALARM PANEL ROOM FIRE CAULKING - - EAST END GFCI AT EXTERIOR HVAC NO POWER - - EAST END INSTALL A/C CONDENSORS - - PROVIDE TAMPER PROOF CAPS ALL A/C CONDENSORS - - COMPLETE WIRING & LABEL ALL A/C DISCONNECTS - - FIRE CAULK PLUMBING PENETRATIONS AT ALL WATER HEATERS -
Water Service Inspection Passed 4/1/2020 04/15/2020
Occupancy Inspection - Engineering Passed 4/15/2020 04/15/2020
Occupancy Inspection - Codes Commercial Failed 4/15/2020 4/15/2020 04/15/2020
Misc
Corrective Action Required
04/08/2020
- PROVIDE TAMPER PROOF CAPS ALL A/C CONDENSORS - OK FOR TCO WHEN PARKING ISSUES RESOLVED- Michael Harkins 04/15/2020 1:50 PM
Occupancy Inspection - Planning Temporary C of O 4/15/2020 04/17/2020
Rough Electrical Inspection - Commercial Passed 4/20/2020 04/20/2020
Rough Mechanical Inspection - Commercial Passed 4/20/2020 04/20/2020
Rough Plumbing Inspection - Commercial Passed 4/20/2020 04/20/2020
Underslab Plumbing Inspection - Commercial Passed 4/20/2020 04/20/2020
Final Mechanical Inspection Passed 4/20/2020 04/20/2020
Final Plumbing Inspection - Commercial Passed 4/20/2020 04/20/2020
Final Electrical Inspection - Commercial Passed 4/20/2020 04/20/2020
Piers/Caissons Inspection - Commercial Passed 4/17/2020 (8:00) 4/17/2020 04/21/2020
Misc
Informational
04/17/2020
- 1 LIGHT POLE BASE, DRIVEN GROUND ROD IN PLACE, NORTH END OF BLDG -
Occupancy Inspection - Codes Commercial Full C of O 04/22/2020
Misc
Resolved
04/22/2020
- OK FOR TCO WHEN PARKING ISSUES RESOLVED- Michael Harkins 04/15/2020 1:50 PM
Occupancy Inspection - Planning Passed 04/24/2020
Documents & Images
Date Uploaded File Type Document Name
10/16/2017 Meridian Site Map
01/07/2019 Letter Codes Building Permit
01/07/2019 Receipt Receipt for transaction: 2019-000072
03/20/2019 Letter INSPECTION SUMMARY

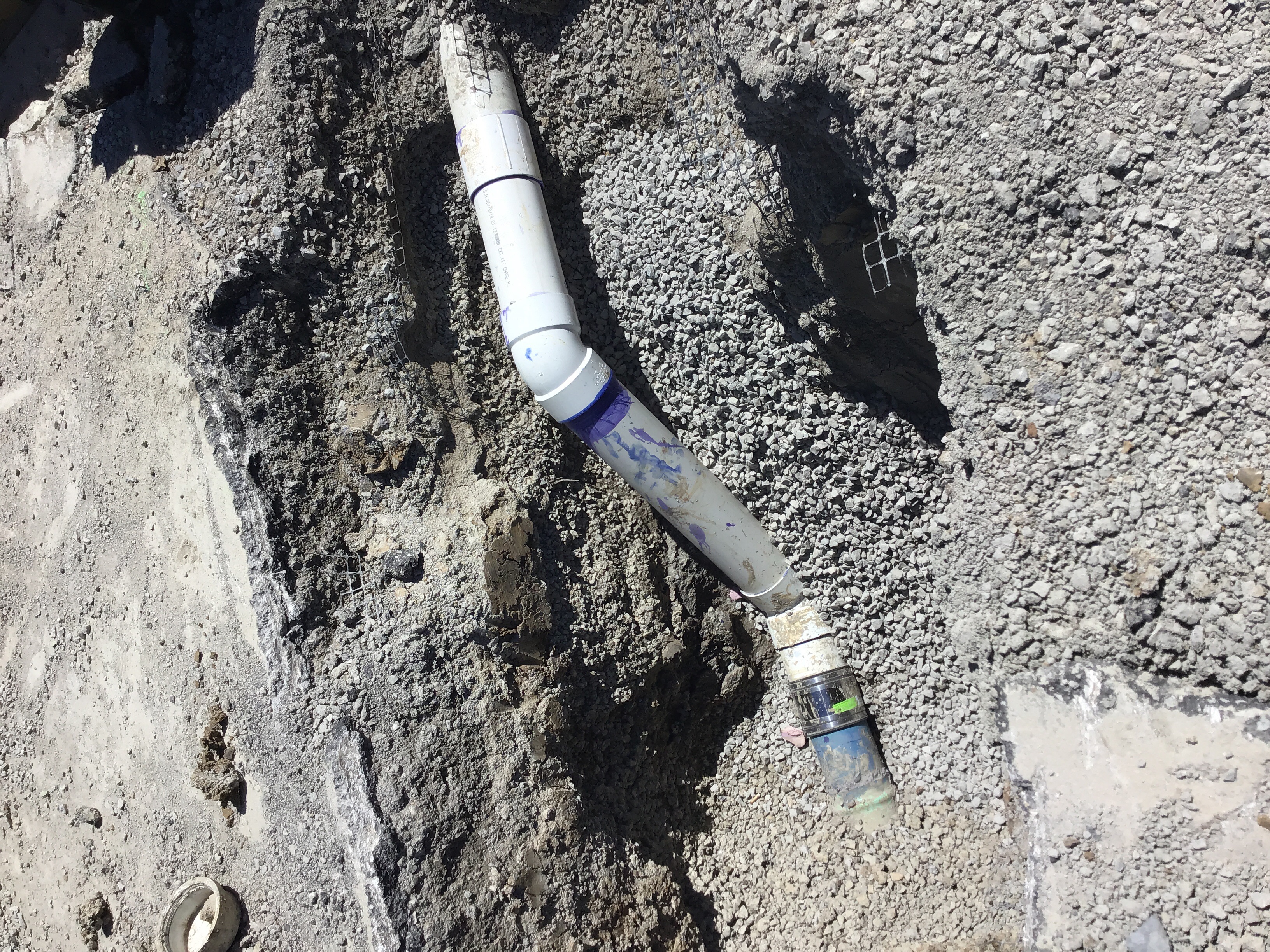

04/12/2019 Bld 229 sanitary service connection
04/12/2019 Letter INSPECTION SUMMARY
04/19/2019 Letter INSPECTION SUMMARY
07/24/2019 Letter INSPECTION SUMMARY
07/30/2019 Letter INSPECTION SUMMARY
08/06/2019 Letter INSPECTION SUMMARY
08/26/2019 Letter INSPECTION SUMMARY
09/06/2019 Letter INSPECTION SUMMARY
09/13/2019 Letter INSPECTION SUMMARY
09/16/2019 Letter INSPECTION SUMMARY
10/07/2019 Letter INSPECTION SUMMARY
10/23/2019 Letter INSPECTION SUMMARY
11/04/2019 Letter INSPECTION SUMMARY
01/08/2020 Letter INSPECTION SUMMARY
04/08/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/17/2020 Letter INSPECTION SUMMARY
04/22/2020 Letter Codes Final Certificate of Occupancy
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
