Review Type |
Outcome |
Est. Completion Date |
Completed |
Record Drawings Review
|
No Comments
|
06/15/2022
|
06/17/2022
|
|
Sue Pyles, P.E.
|
|
|
Record Drawings Review
|
Corrections
|
05/20/2022
|
05/20/2022
|
|
Sue Pyles, P.E.
|
|
|
As-graded MDP Review
|
No Comments
|
05/11/2022
|
05/11/2022
|
|
Sue Pyles, P.E.
|
|
|
Record Drawings Review
|
Corrections
|
05/04/2022
|
05/03/2022
|
|
Mike Weisenborn
|
|
|
As-graded MDP Review
|
Corrections
|
05/02/2022
|
05/02/2022
|
|
Sue Pyles, P.E.
|
|
|
As-graded MDP Review
|
Corrections
|
04/01/2022
|
04/05/2022
|
|
Sue Pyles, P.E.
|
|
|
Record Drawings Review
|
Corrections
|
04/01/2022
|
04/05/2022
|
|
Sue Pyles, P.E.
|
|
|
Record Drawings Review
|
Corrections
|
03/01/2022
|
03/25/2022
|
|
Mike Weisenborn
|
|
|
Engineering Review
|
No Comments
|
10/29/2021
|
10/29/2021
|
|
Sue Pyles, P.E.
|
|
|
Engineering Review
|
No Comments
|
10/18/2021
|
10/18/2021
|
|
Sue Pyles, P.E.
|
|
|
Engineering Review
|
No Comments
|
04/01/2021
|
03/16/2021
|
|
Sue Pyles, P.E.
|
|
|
Engineering Review
|
No Comments
|
04/01/2021
|
03/15/2021
|
|
Sue Pyles, P.E.
|
|
|
Traffic Review
|
No Comments
|
04/01/2021
|
03/11/2021
|
|
Sue Pyles, P.E.
|
|
|
Traffic Review
|
No Comments
|
03/08/2021
|
03/02/2021
|
|
Michael Park
|
|
|
Engineering Review
|
Corrections
|
02/05/2021
|
02/05/2021
|
|
Sue Pyles, P.E.
|
|
Corrective Action Required
Comments on the Engineer's Estimate of Probable Construction Costs will be provided under separate cover.
|
|
Corrective Action Required
Since the initial review, the department has changed the inspection contact process. Please revise the "48 hour" contact note with the following: “The contractor shall contact the City’s Development Services Engineering Inspection to schedule a pre-construction meeting with a Field Engineering Inspector prior to any land disturbance work at (816) 969-1200.”
I don’t see Master Drainage Plan items required for LS Section 5601.8.A.3, items h-j. Please add to the plan set.
|
|
Corrective Action Required
Please include enough dimensional information to ensure the rip rap can be constructed to the required shape for each location.
|
|
Corrective Action Required
Sheet C101: Longview Blvd. is classified as an arterial. As shown in Design and Construction Manual Section LS5203.11, an arterial requires a specific pavement design based on criteria in that section.
|
|
Corrective Action Required
Include the 2 added detention basin notes, shown in Comment 5 of the previous review, on Sheet C205. They can remain on Sheet C050, or be removed from that sheet.
|
|
Corrective Action Required
Sheet C205:
• Include top of dam and emergency overflow spillway elevations,.
• Show dam in detention basin cross sections.
• Show & label emergency overflow spillway location in Plan view on this sheet and throughout the plan set.
• Include stationing in the Structure 205 label in the Detention basin Length Section.
|
|
|
Traffic Review
|
No Comments
|
02/05/2021
|
02/03/2021
|
|
Michael Park
|
|
|
Engineering Review
|
Corrections
|
12/11/2020
|
12/11/2020
|
|
Sue Pyles, P.E.
|
|
Corrective Action Required
General:
• Due to the nature and number of comments, the resubmittal review period will be 10 days.
• Please revise these plans to reflect any applicable comments made with the Preliminary Development Plan review, as well as any other plan sets submitted.
• Show location of all oil/gas wells, or indicate none are present, and cite the source.
• Please add the following note: The contractor shall contact the City’s Development Services Engineering Inspection 48 hours prior to any land disturbance work at (816) 969-1200.”
• Please make sure all shadings/hatchings used throughout the plan set are included in a Legend.
• Include construction of SW Longview Blvd. north to the connection with the existing road.
• Revise plans to show SW 12th Street in a stop condition at SW Longview Blvd.
|
|
Corrective Action Required
Please submit the following:
• Engineer's Estimate of Probable Construction Costs.
• SWPPP and a copy of the MDNR Land Disturbance Permit.
|
|
Corrective Action Required
ADA:
• General Comment Concerning the ADA-Accessible Ramps and ADA-Accessible Ways: The specific details of these features must include, at a minimum, the design details specified in Section 5304.8 of the Design and Construction Manual. Elevation call-outs, although required, are not sufficient. Other design details specified in this section are required, including slope call-outs which comply with the criteria listed in Table LS-5, and section views specified in 5304.8.
• Include ADA-accessible route details, using the City of Lee’s Summit design standards, across intersections under stop control. In addition, the profile view of the roadway sections must be updated to clearly show the locations of these stop controlled intersections.
• The developer is responsible for construction of all ADA-accessible ramps, as well as any sidewalk adjacent to tracts or unplatted land, at the time of infrastructure improvements. Please clearly indicate this on the plan set by note or by labels.
|
|
Corrective Action Required
Stormwater:
• Please see Design and Construction Manual Lee’s Summit Section 5601.8.A and incorporate all required information into a Master Drainage plan within this set of plans.
• Please submit a Final Stormwater Study for the project. It will build upon the approved Preliminary Stormwater Study and include additional information identified in Design and Construction Manual Section 5600. As of these comments, the preliminary report has not yet been approved.
• Included detention basin information, including a cross section that shows all relevant basin elevations. Show and label the 100-year WSE throughout the plan set.
• Please note that a full review of the storm sewer system was not completed since no stormwater study has been submitted.
|
|
Corrective Action Required
Please include the following notes, displayed prominently, on appropriate sheets within the plan set:
• CONTRACTOR TO CONSTRUCT STORMWATER MANAGEMENT FACILITIES, SPECIFICALLY THOSE FEATURES RELATED TO DETENTION, PRIOR TO ANY LAND DISTURBANCE OF THE SITE AND PRIOR TO THE CONSTRUCTION OF ANY OTHER SITE DEVELOPMENT WORK AS NOT TO EFFECT DOWNSTREAM NEIGHBORS WITH UNDETAINED STORMWATER DISCHARGE.

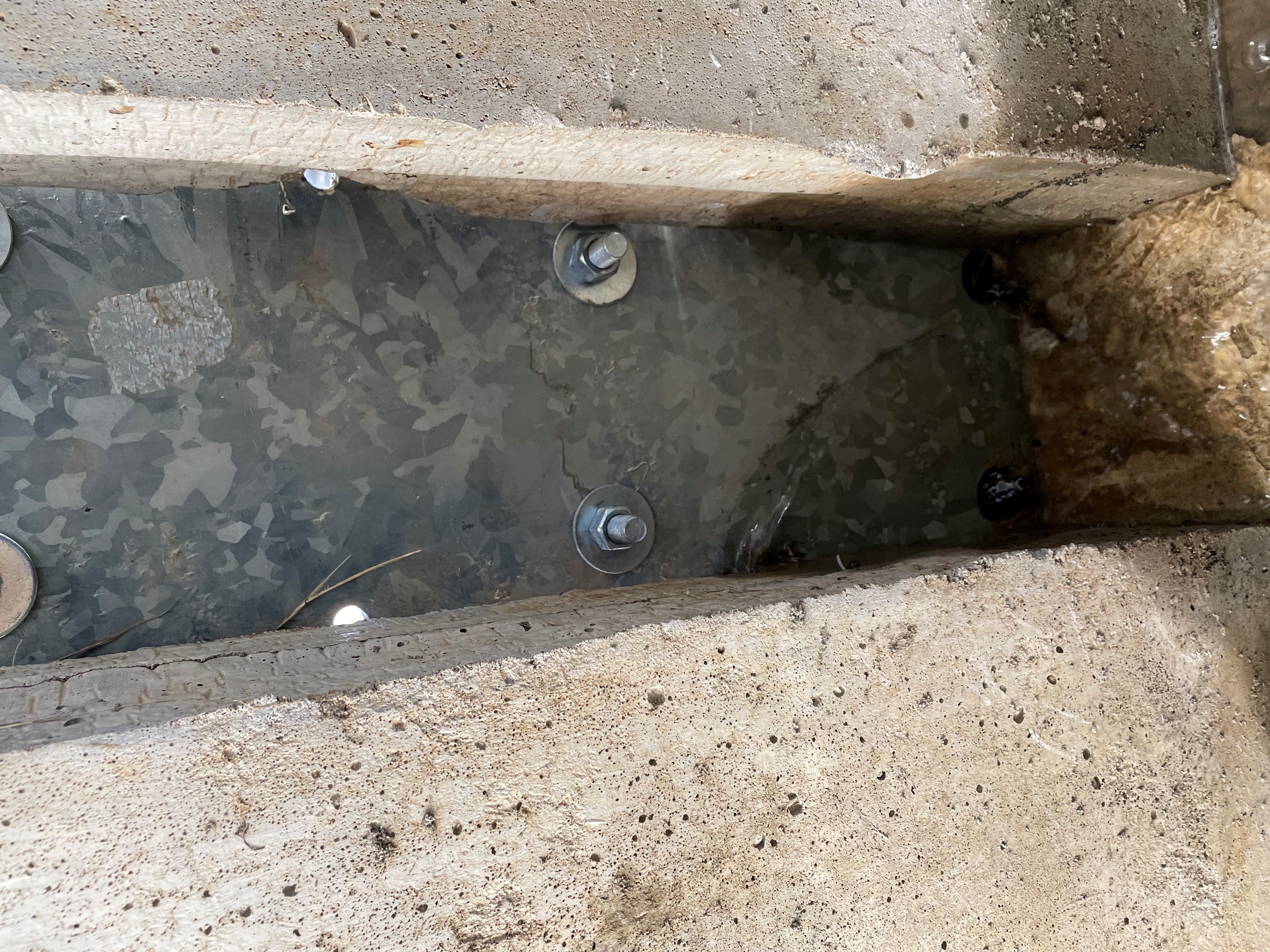

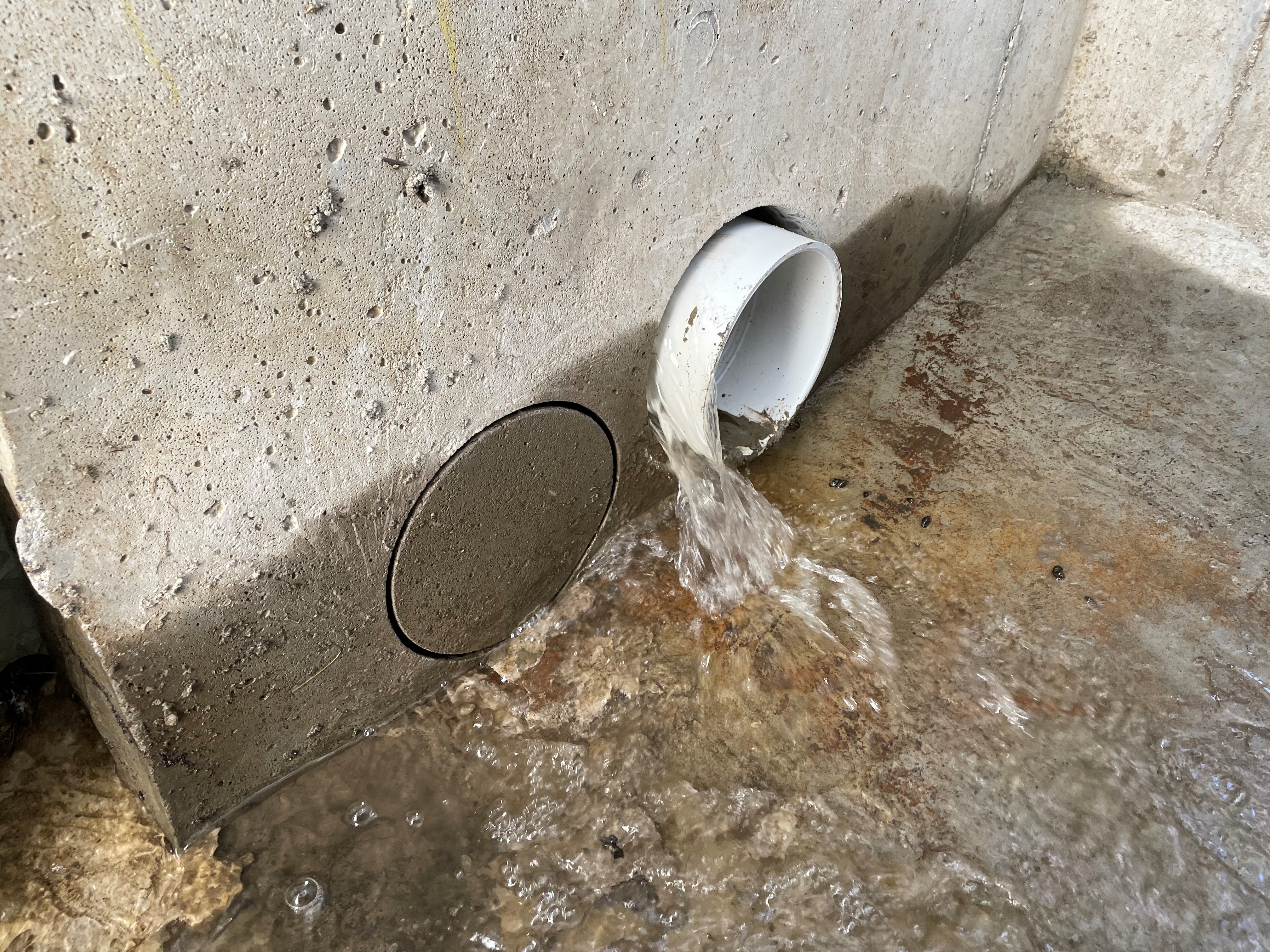

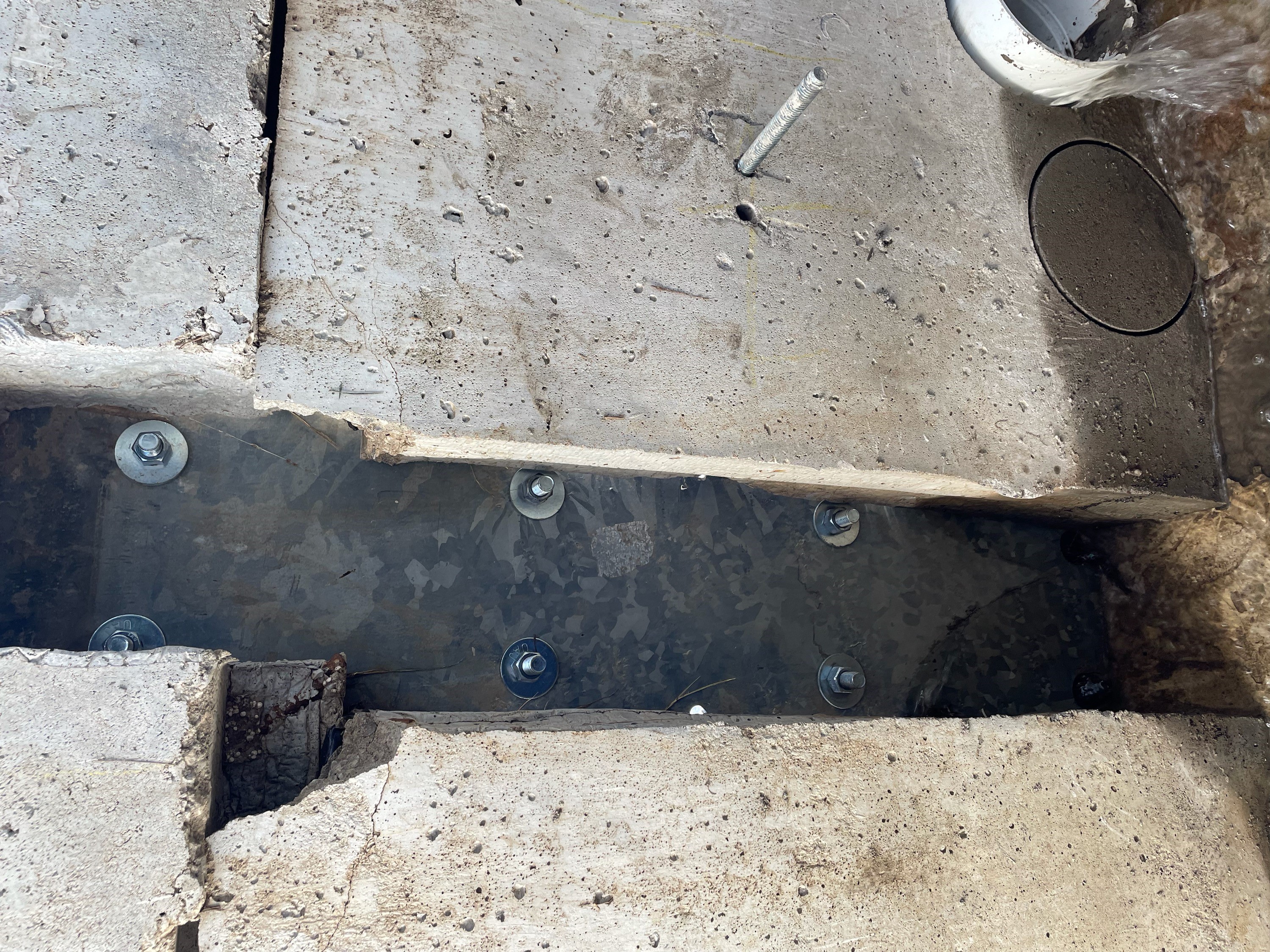

• AN AS-GRADED AND AS-AS-BUILT DRAWING SHALL BE SUBMITTED TO AND REVIEWED BY THE CITY FOR THE DETENTION BASIN. THIS SHALL BE REQUIRED PRIOR TO ISSUANCE OF A CERTIFICATE OF SUBSTANTIAL COMPLETION. ALL PRECAUTIONS SHOULD BE TAKEN TO ENSURE DETENTION POND AND OUTLET STRUCTURE ARE CONSTRUCTED ACCORDING TO THE APPROVED PLANS; VOLUMES AND ELEVATIONSARE CRITICAL FOR AS-BUILT APPROVAL. THE CITY SHALL BE PROVIDED WITH AN AS-BUILT SURVEY OF THE DETENTION BASIN, OUTLET STRUCTURE INCLUDING ALL WEIR ELEVATIONS AND STORM SYSTEM INCLUDING ALL THE INVERTS, STAMPED BY A MISSOURI LICENSED ENGINEER.
|
|
Corrective Action Required
Sheet CVR:
• Remove the approval signature block for the City. A stamp will be provided electronically when approved.
• KCP&L is now Evergy. Please update the Utility Contacts accordingly.
• Gene Williams is not the City’s contact for stormwater. There is no one person to list, just Public Works in general. Their phone number is 816-969-1800. Please revise.
|
|
Corrective Action Required
Sheet C050:
• Please revise “as directed by the engineer” to “as directed by the City” in General Note 23.
• General Note 23 isn’t typically done on private construction projects.
|
|
Corrective Action Required
Sheet C101:
• Revise the geogrid label to reference the City of Lee’s Summit Public Works Approved Materials List.
• Please submit a specific pavement design for review and approval, meeting the requirements of Design and Construction Manual Section 5203.11, for Longview Blvd.
|
|
Corrective Action Required
Sheet C102: Show the existing water line to the east on SW 12th Street on this sheet and throughout the plan set.
|
|
Corrective Action Required
Sheet C104: Relocate overlapping text in the title block.
|
|
Corrective Action Required
Sheet C106:
• The grading will be reviewed when the additional required information has been included.
• Show and label the detention basin emergency overflow spillway.
• There appears to be a swale along the rear property line of Lots 149-154. Is this intended to be an engineered swale?
|
|
Corrective Action Required
Sheets C203 & C204:
• Include all utility crossings in the Profile views.
• Remove all inaccurate utility crossing information in the Profile views.
• It would appear that the Storm 201.1 Series profile is named incorrectly. Please revise as needed.
• The Structure 201 label shows incorrect type and size in the Profile view.
• HDPE is not an allowed pipe material for the pipe under Longview Blvd.
• The Storm 200 Series drop thru Structure 201 does not meet minimum drop requirements. Please revise.
• Please revise the Storm 200 Series profile so that information on the right side is not cut off.

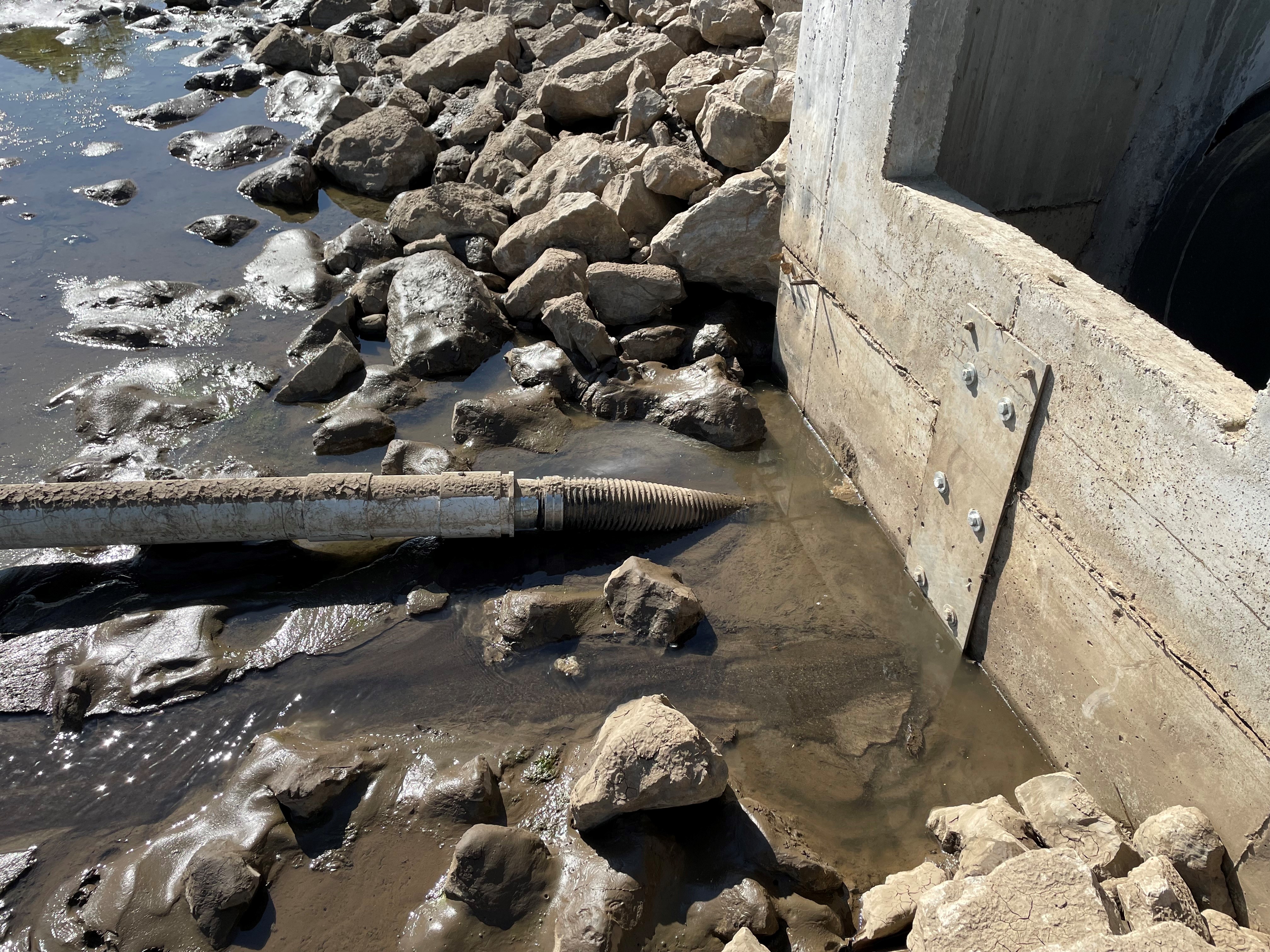

• Please include dimensional information for all riprap on these sheets or elsewhere in the plan set. Include design information to ensure the design is adequate for the velocities present.
|
|
Corrective Action Required
Sheet’s C301-C303: Please revise the ESC plan sheets to match the ESC set of plans submitted separately.
|
|
Corrective Action Required
Sheet C402: Label CG-1 on the north leg of the intersection.
|
|
Corrective Action Required
Sheet C406: Label the concrete as KCMMB.
|
|
Corrective Action Required
Add a standard detail for Trench Backfill.
|
|
|
Traffic Review
|
Approved with Conditions
|
12/11/2020
|
12/11/2020
|
|
Michael Park
|
|
Corrective Action Required
Pavement Markings should be removed from the plan as unnecessary and inconsistent with City practice at this location.
|
|
Corrective Action Required
Plans shall refer to the City standards, details and specifications for signing location, installation and materials. In particular, street name signs require certain prefix, suffix and dimensions that must comply with City standard details.
|
|
Corrective Action Required
Stop signs and street name signs are required on 12th at Longview Blvd; no stop control on Longview Blvd. The sequencing of construction for Longview Blvd. conveyed by engineer and applicant indicates Longview Blvd. will be constructed immediately after or in concurrance with the construction of 12th in assocation with committed 6th Plat to immediately follow or concurrently occur with 5th Plat construction activities.
|
|
Corrective Action Required
Design has not included Longview Blvd. Longview Blvd. will be constructed with 6th Plat, but escrow for construction in association with 5th Plat for assurance of completion and connection of planned roadway network.
|
|
|
