Permit Application Status

PRSUBD20183913


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary


PRSUBD20183913
Public Infrastructure
Final Acceptance
OAK VIEW LEES SUMMIT LLC
DEVELOPMENT COMPLETE
PUBLIC TRAFFIC IMPROVEMENTS
11/16/2018
01/17/2019
12/22/2020
Locations
Contacts
OAK VIEW LEES SUMMIT LLC, Address:201 HAWKS RIDGE TRL
PROSSER WILBERT CONSTRUCTION INC, Address:13730 W 108TH ST, Phone:(913) 906-0104
Reviews
Review Type Outcome Est. Completion Date Completed
Master Draingage As-built Review Approved 11/10/2020 12/22/2020
Steve Robbins
Licensed Contractors Approved 11/16/2018 01/15/2019
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
9110081-Paved Surface Inspection Fee $1,464.72 $1,464.72 Paid 11/16/2018
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Site Visit Partial 3/22/2019 04/10/2019
Misc
Informational
04/10/2019
4-10-19 Talked with Brad the GC he is requesting a wet tap for the water tie it on Douglas due to business operating 24 hours a day.
Site Visit Partial 4/11/2019 at 2:15 PM 04/11/2019
Misc
Informational
04/10/2019
4-10-19 Talked with Brad the GC he is requesting a wet tap for the water tie it on Douglas due to business operating 24 hours a day.
Misc
Informational
04/11/2019
Joe Starlin 04/11/2019 4:00 PM The beemer crew filled in the core holes on Douglas with flowable fill and fast setting hydraulic cement. They left the street plates on so that the flowable fill can set up completely.
Pavement-Proof Roll Passed 06/15/2019
Misc
Informational
06/15/2019
5-16-19 The turn lane was proof rolled with a 20 ton loan and passed.
Pavement-Surface Partial 06/15/2019
Misc
Informational
06/15/2019
5-16-19 7:45 cloudy 70 degrees out. O’Donnell Way Construction are laying asphalt in the turn lane.
Commercial Curb Inspection Partial 6/18/2019 06/18/2019
Misc
Informational
06/18/2019
6-18-19 Freedom Concrete will be pouring the curb with machine and some hand work. I informed them that they will need to grout the backside of the curb if there is honeycomb and to use plenty of cure on both sides. First truck arrived at 9:40am. They completed the curb at 2:30pm. The backside of curb is grouted and cure was applied correctly.
Street - Wedge Lift Passed 06/20/2019
Misc
Informational
06/20/2019
6-20-19 The wedge lift is complete for the turning lane.
Sidewalk Inspection Partial 6/27/2019 06/27/2019
Misc
Informational
06/27/2019
6-27-19 9:09am They have set up sidewalk on the north side of the site along Douglas. Aggregate is compacted and forms are set. I spoke with the Forman and he assured me they will stay compliant with are specs. I gave them details for all ADA specs.
Misc
Informational
06/27/2019
6-27-19 9:09am They have set up sidewalk on the north side of the site along Douglas. Aggregate is compacted and forms are set. I spoke with the Forman and he assured me they will stay compliant with are specs. I gave them details for all ADA specs.
Misc
Informational
06/27/2019
6-27-19 9:09am They have set up sidewalk on the north side of the site along Douglas. Aggregate is compacted and forms are set. I spoke with the Forman and he assured me they will stay compliant with are specs. I gave them details for all ADA specs.3:26pm The sidewalk is poured
Driveway Inspection Partial 6/28/2019 06/28/2019
Misc
Informational
06/28/2019
The approach is ready for pour. Aggregate is compacted and pins are set for ADA compliance. They were told to use white cure.
Pavement-Proof Roll Passed 5/14/2019 10/03/2019
Curb - Proof Roll Passed 10/03/2019
Street - Surface Course Passed 10/03/2019
Grading/Excavation/Fill Inspection Passed 10/03/2019
Site Visit Complete 10/03/2019
Misc
Informational
04/11/2019
4-10-19 Talked with Brad the GC he is requesting a wet tap for the water tie it on Douglas due to business operating 24 hours a day.
Misc
Informational
04/11/2019
Joe Starlin 04/11/2019 4:00 PM The beemer crew filled in the core holes on Douglas with flowable fill and fast setting hydraulic cement. They left the street plates on so that the flowable fill can set up completely.
Pavement-Surface Passed 10/03/2019
Misc
Informational
06/15/2019
5-16-19 7:45 cloudy 70 degrees out. O’Donnell Way Construction are laying asphalt in the turn lane.
Pavement-Curb Construction Passed 10/03/2019
Misc
Informational
06/18/2019
6-18-19 Freedom Concrete will be pouring the curb with machine and some hand work. I informed them that they will need to grout the backside of the curb if there is honeycomb and to use plenty of cure on both sides. First truck arrived at 9:40am. They completed the curb at 2:30pm. The backside of curb is grouted and cure was applied correctly.
Street - Surface Course Passed 6/20/2019 10/03/2019
Sidewalk Inspection Passed 10/03/2019
Misc
Informational
06/27/2019
6-27-19 9:09am They have set up sidewalk on the north side of the site along Douglas. Aggregate is compacted and forms are set. I spoke with the Forman and he assured me they will stay compliant with are specs. I gave them details for all ADA specs.
Misc
Informational
06/27/2019
6-27-19 9:09am They have set up sidewalk on the north side of the site along Douglas. Aggregate is compacted and forms are set. I spoke with the Forman and he assured me they will stay compliant with are specs. I gave them details for all ADA specs.
Misc
Informational
06/27/2019
6-27-19 9:09am They have set up sidewalk on the north side of the site along Douglas. Aggregate is compacted and forms are set. I spoke with the Forman and he assured me they will stay compliant with are specs. I gave them details for all ADA specs.3:26pm The sidewalk is poured
Driveway Inspection Passed 10/03/2019
Misc
Informational
06/28/2019
The approach is ready for pour. Aggregate is compacted and pins are set for ADA compliance. They were told to use white cure.
Erosion Control Inspection Passed 11/06/2020
Master Drainage As-built Inspection Passed 12/28/2020 12/22/2020
Documents & Images
Date Uploaded File Type Document Name
11/16/2018 Receipt Receipt for transaction: 2018-007265
12/12/2018 Letter DE-Permit
01/17/2019 Oakview Street Expansion Singed Permit
04/10/2019 Letter INSPECTION SUMMARY
04/11/2019 Letter DE-Daily Inspection Summary
06/15/2019 Letter INSPECTION SUMMARY

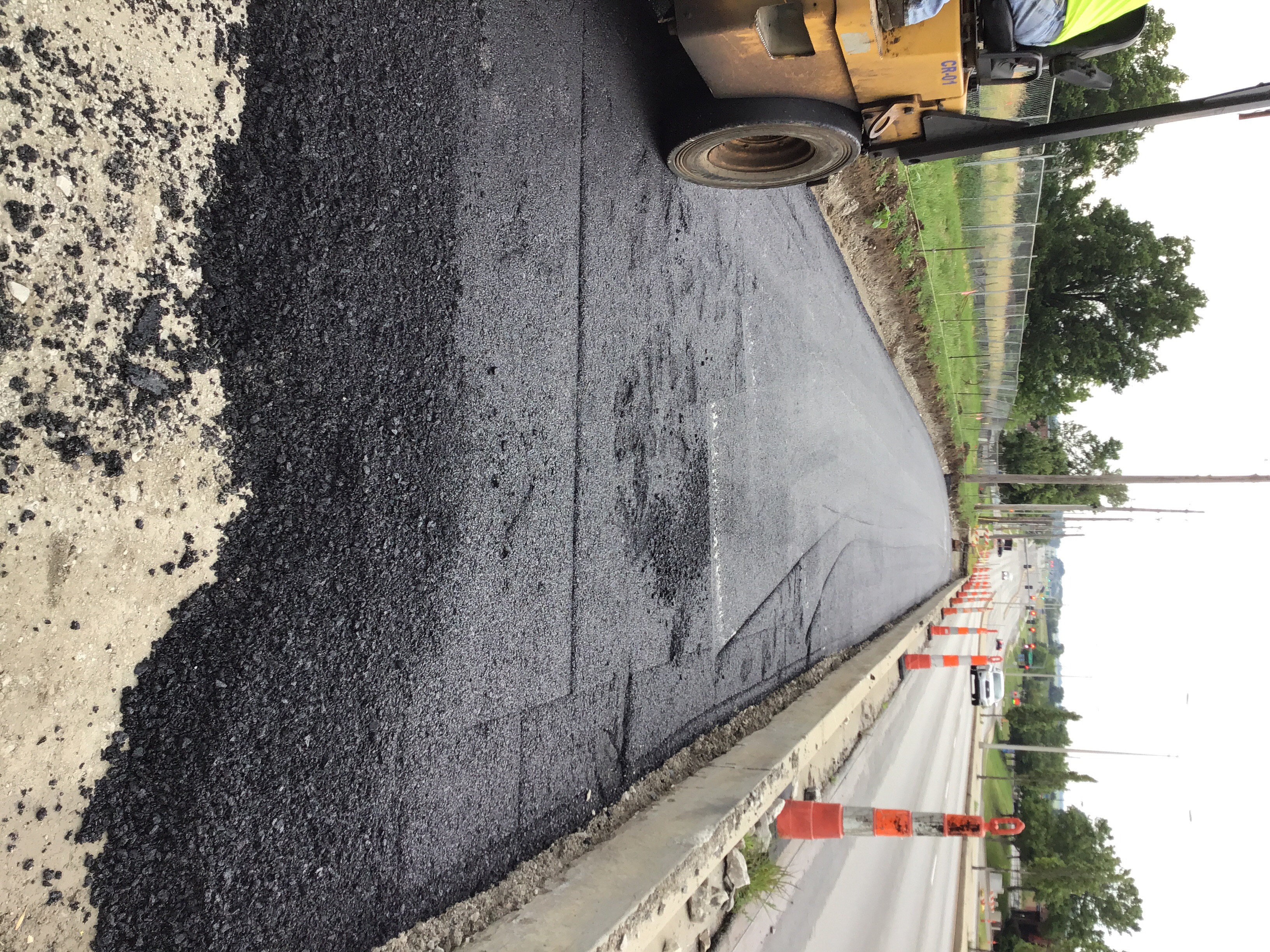

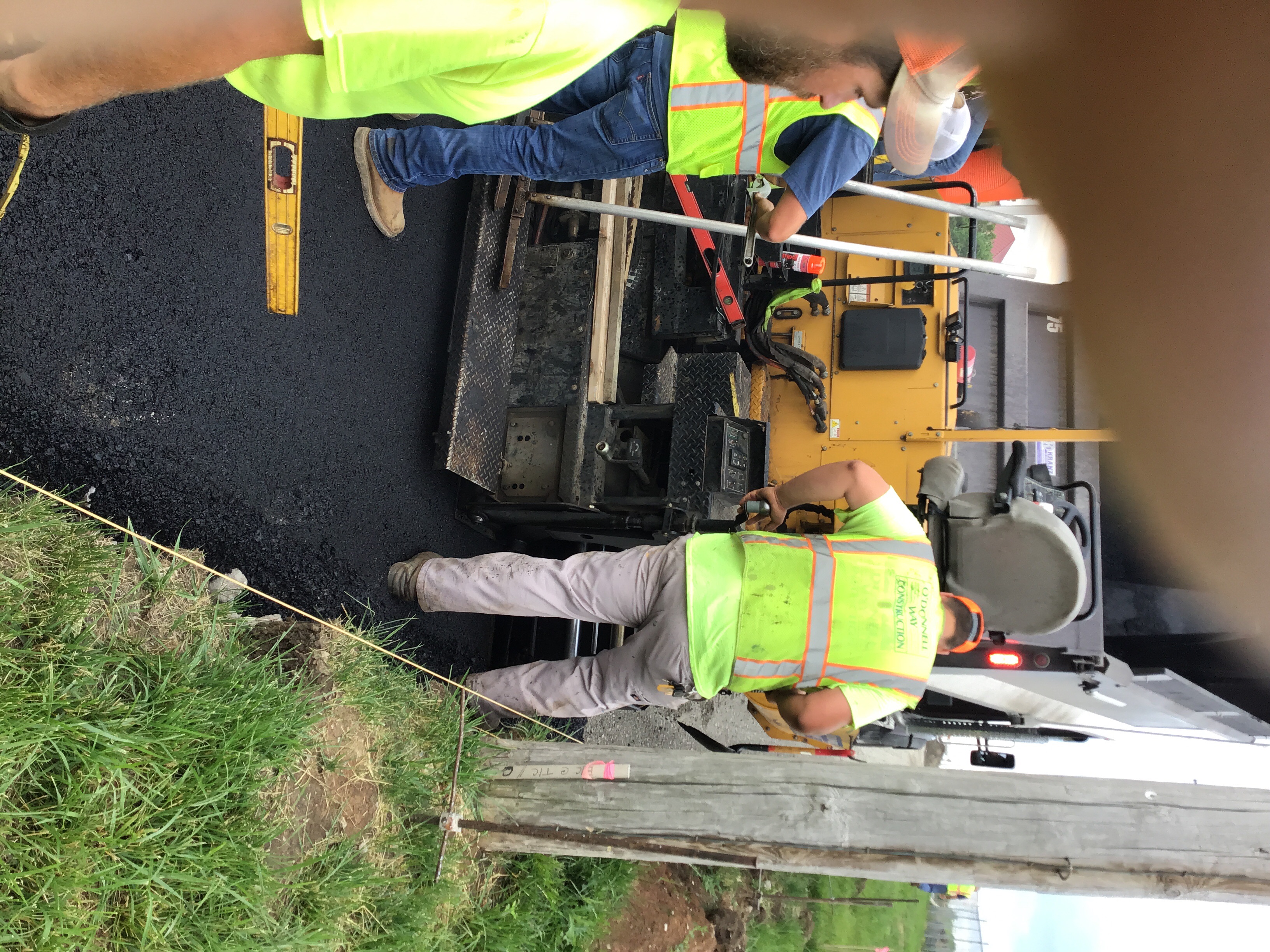

06/15/2019 image turn lane asphalt

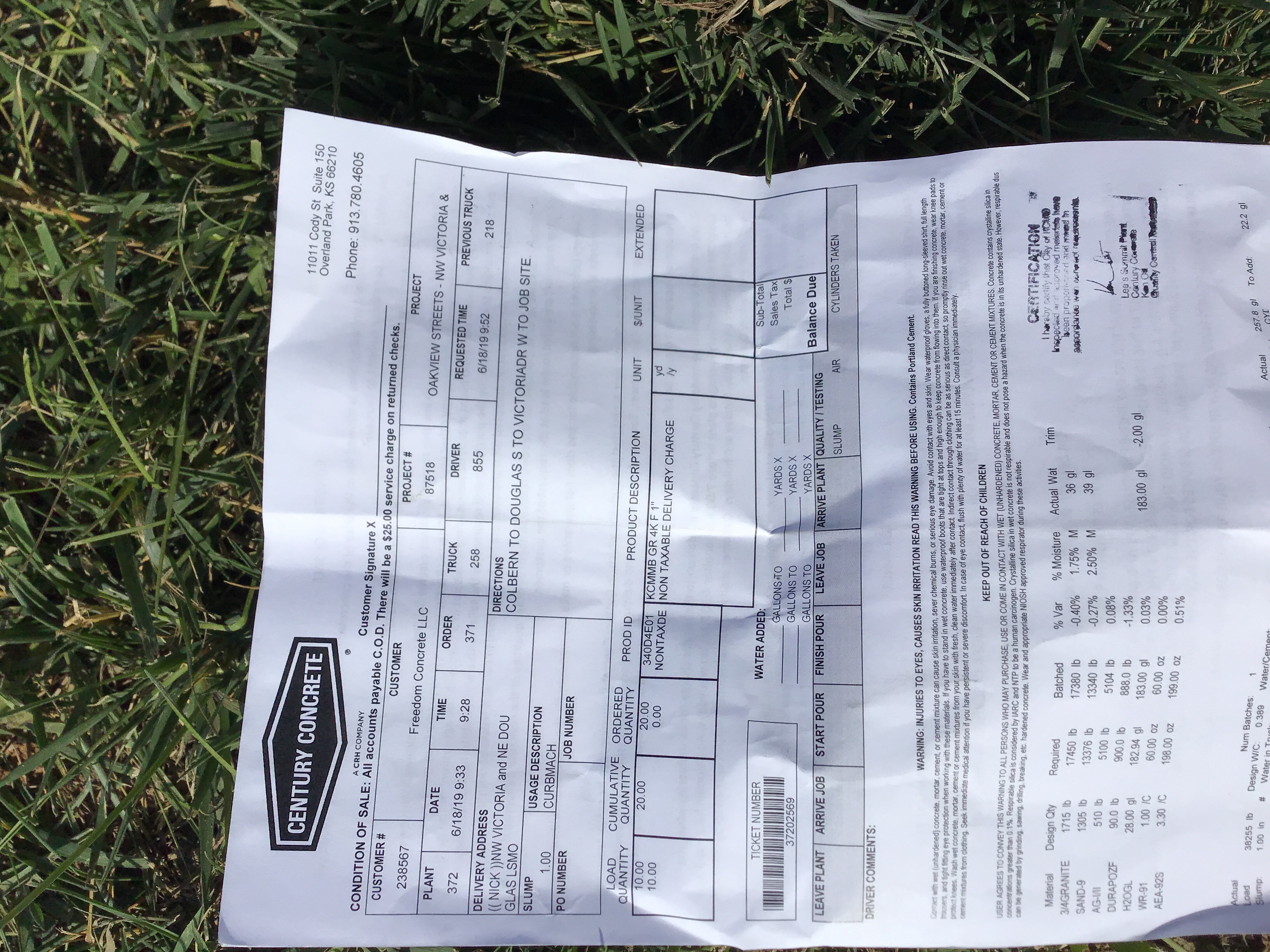

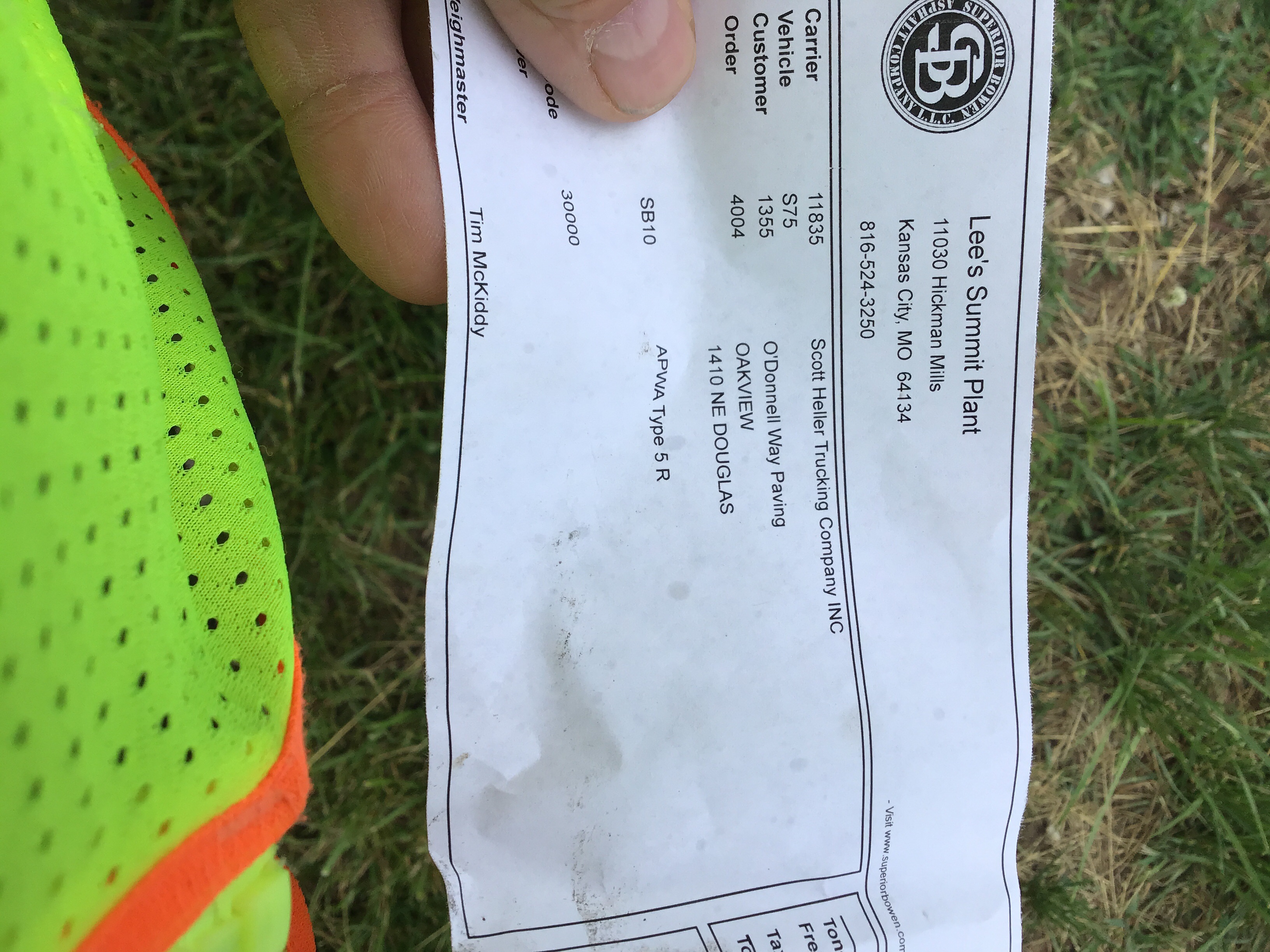

06/15/2019 image asphalt ticket

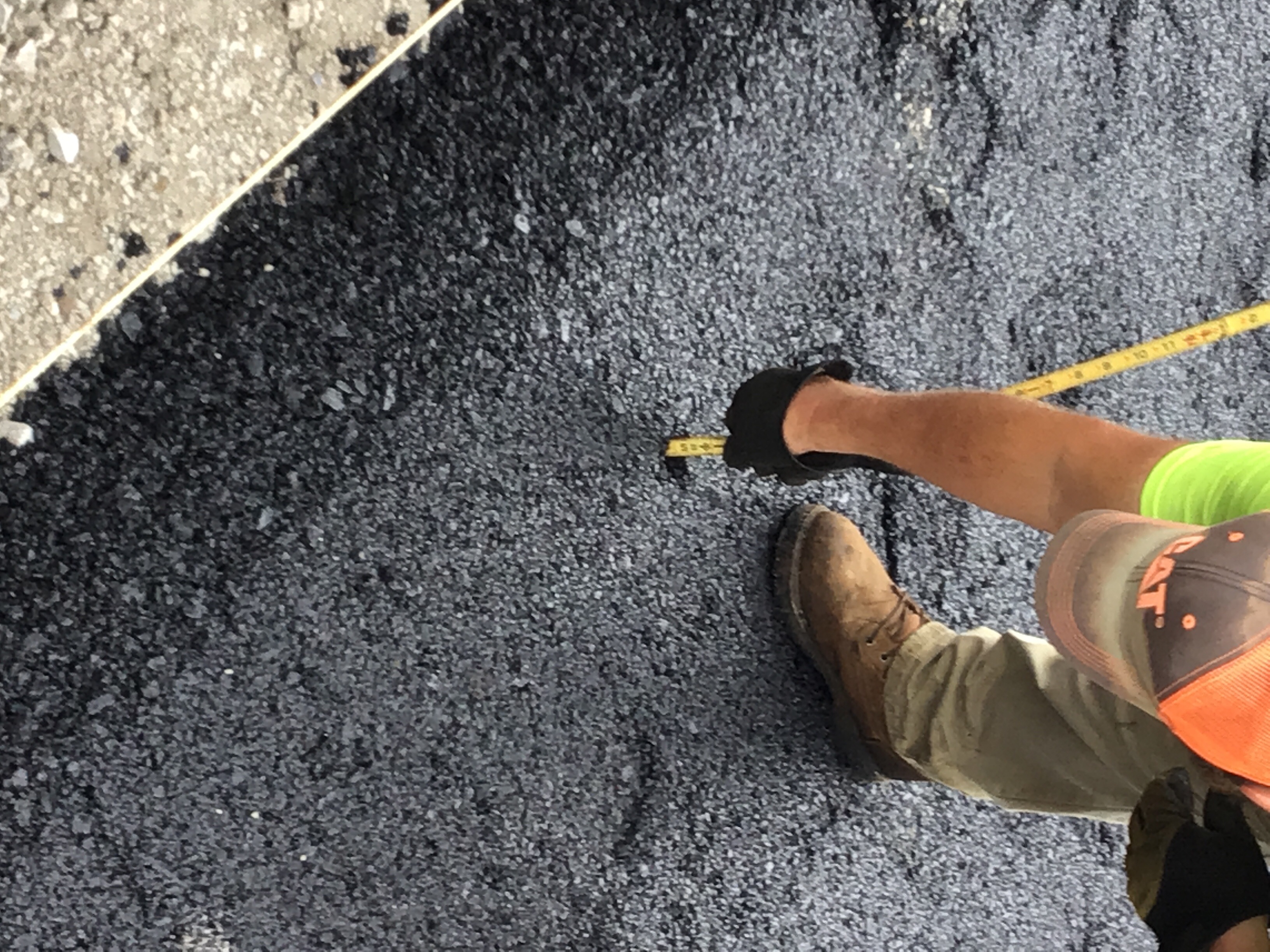

06/15/2019 image asphalt Depth turning lane

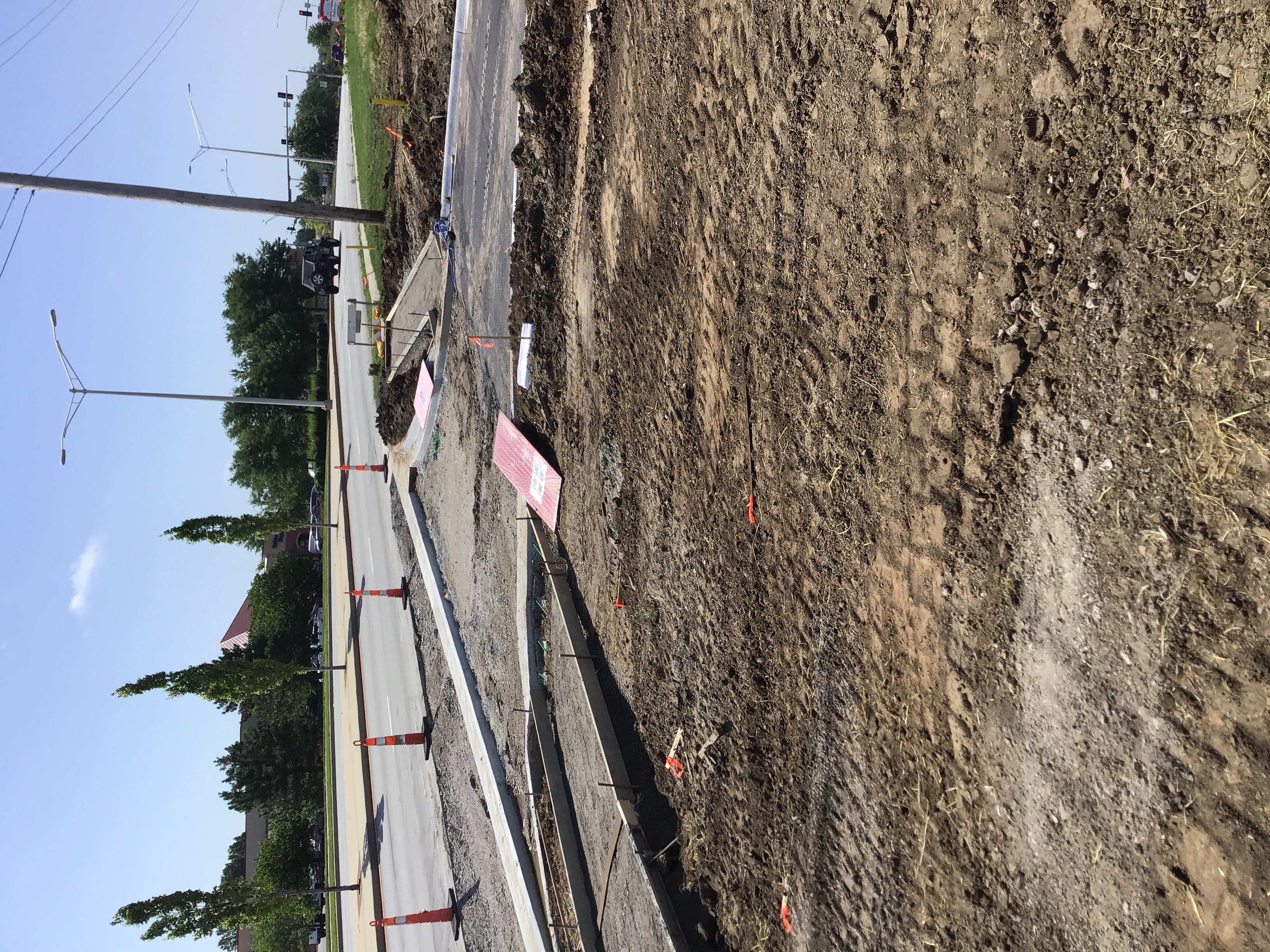

06/15/2019 image first lift of base
06/15/2019 Letter INSPECTION SUMMARY

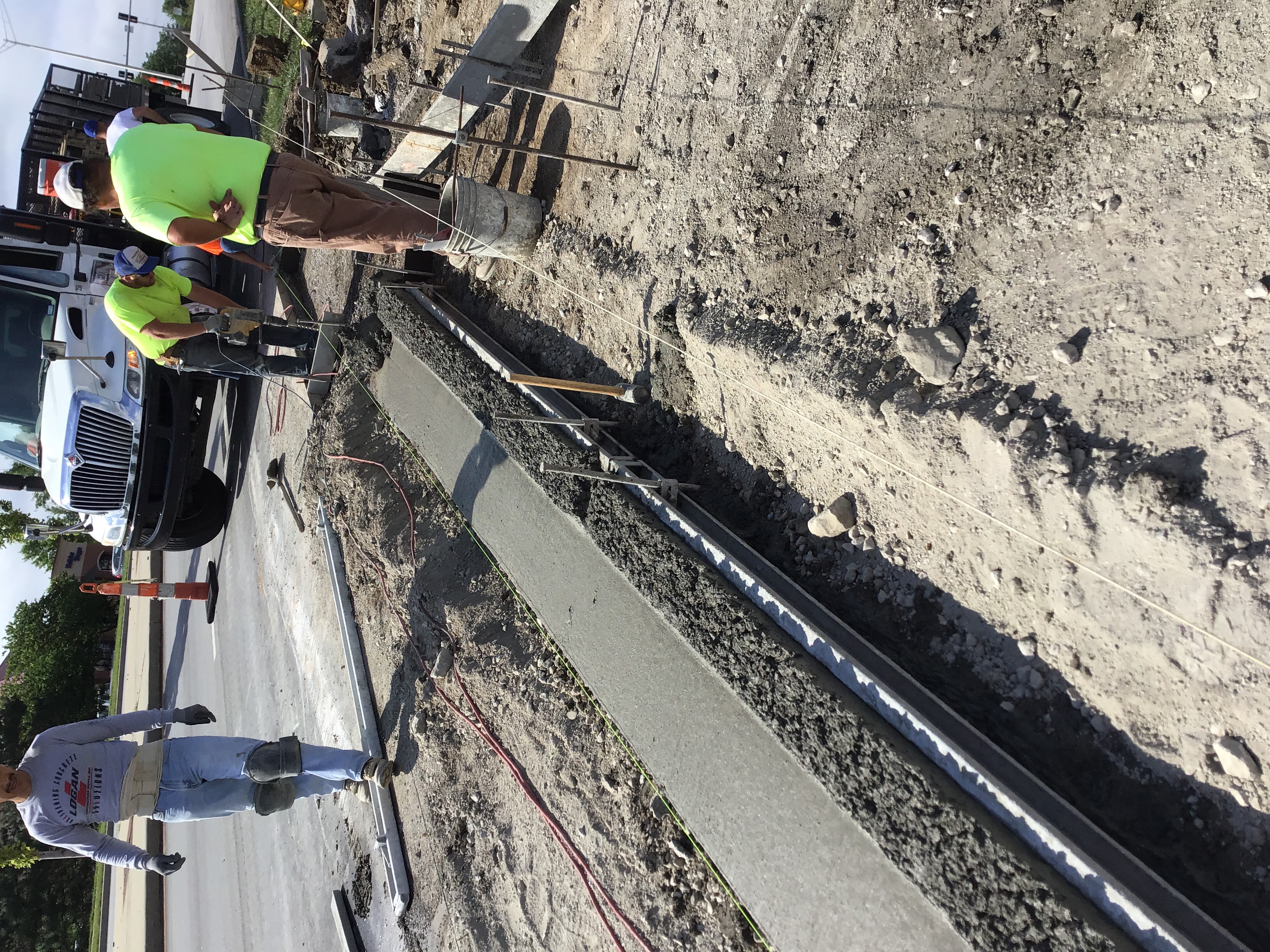

06/18/2019 image turn lane for curb
06/18/2019 image curb south end

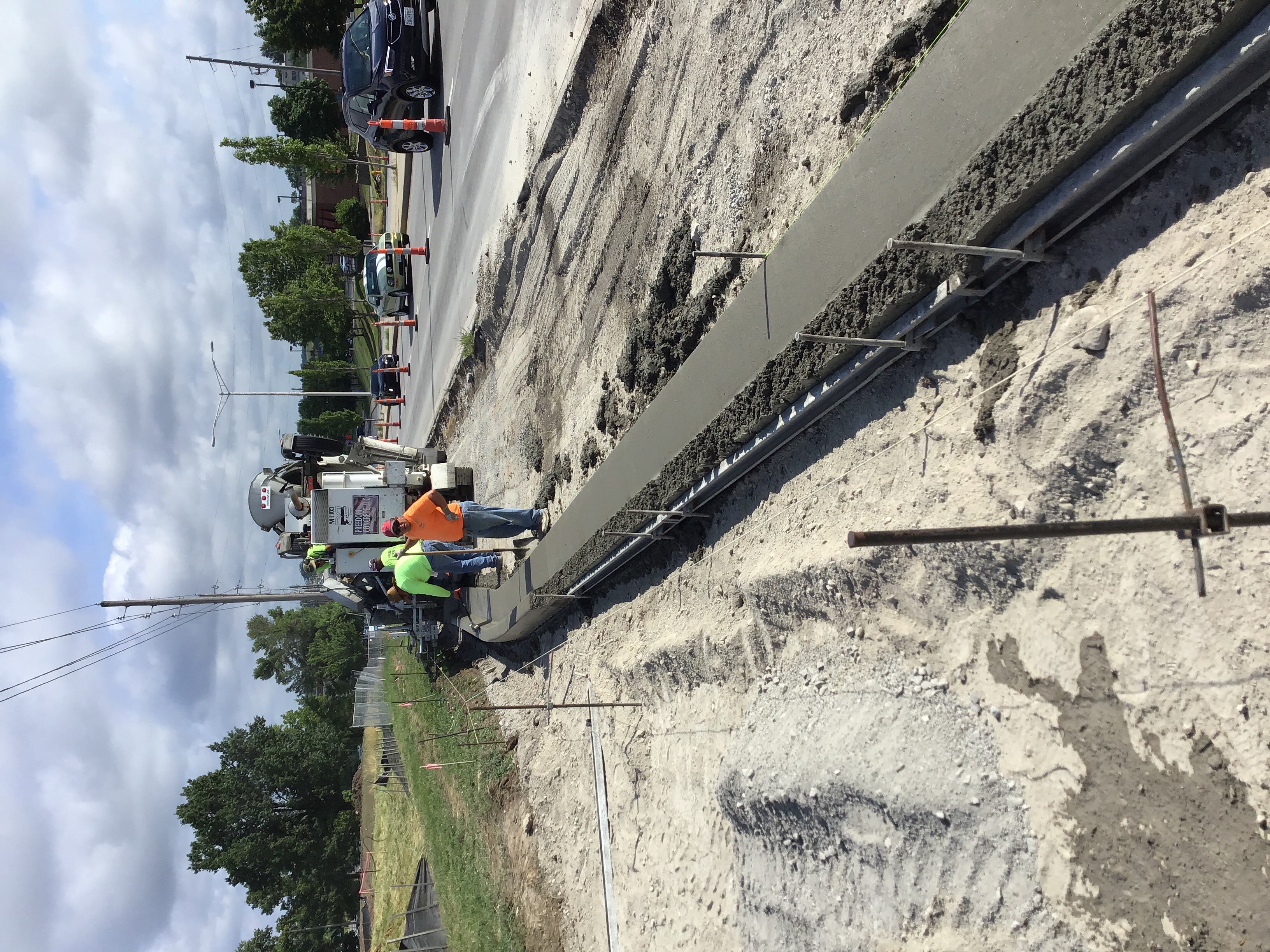

06/18/2019 image curb facing north
06/18/2019 image turn lane curb facing south
06/18/2019 image concrete ticket for curb
06/18/2019 image concrete ticket for curb0

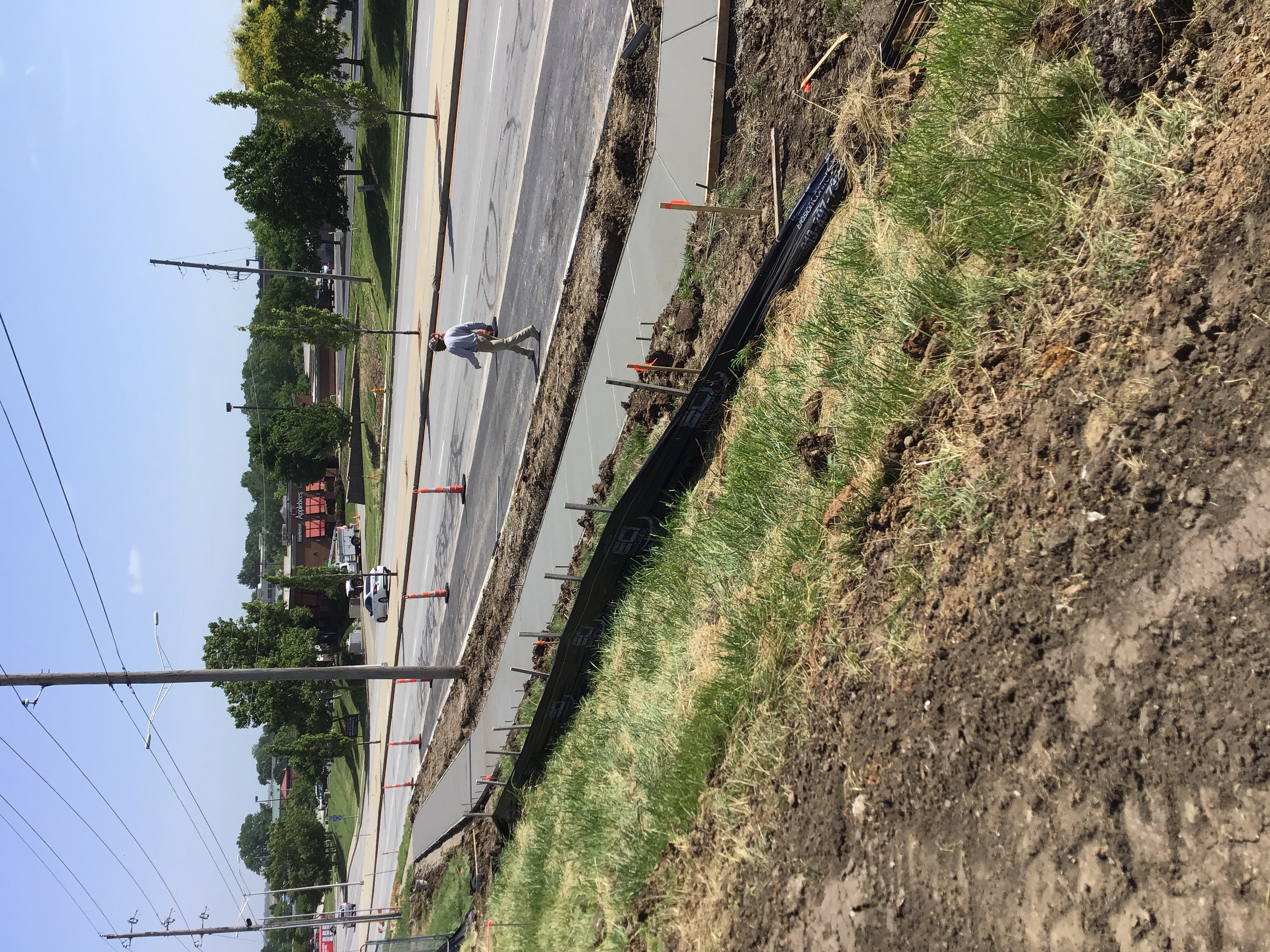

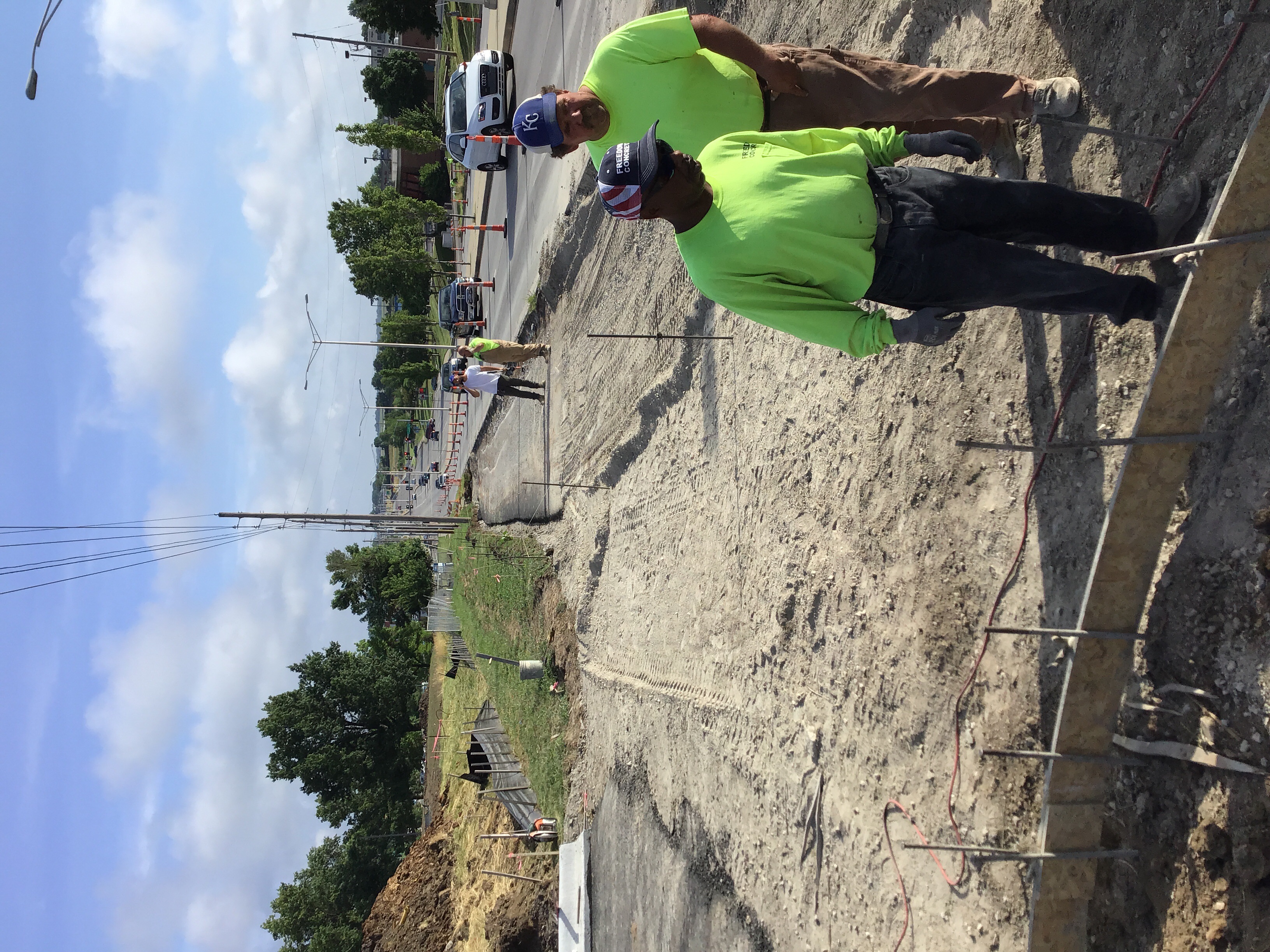

06/18/2019 image ADA N side entrance

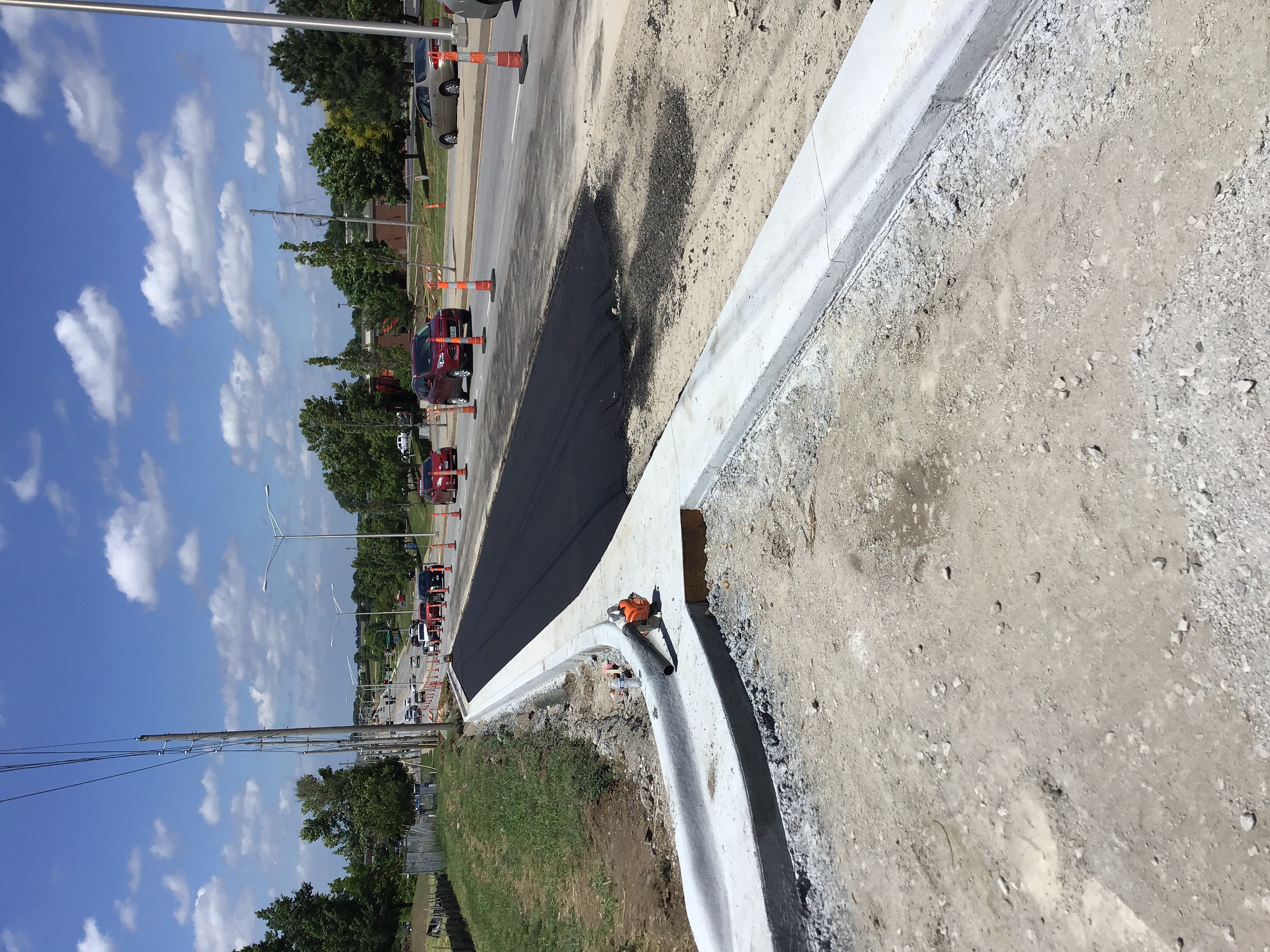

06/18/2019 image curb grouted
06/18/2019 Letter INSPECTION SUMMARY

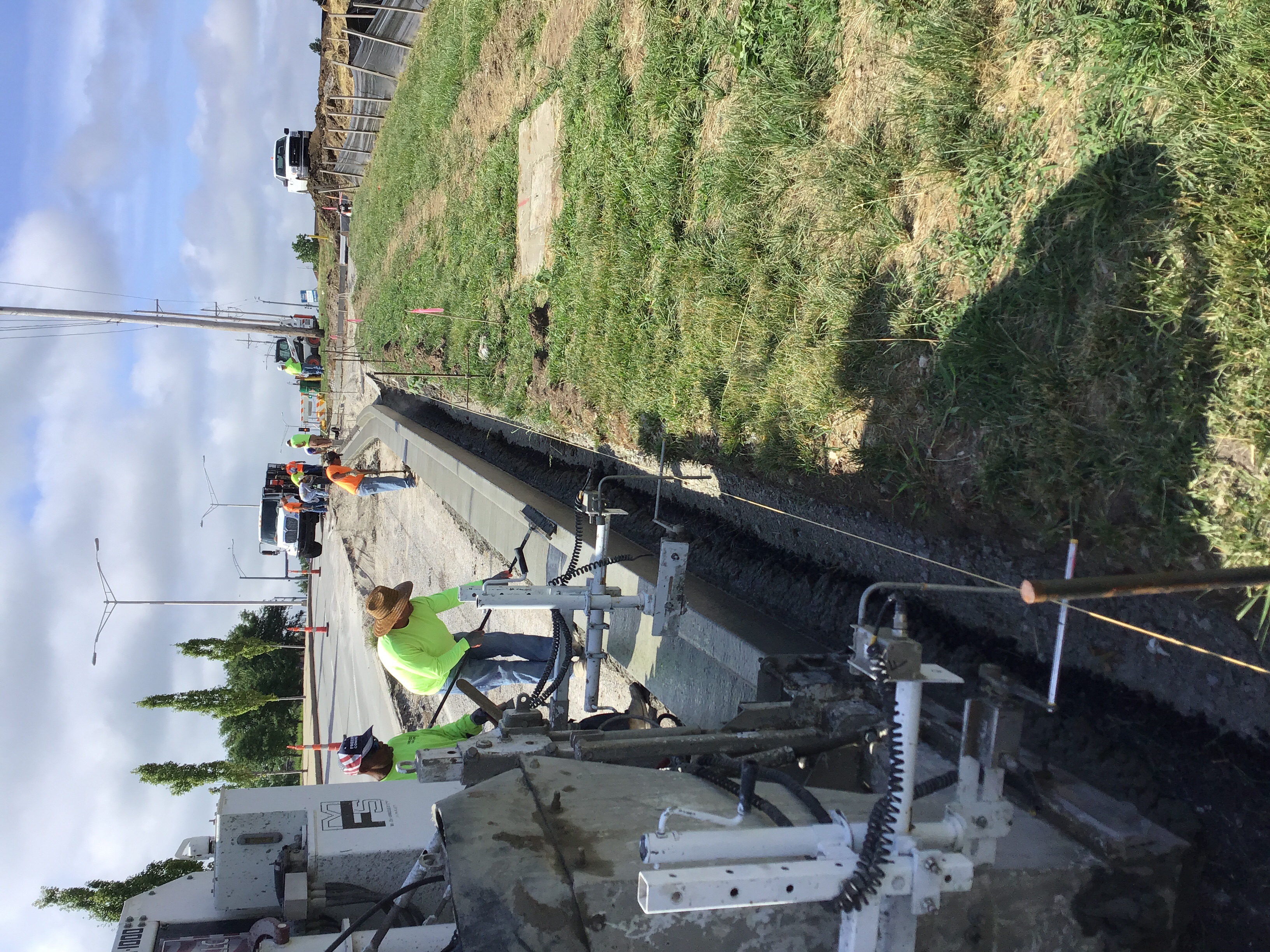

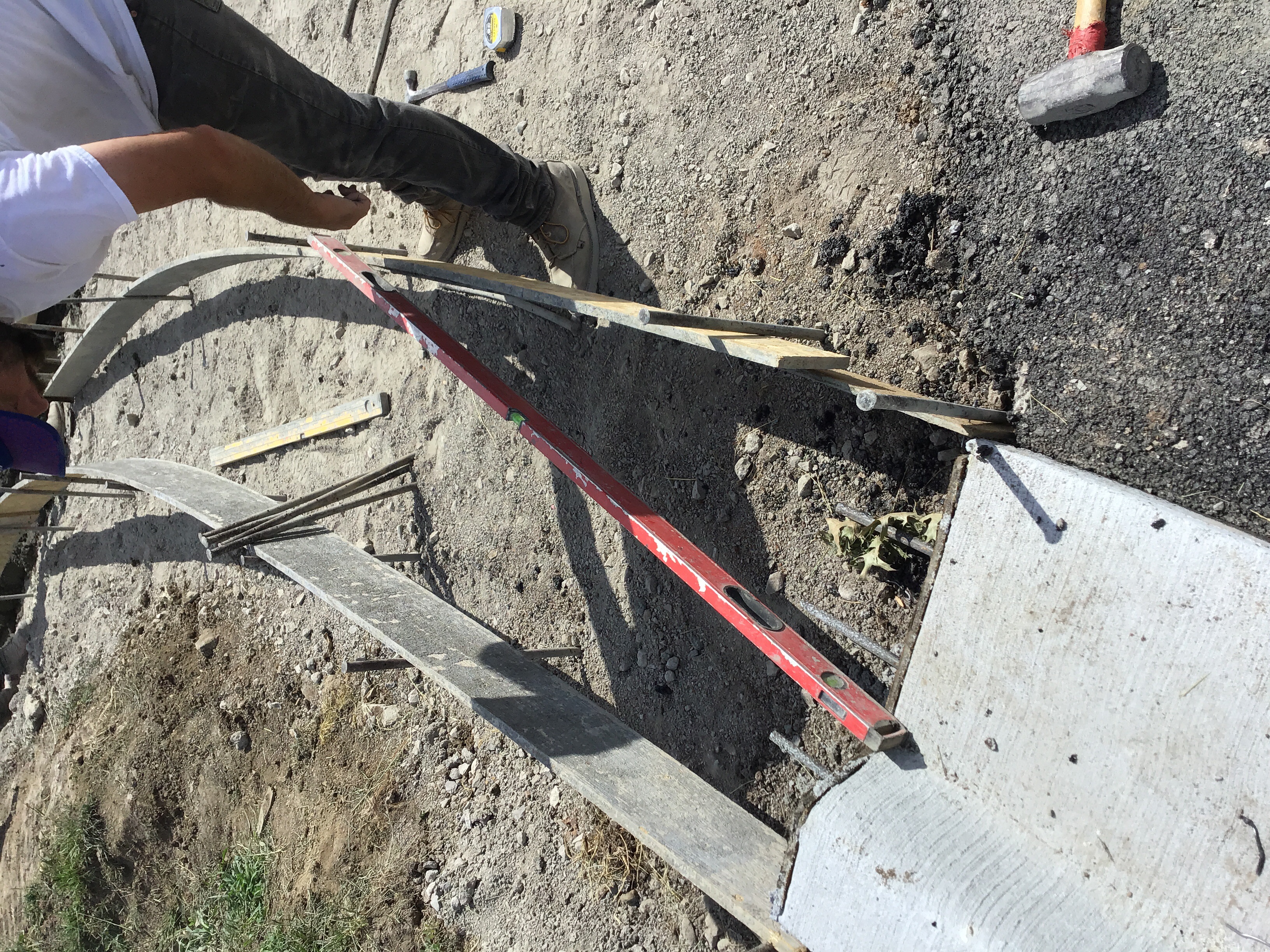

06/20/2019 image wedge lift turn lane
06/20/2019 Letter INSPECTION SUMMARY
06/27/2019 imagesidewalk on Douglas
06/27/2019 image east entrance
06/28/2019 Letter INSPECTION SUMMARY
07/22/2019 Letter DE-Certificate of Substantial Completion Multiple Lot
07/22/2019 Letter DE-Punch List
11/06/2020 OV Site Development - Maintenance Bond - Turn Lane & Sidewalk
11/06/2020 OV Site Development - Maintenance Bond - Turn Lane & Sidewalk
11/06/2020 GC Final Lien Waiver 7.8.19
11/06/2020 Letter DE-Certificate of Final Acceptance (Commercial)
11/06/2020 Oakview Storage -Turn Lane Final Acceptance
12/22/2020 Oakview Storage-Sanitary Sewer and Sidewalk Final Acceptance
12/30/2020 Plans 2020-12-29-17-135 TURN LANE AS-BUILT
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
