Summary

PRSUBD20183647
Public Infrastructure
Final Completion
CITY OF LEES SUMMIT
DEVELOPMENT COMPLETE

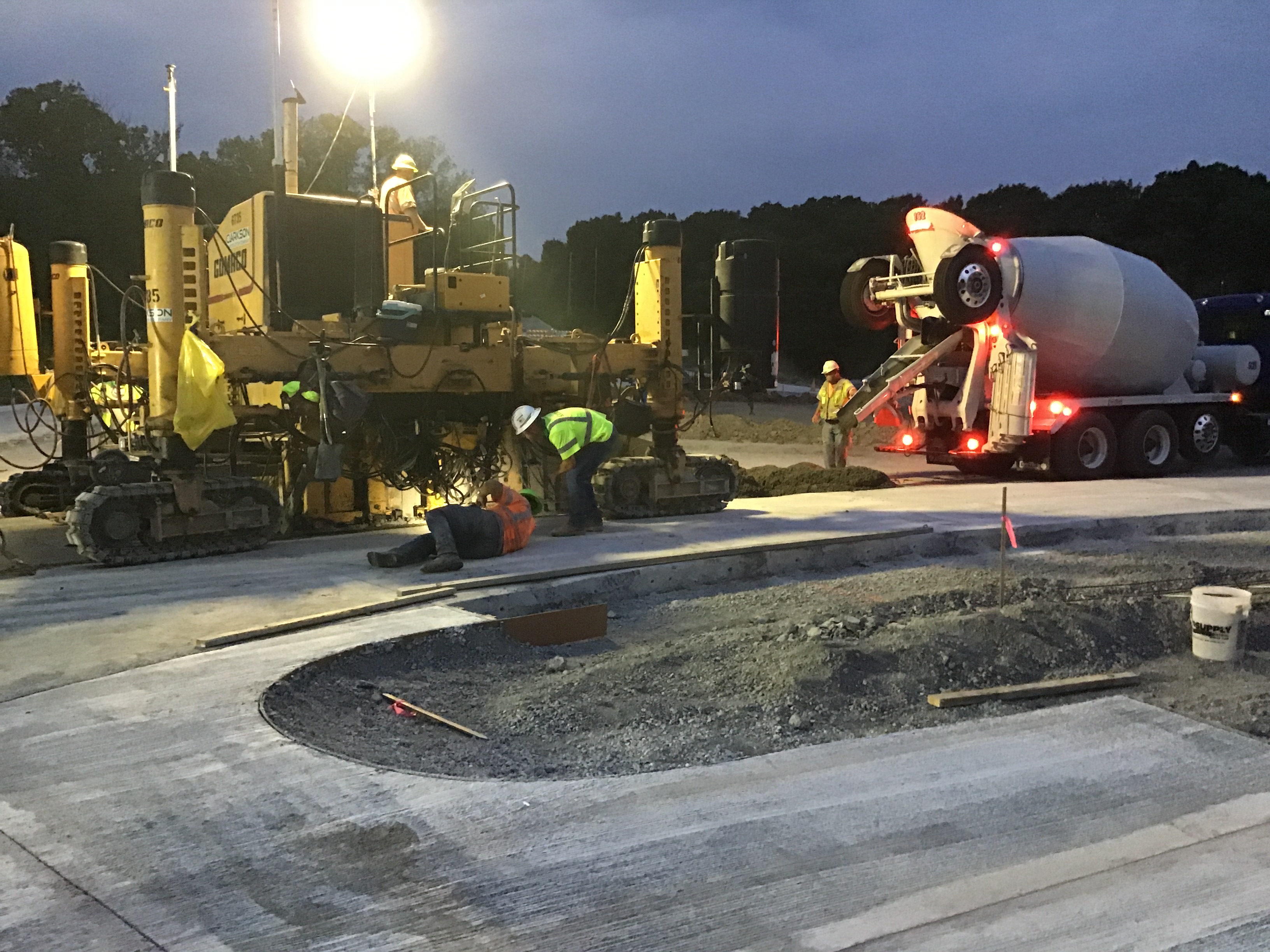

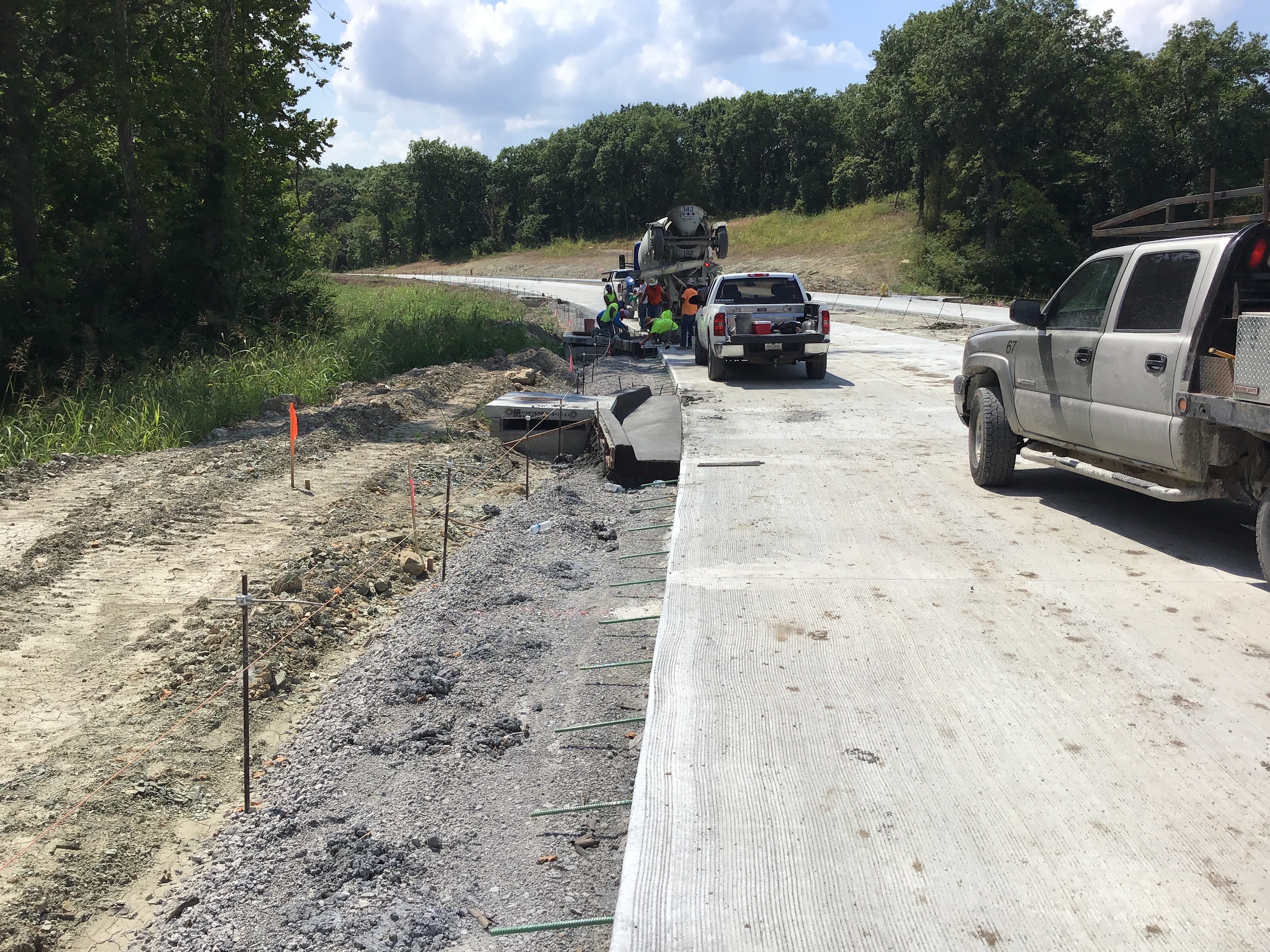

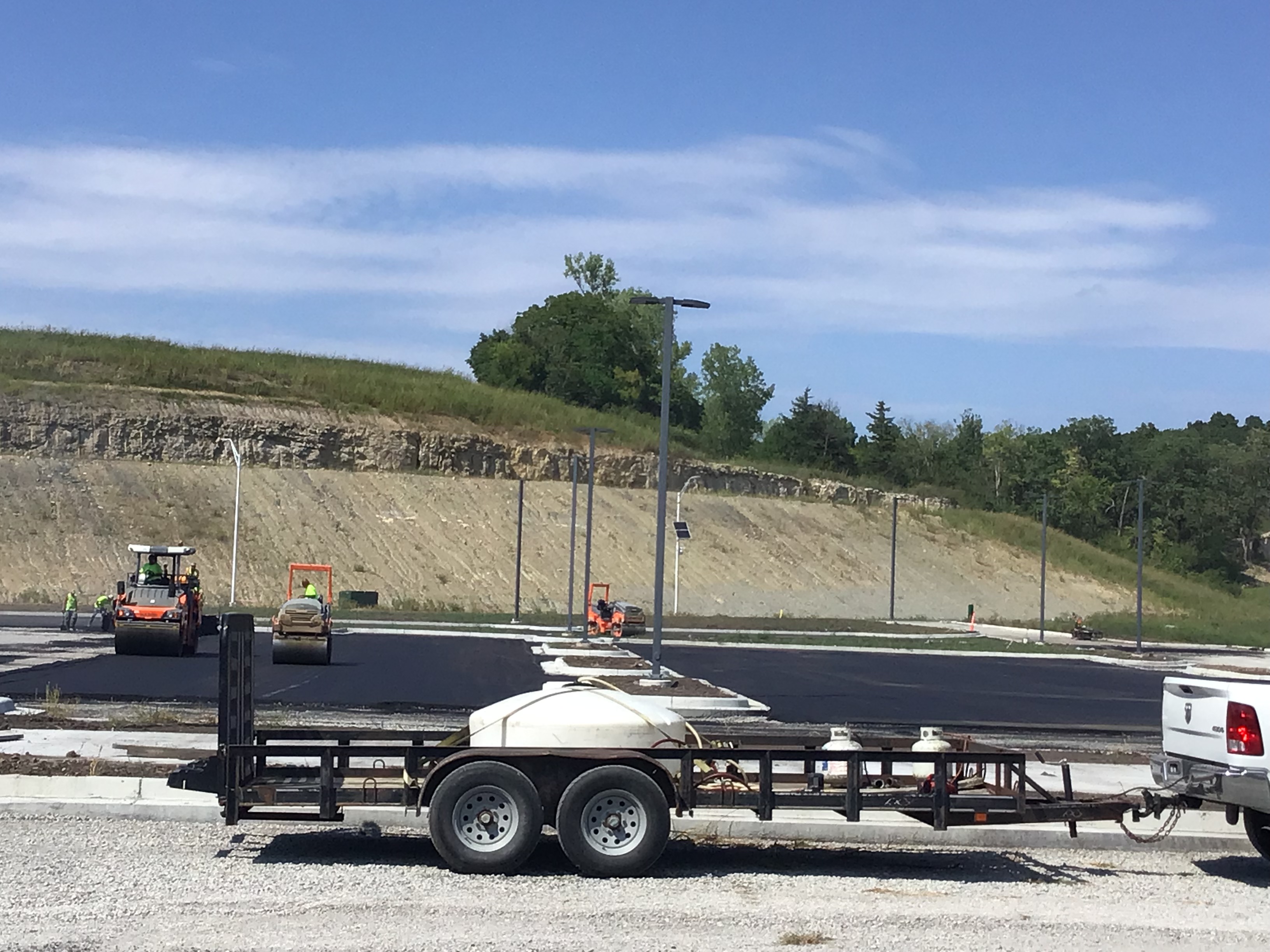

PUBLIC STREETS, STREET LIGHTING, STORMWATER AND MASS GRADING. STREETS INCLUDE VIEW HIGH DR, VIEW HIGH PKWY AND RIVER RD

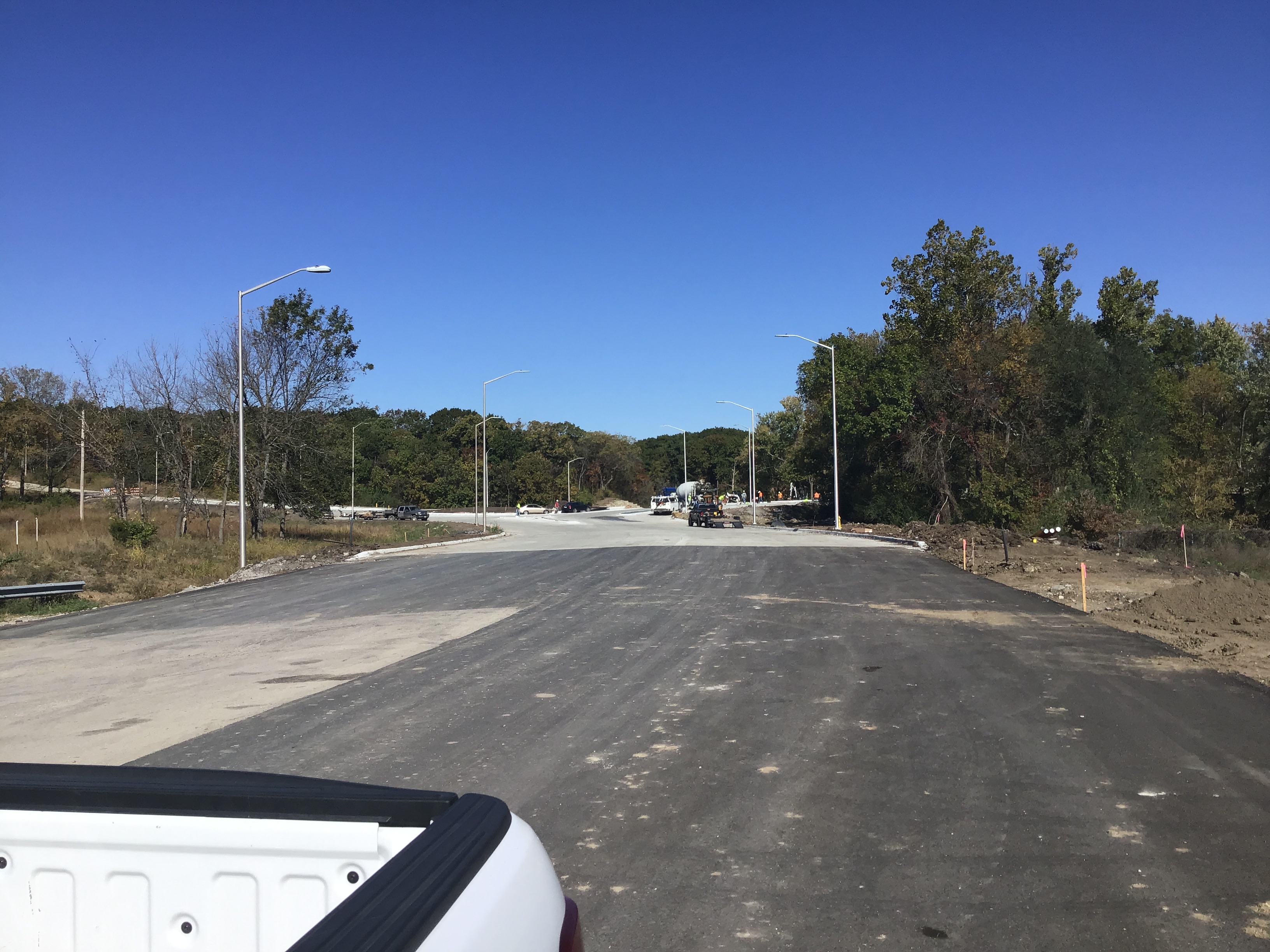

10/23/2018
01/28/2019
03/13/2025
Locations
Contacts
CITY OF LEES SUMMIT, Address:PO BOX 1600
PBAJ MANAGEMENT, LLC, Address:801 NW COMMERCE DR
Reviews
Review Type Outcome Est. Completion Date Completed

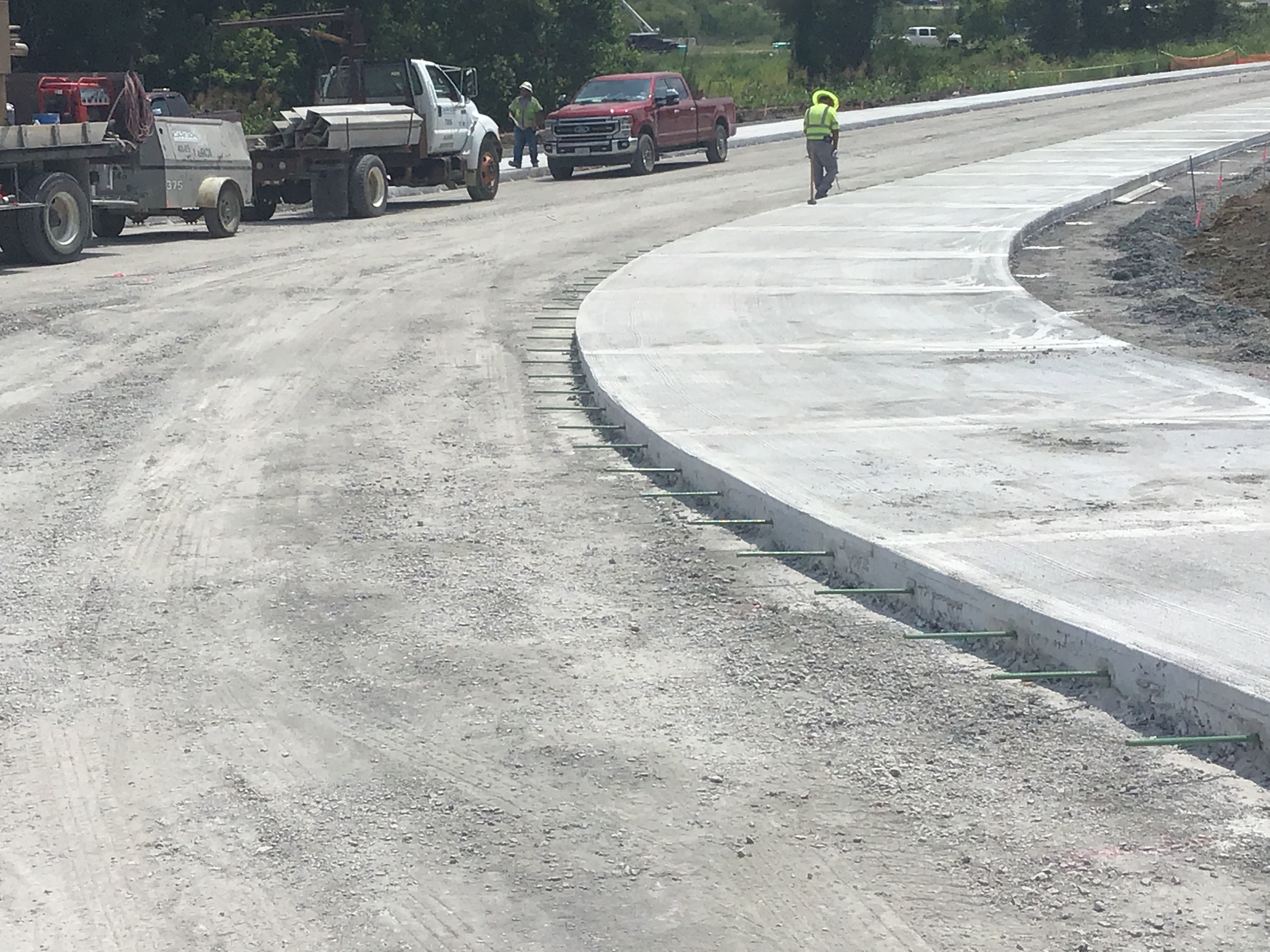

Licensed Contractors Approved 10/23/2018 03/25/2020
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
91100C8-Sanitary Sewer Insp Fees $13,451.58 $13,451.58 Paid 10/23/2018
9110071-Site Grading Fee $57,192.73 $57,192.73 Paid 10/23/2018
$57,192.74
9110068-Storm Fee $16,824.59 $16,824.59 Paid 04/06/2020
$30,276.17
9110071-Site Grading Fee $9,795.59 $9,795.59 Paid 04/09/2020
$66,988.32

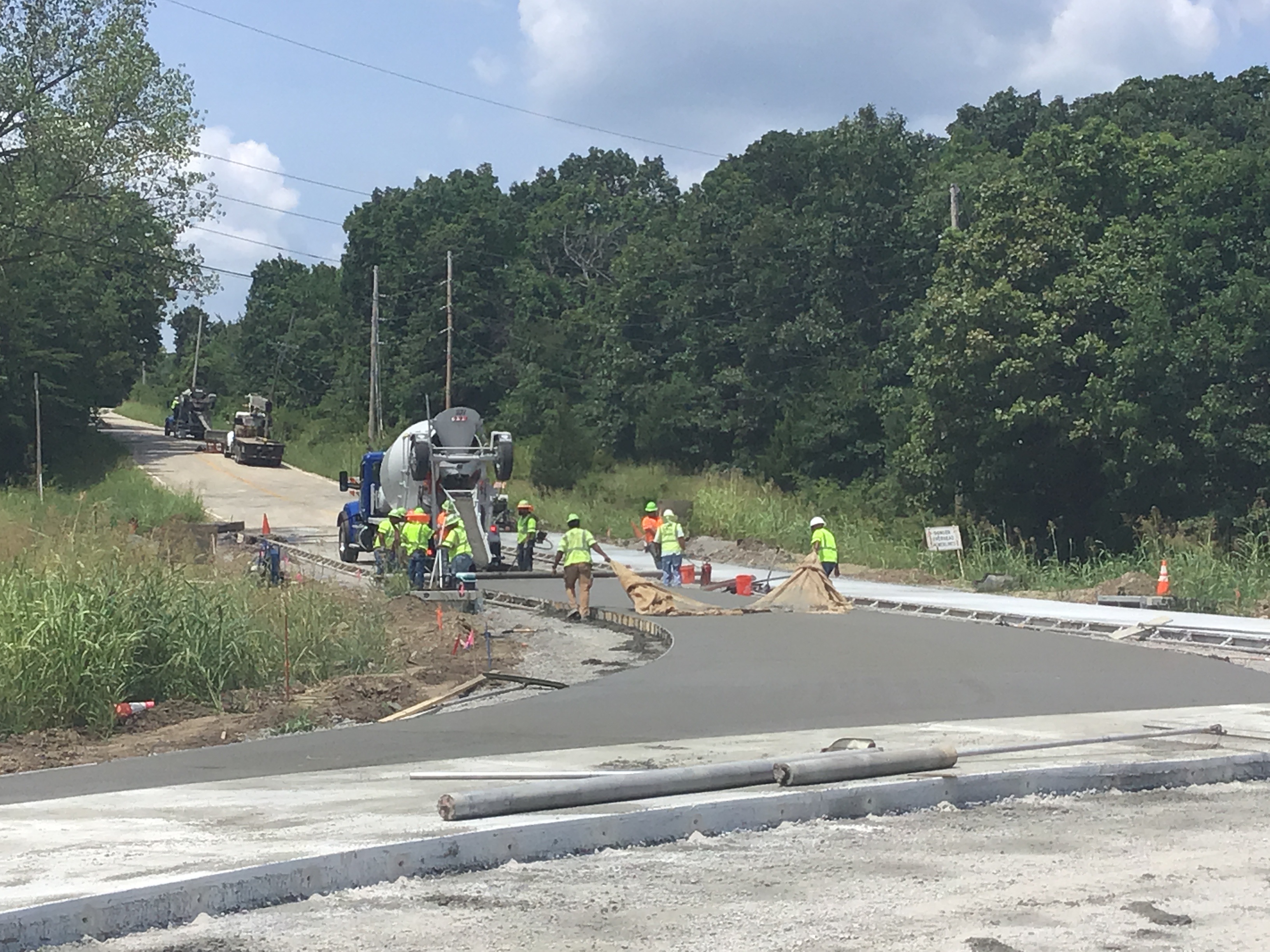

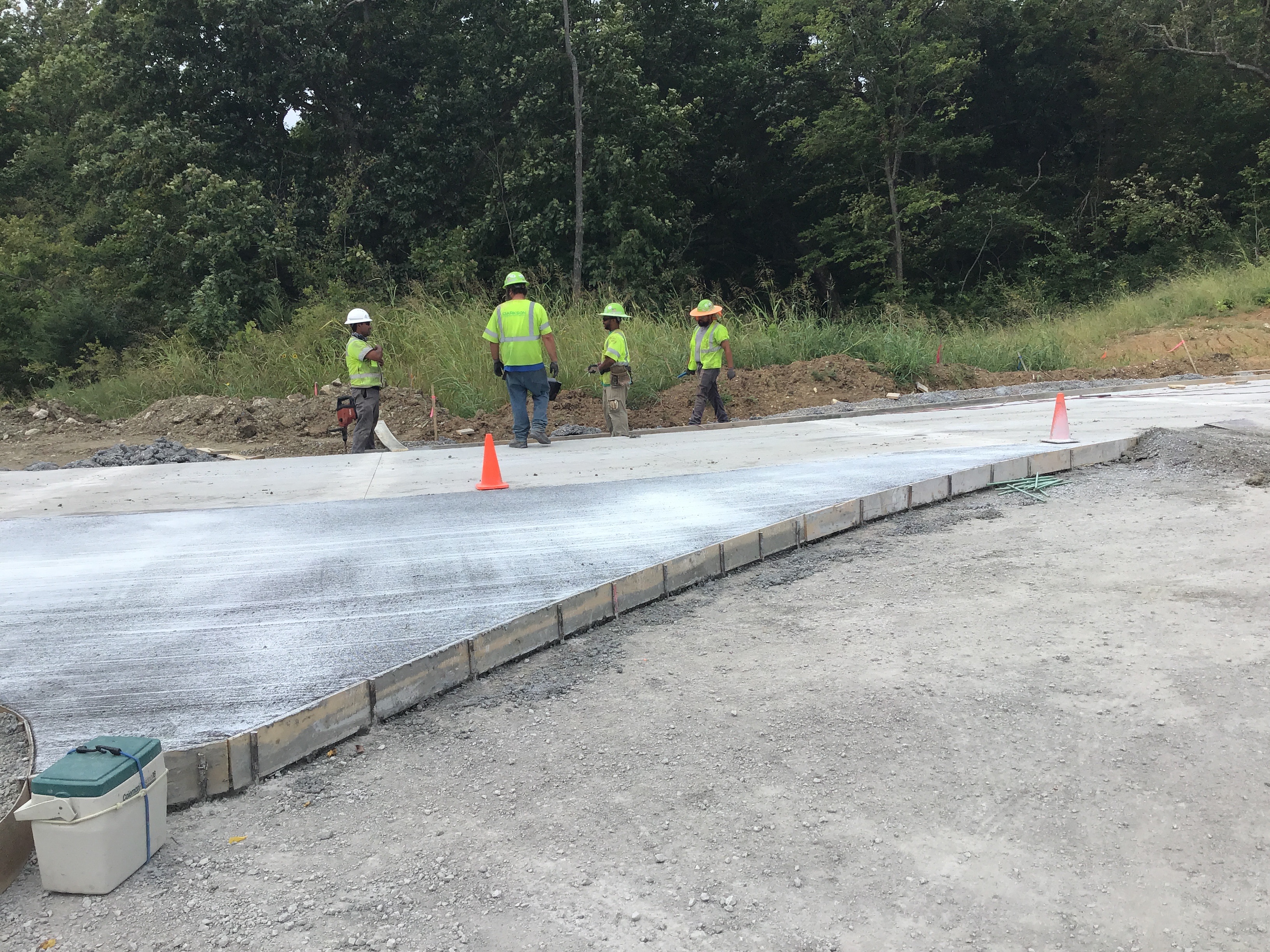

9110081-Paved Surface Inspection Fee $62,461.35 $62,461.35 Paid 10/09/2020
9110071-Site Grading Fee $8,341.87 $8,341.87 Paid 10/09/2020
$75,330.19
9110068-Storm Fee $13,811.55 $13,811.55 Paid 10/09/2020
$43,817.70
Outstanding Fees Amount Paid Owing Date Paid
9110069-After Hours Inspections (Public Works)(Per Hour) $425.00 $0.00 $425.00 Not Paid

$425.00    Add Fees to My Cart
Inspections
Inspection Outcome Requested Scheduled Date Inspected

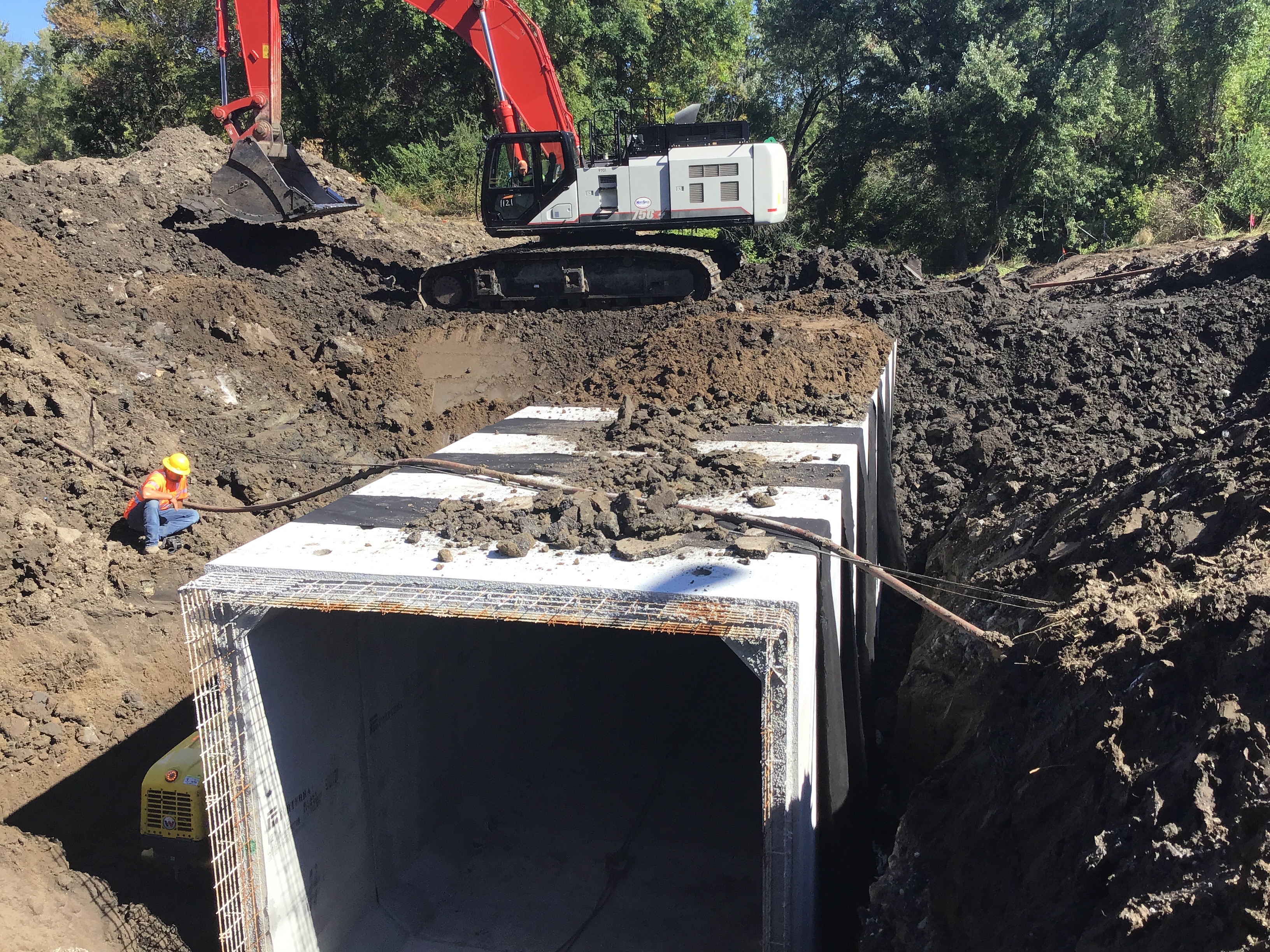

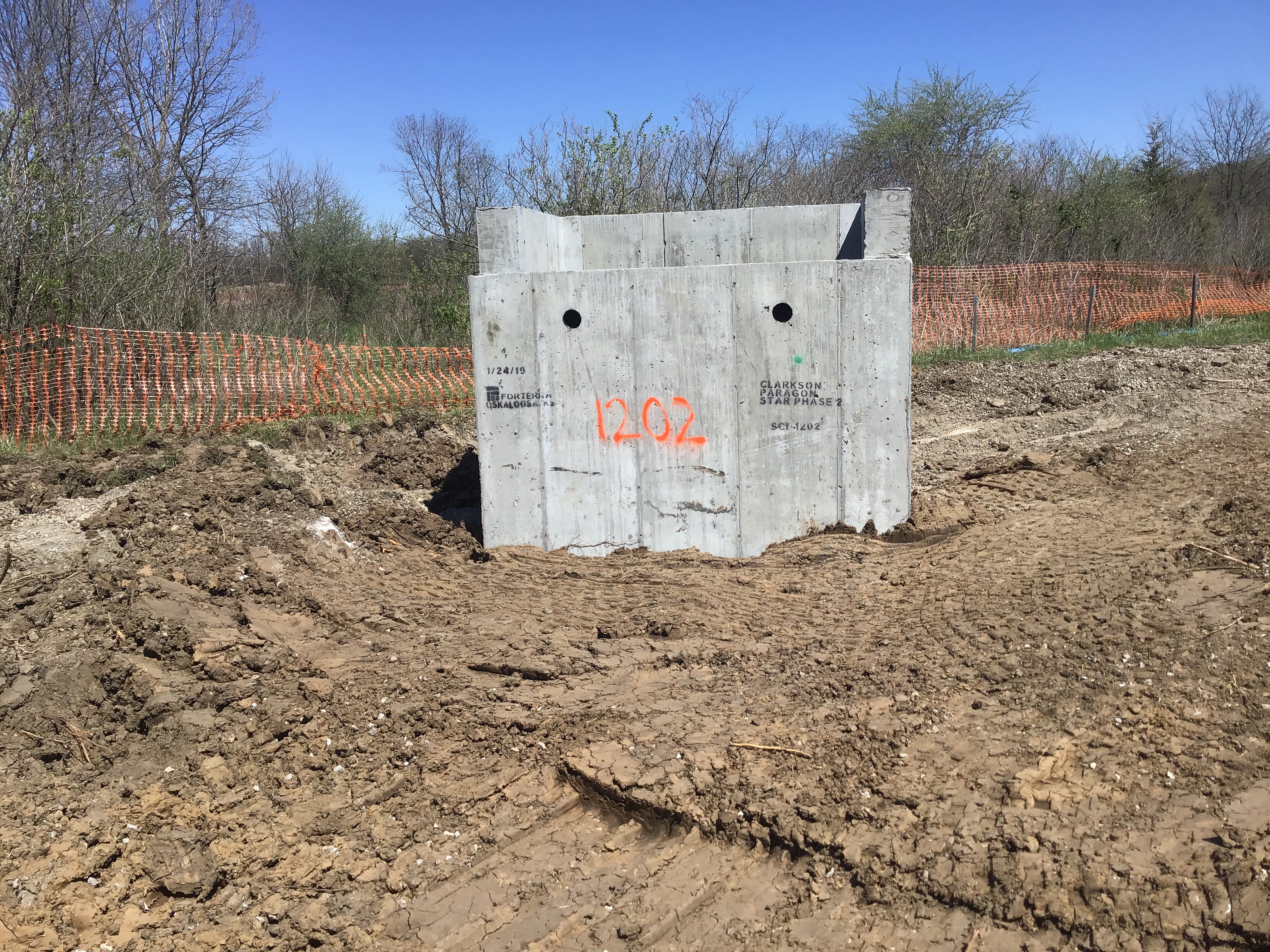

Storm - Pipe Partial 3/26/2019 03/27/2019
Informational
03/27/2019

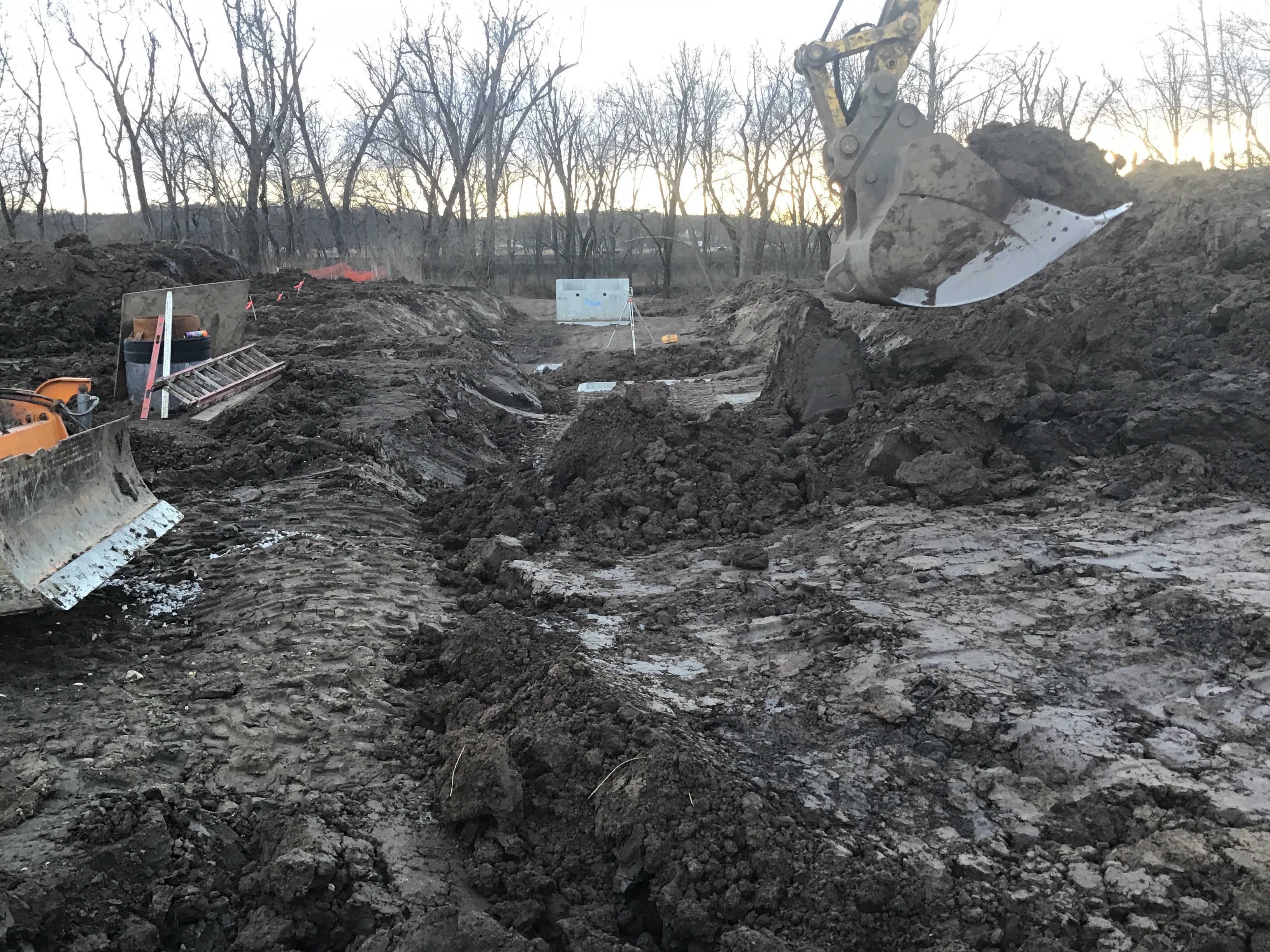

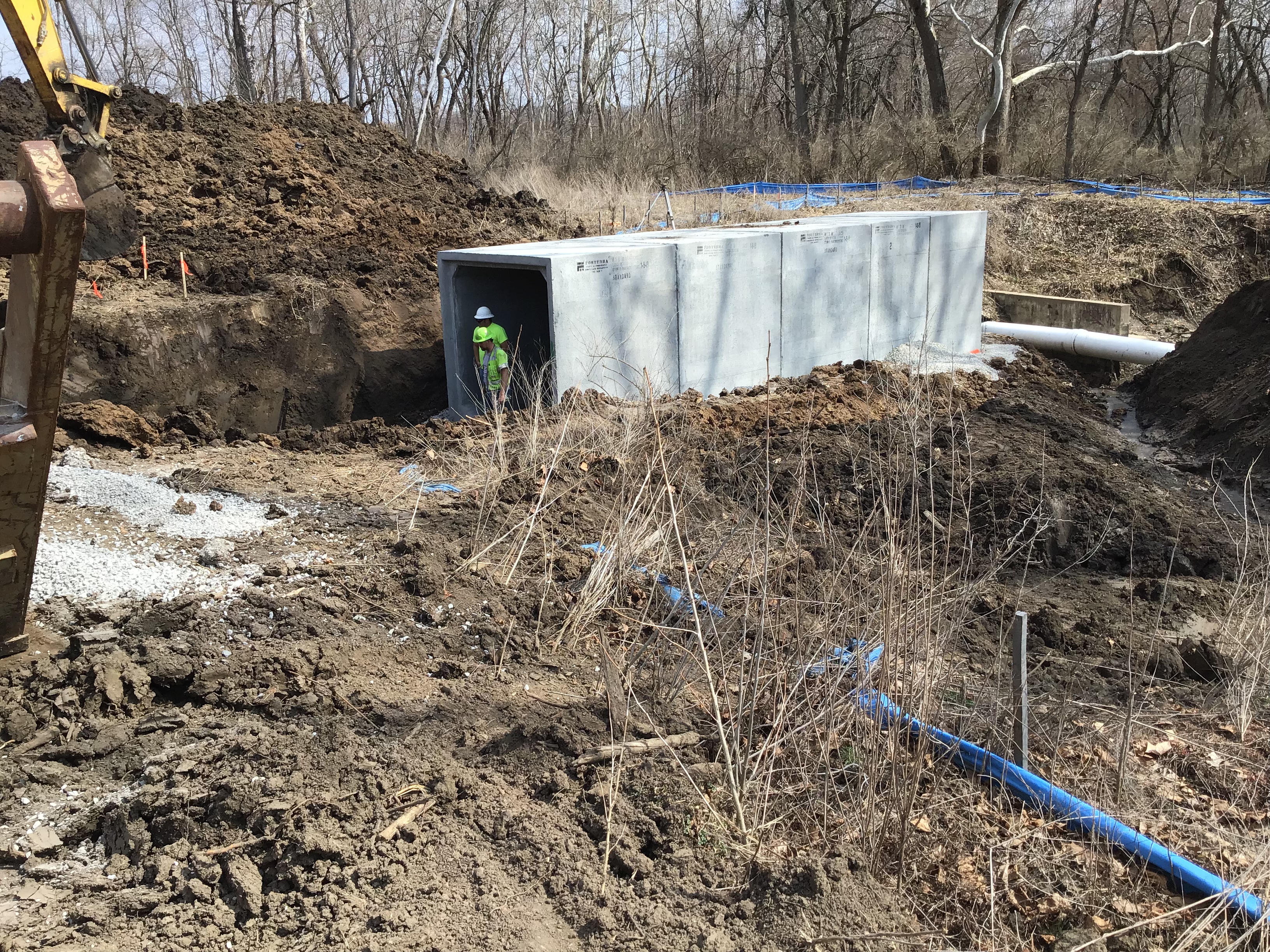

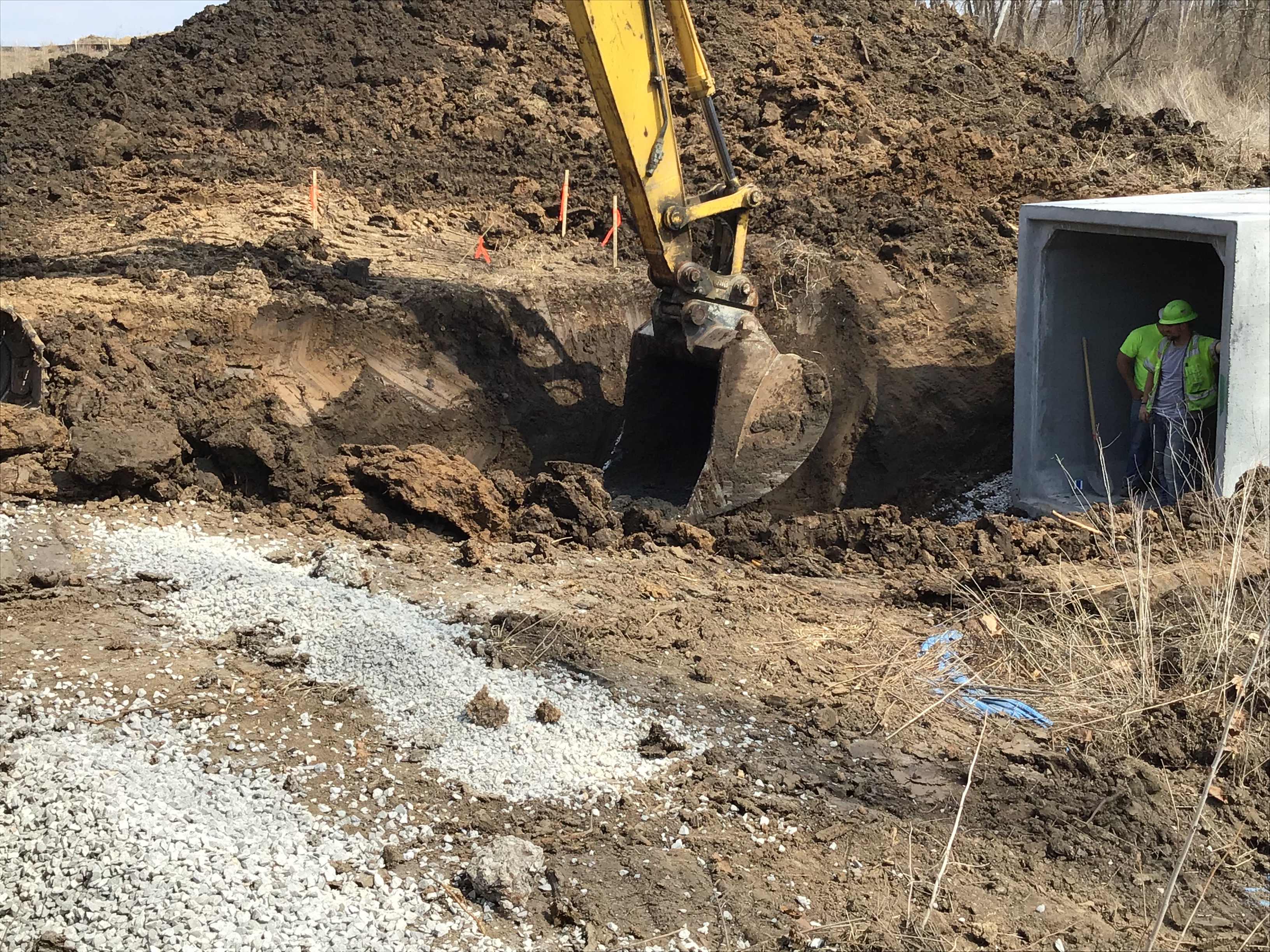

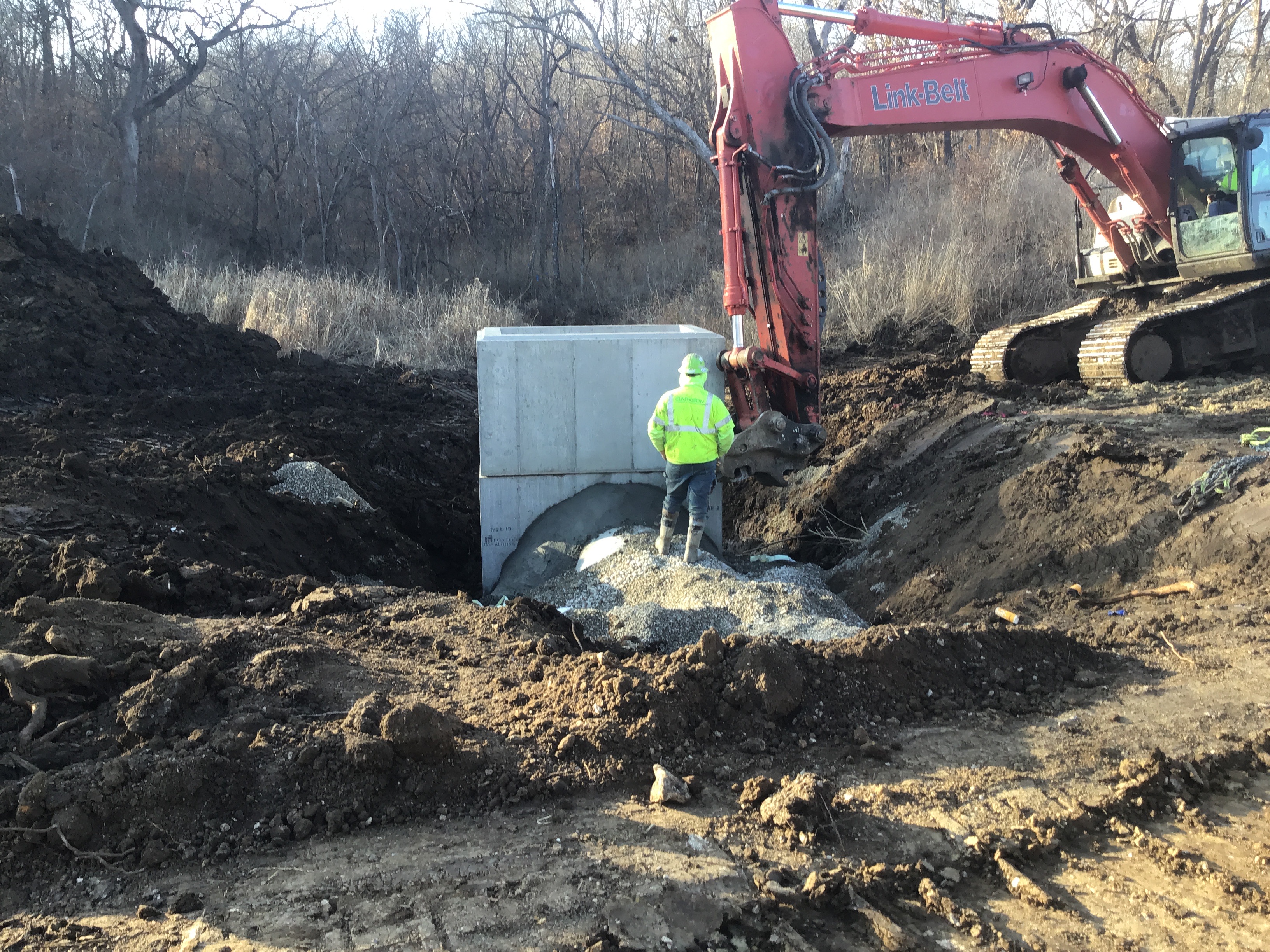

Contractor installed Approximately 60' of RCB PreCasted Conrete 8'X8' storm piping. Which includes 15 & 35 degree bends.

Storm - Material Verification Passed 3/26/2019 at 11:00 AM 03/27/2019
Misc
Informational
03/27/2019
All the materials appear to be correct.
Storm - Pipe Partial 3/27/2019 03/27/2019
Storm - Pipe Partial 3/27/2019 03/27/2019
Informational
03/27/2019
Cotractor had to reset RCB concrete due to incorrect sequencing of precast concrete storm line 300. Contractor appeared to have reestablish with stake center line. Last documented observation on project by inspector was 35 Degree bend @ Sta 1+54.93. John Jackson 03/27/2019 3:34 PM

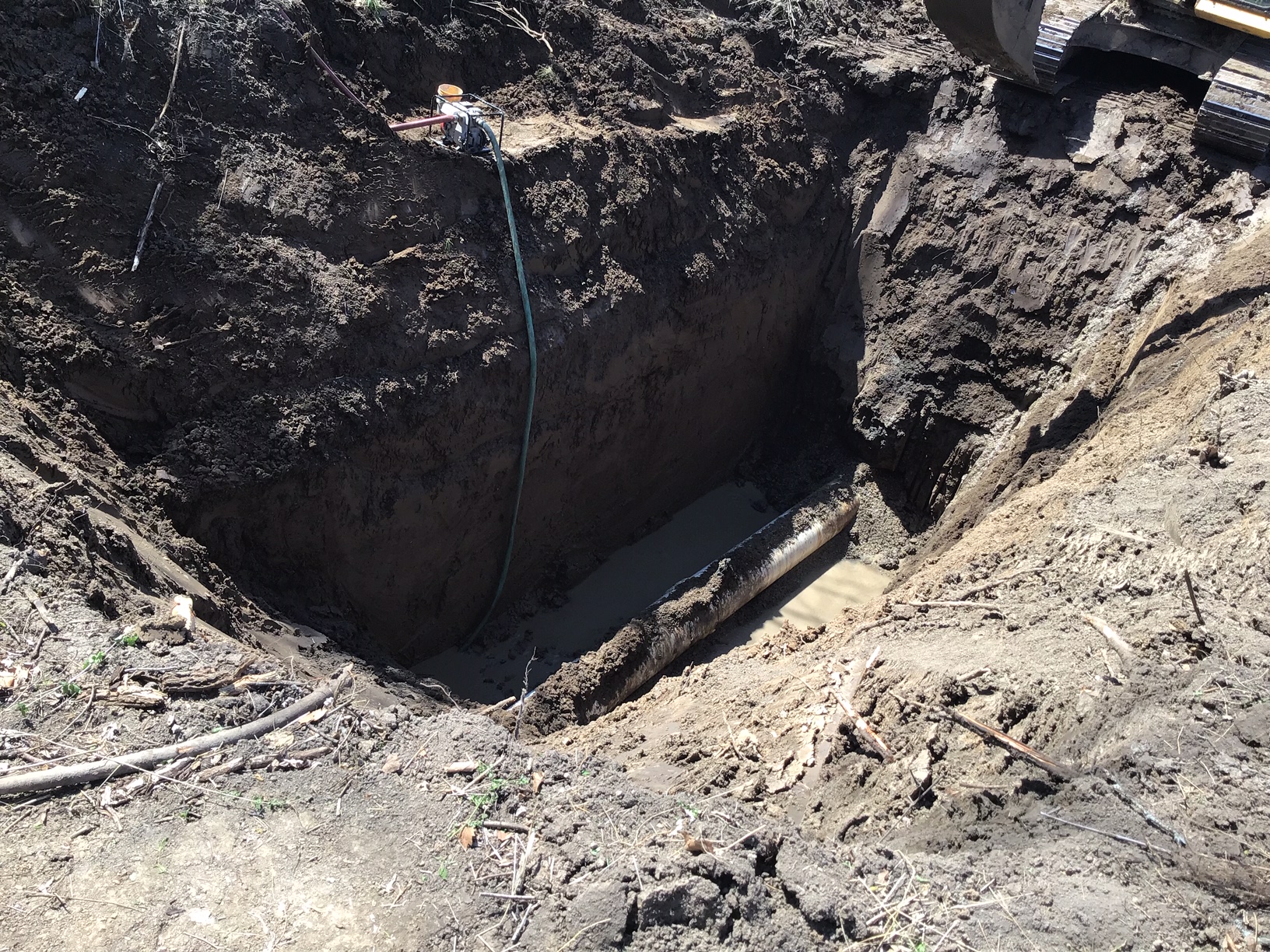

Storm - Pipe Partial 4/1/2019 04/01/2019
Informational
04/01/2019

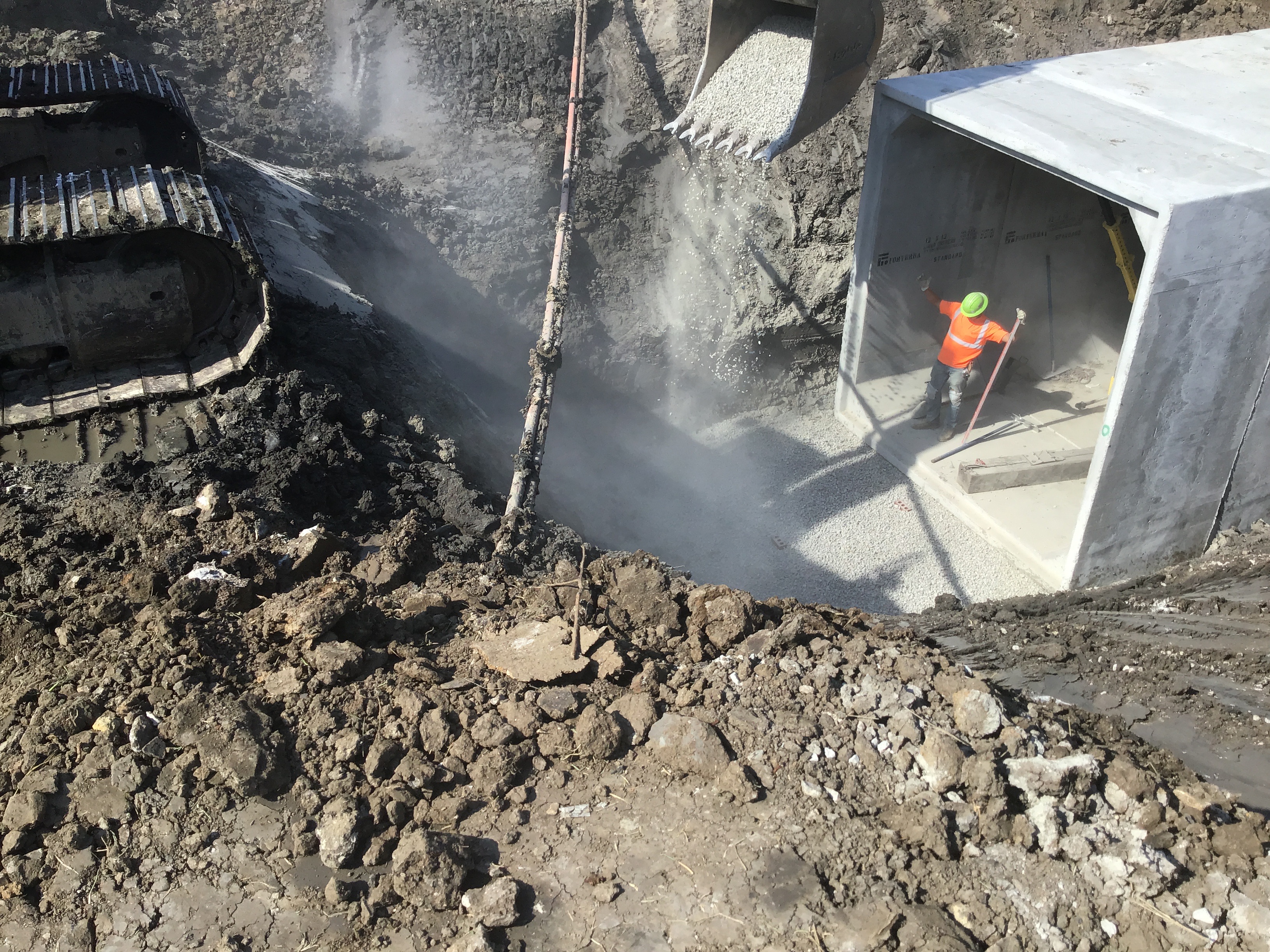

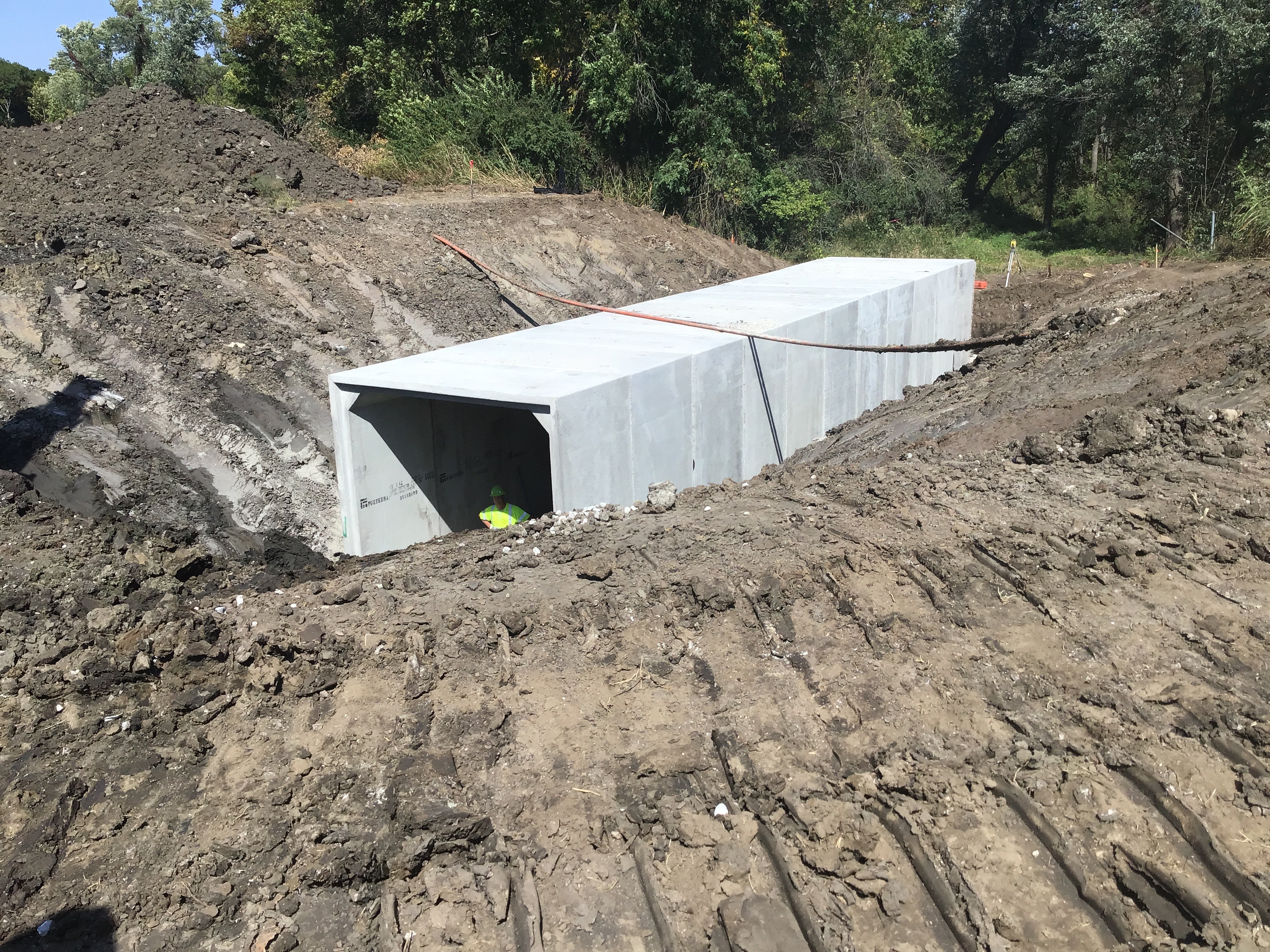

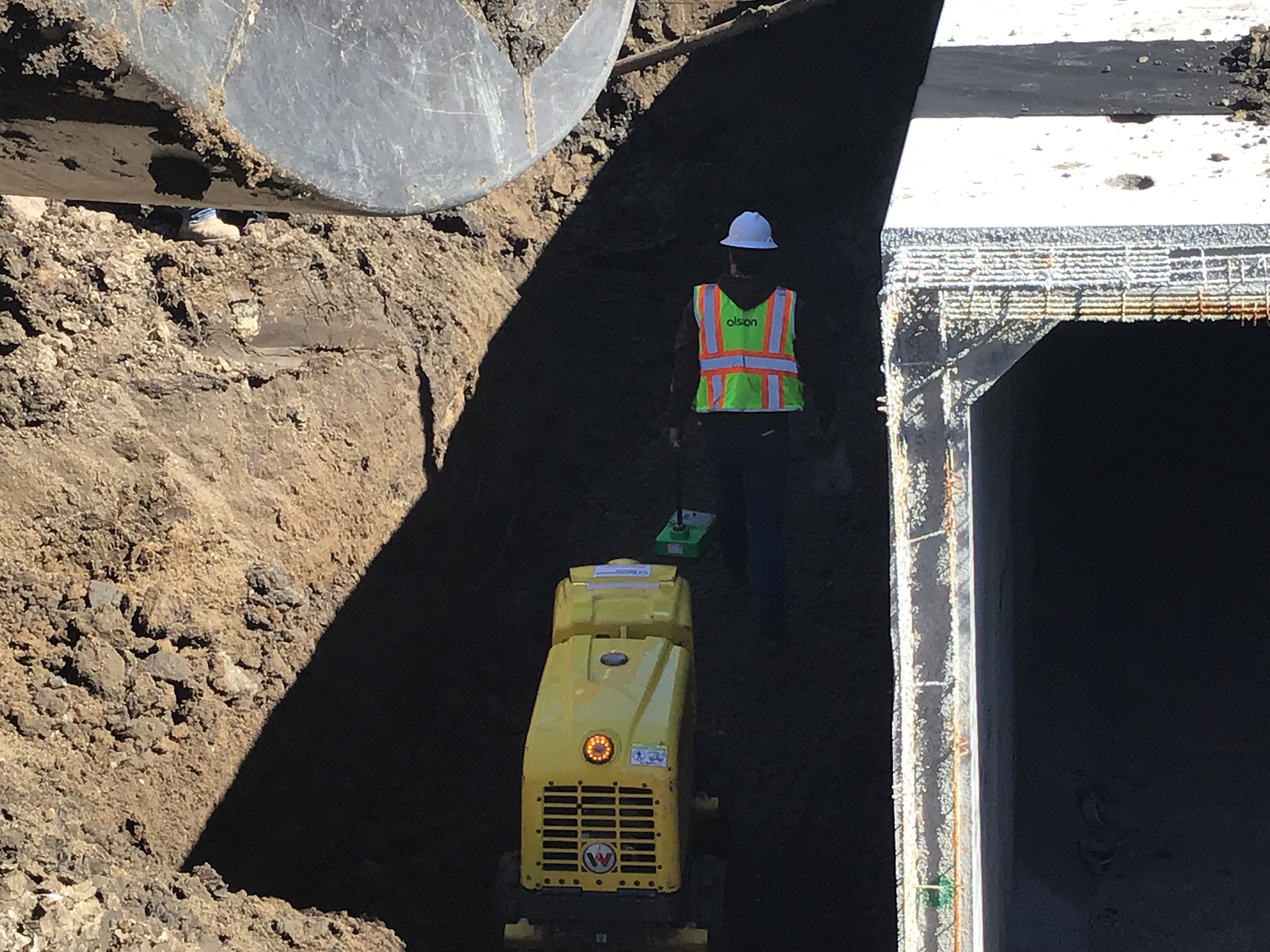

Contractor has installed approximately 140' of 8'x8' RCB storm sewer pipeline. Contractor meet with Plan Engineer & manufacture and found that bends (15 & 35 degree bends) were off roughly 5 degrees overall. Plan Engineer determine that the tolerance was still acceptable. Contractor comtinued installing storm line after I left site at approximately 2:15 pm. John Jackson 04/01/2019 3:55 PM
Storm - Pipe Partial 4/2/2019 04/02/2019
Informational
04/02/2019
Contractor began the backfilling of 8'X8' RCB concrete storm sewer line 300. Compaction lifts were tested by Olson. Contractor continued backfilling throughtout the work day. An issue arouse about the feasability of the Sanitary Line encasement and the Toe Wall installation as planned. Contractor plan to meet @ 7:30 am 4/3/19 onsite with their Engineer to discuss a plan of action. I have videos and pictures of the sanitary sewer main, waterway and stakes (limit, toe wall, & center line) John Jackson 04/02/2019 4:14 PM
Site Visit Failed 4/3/2019 at 3:00 PM 04/03/2019
Miscellaneous Correction
Corrective Action Required
04/03/2019
I spoke with Casey Williams from Fogel Anderson and let him know that they needed to stop work and remove all the rip rap that was installed as a crossing in the Little Blue River. As per an application that was filled out there is not suppose to be any work in the Flood way at this time until all permits have been approved. We have also requested that the flood way be staked out and marked in some way so we know that work is not being done in it. The contractor said he was going to keep working and try to get things figure out in the next few days. I spoke with Dan and he called Casey and he has now agreed to remove crossing and he is having a surveyor come out to stake the flood way. Steve Robbins 04/03/2019 4:52 PM
Storm - Pipe Partial 4/4/2019 04/04/2019
Informational
04/04/2019
Clarkson Construction Company installed approximately 120' of 72" RCP storm pipe on Line 500. Tree and brush were cleared where needed and gravel bedding was placed to install line. Ground condtion were a little murky. Olsen was onsite for soil testing earlier in the work day. Issues came up about the contractor operating in the floodway. It was found that the contractor was in violation. Casey Williams Senior Superintentdent Fogel Anderson Construction (Primary Contractor) was told that operation were to cease until violation of plans were corrected. See Steve Robbins Site Visit for details on 4/3/19
Site Visit Failed 4/4/2019 04/04/2019
Informational
04/04/2019
Talked with Casey Williams of Fogel-Anderson Construction along with my Supervisor Steve Robbins. We reinterated that no work or construction should be done in the Floodway As per Lee's Summit permit until all related permits and associated entities have been approved and cleared. Casey Williams was instructed to remove construction bridge which is in the Floodway. Please refer to Steve Robbins Site Visit 4/3/19 and 4/4/19. I took additional pictures and video of construction bridge that is in violation of Permit that no work or construction be done in the Floodway at this time.
Site Visit Failed 4/4/2019 04/04/2019
Resolved
04/08/2019
See Steve Robbins Inspection and John Jacksons prior Failed reports. A Stop Work Order is being issued.
Site Visit Failed - Stop Work 4/4/2019 04/04/2019
Miscellaneous Correction
Corrective Action Required
04/03/2019
I spoke with Casey Williams from Fogel Anderson and let him know that they needed to stop work and remove all the rip rap that was installed as a crossing in the Little Blue River. As per an application that was filled out there is not suppose to be any work in the Flood way at this time until all permits have been approved. We have also requested that the flood way be staked out and marked in some way so we know that work is not being done in it. The contractor said he was going to keep working and try to get things figure out in the next few days. I spoke with Dan and he called Casey and he has now agreed to remove crossing and he is having a surveyor come out to stake the flood way. Steve Robbins 04/03/2019 4:52 PM
Misc
Corrective Action Required
04/04/2019

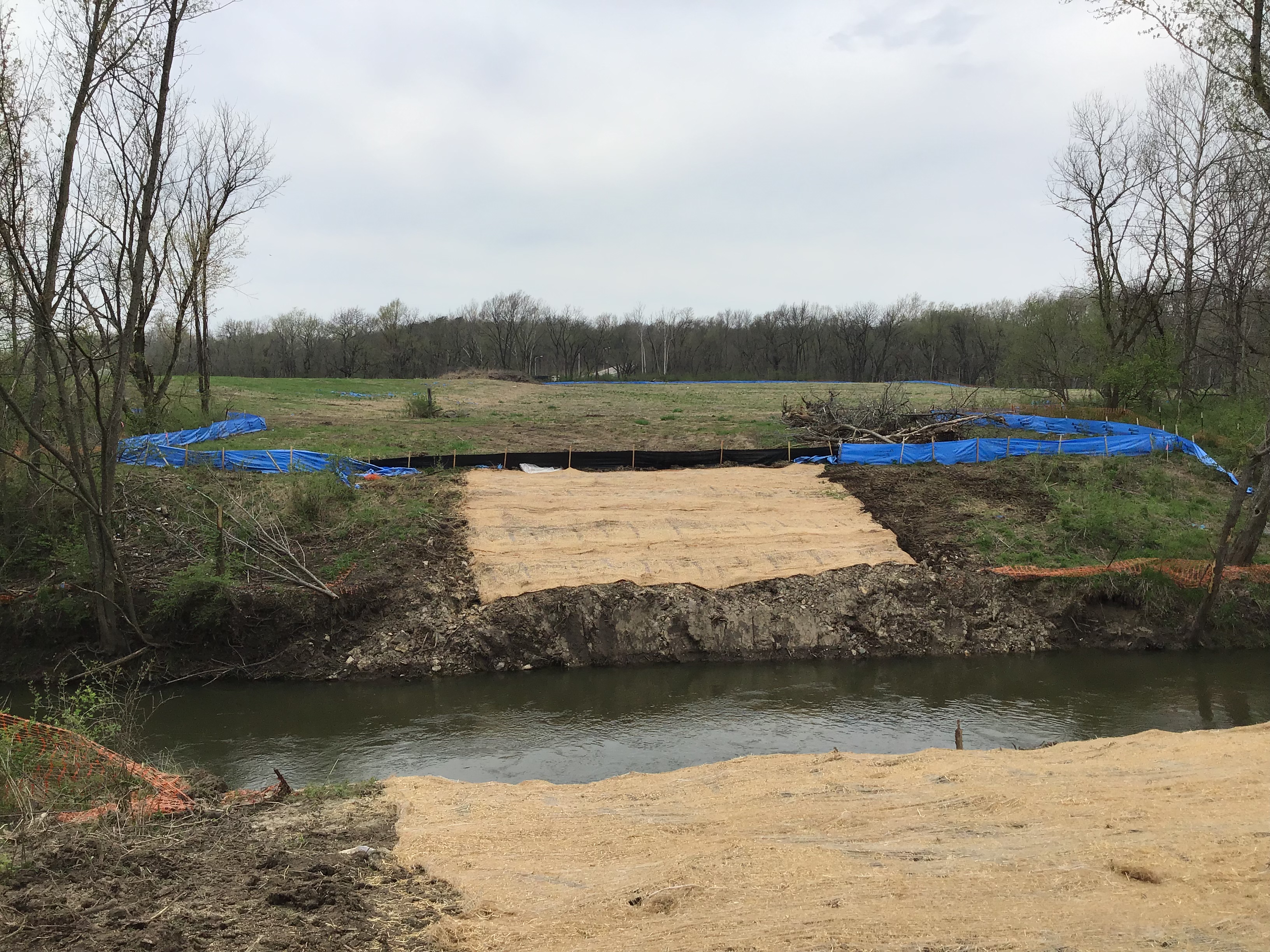

Stream crossing in Little Blue River must be removed prior to any other work occuring on site. Dan Harper 04/04/2019 3:52 PM
Site Visit Partial 4/5/2019 04/05/2019
Resolved
04/08/2019
Contractor contacted @ 2:25pm via cellphone they had completely removed unauthorized bridge. Contractor is aware that all excavation must be placed outside the Floodway. Contractor was staking Storm lines 300, 500, and 700 to mark the Floodway boundaries while I was onsite. Full clearance will be given when after I visual inspect site 4/8/19 to ensure full compliance with permit regulation. I took pictures and video of site 90% of the removal was done when left the site at 2:00pm.
Site Visit Complete 4/8/2019 at 7:00 AM 04/08/2019
Miscellaneous Correction
Informational
04/08/2019
The crossing in the Little Blue has been removed. All equipment and debris has also been removed from the floodway. The contractors will not be working in the floodway and when they are near the floodway it will be staked and marked so it is clear as to where they need to be. As of now this is putting an end to the Stop Work Order.Steve Robbins 04/08/2019 9:47 AM
Miscellaneous PWORKS Inspection Passed 4/8/2019 04/08/2019
Miscellaneous Correction
Informational
04/08/2019
The crossing in the Little Blue has been removed. All rip rap and debris has been removed out of the flood way. Going forward no work will be done in the flood way and no equipment will be used or parked in the flood way. When working close to the flood way it will be clearly surveyed and stakes. The contractor has permission to resume work but not in the flood way. Steve Robbins 04/08/2019 11:36 AM

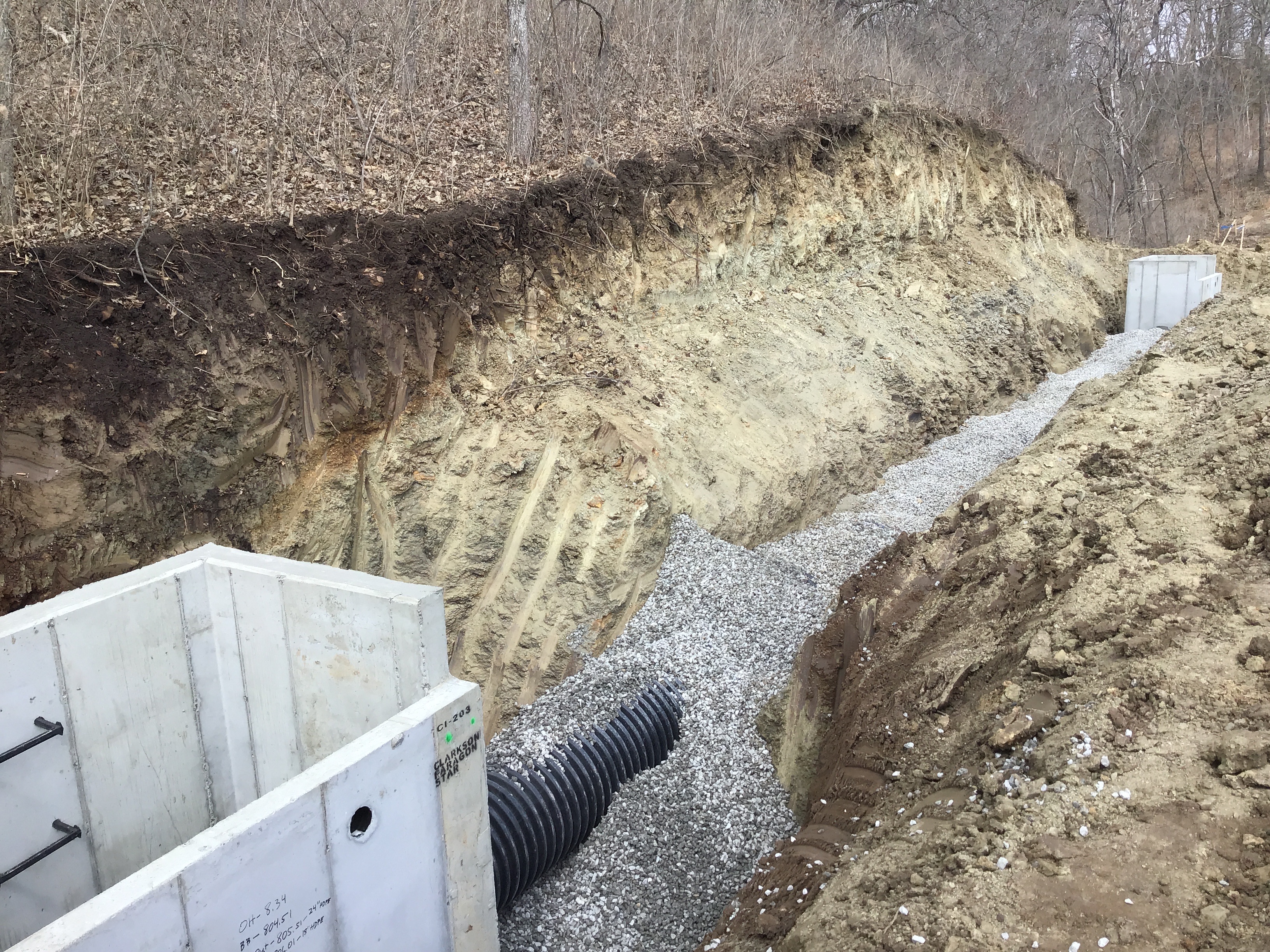

Storm - Pipe Partial 4/8/2019 04/10/2019
Informational
04/10/2019

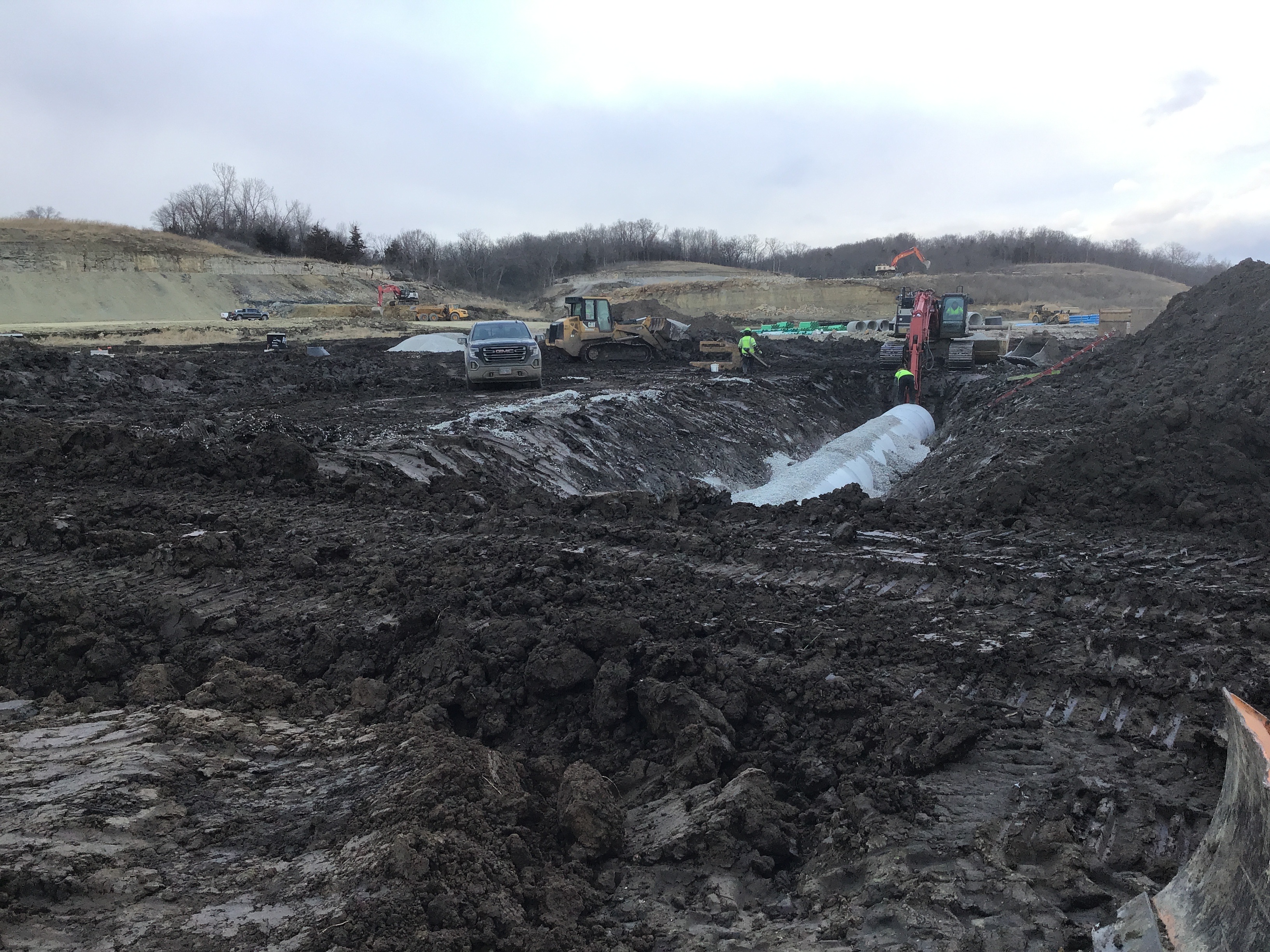

Contractor continued to work and finished laying the of Storm Line 500. Approximately 60' of piping was installed. Condition for the field were a little murky fromthe weekend rains. 4/8/19
Storm - Pipe Partial 4/9/2019 04/10/2019
Informational
04/10/2019
Contractor began backfilling Storm Line 500 and started the installation of the rip-rap at the exit point of the storm line. A temporary channel was built to divert water from storm line until it is placed in sevice.
Erosion Control Inspection Failed 4/8/2019 04/10/2019
Corrective Action Required
04/17/2019
Silt along the entire site was down. Reinstallation is to be perform in the next two days. 4/8/19
Erosion Control Inspection Partial 4/9/2019 04/10/2019
Corrective Action Required
04/10/2019

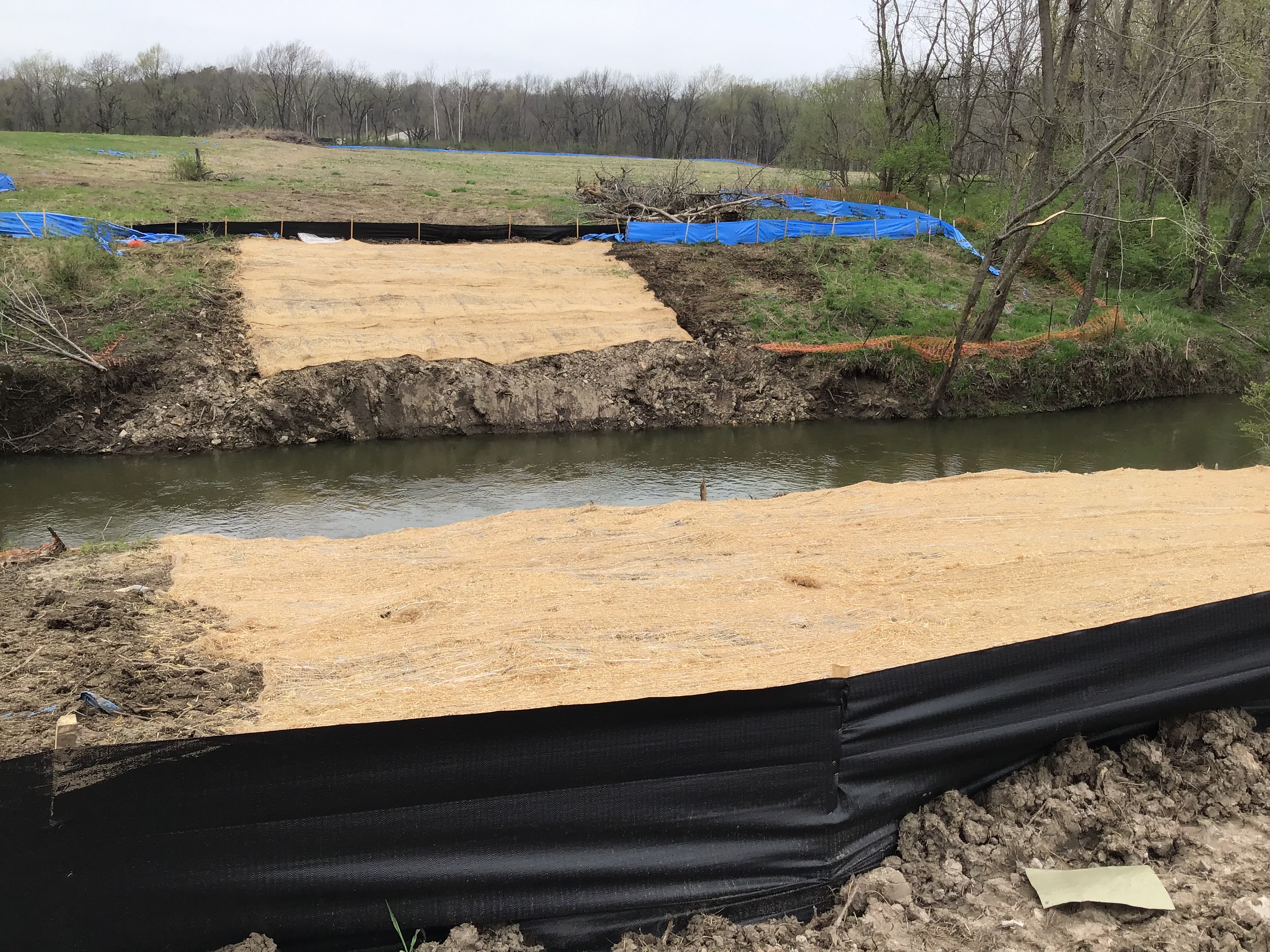

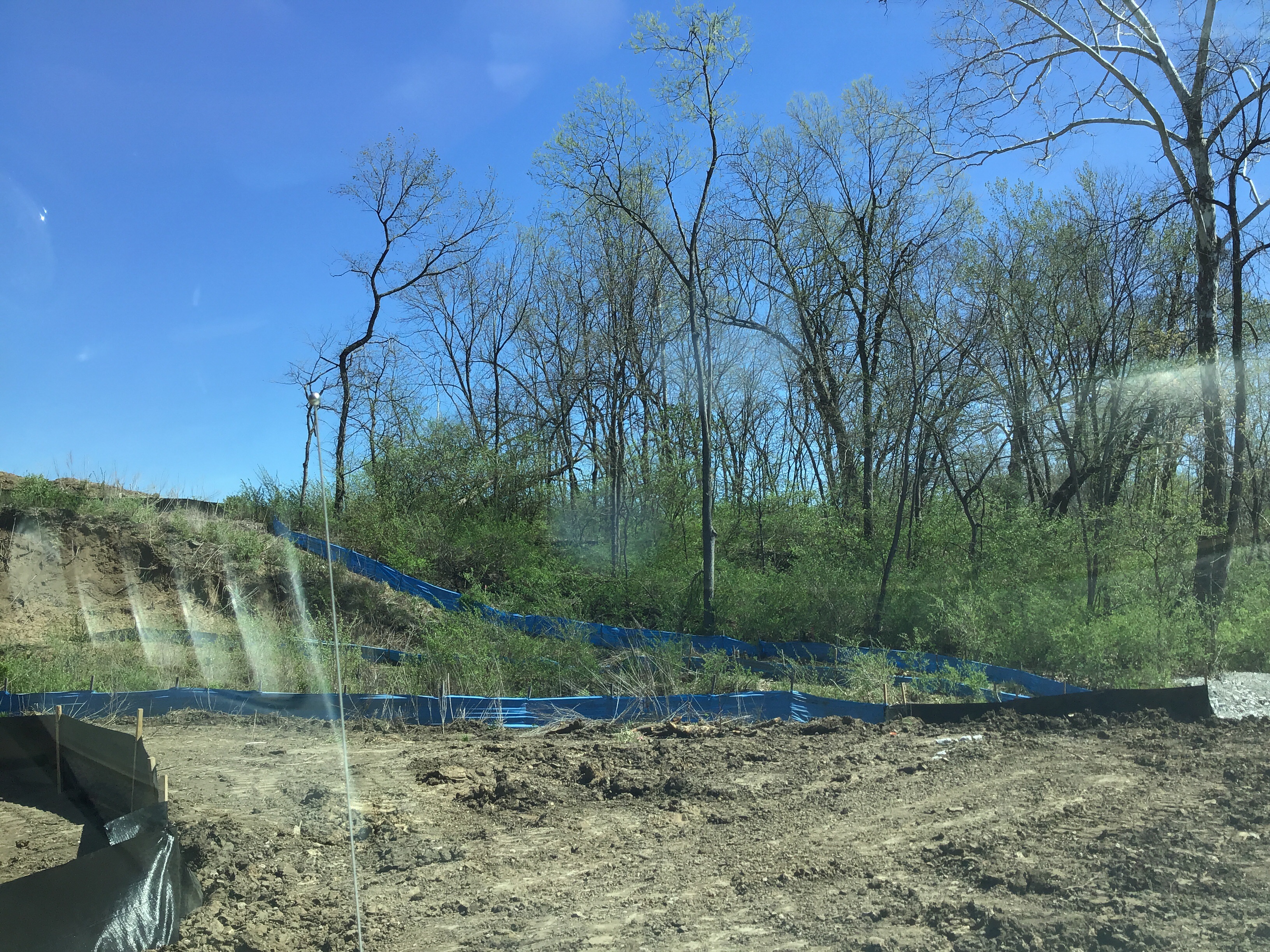

Contractor began prep for the laying of hay matting. on 4/10/19. Silt fence is still down throughout the job site. As per Casey Williams of Fogel- Anderson silt fencing will be reinstalled soon.
Erosion Control Inspection Partial 4/10/2019 04/10/2019
Corrective Action Required
04/10/2019
Matting was installed along river banks North & South sides. Contractor was unable to restore silt fencing. I talked with Casey Williams (Senior Superintendent) of Fogel - Anderson Construction I reminded him of the urgency for the silt fence to reinstalled fencing to protect against ersion into waterway. I will send a letter to stress that my expectation are that the fencing will be completely reinstalled by the close of business 4/11/9. John Jackson 04/10/2019 3:24 PM
Site Visit Complete 4/9/2019 04/10/2019
Informational
04/10/2019
During site visit it was noted by inspector that the River was high and cloudy. It appeared that the introduction of possible erosion was coming from upstream of project. Inspection of site revealed no evidence of erosion into waterway as per my inspection. Casey Williams asked that this be documented. 4/9/19 time apporoximately 12:30 pm.
Storm - Pipe Partial 4/11/2019 04/11/2019
Informational
04/11/2019

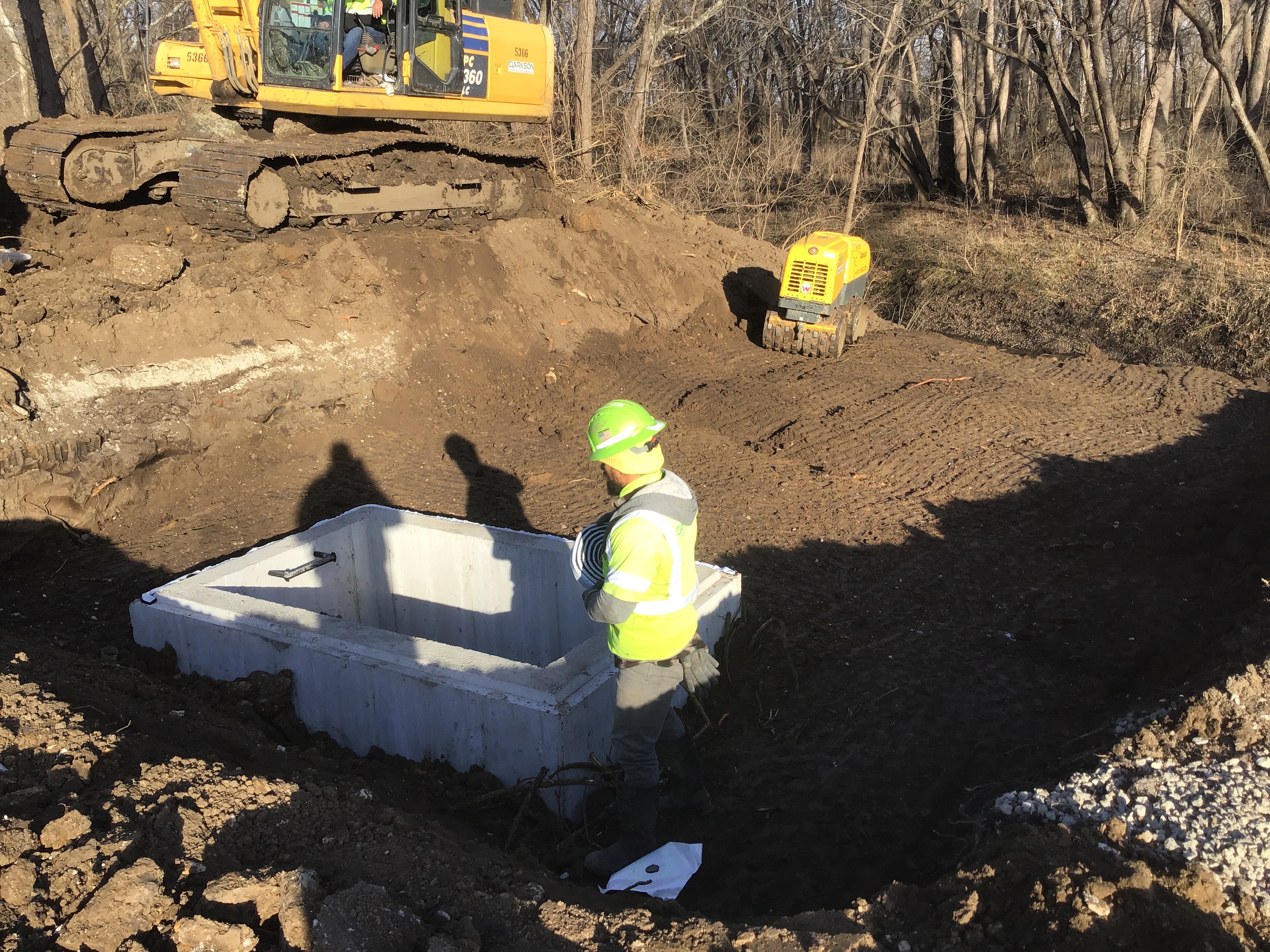

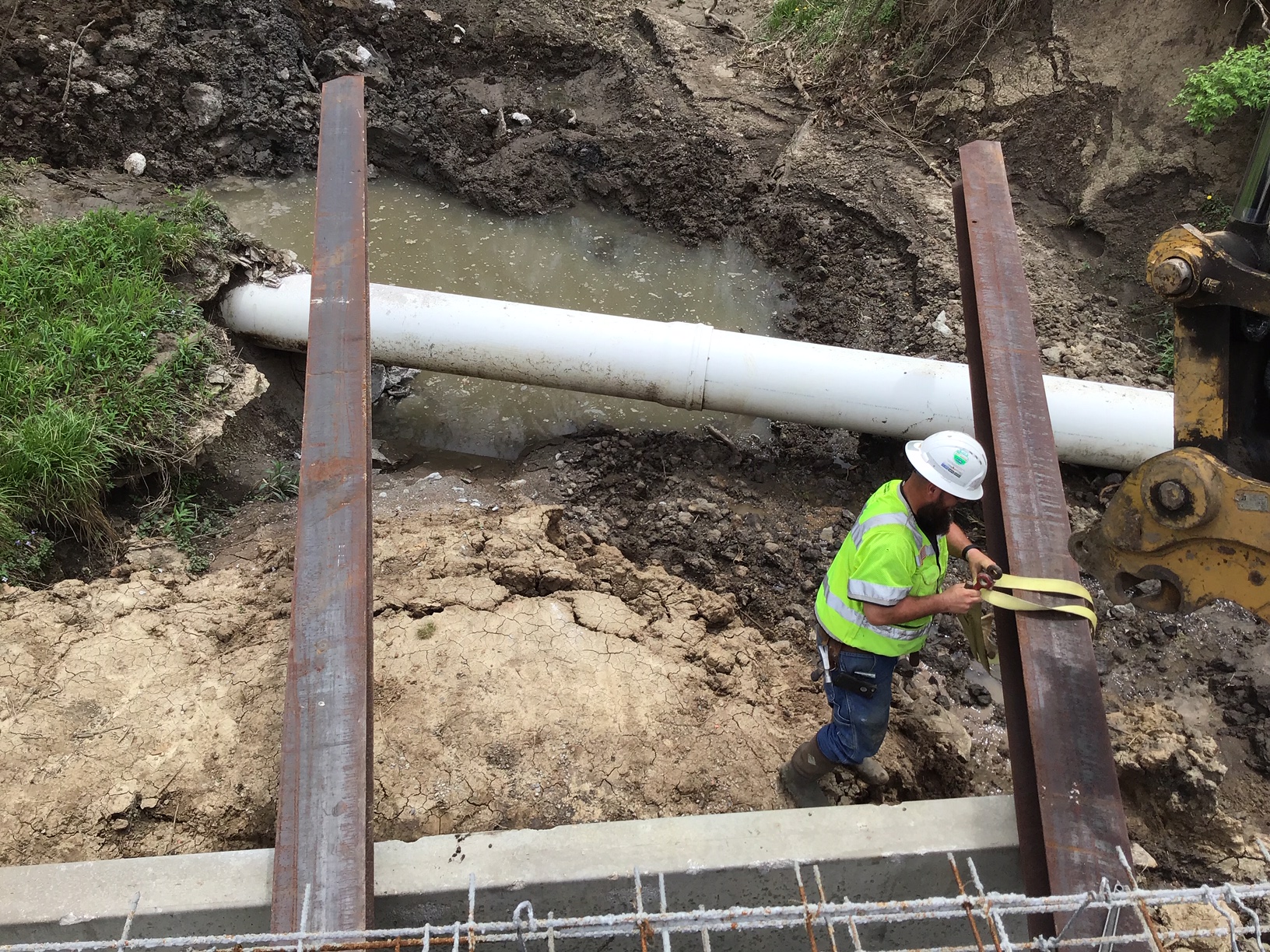

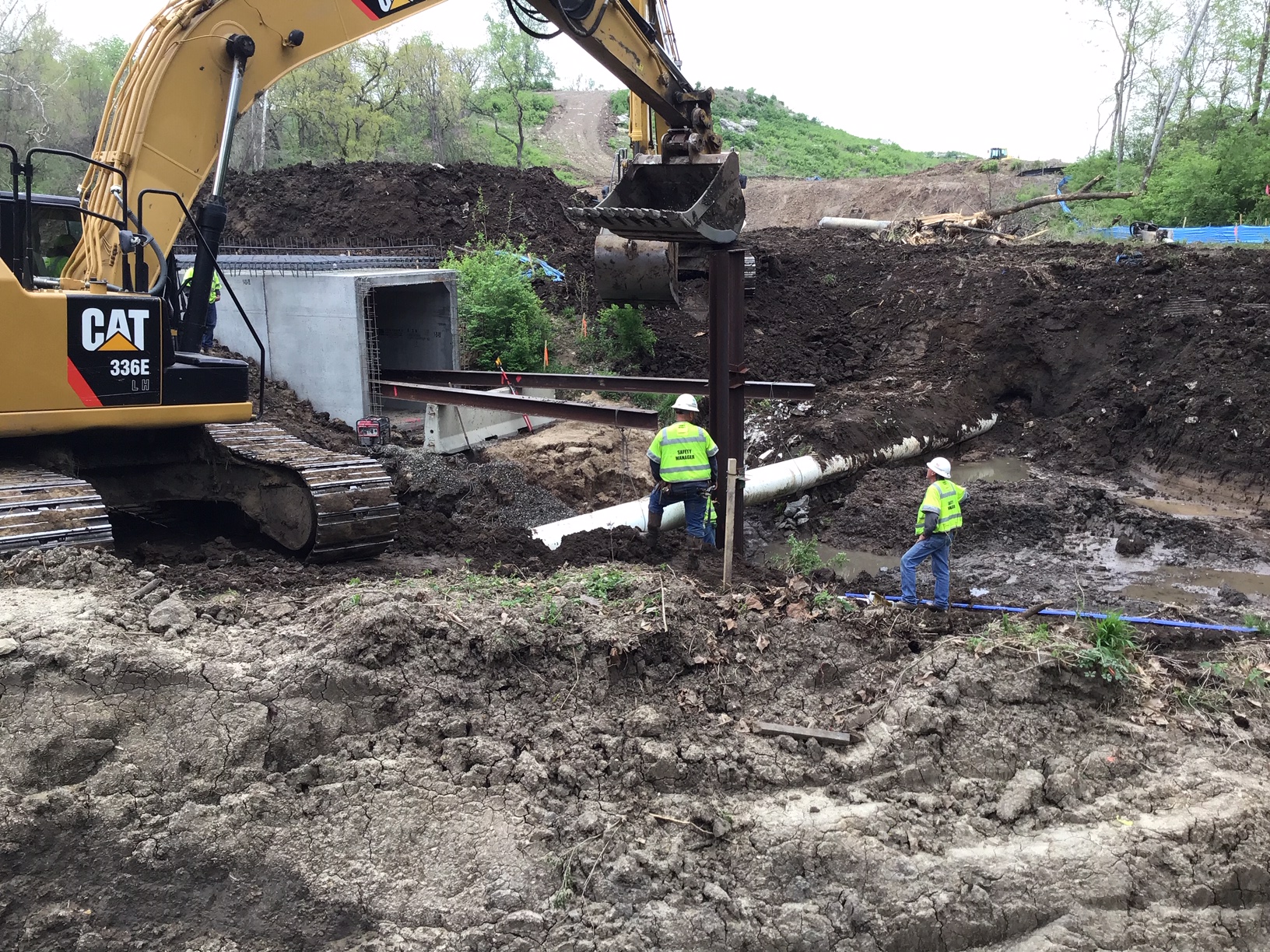

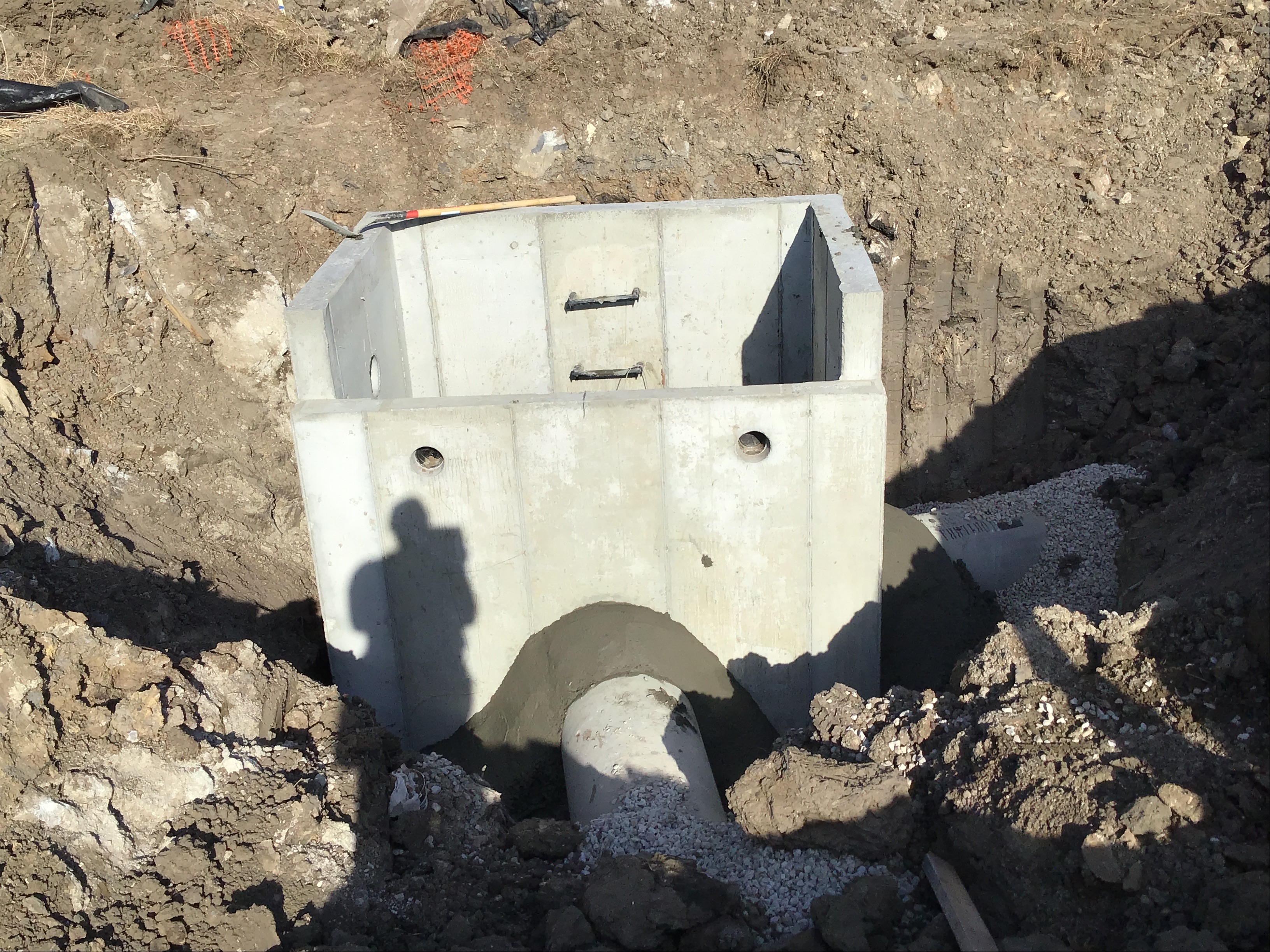

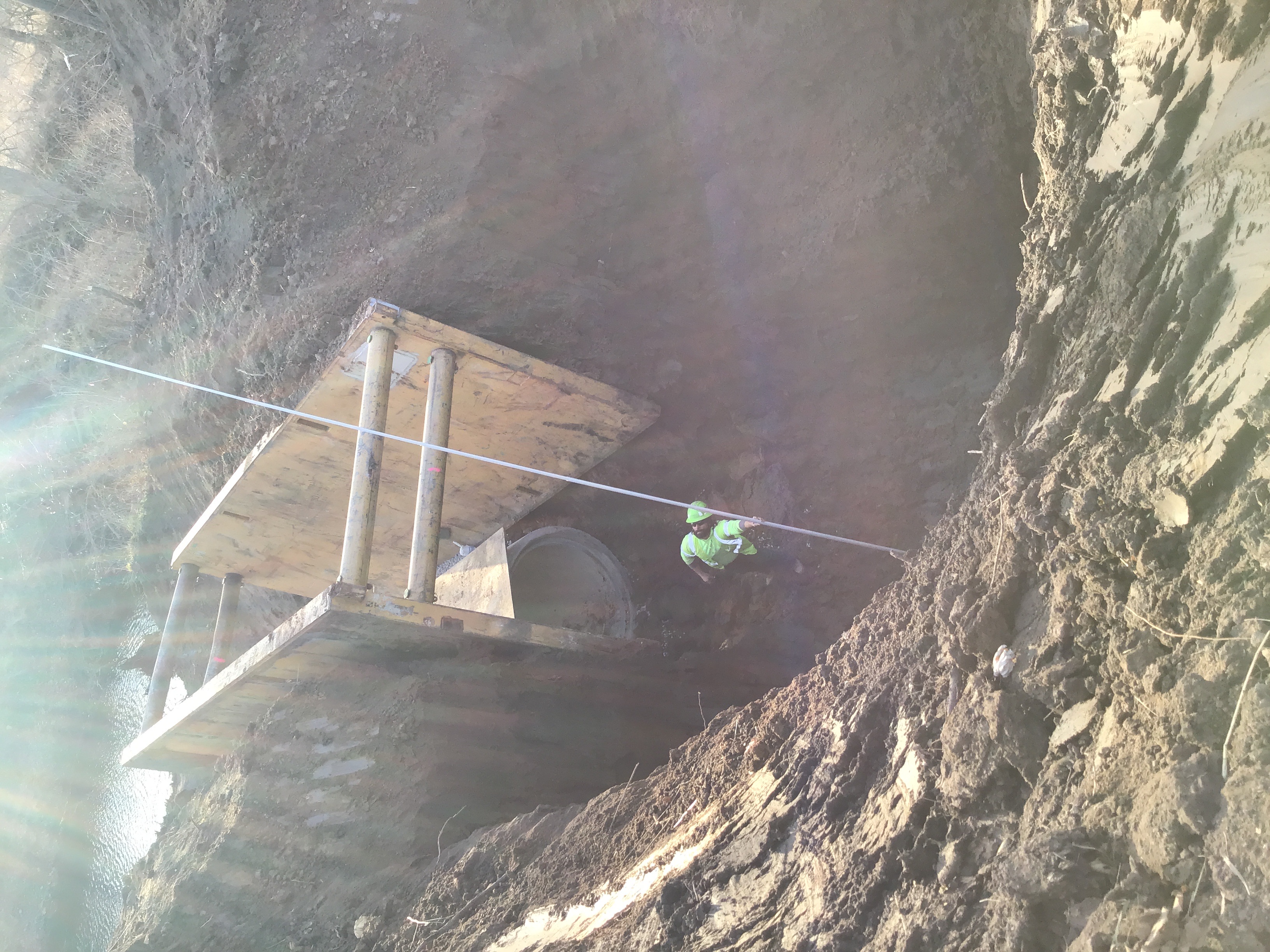

Installed 97' of 30" RCP & Curb Inlet 1201 & 1202 on Line 1200. Collars and inverts were poured. Contractor plans to backfill tomorrow and begin construction on Line 700. Picture taken of Line installation of Line 1200.
Erosion Control Inspection Passed 4/11/2019 04/12/2019
Corrective Action Required
04/11/2019
Contactor has made significant gain on the reinstallation of Silt and erosion control devices. They have not yet complete reinstalled of all silt fence as per construction plans. They still onsite working. The areas of concern are around Lines 300 & 500. Silt fencing should be completely reinstalled by 4/12/19. John Jackson 04/11/2019 4:09 PM
Misc
Corrective Action Required
04/12/2019
Contractor has successfully completed fencing for re-installation of soil erosion at this. 4/12/19
Miscellaneous PWORKS Inspection Passed 4/16/2019 04/16/2019
Informational
04/16/2019

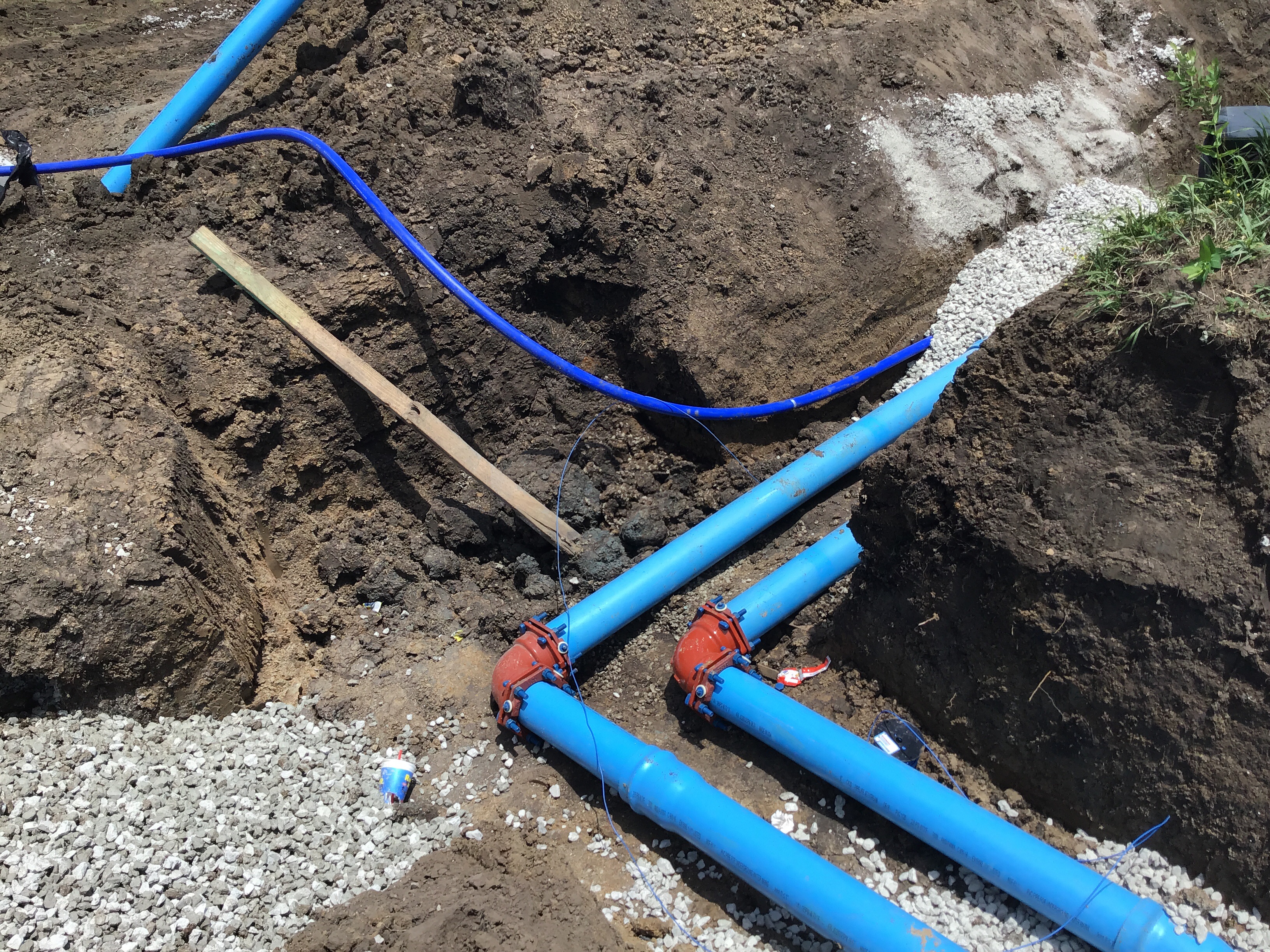

Contractor excavated existing santitary to encase in concrete as per plan.
Miscellaneous Correction
Informational
04/16/2019
Contractor poured concrete encased around Kansas City 24” SDR Sanitary. Storm sewer Line 700 shall cross above the existing at encasement of approximately 40’X6’

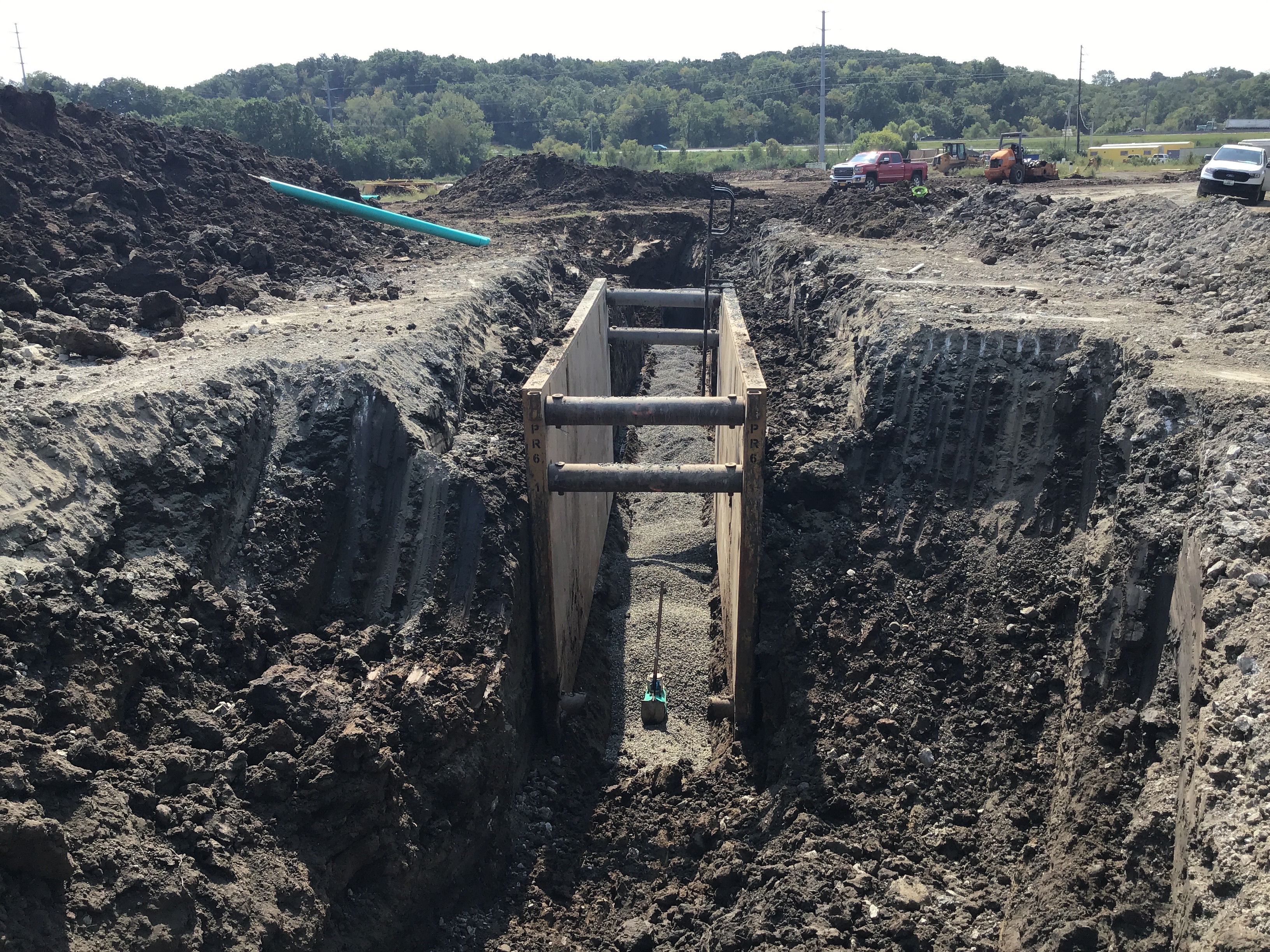

Grading/Excavation/Fill Inspection Partial 4/17/2019 04/18/2019
Informational
04/18/2019

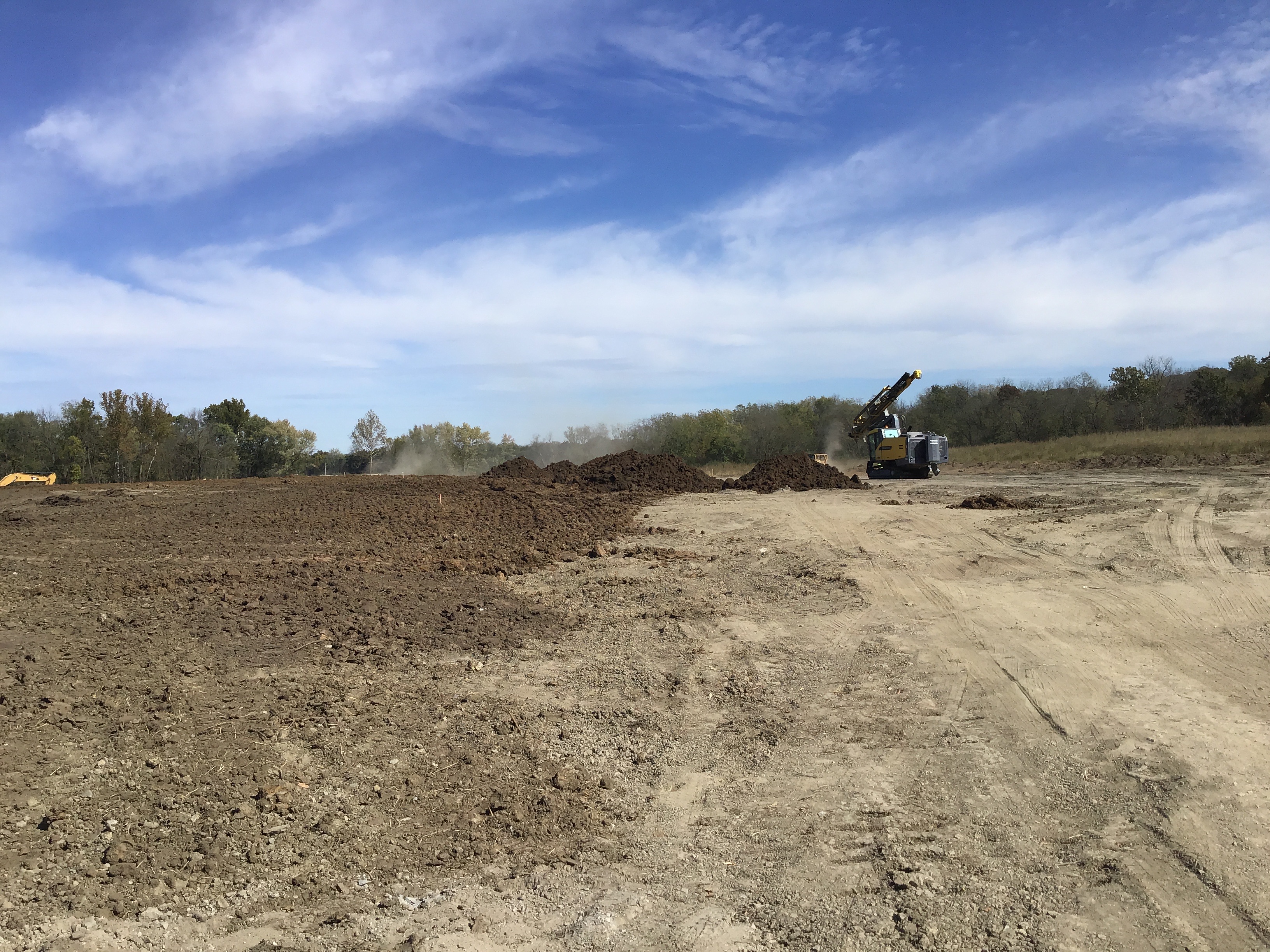

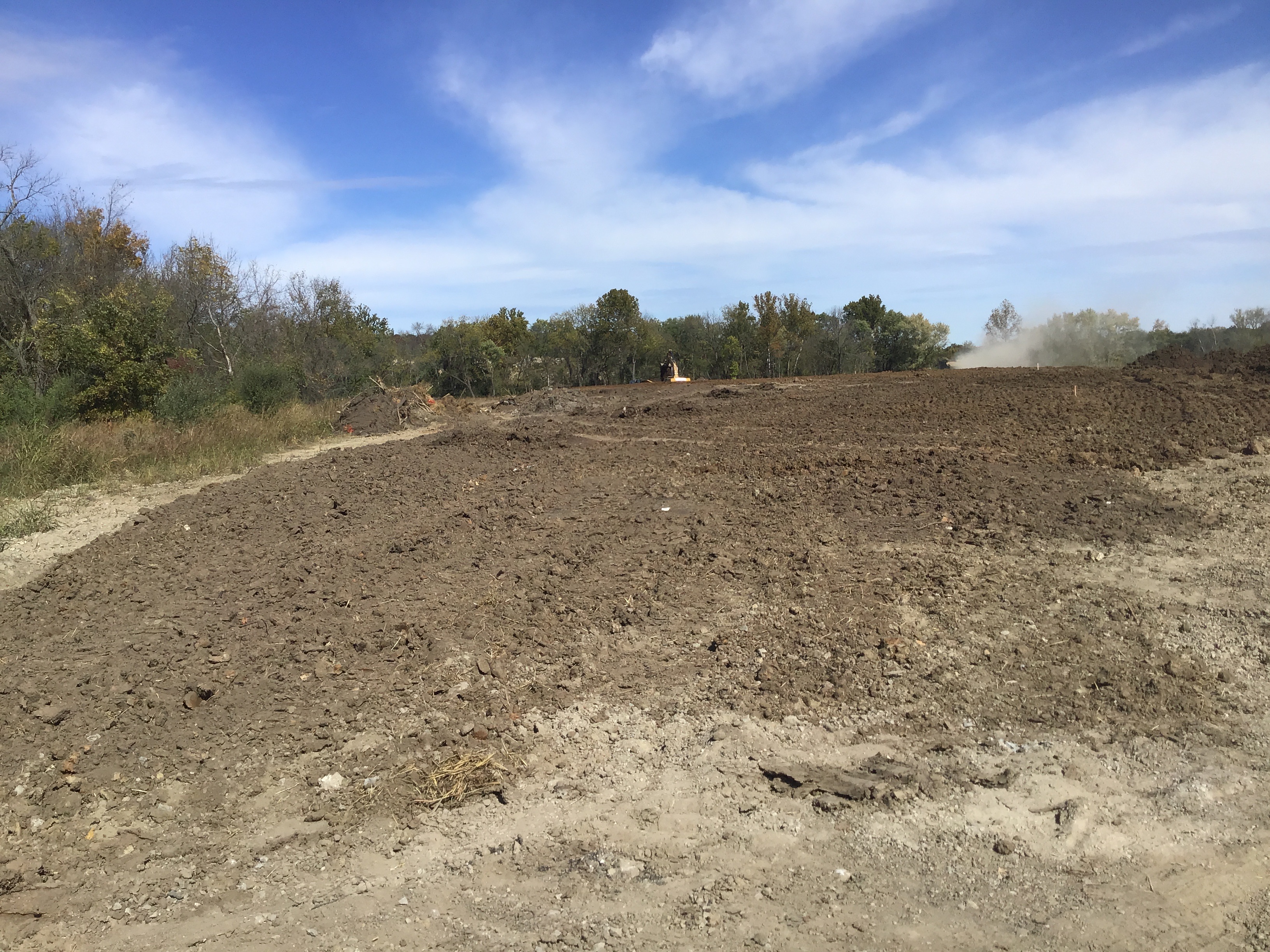

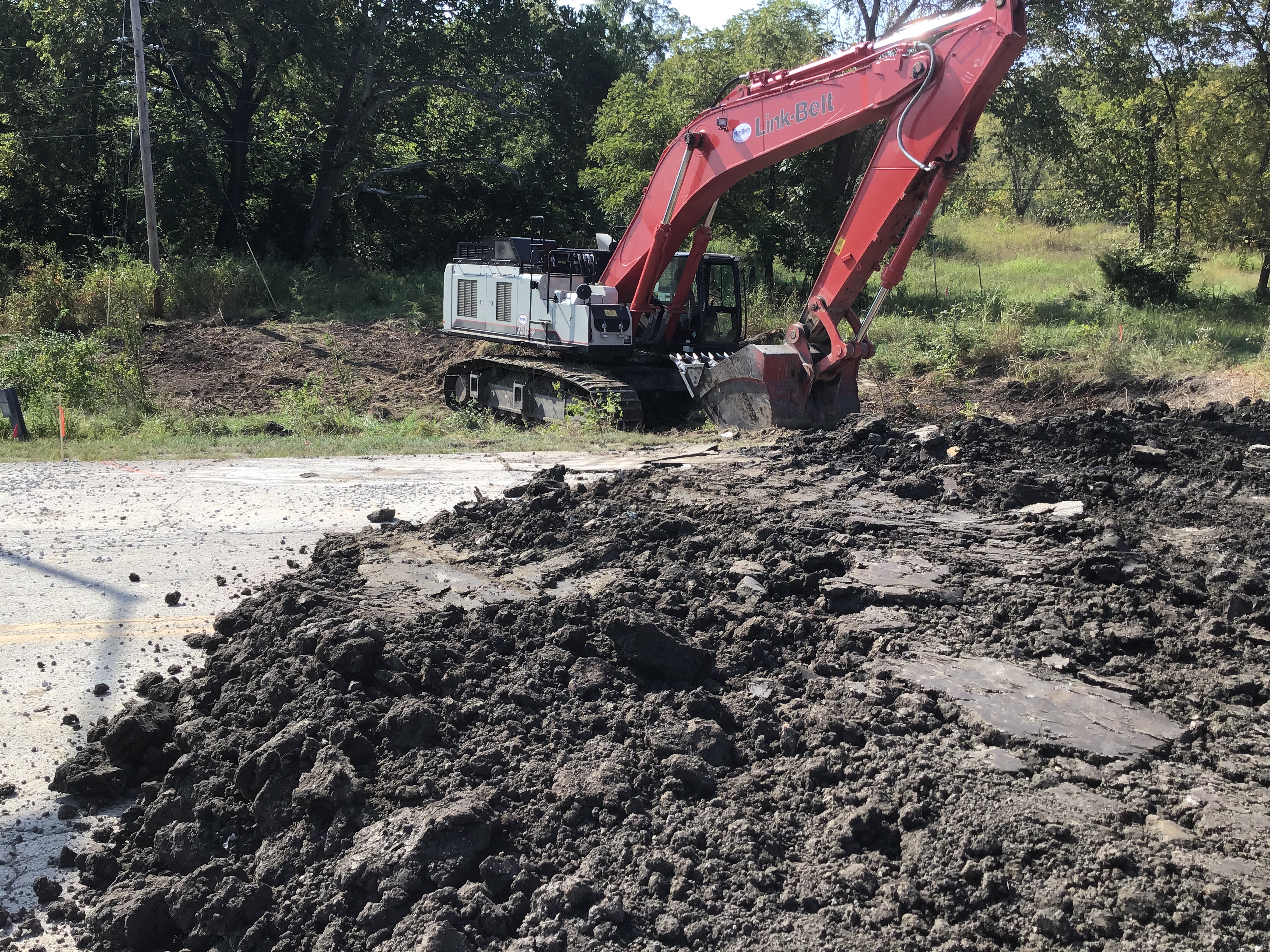

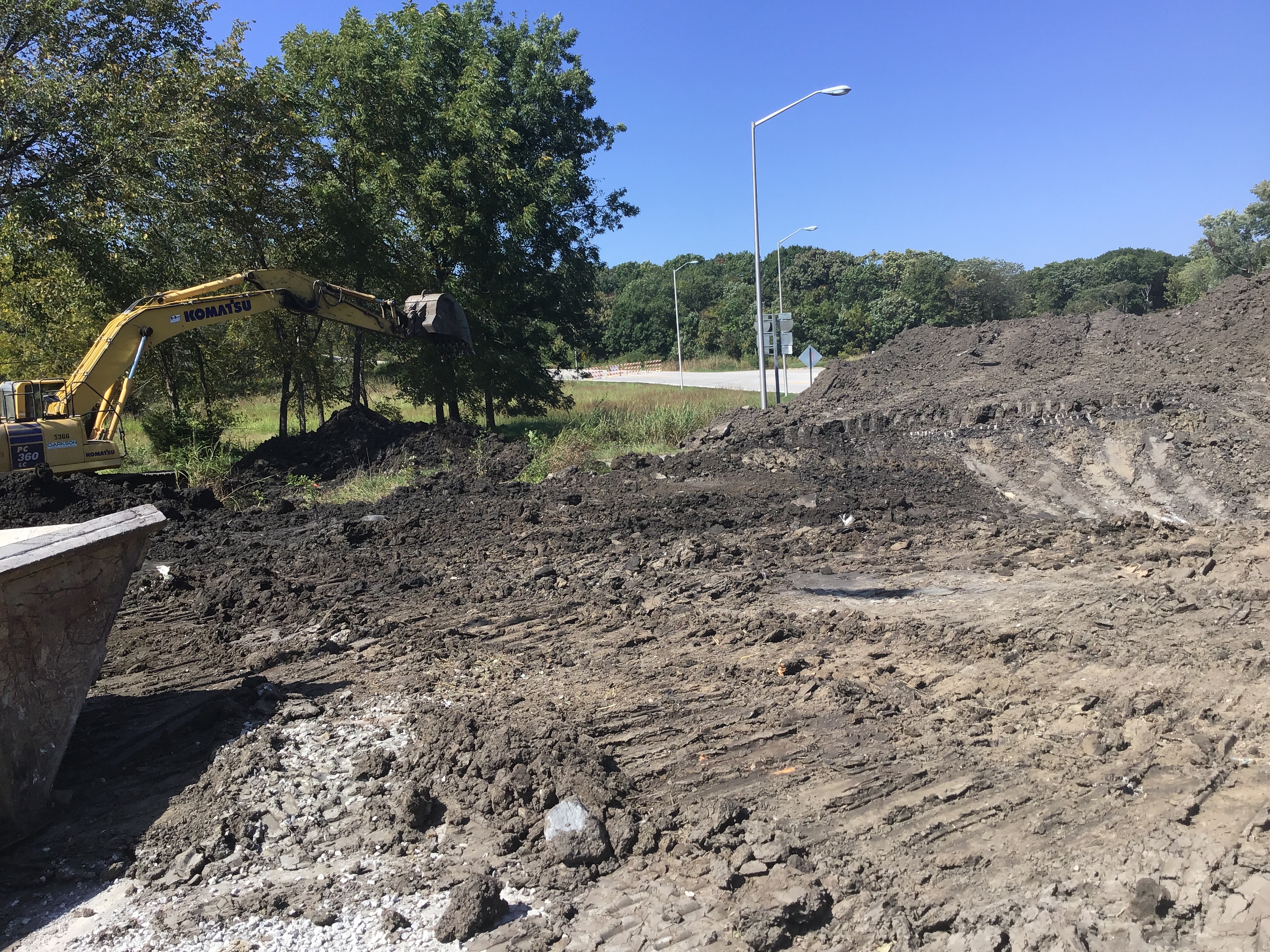

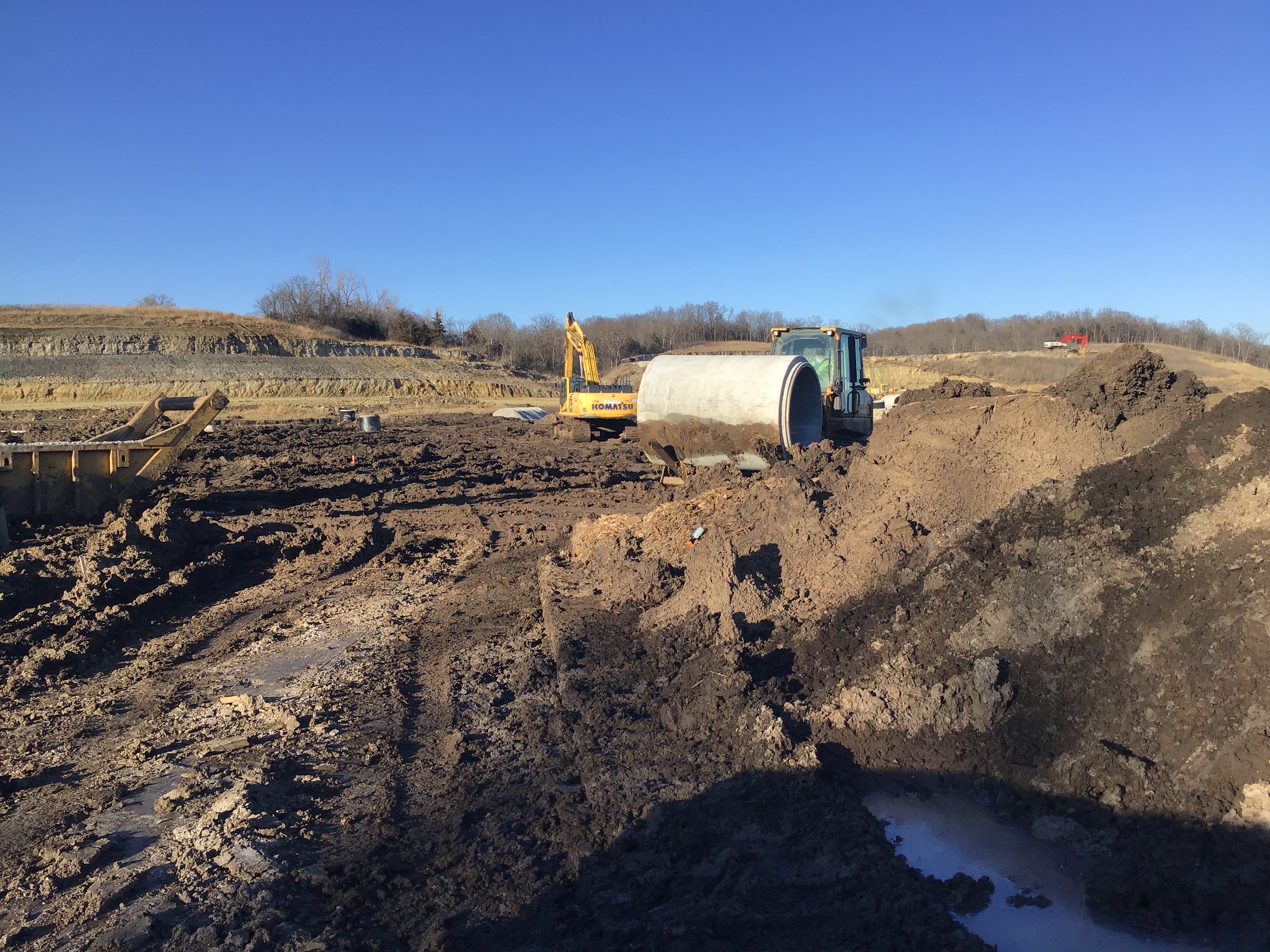

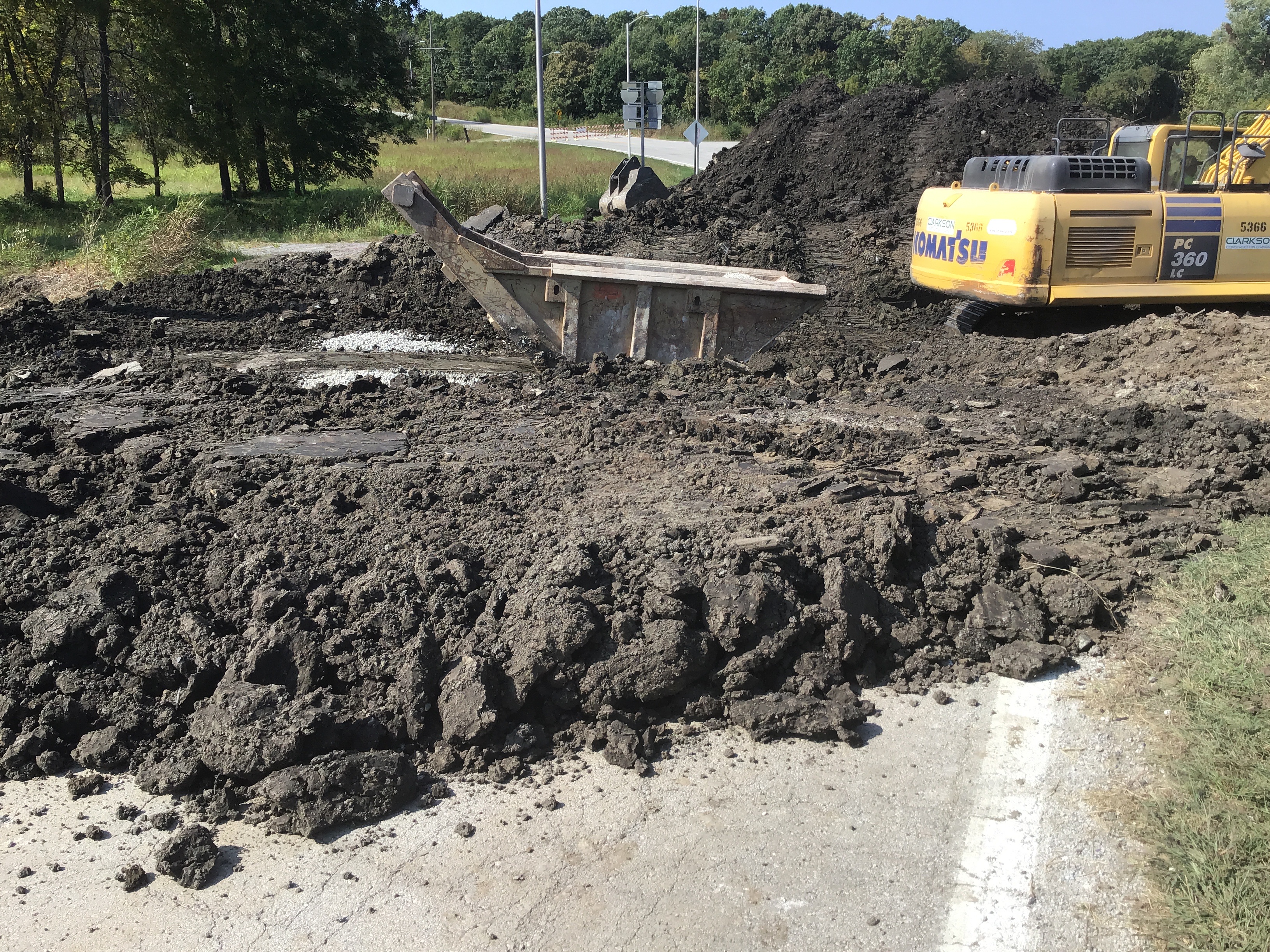

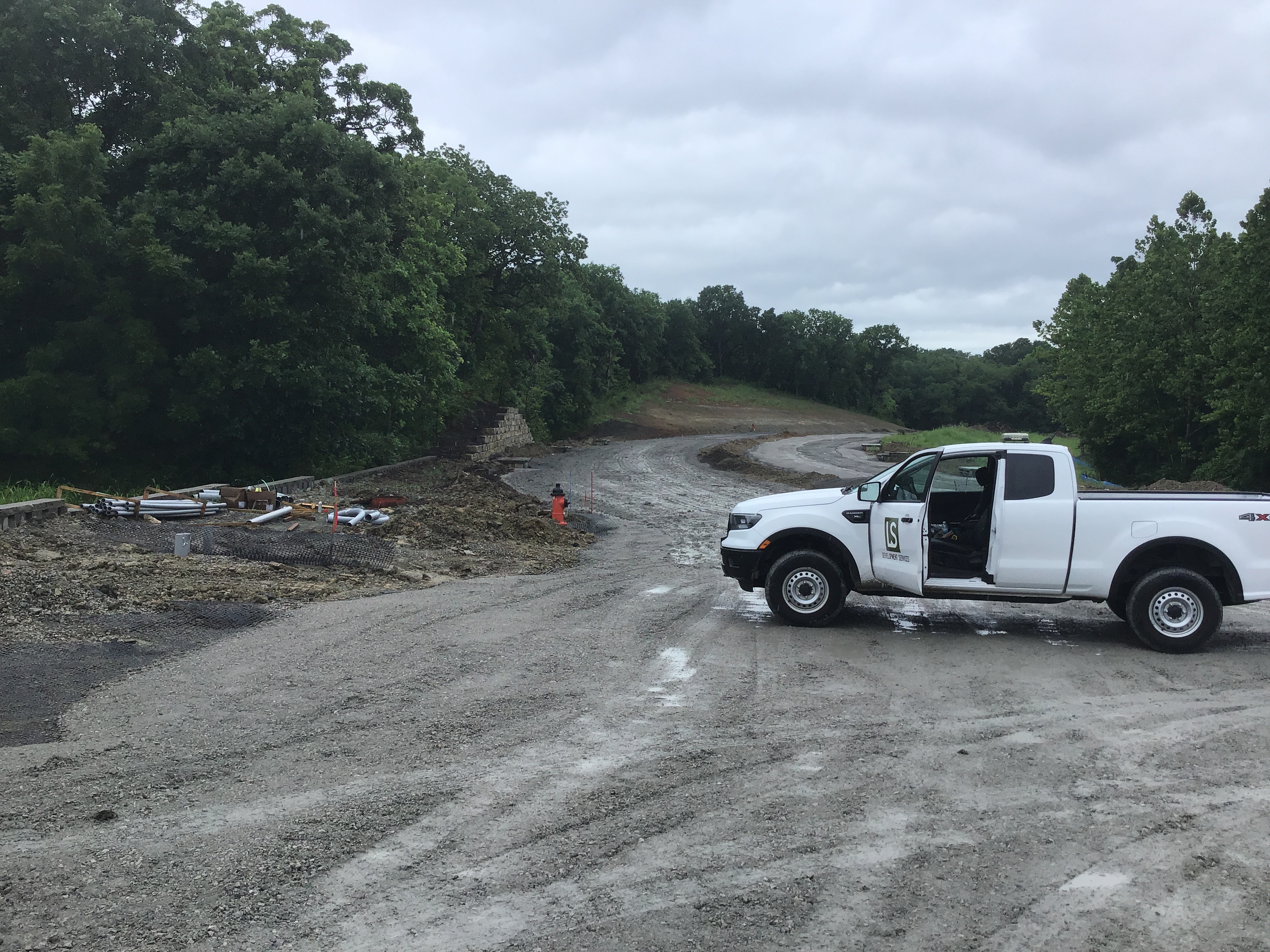

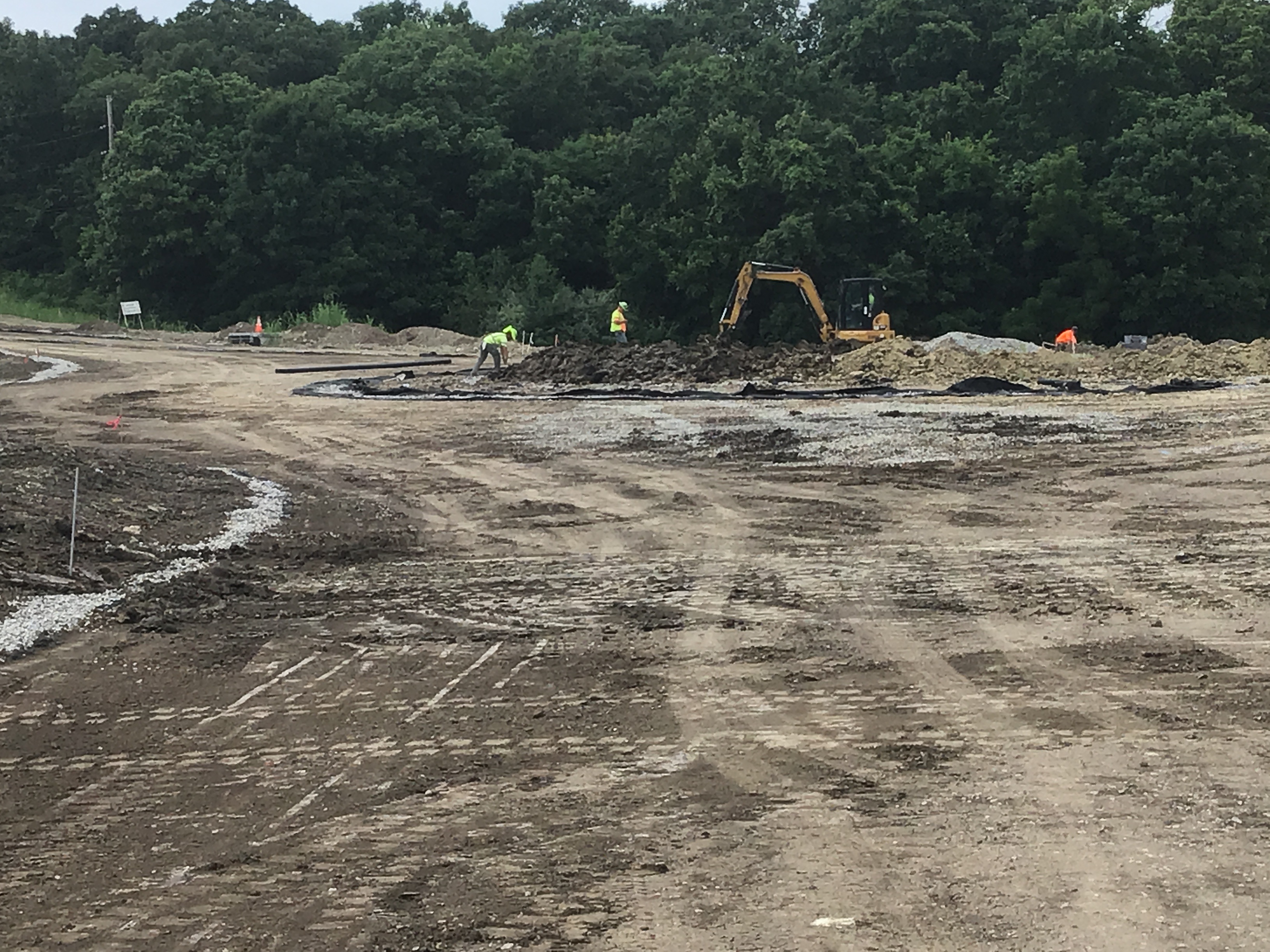

Contractor Clarkson continued grading site area for contruction. Contractor work to reroute water from Line 300 to prepare to install Toe Wall & Wings.

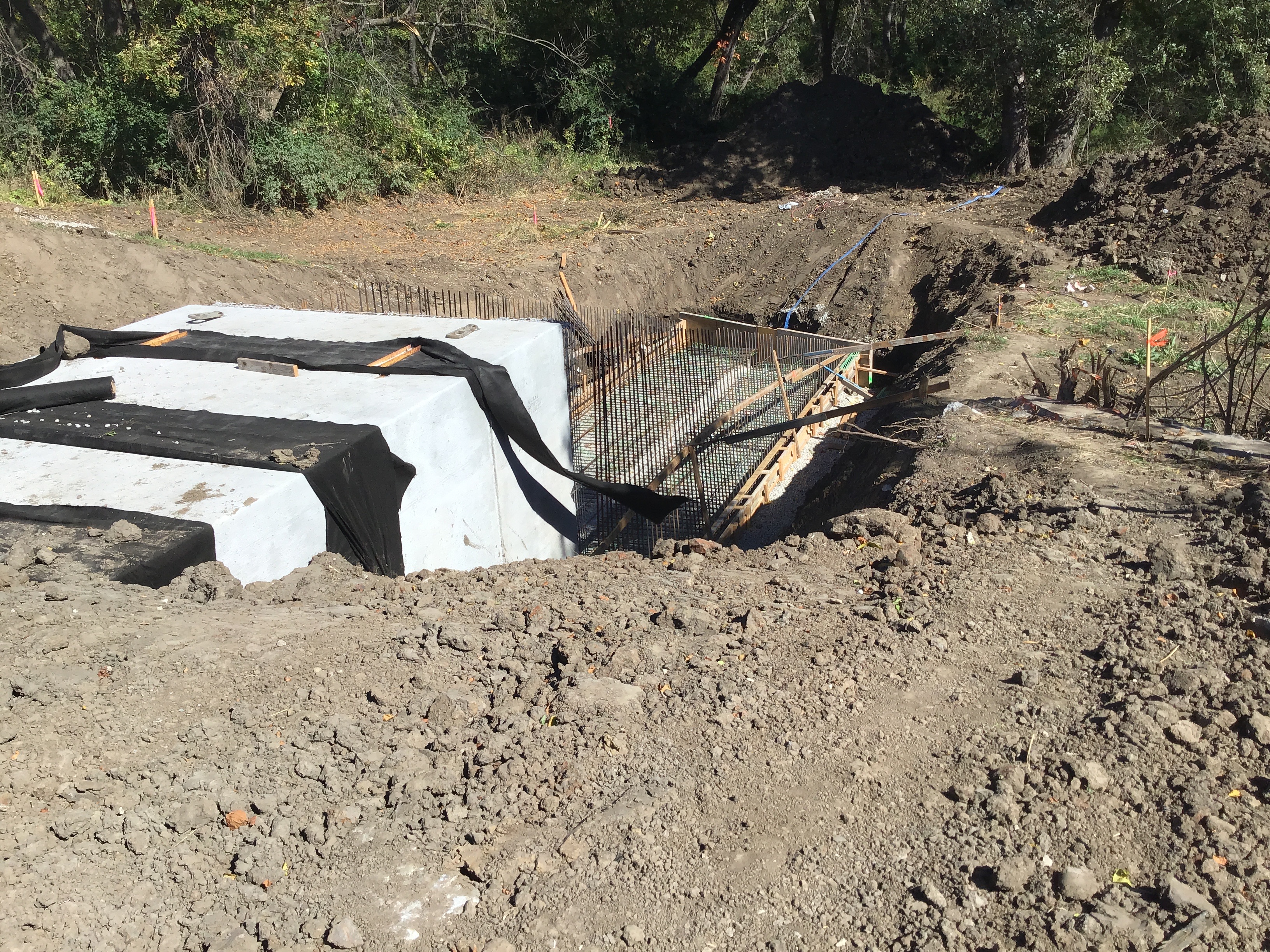

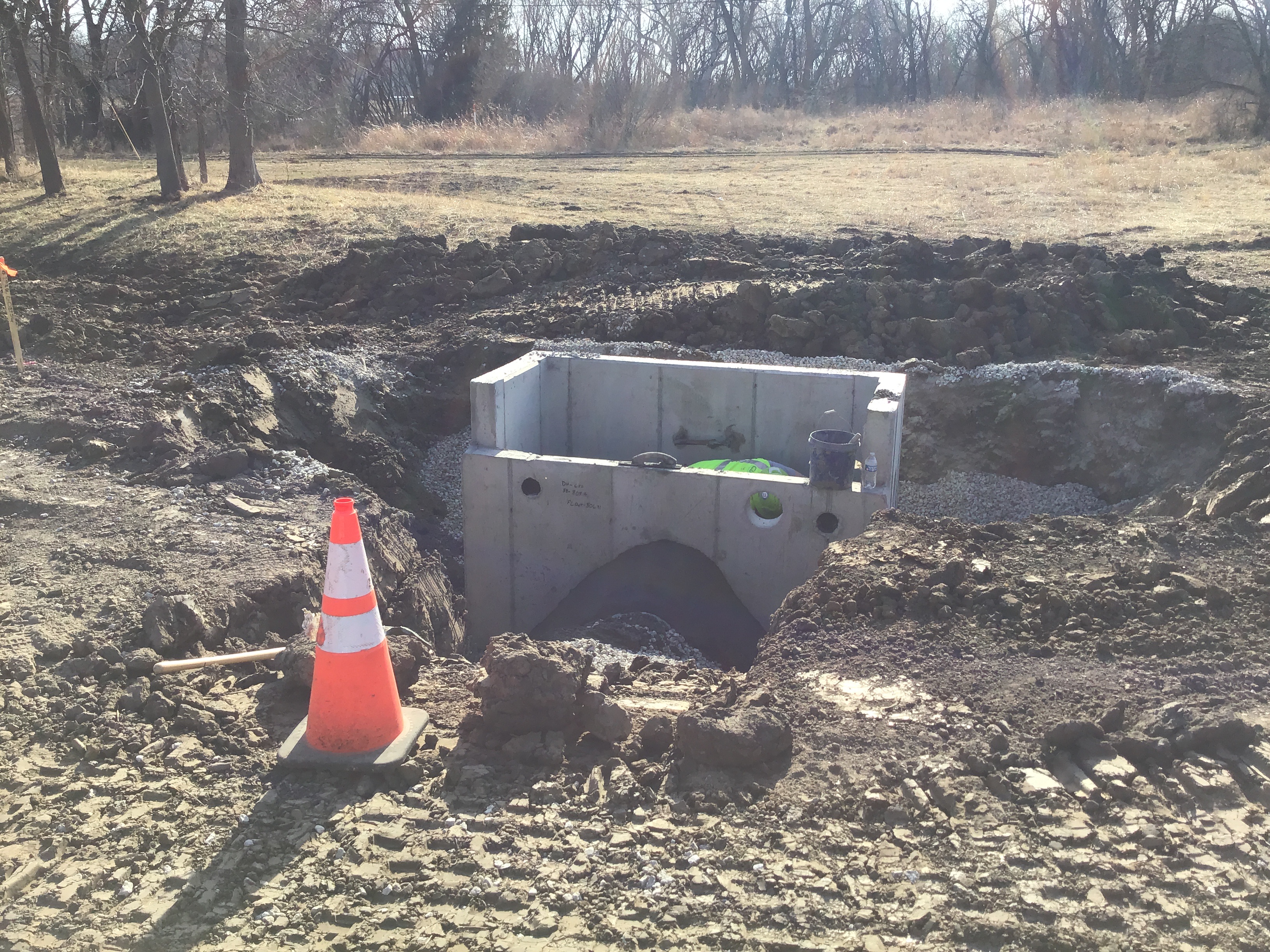

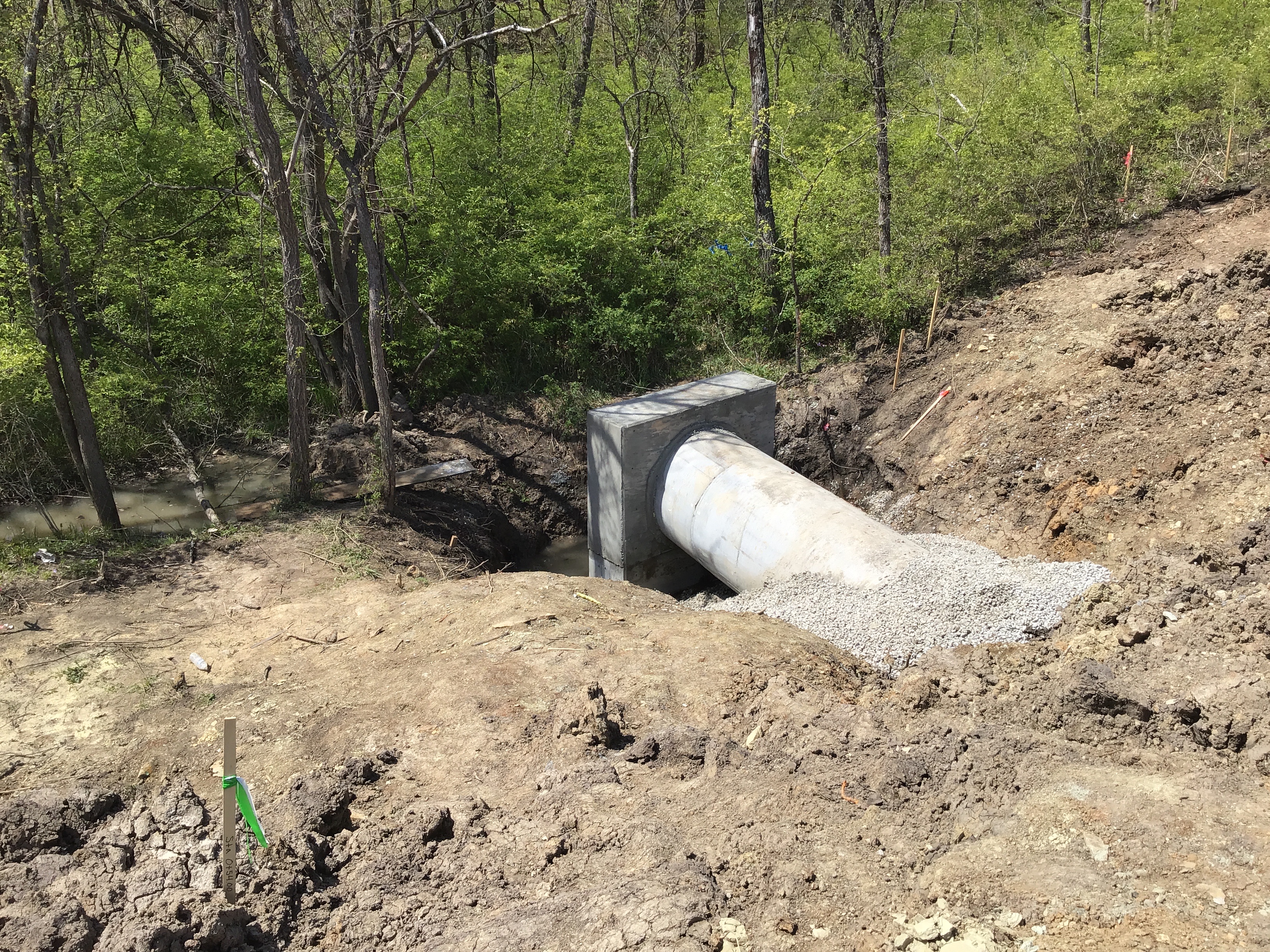

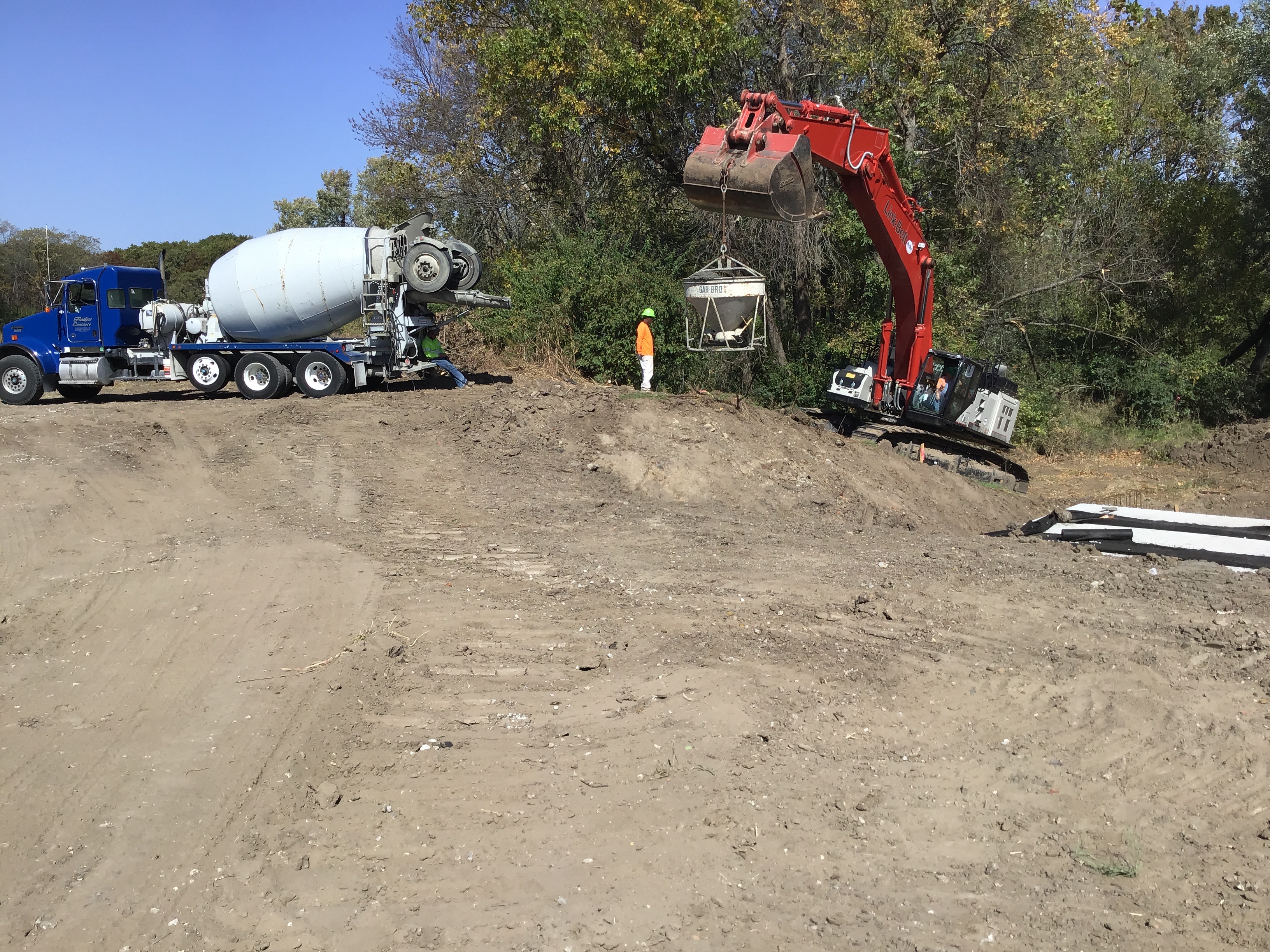

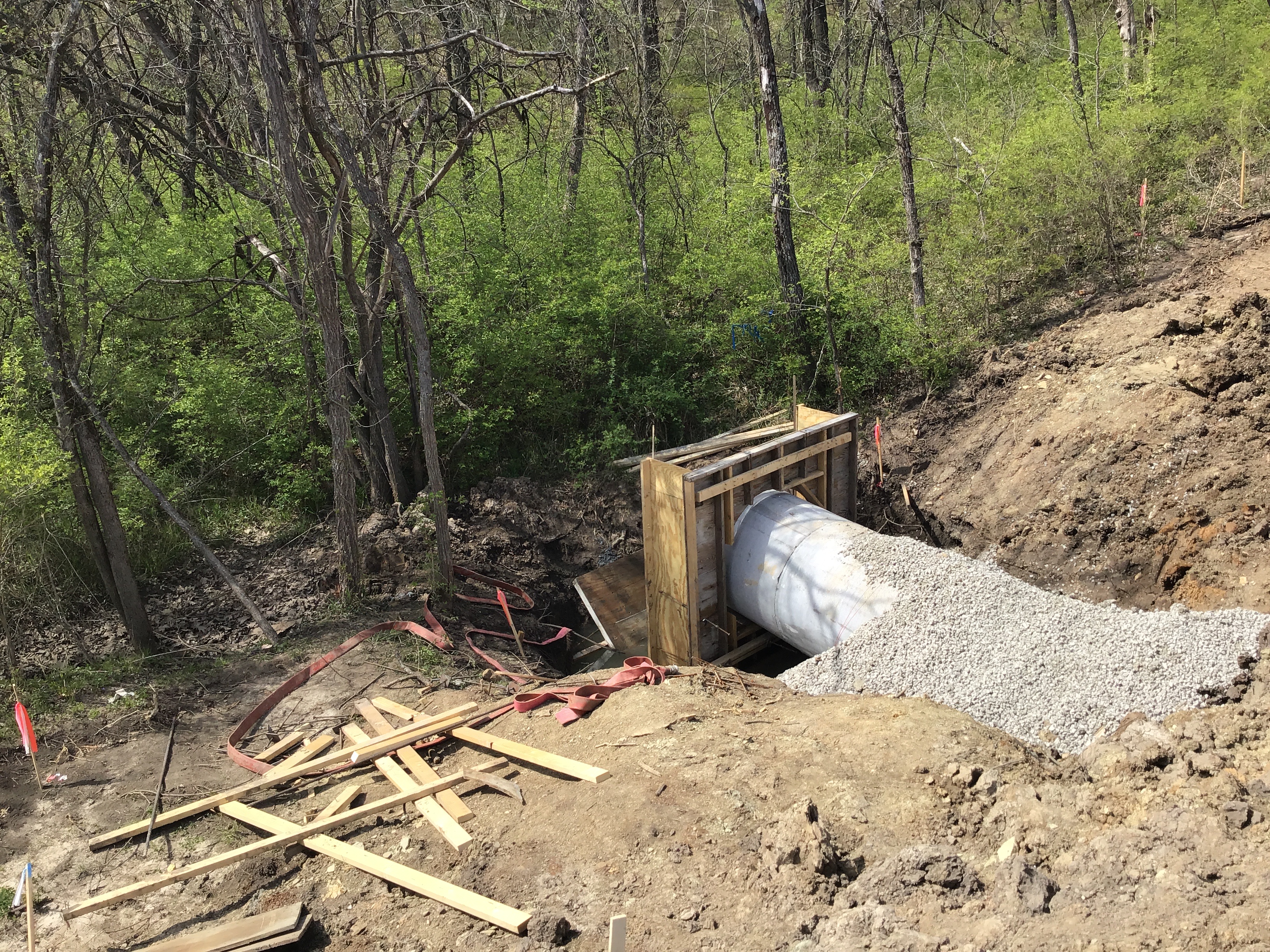

Storm - Outlet Structure Partial 04/26/2019
04/26/2019
Informational
04/26/2019

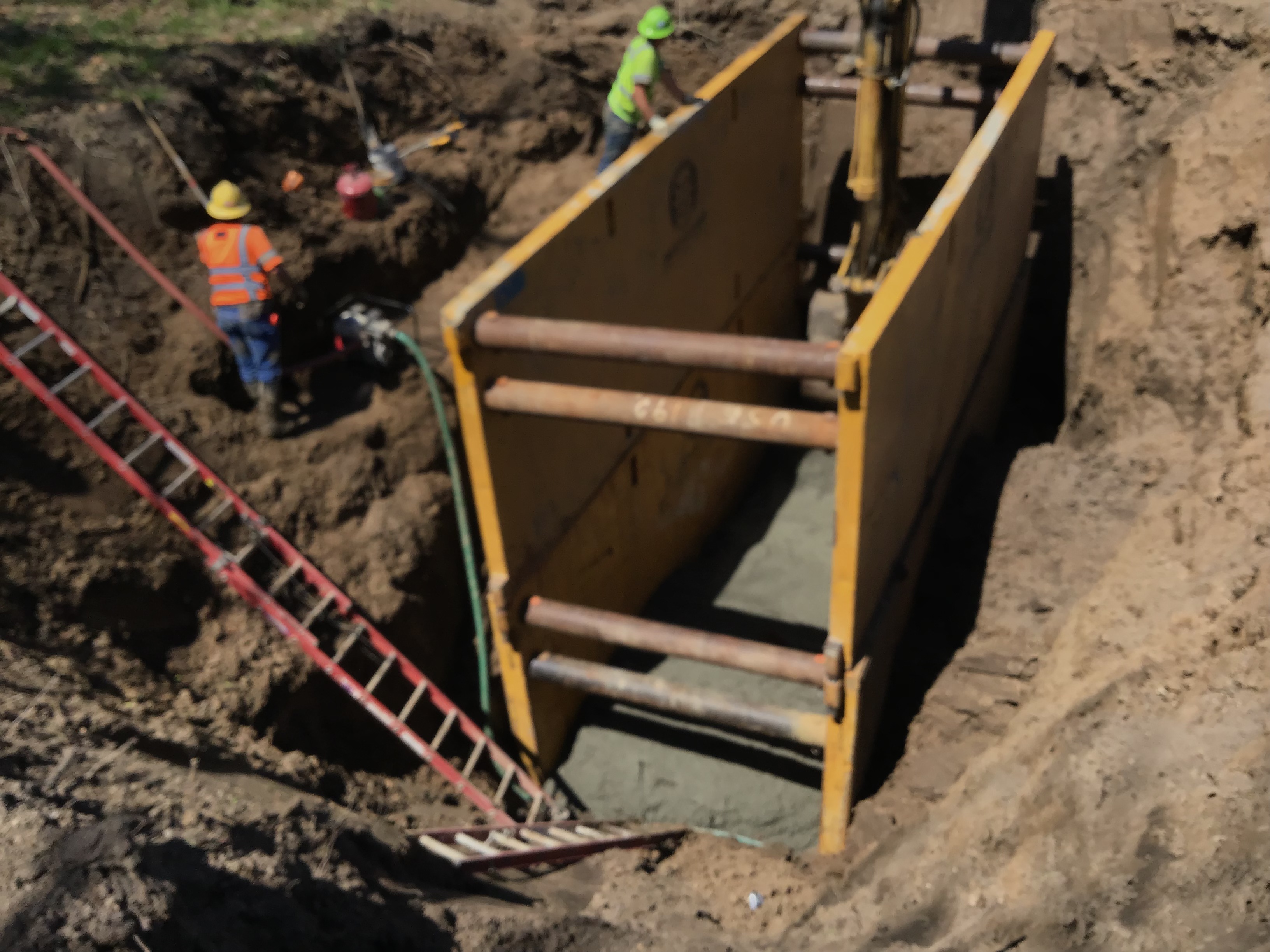

Contractor continued to construct Toe wall on Line 300 and encasement( for Kansas City Sanitary Pipe Line) throughout the week of 4/22/19 to 4/26/19. Conrete pour for encasement of sanitary pipeline began around 1:30 pm. Project picture were taken of progress.
Site Visit Partial 4/8/2019 05/24/2019
PW-Misc
Informational
04/08/2019
The crossing in the Little Blue has been removed. All equipment and debris has also been removed from the floodway. The contractors will not be working in the floodway and when they are near the floodway it will be staked and marked so it is clear as to where they need to be. As of now this is putting an end to the Stop Work Order.Steve Robbins 04/08/2019 9:47 AM
Miscellaneous Correction
Informational
05/24/2019
This project cannot have anymore work done except finish the storm line on 300 and toe-wall.John Jackson will be checking on this to make sure it gets wrapped up. No work until further notice.

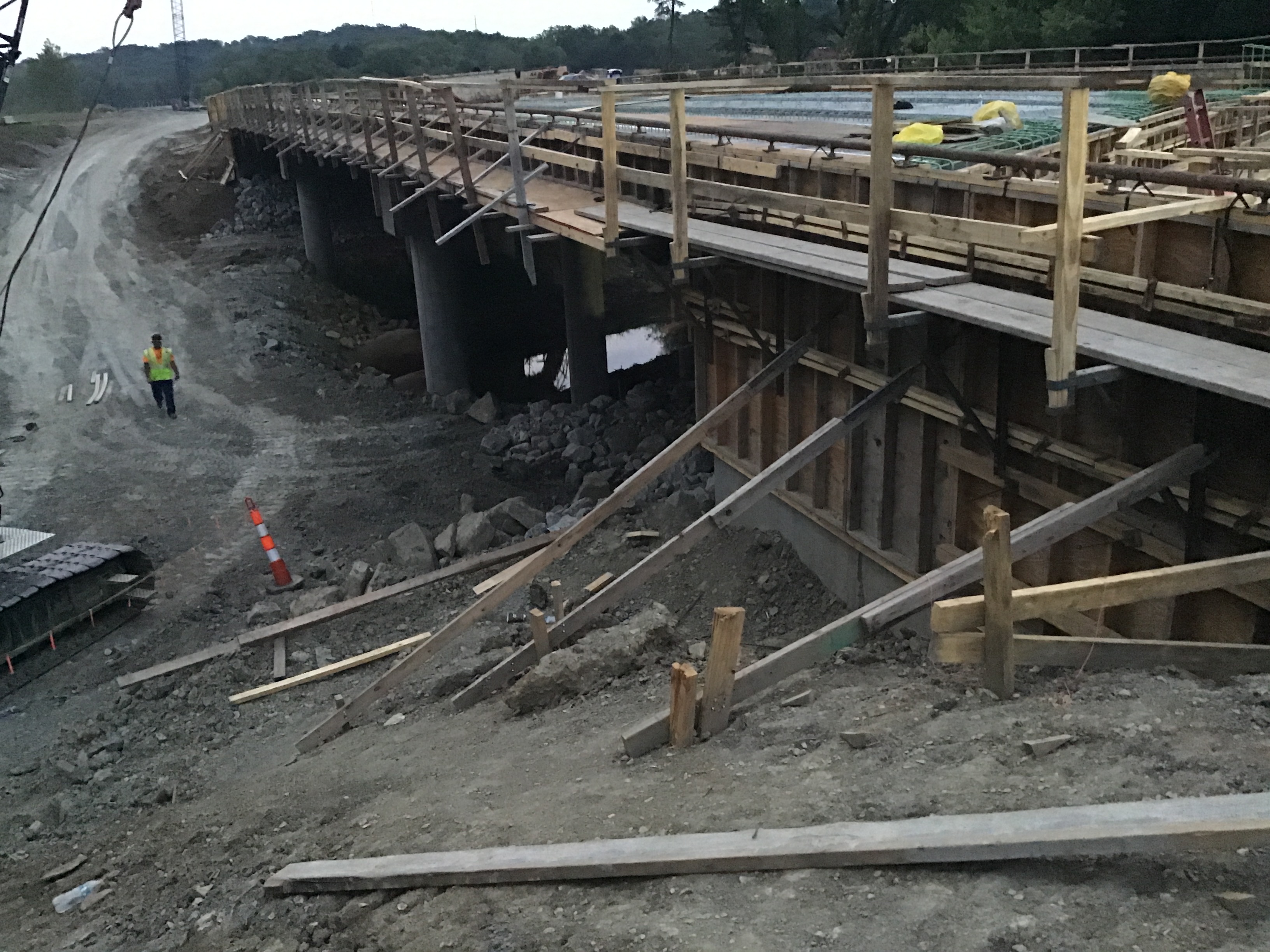

Storm - Outlet Structure Partial 6/13/2019 06/19/2019
Informational
06/19/2019

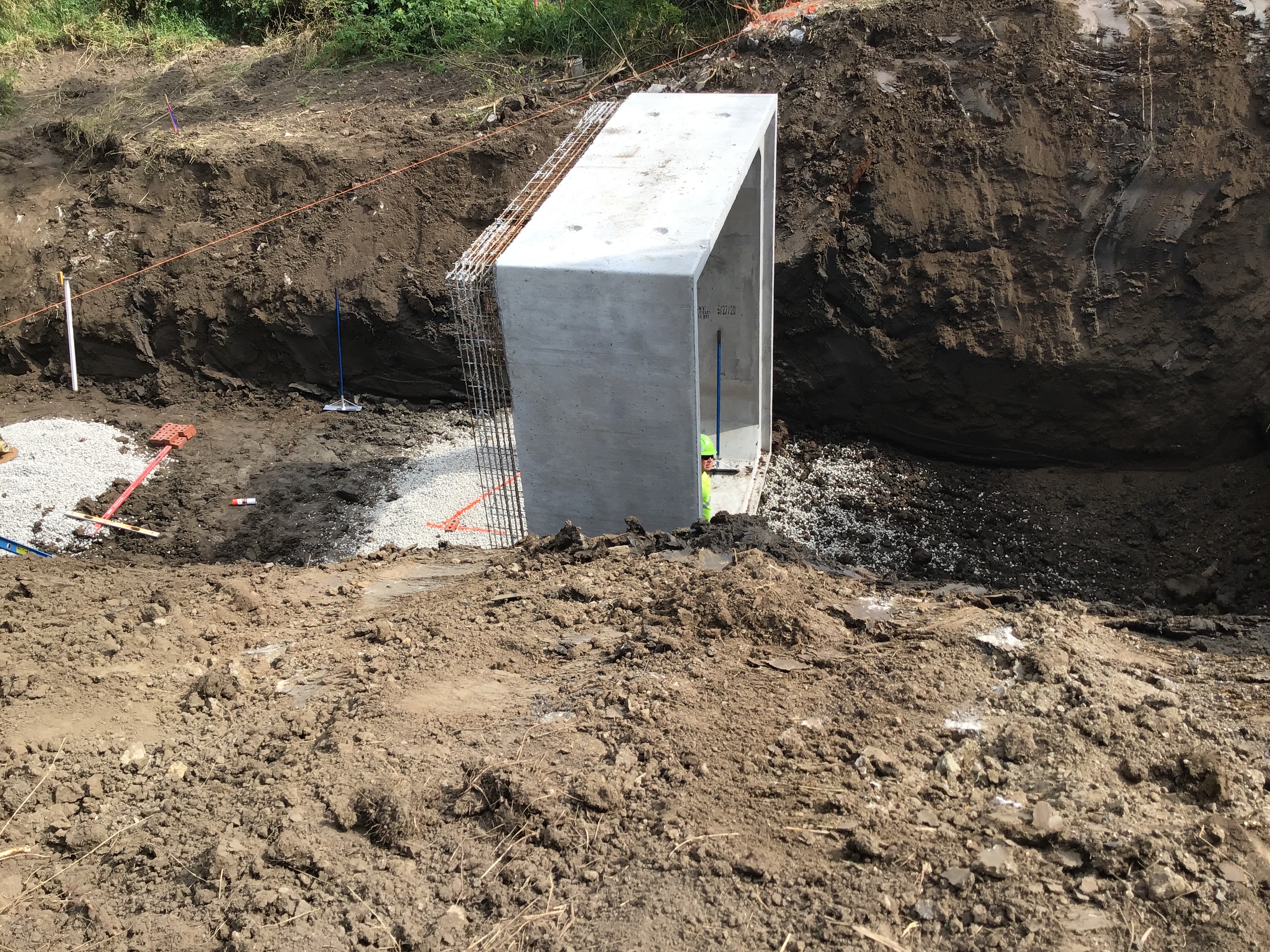

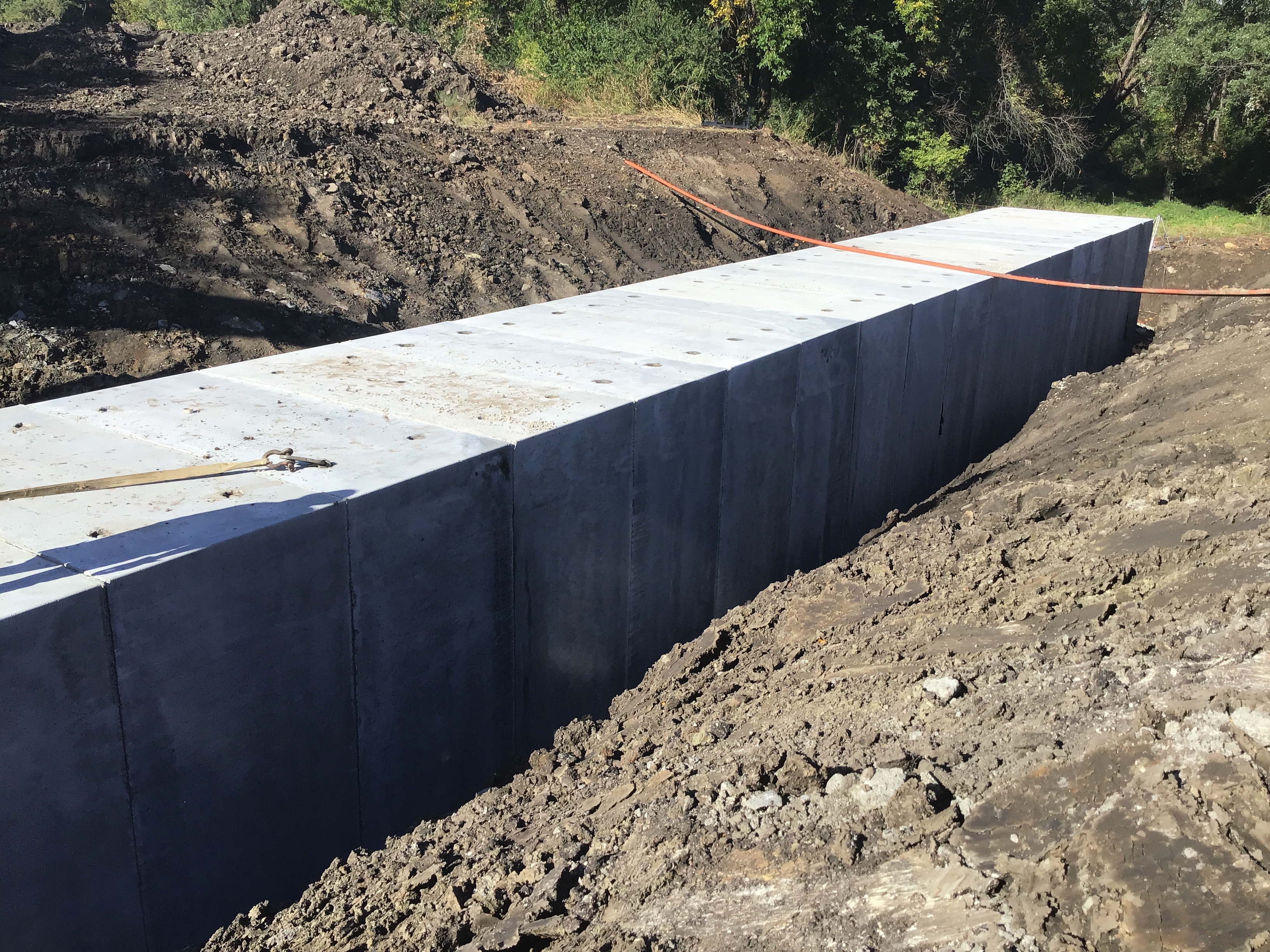

Contractor has completed the structure of the Toe wall that encased KC sanitary main 6/13/19 . Contractor installed rebar for the apron for the storm outlet on Line #3 6/18/19. Contractor poured apron 6/19/19 . I will inspect concrete pour on 6/20/19 .

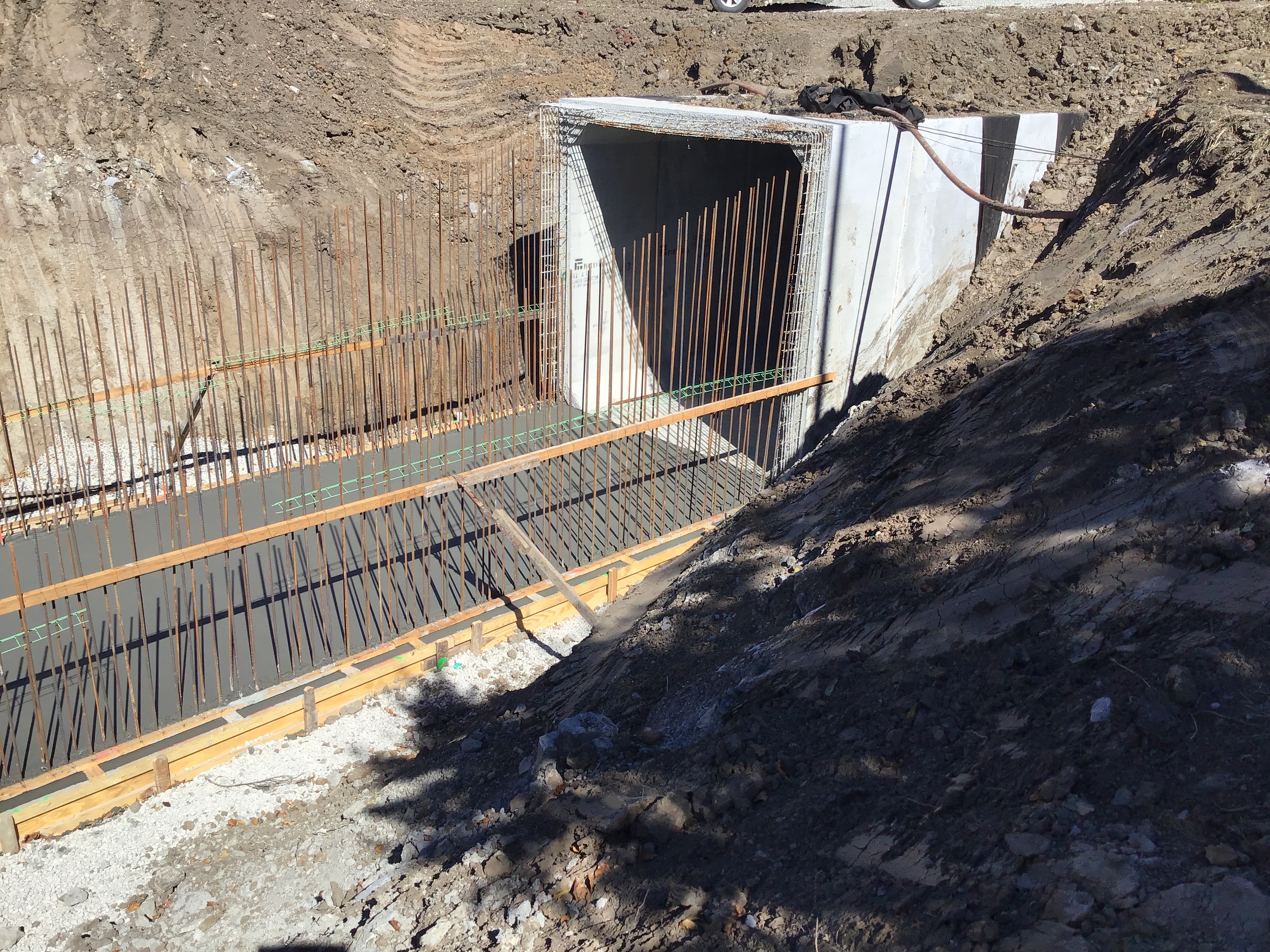

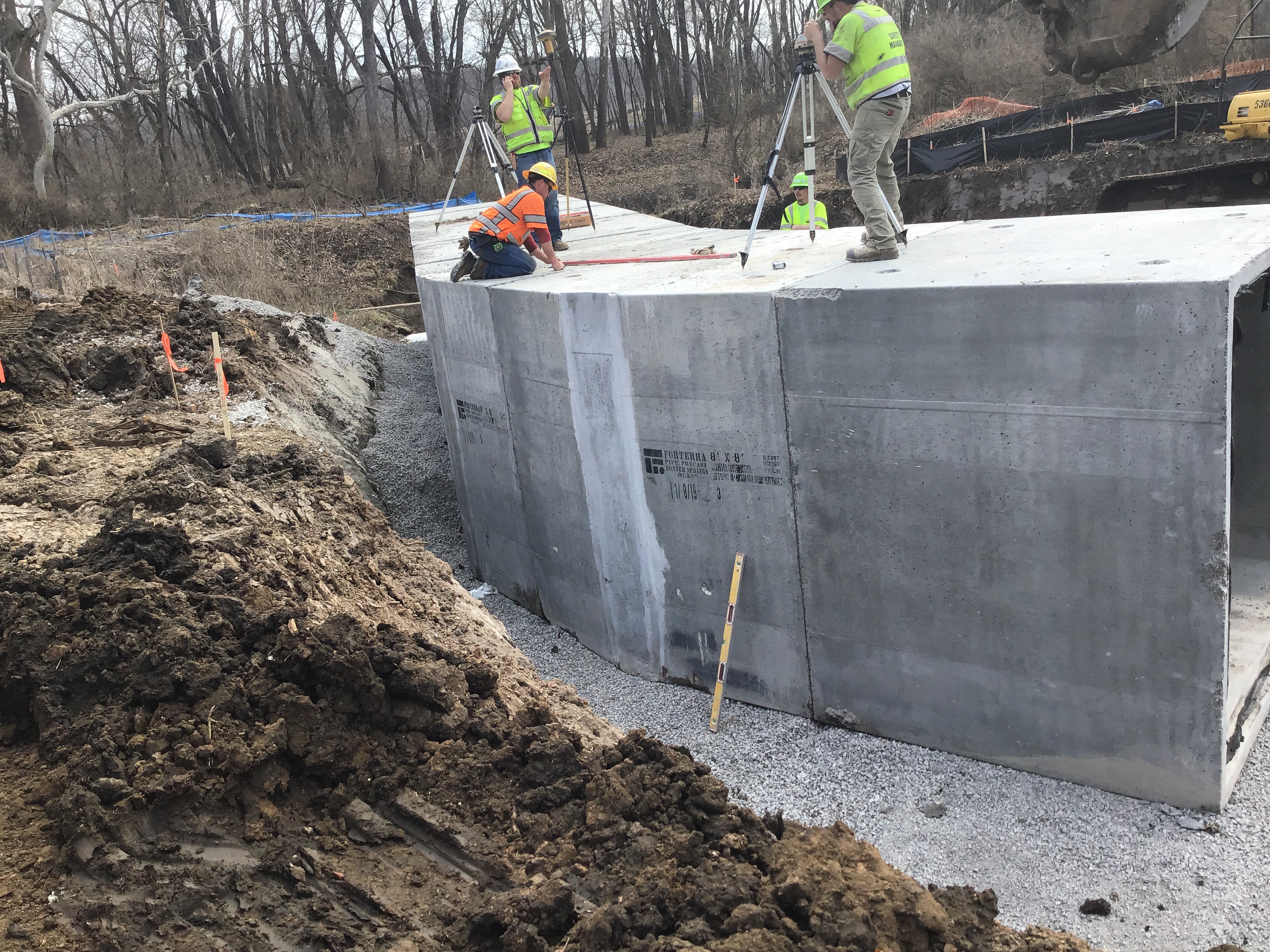

Storm - Outlet Structure Partial 7/8/2019 07/08/2019
Informational
07/08/2019

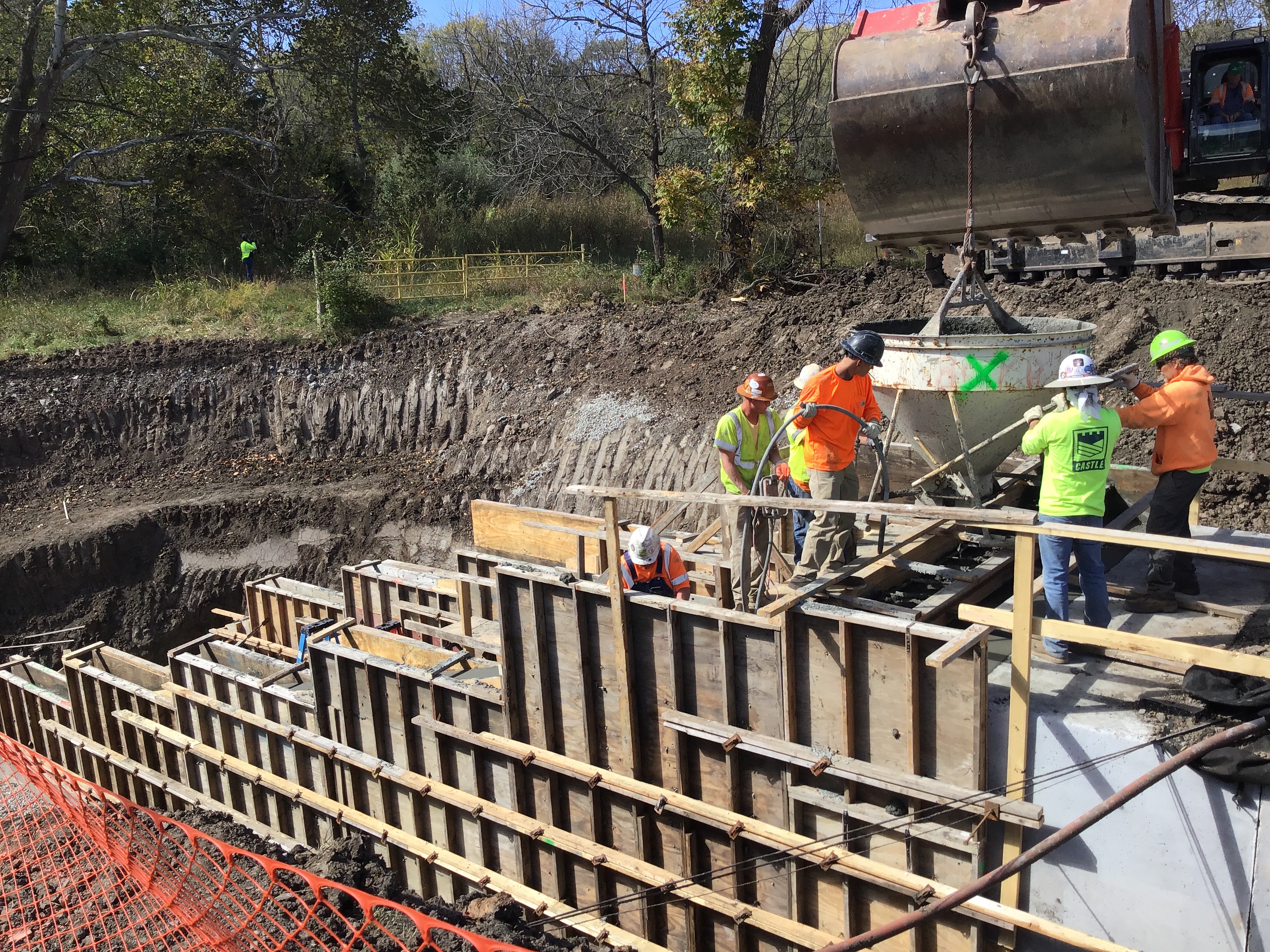

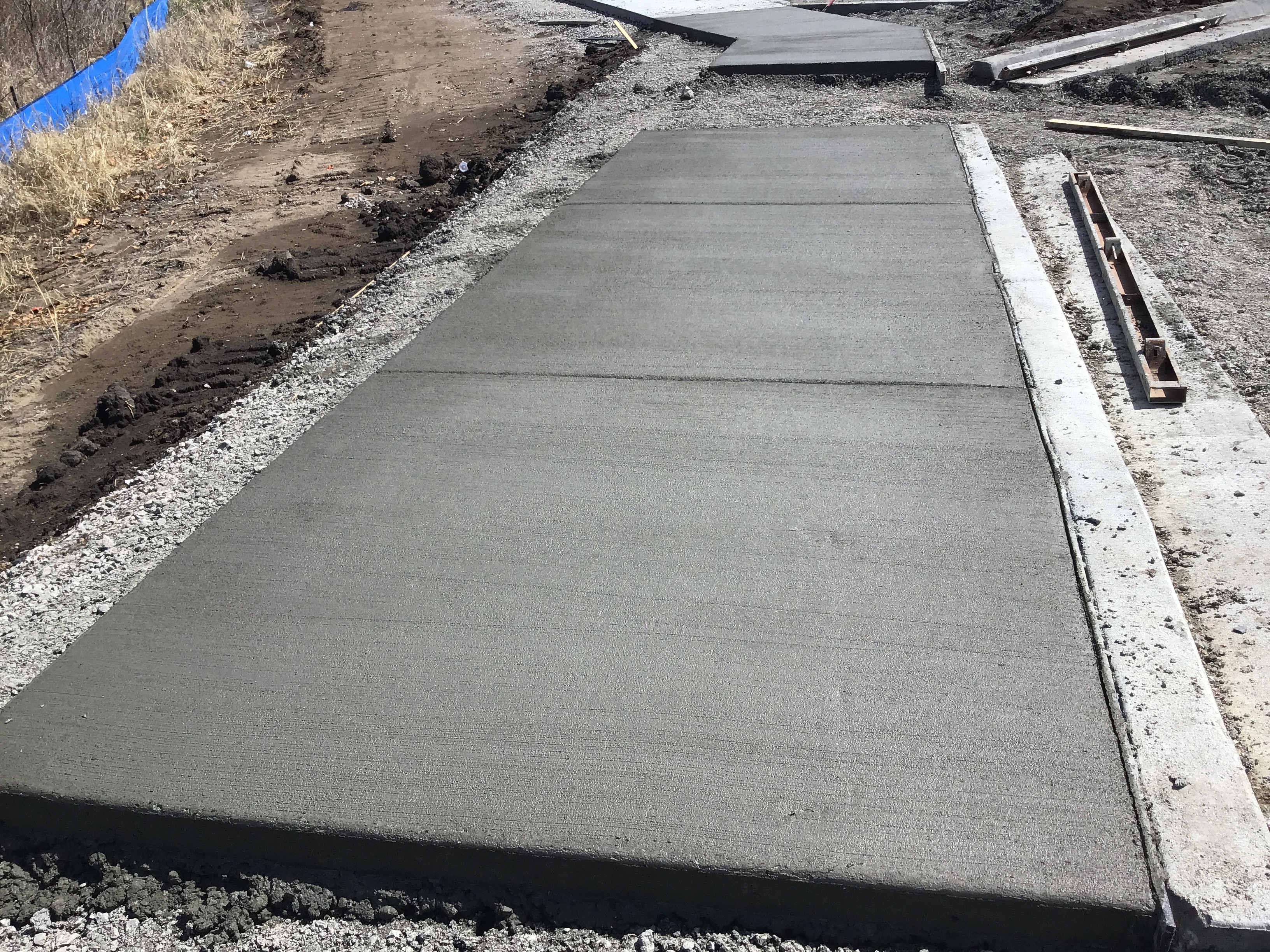

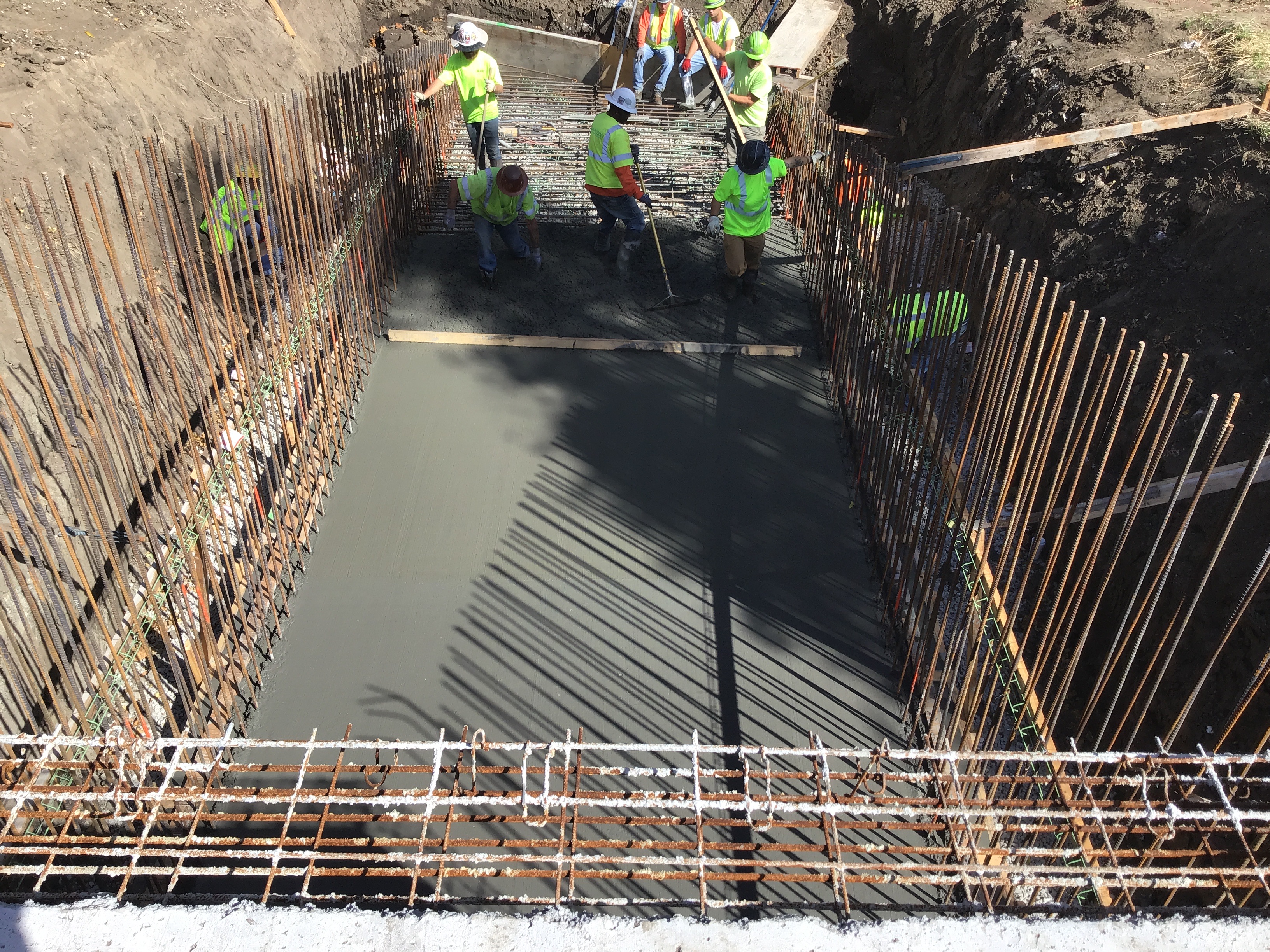

Contractor continued to construct rebar reinforcement and forms to pour concrete for wing walls of Outlet structure on Line 3 . Conrete pouring shall being 7/9/19 at or around 12:30 AM As per Clarkston Construction .
Storm - Outlet Structure Partial 07/09/2019
Misc
Informational
07/09/2019

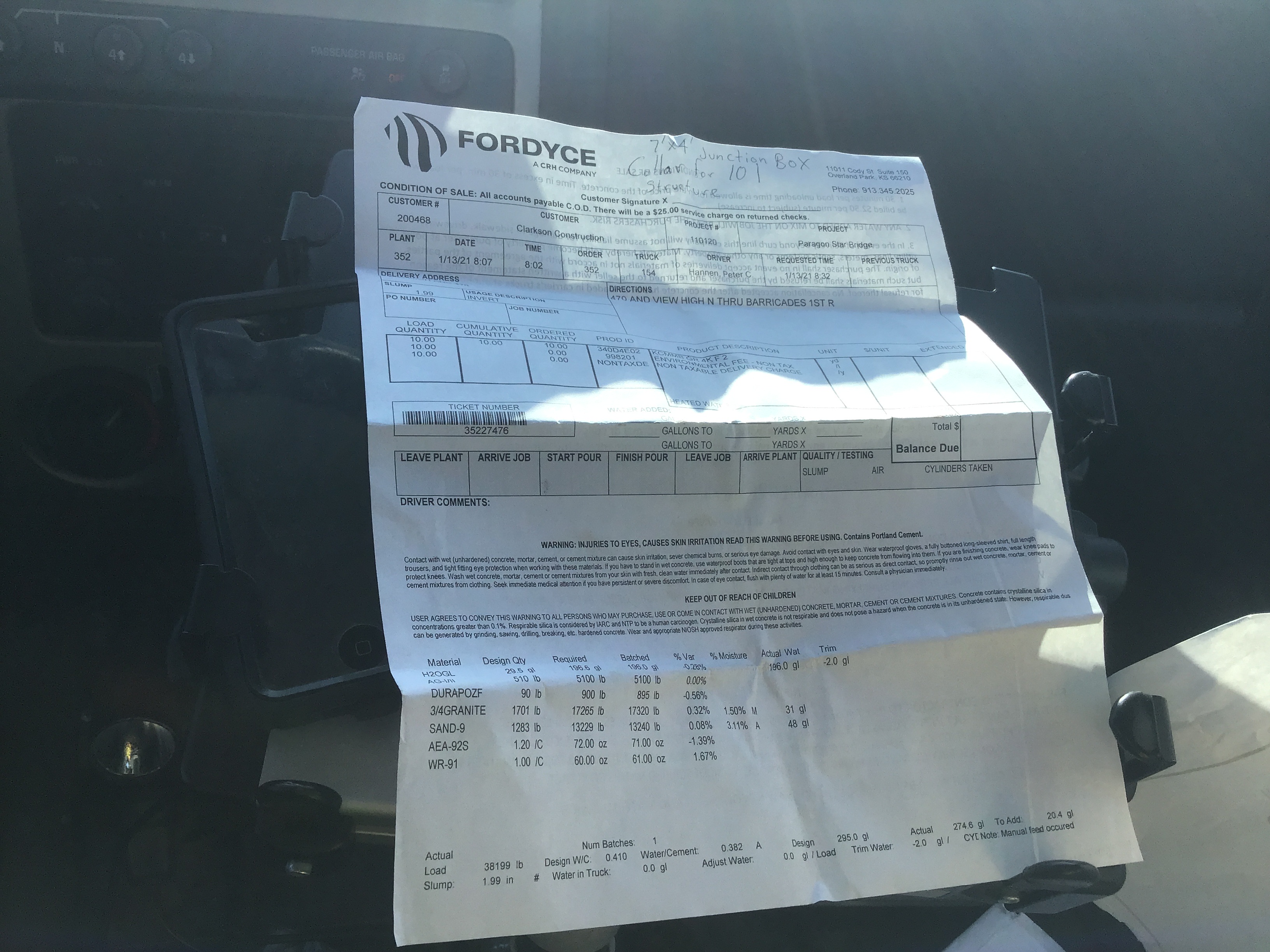

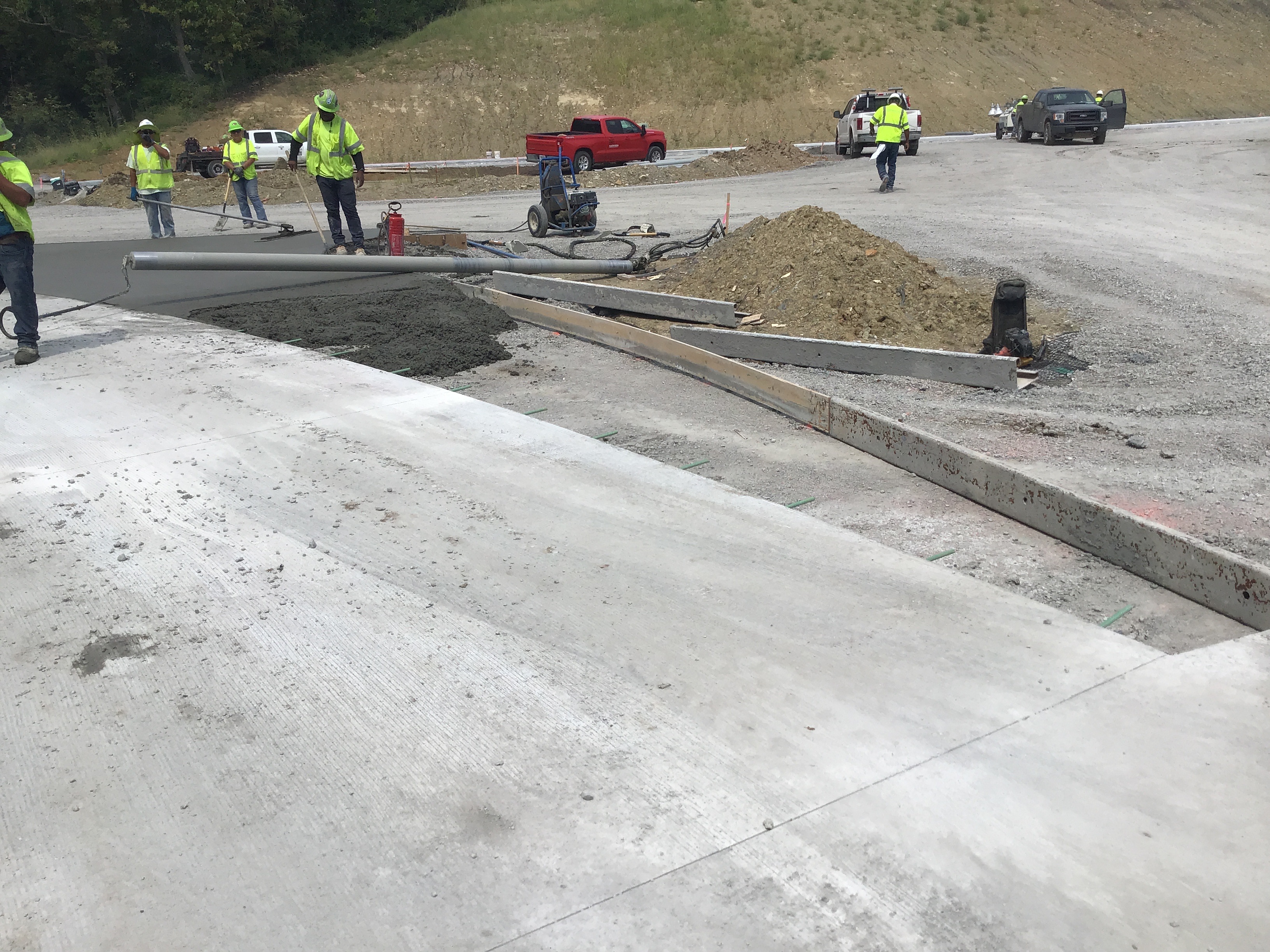

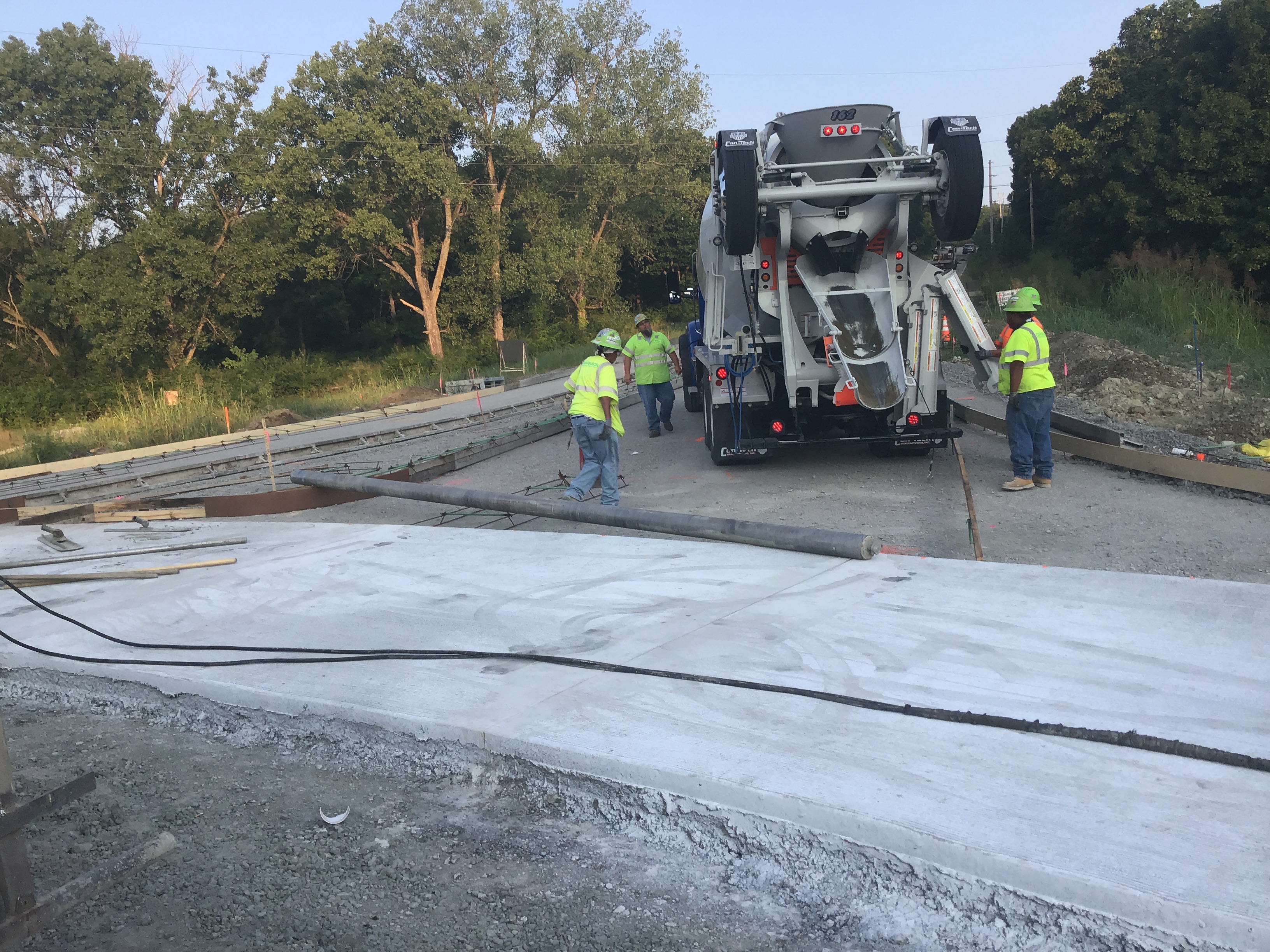

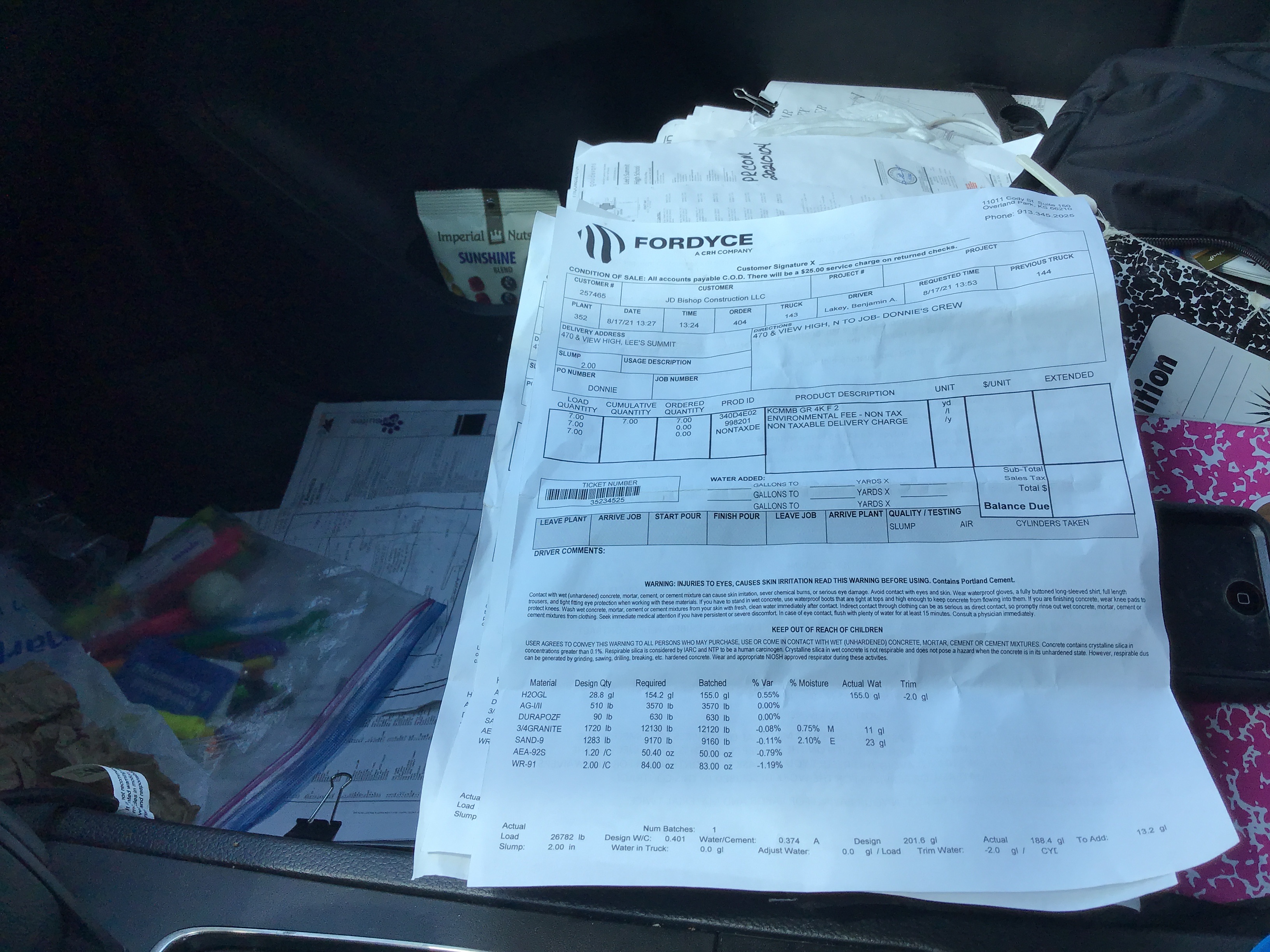

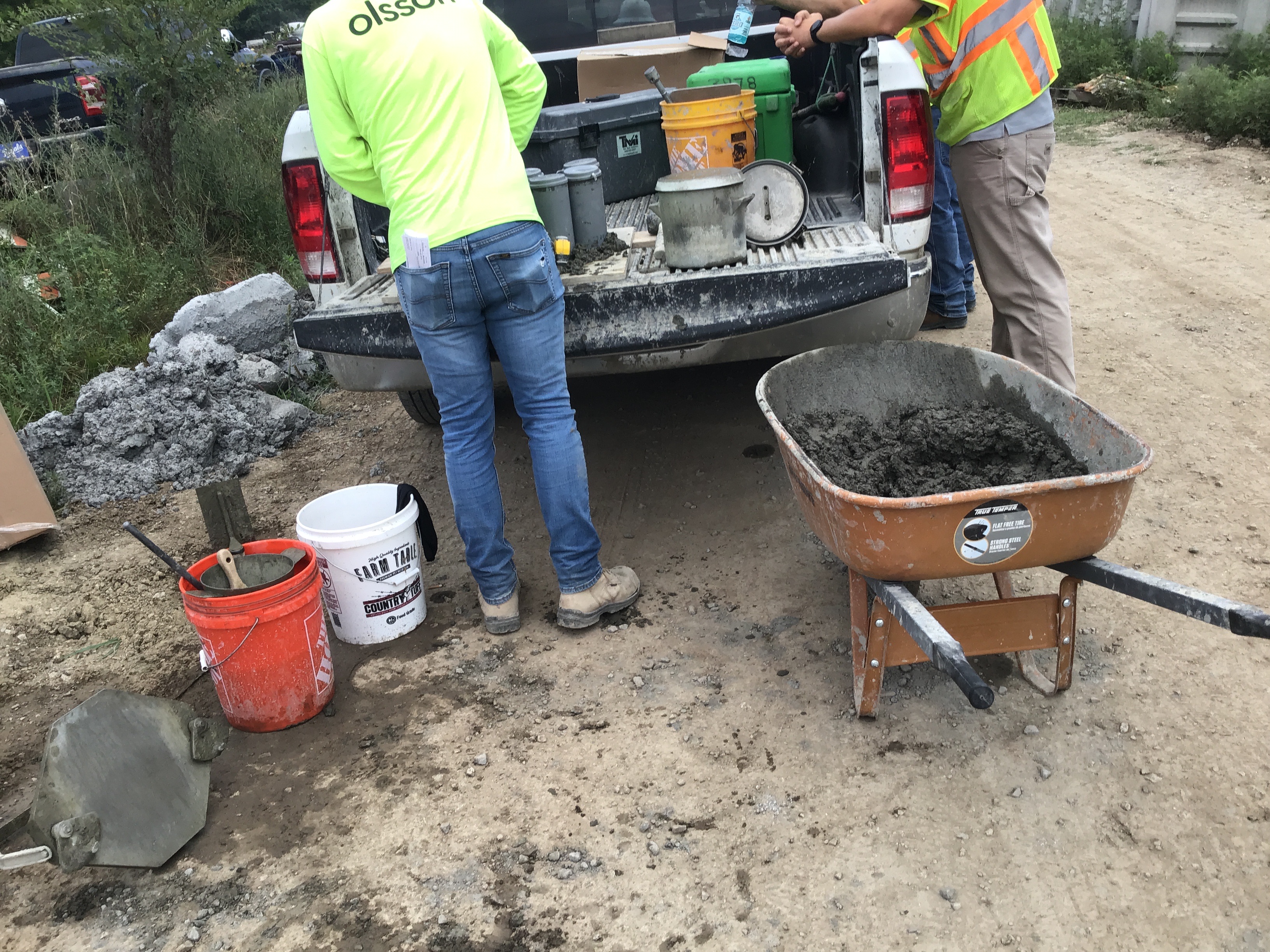

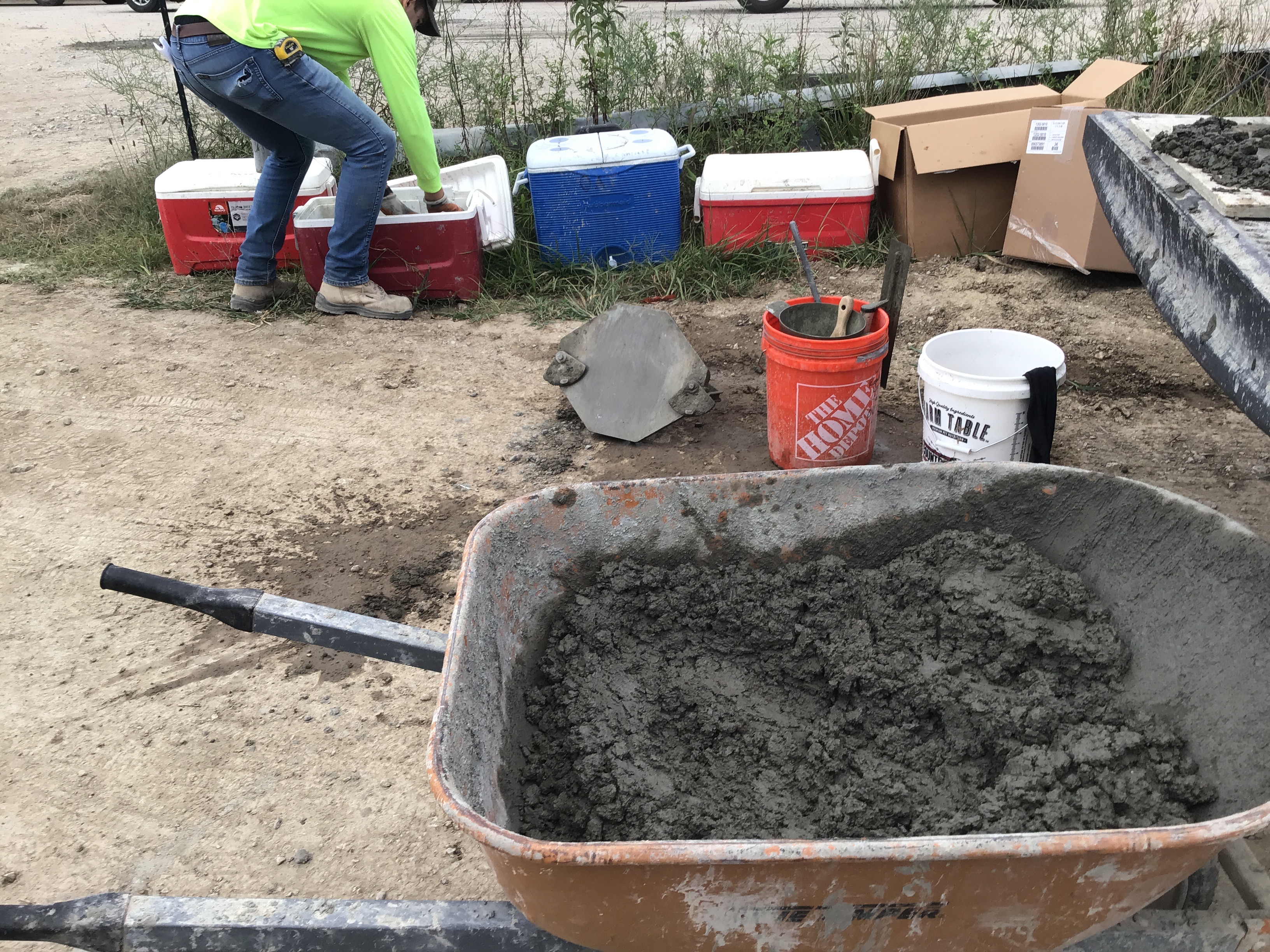

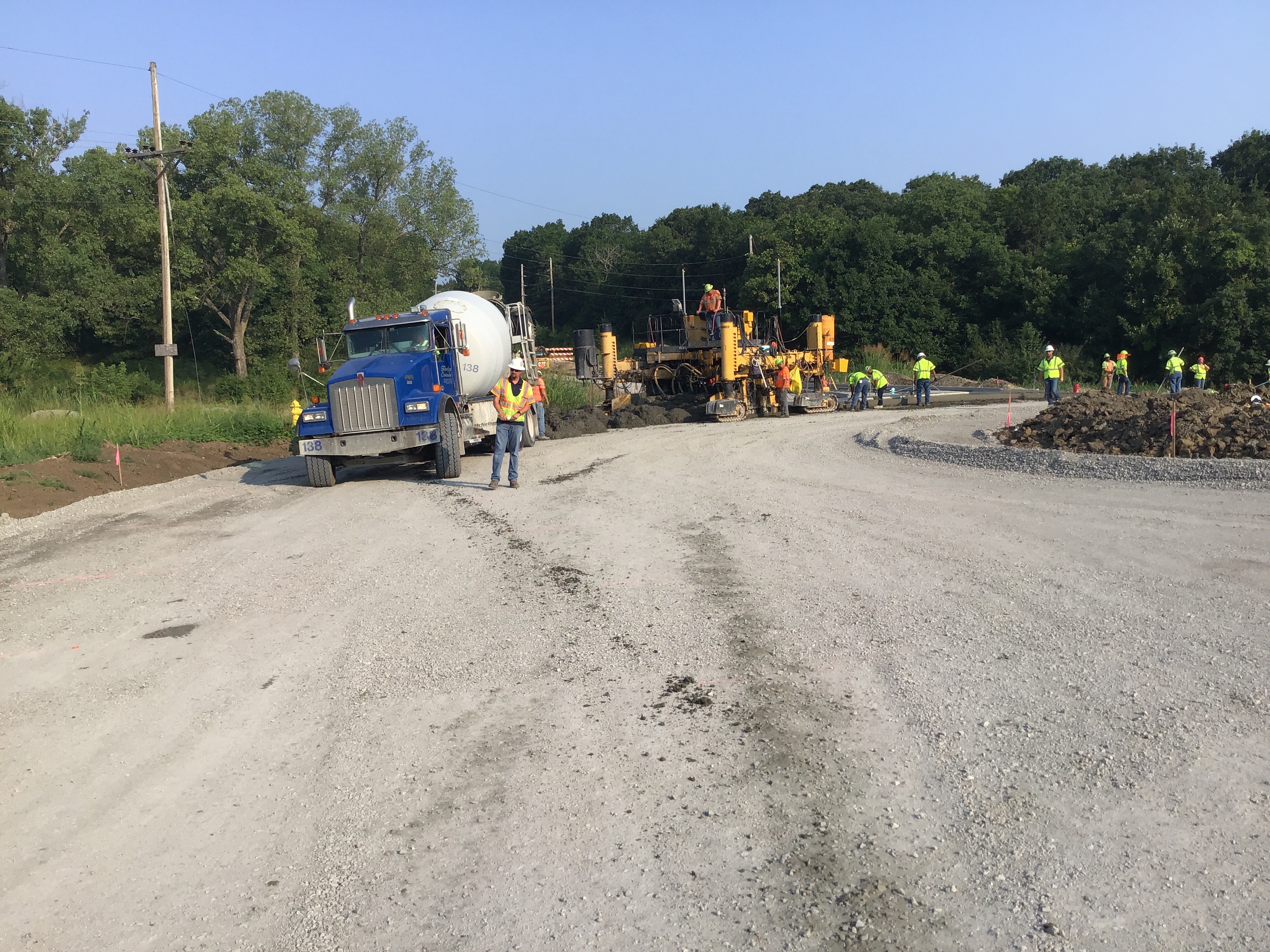

Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Erosion Control Inspection Partial 03/25/2020
Misc
Informational
03/25/2020
Clarkson Construction continue to work on correcting soil erosion systems like rock checks and berms.
Site Visit Complete 4/4/2019 03/25/2020
Resolved
04/08/2019
See Steve Robbins 4/3/19 Site Visit.
Erosion Control Inspection Partial 03/26/2020
Misc
Informational
03/25/2020
Clarkson Construction continue to work on correcting soil erosion systems like rock checks and berms.
Misc
Informational
03/26/2020
Erosion control systems appear to be in place. We will continue to monitor the changes and corrections needed to ensure project site meets guide lines. Met with Fogel Anderson Construction site Superintendent Casey to clear contractor for project restart as per Project Engineer through Inspector observation.
Storm - Outlet Structure Partial 4/8/2020 04/08/2020
Misc
Informational
04/08/2020

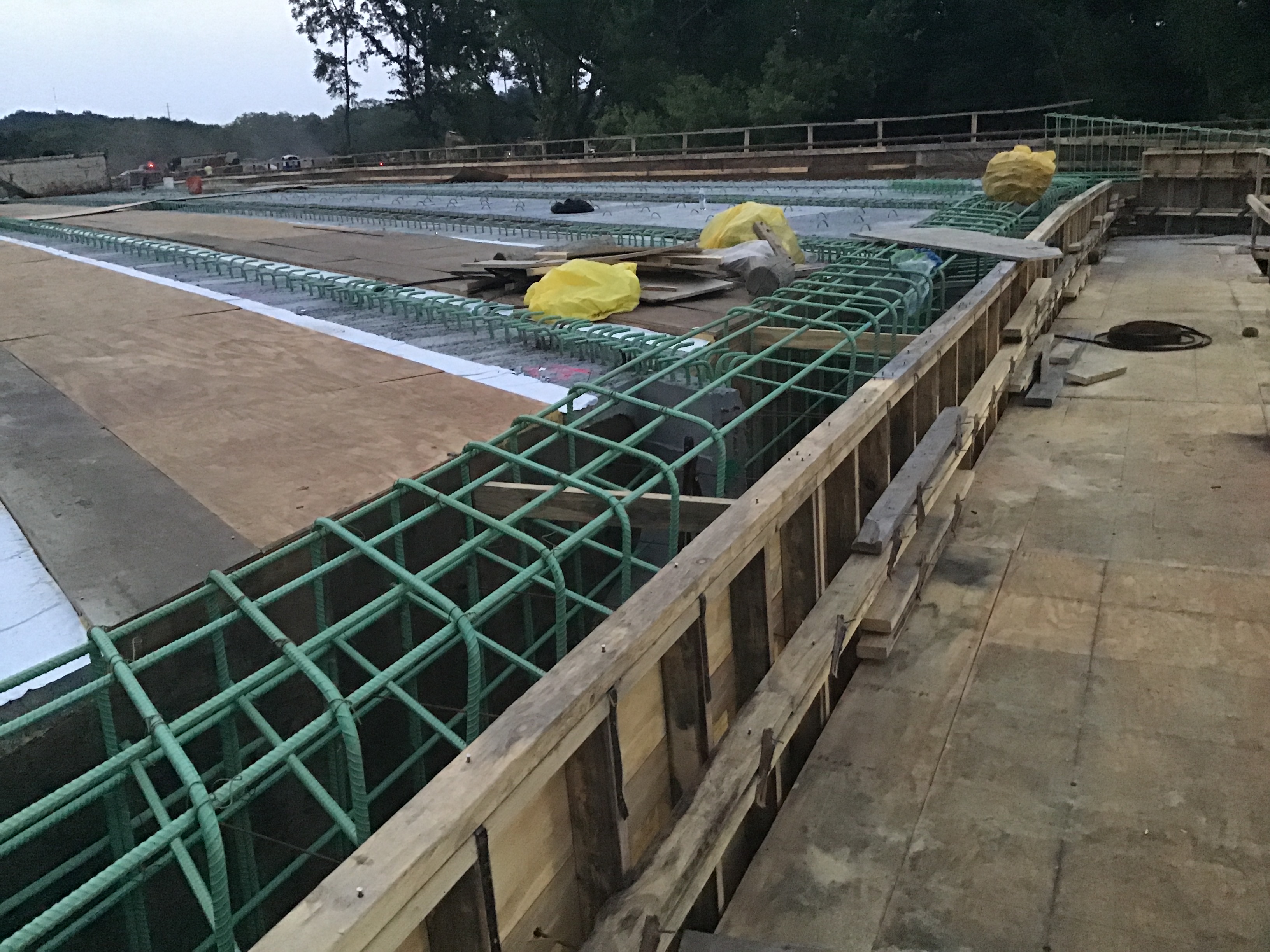

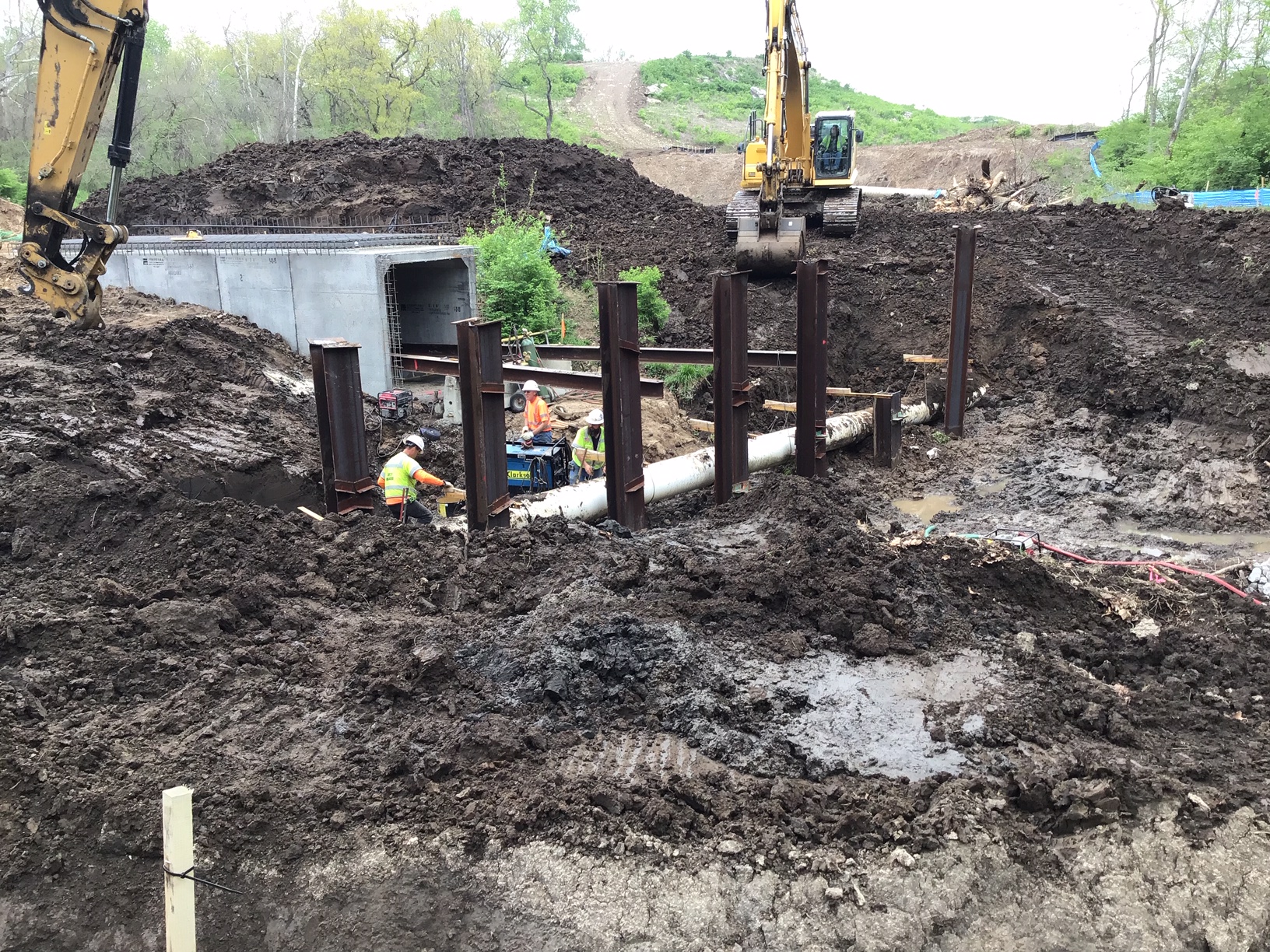

The contractor has been working on forming up the final toe-wall/ end section on line 300 which has been installed. They were pumping the water out and gettin g ready to pour for tomorrow.
Storm - Outlet Structure Partial 4/9/2020 04/15/2020
Misc
Informational
04/08/2020
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
04/15/2020

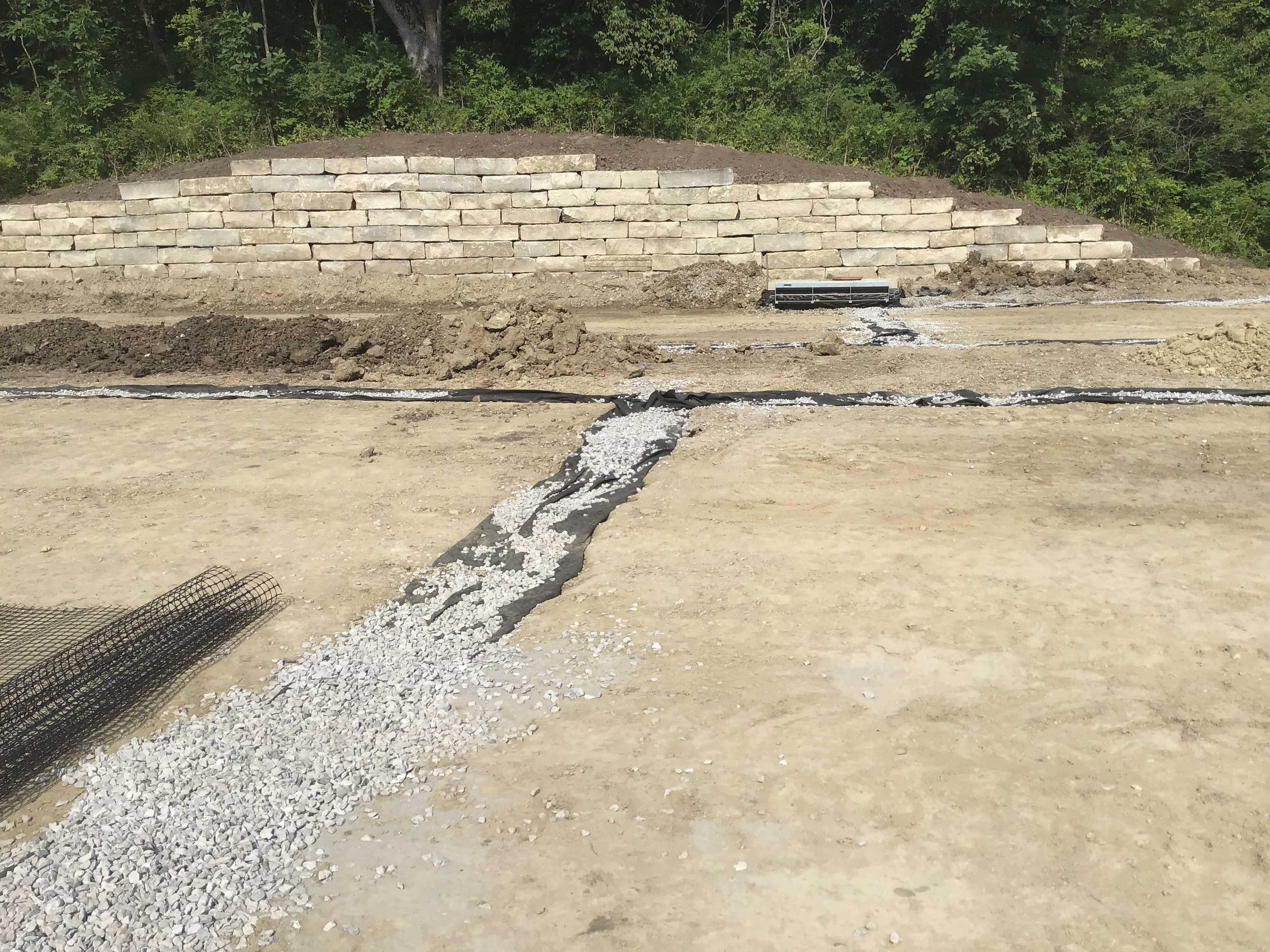

21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Storm - Outlet Structure Partial 04/15/2020
Misc
Informational
04/15/2020

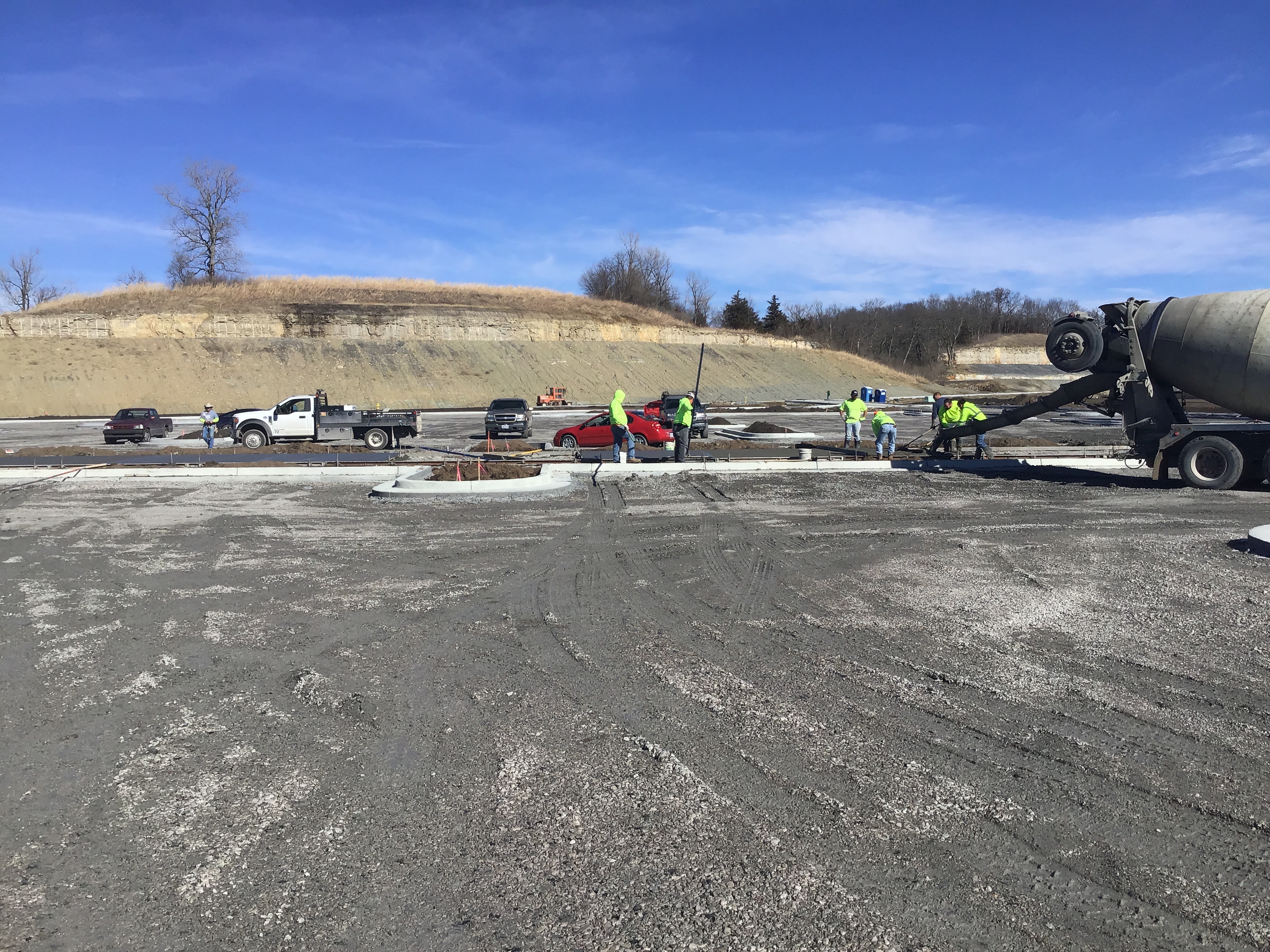

Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
04/15/2020
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
04/15/2020
Collected the last concrete ticket for the pour on Unstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Grading/Excavation/Fill Inspection Partial 04/15/2020
Misc
Informational
04/15/2020

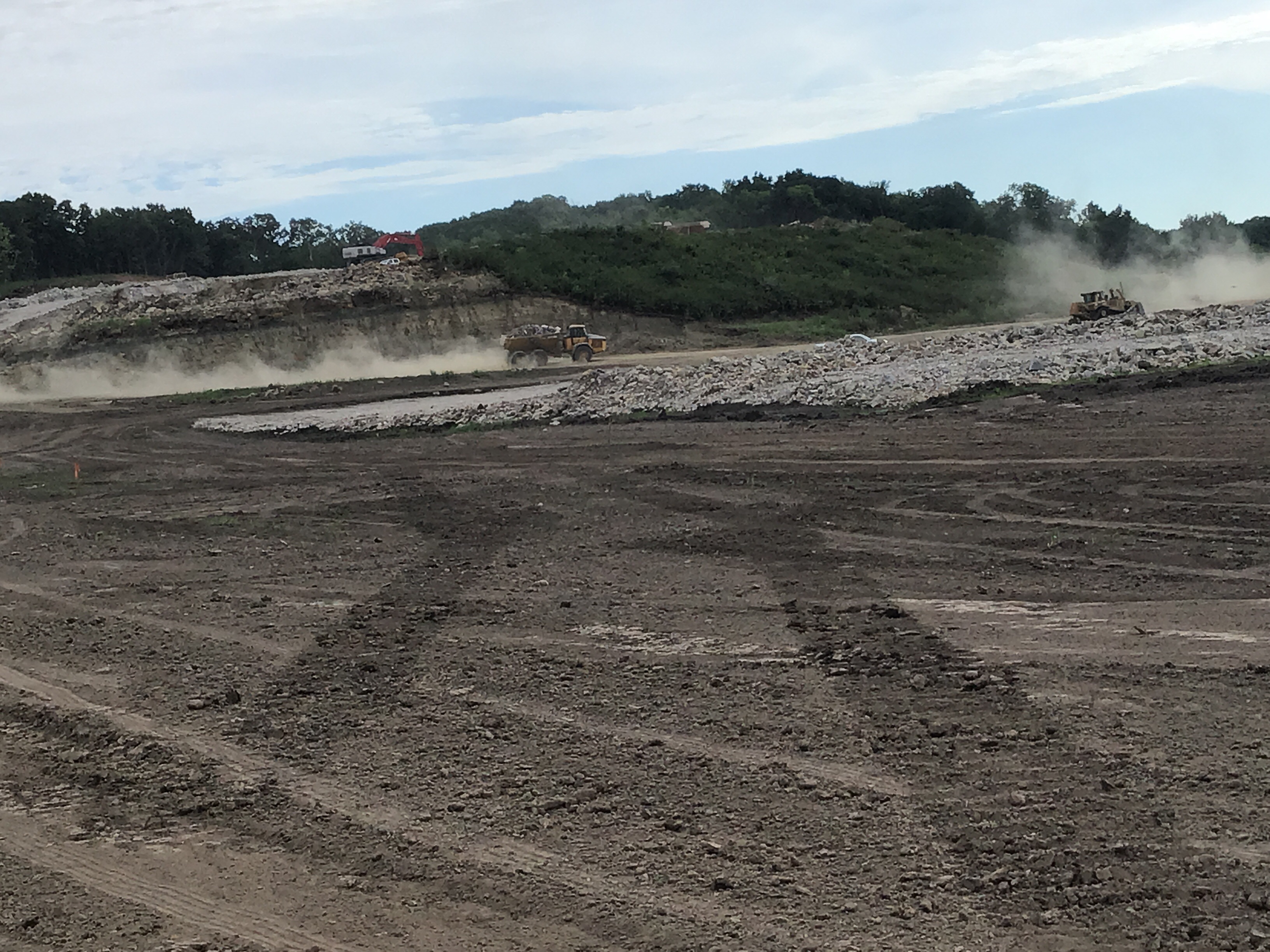

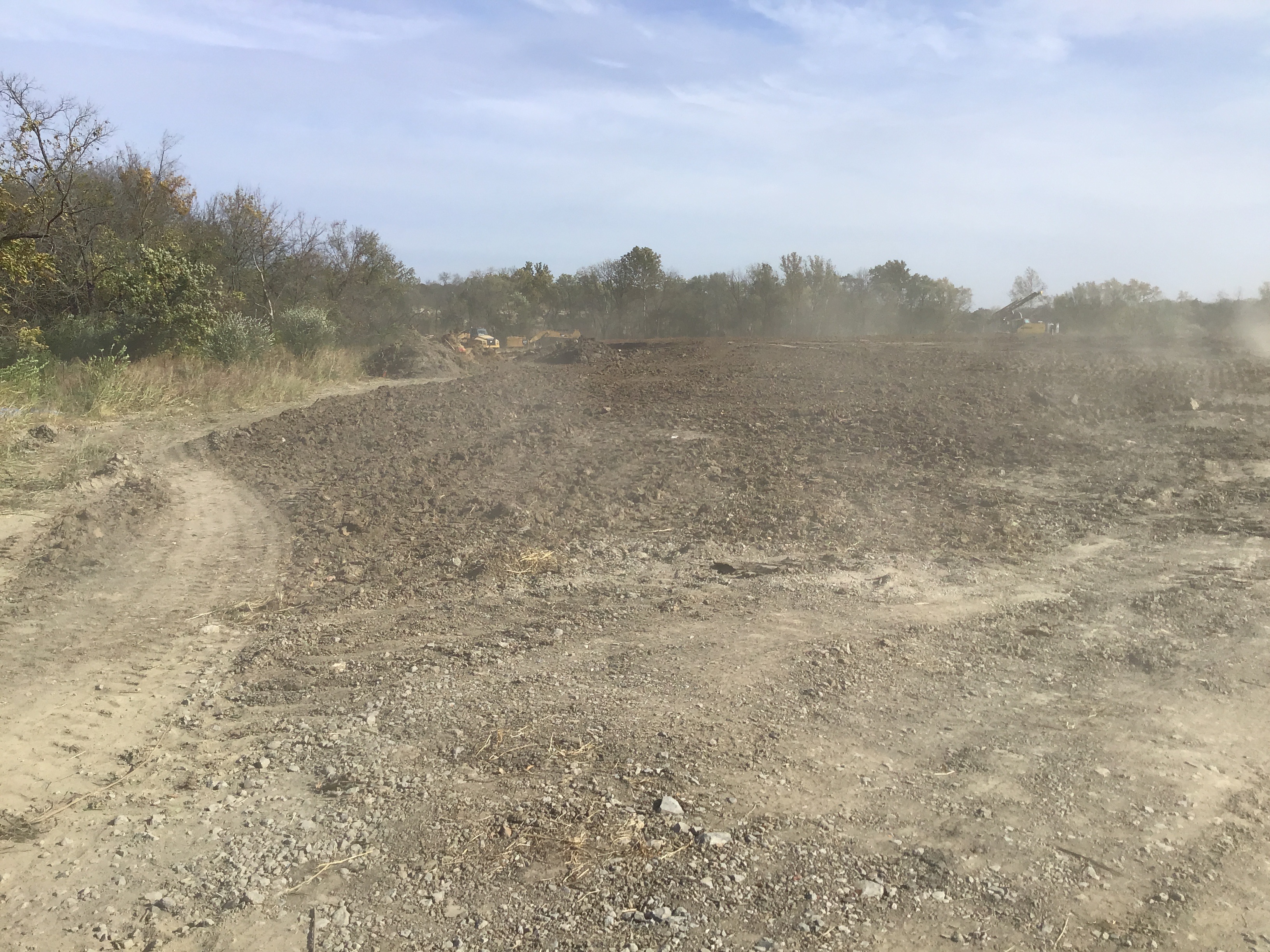

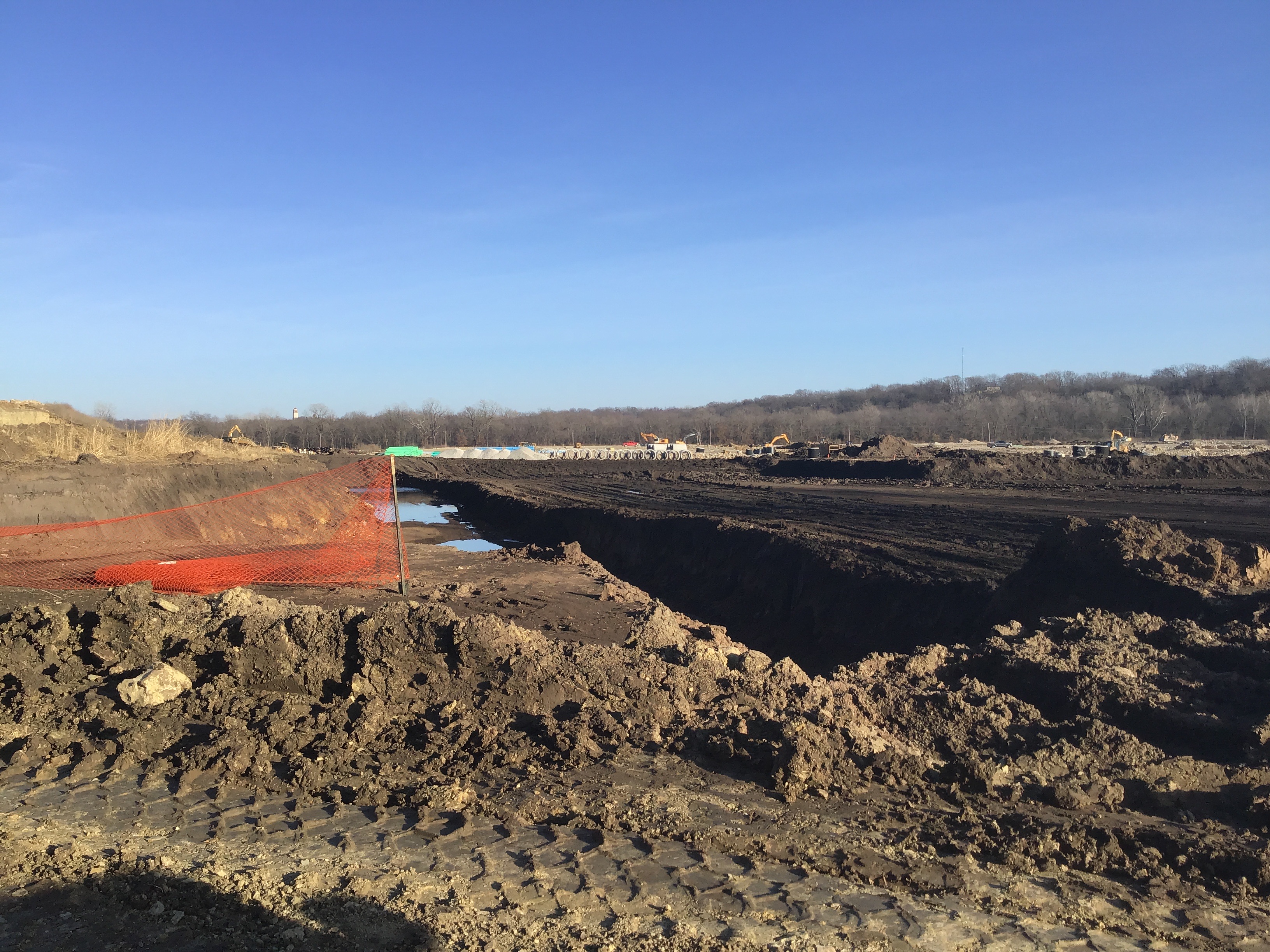

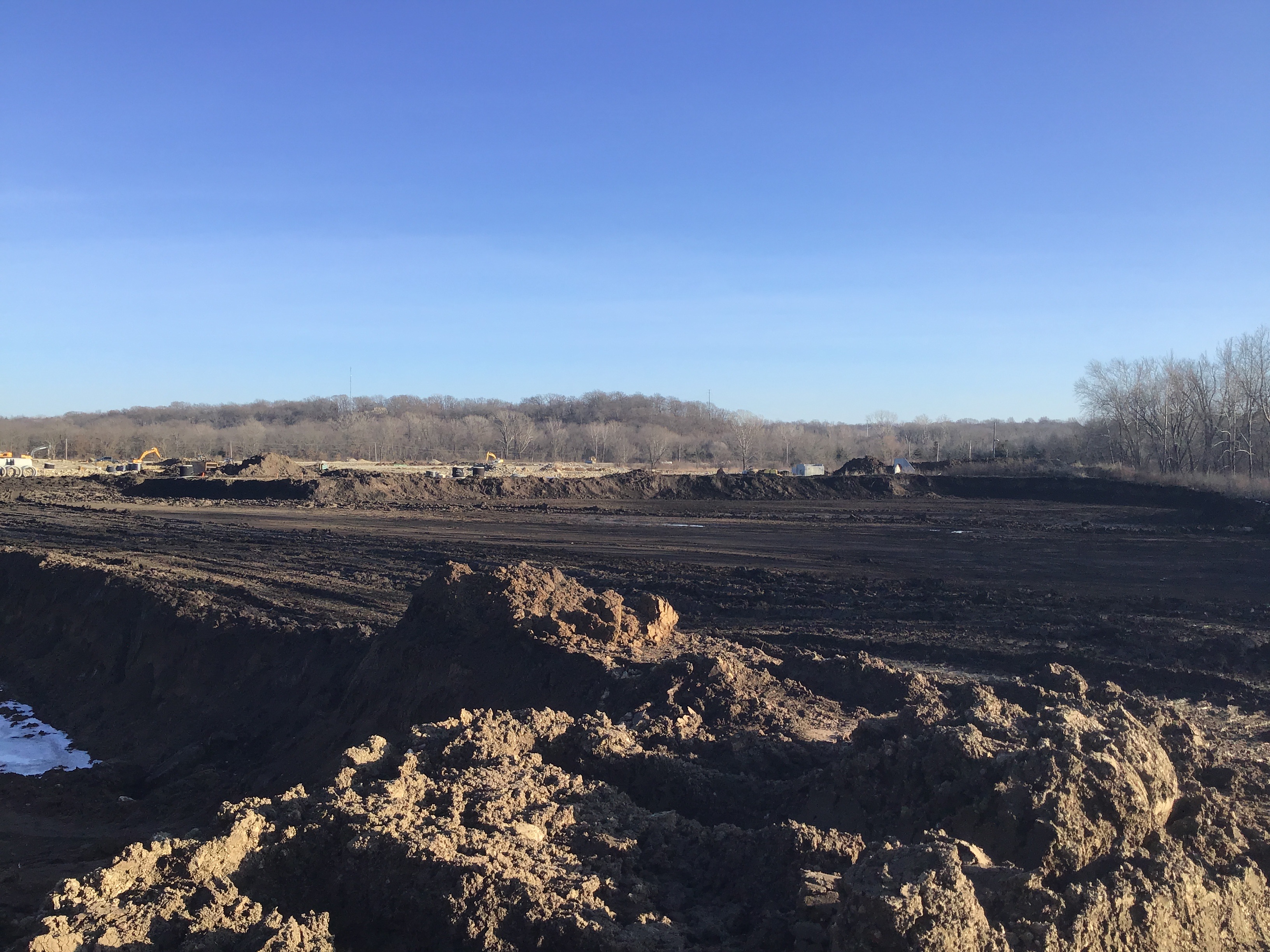

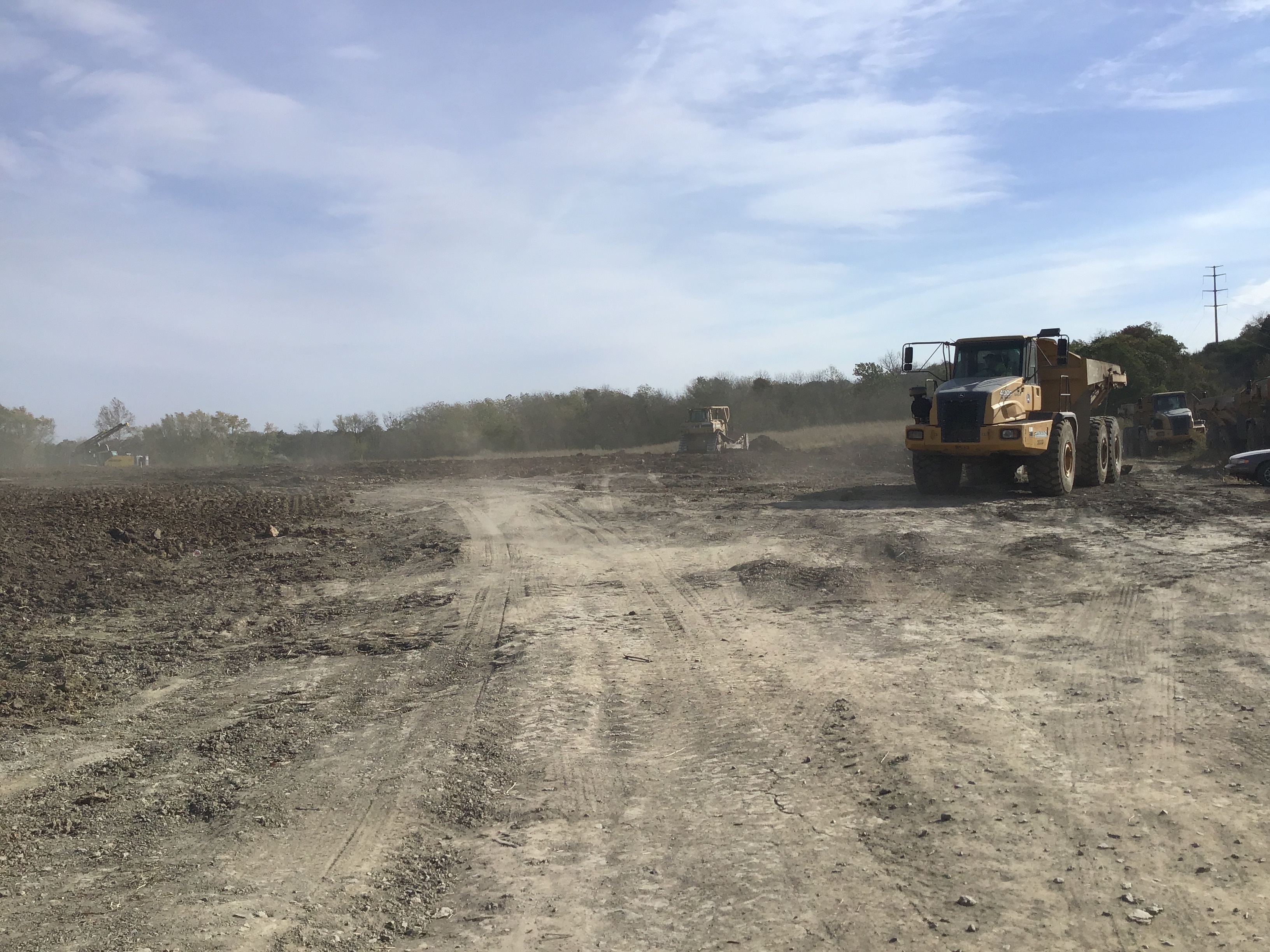

Contractor continued to grade and cutting trees on-site.
Grading/Excavation/Fill Inspection Partial 04/21/2020
Misc
Informational
04/21/2020
Contractor continued to grade and fill onsite.
Storm - Outlet Structure Partial 04/21/2020
Misc
Informational
04/15/2020
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
04/15/2020
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
04/15/2020
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
04/20/2020
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
04/21/2020
Contractor removed forms and continued to work on Toe & Wing walls Upstream and Downstream Storm Structure.
Storm - Outlet Structure Partial 04/23/2020
Misc
Informational
04/21/2020
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
04/21/2020
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
04/21/2020
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
04/21/2020
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
04/23/2020
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
04/23/2020
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Grading/Excavation/Fill Inspection Partial 04/23/2020
Misc
Informational
04/21/2020
Contractor continued to grade and fill onsite.
Misc
Informational
04/23/2020
Contractor continued to fill and grade site as per plan.
Site Visit Partial 04/24/2020
Misc
Informational
04/24/2020

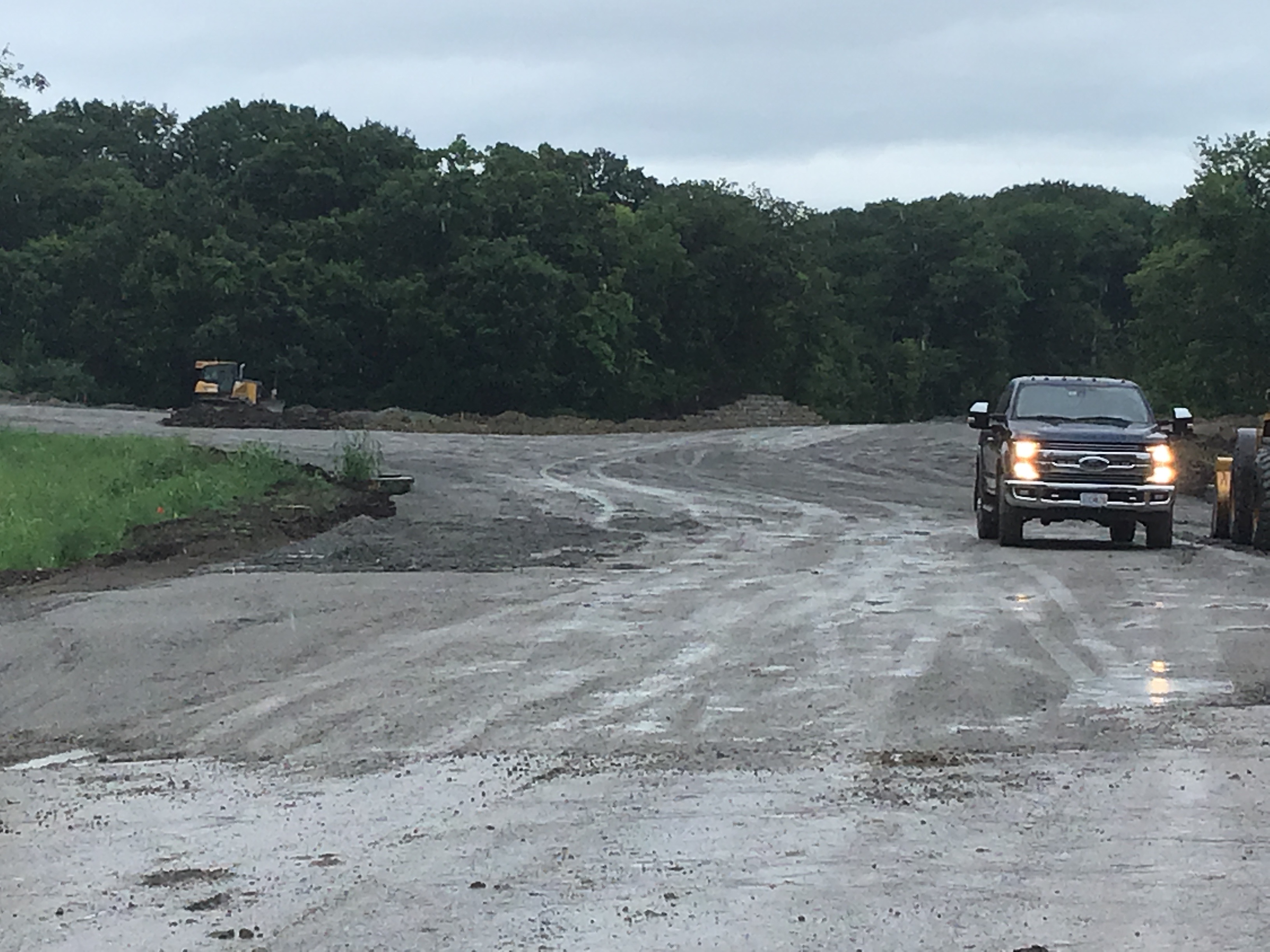

Contractor work on site until 12:00AM due to rains. Grading & Ollson continued compaction test.
Storm - Outlet Structure Partial 04/28/2020
Misc
Informational
04/23/2020
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
04/23/2020
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
04/23/2020
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
04/23/2020
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
04/23/2020
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
04/23/2020
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
04/28/2020
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.

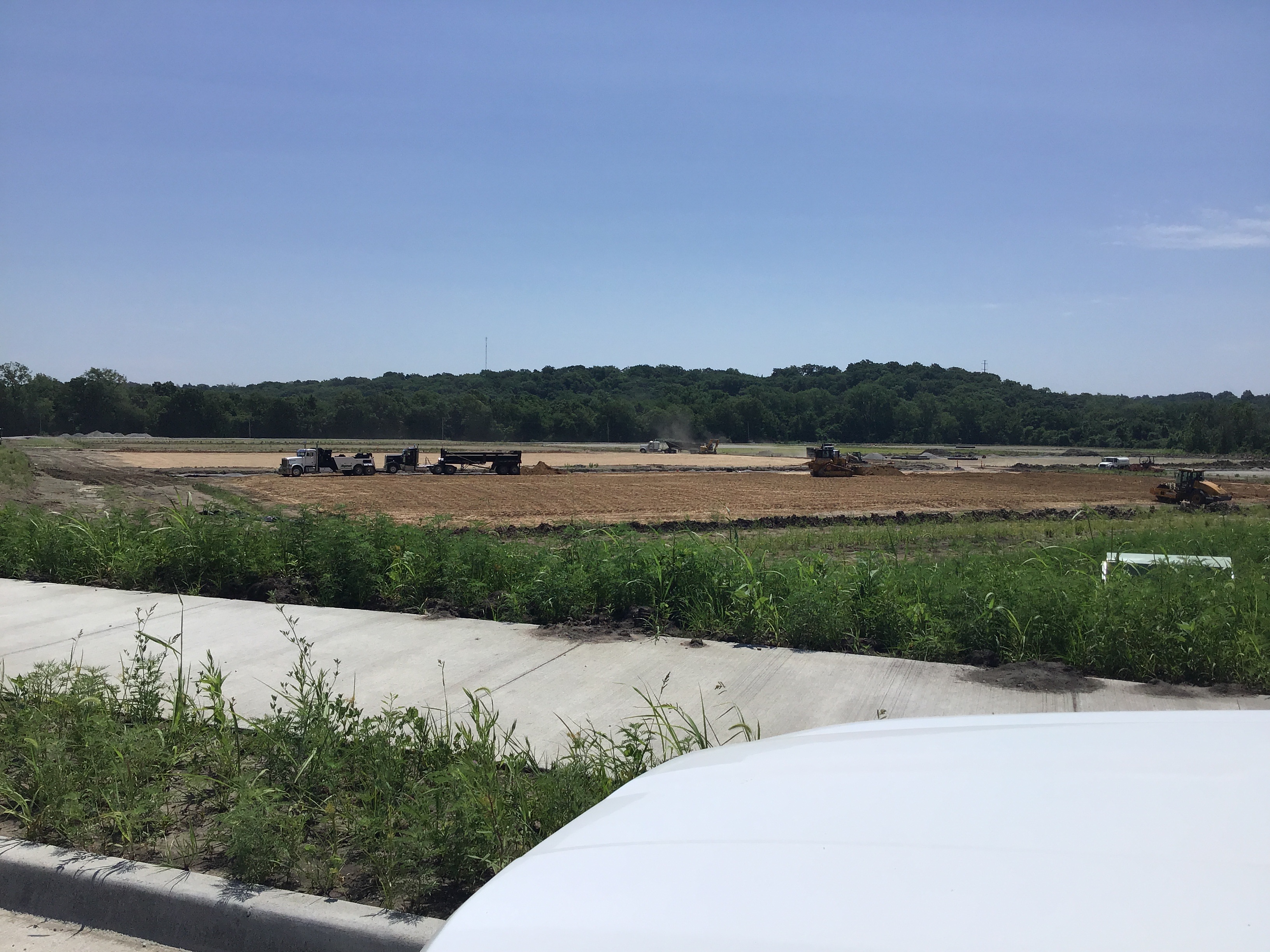

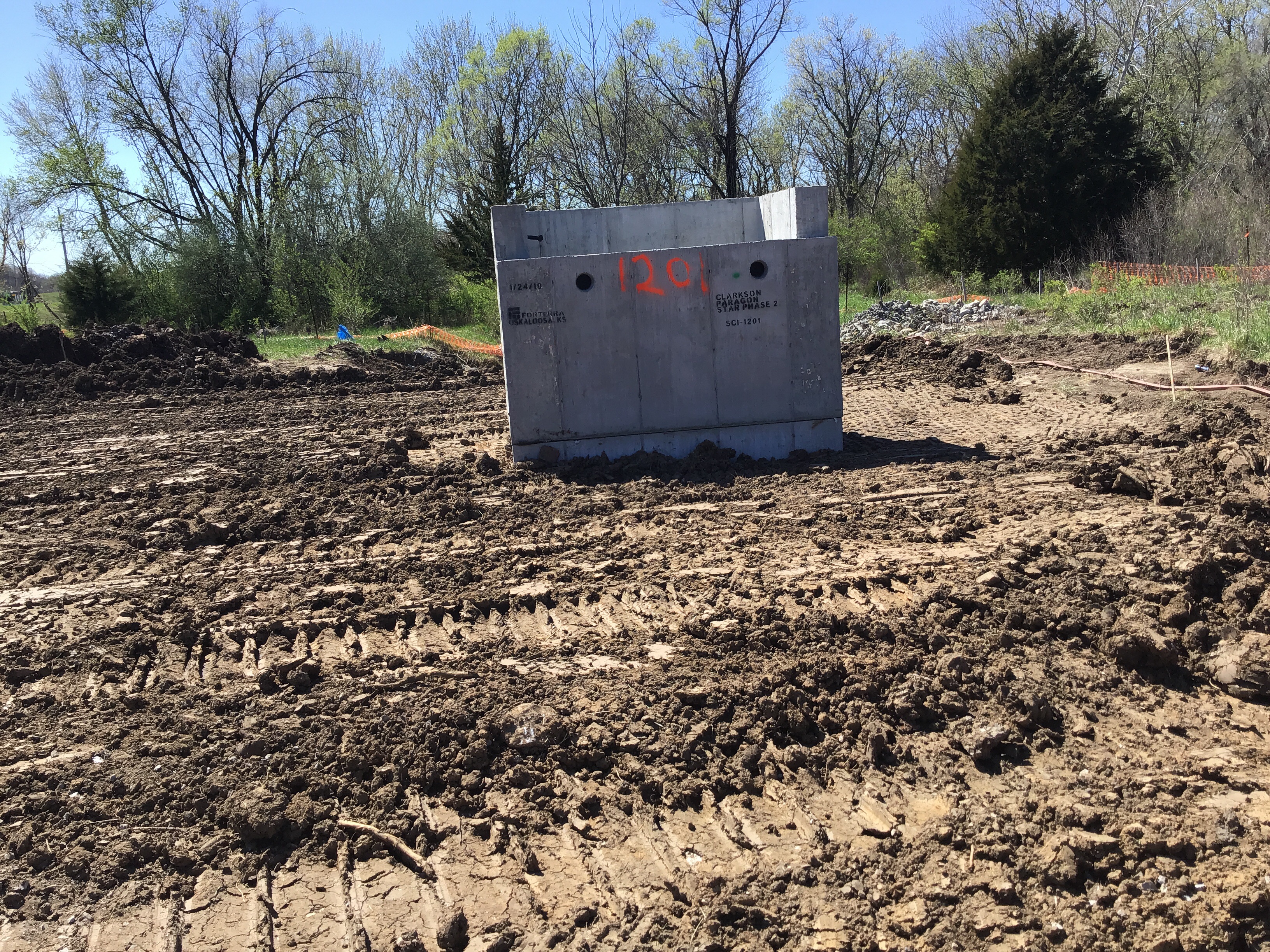

Grading/Excavation/Fill Inspection Partial 05/07/2020
Misc
Informational
04/23/2020
Contractor continued to grade and fill onsite.
Misc
Informational
04/23/2020
Contractor continued to fill and grade site as per plan.
Misc
Informational
04/29/2020
Contractor not working at full force but earthwork. Compaction and grading onsite. Weather 54 degrees and could brief shower through the morning. Report was done at 10:45AM.
Grading/Excavation/Fill Inspection Partial 05/07/2020
Misc
Informational
05/07/2020
Contractor continued to grade and fill onsite.
Misc
Informational
05/07/2020
Contractor continued to fill and grade site as per plan.
Misc
Informational
05/07/2020
Contractor not working at full force but earthwork. Compaction and grading onsite. Weather 54 degrees and could brief shower through the morning. Report was done at 10:45AM.
Misc
Informational
05/07/2020
A lite amount of grading was done it maybe due to the moisture from passed rains.Temperature for today is 61 degrees and cloudy @ 12:39 5/7/20. Olsson Labs was onsite to get soil compaction test .
Grading/Excavation/Fill Inspection Partial 05/19/2020
Misc
Informational
05/07/2020
Contractor continued to grade and fill onsite.
Misc
Informational
05/07/2020
Contractor continued to fill and grade site as per plan.
Misc
Informational
05/07/2020

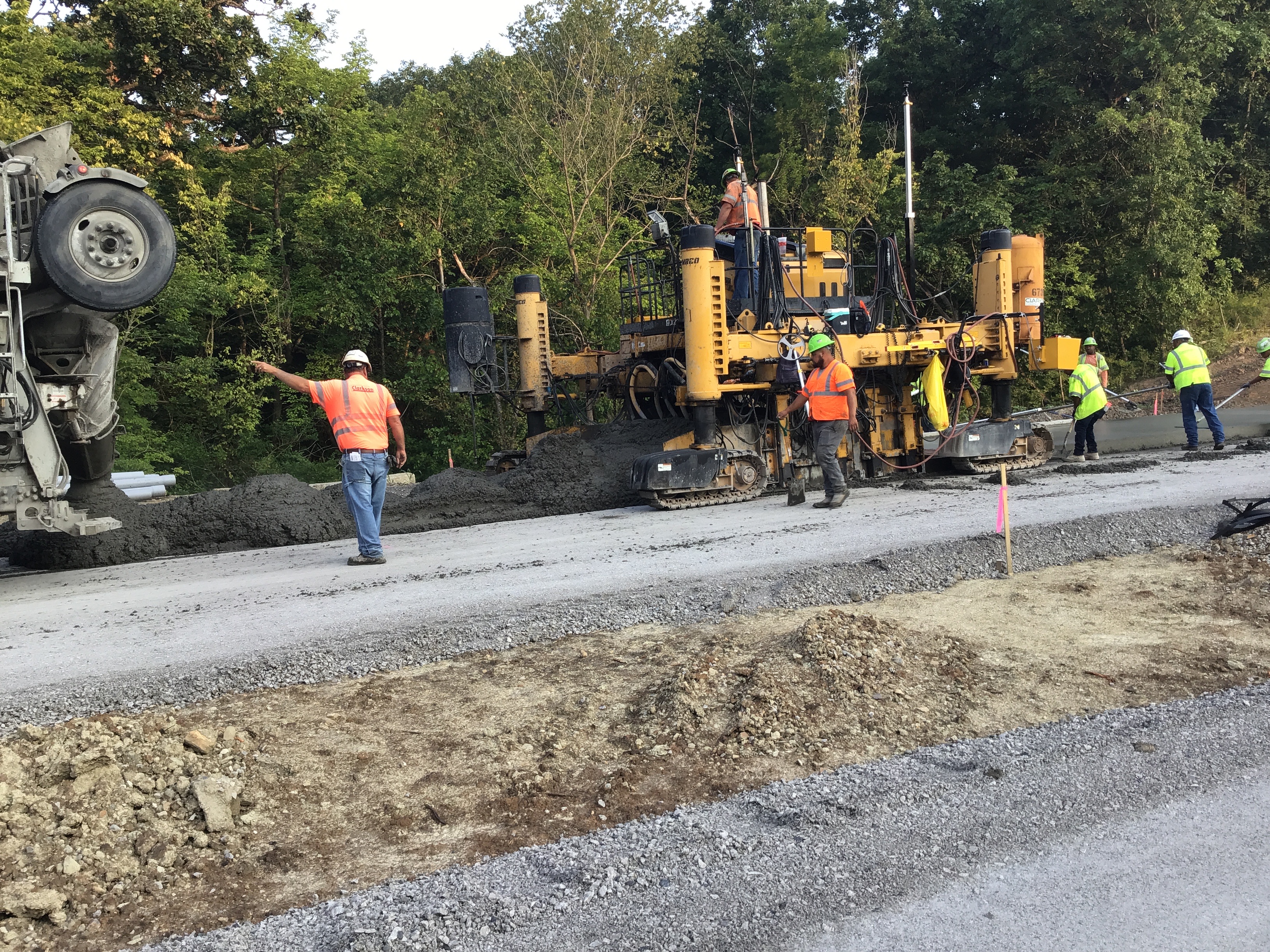

Contractor not working at full force but earthwork. Compaction and grading onsite. Weather 54 degrees and could brief shower through the morning. Report was done at 10:45AM.
Misc
Informational
05/07/2020
A lite amount of grading was done it maybe due to the moisture from passed rains.Temperature for today is 61 degrees and cloudy @ 12:39 5/7/20. Olsson Labs was onsite to get soil compaction test .
Misc
Informational
05/19/2020
Contractor continues to grade and excavate work site as per plan.
Sanitary Sewer Construction Inspection Passed 05/19/2020
Misc
Informational
05/19/2020
Contractor ( Clarkson Cons.) poured concrete encasement around Kanas City Sewer main.
Grading/Excavation/Fill Inspection Partial 05/22/2020
Misc
Informational
05/19/2020
Contractor continued to grade and fill onsite.
Misc
Informational
05/19/2020
Contractor continued to fill and grade site as per plan.
Misc
Informational
05/19/2020
Contractor not working at full force but earthwork. Compaction and grading onsite. Weather 54 degrees and could brief shower through the morning. Report was done at 10:45AM.
Misc
Informational
05/19/2020
A lite amount of grading was done it maybe due to the moisture from passed rains.Temperature for today is 61 degrees and cloudy @ 12:39 5/7/20. Olsson Labs was onsite to get soil compaction test .
Misc
Informational
05/19/2020
Contractor continues to grade and excavate work site as per plan.
Misc
Informational
05/22/2020

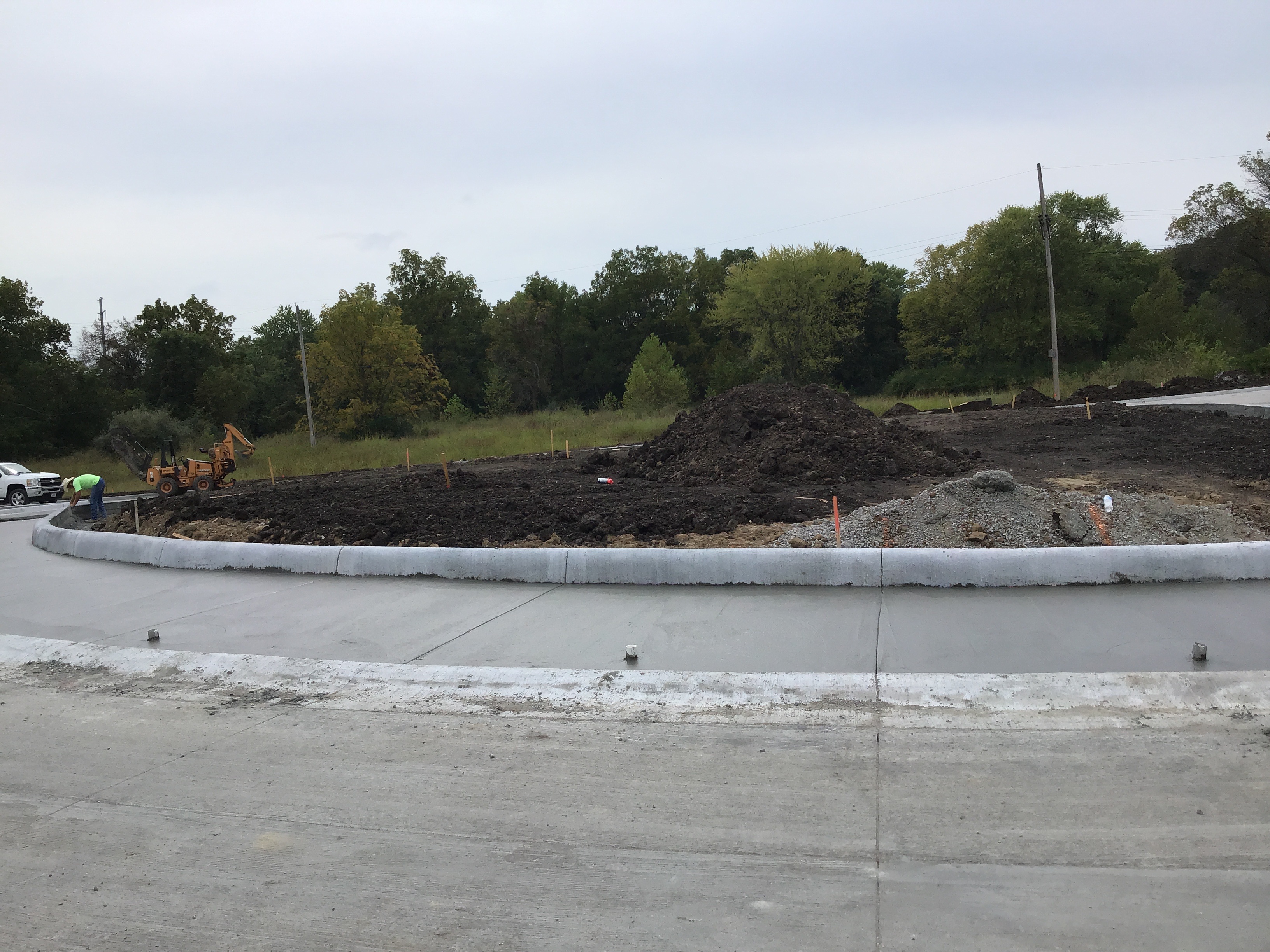

Contractor continued to grade & excavate work site also they began blasting this week. Today there was no work temperatures in the low to mid 60’s cloudy with rains throughout the day..
Grading/Excavation/Fill Inspection Partial 05/22/2020
Misc
Informational
05/22/2020
Contractor continued to grade and fill onsite.
Misc
Informational
05/22/2020
Contractor continued to fill and grade site as per plan.
Misc
Informational
05/22/2020
Contractor not working at full force but earthwork. Compaction and grading onsite. Weather 54 degrees and could brief shower through the morning. Report was done at 10:45AM.
Misc
Informational
05/22/2020
A lite amount of grading was done it maybe due to the moisture from passed rains.Temperature for today is 61 degrees and cloudy @ 12:39 5/7/20. Olsson Labs was onsite to get soil compaction test .
Misc
Informational
05/22/2020
Contractor continues to grade and excavate work site as per plan.
Misc
Informational
05/22/2020
Contractor continued to grade & excavate work site also they began blasting this week. Today there was no work temperatures in the low to mid 60’s cloudy with rains throughout the day..
Misc
Informational
05/22/2020
Contractor installed Geogrid on 5/21/20 covering it with 6” of rural 5.
Erosion Control Inspection Partial 05/28/2020
Misc
Informational
03/26/2020
Clarkson Construction continue to work on correcting soil erosion systems like rock checks and berms.
Misc
Informational
03/26/2020
Erosion control systems appear to be in place. We will continue to monitor the changes and corrections needed to ensure project site meets guide lines. Met with Fogel Anderson Construction site Superintendent Casey to clear contractor for project restart as per Project Engineer through Inspector observation.
Misc
Informational
05/28/2020
Erosion will be check after the rains next week, but for now everything is in place.
Grading/Excavation/Fill Inspection Partial 06/09/2020
Misc
Informational
05/22/2020
Contractor continued to grade and fill onsite.
Misc
Informational
05/22/2020
Contractor continued to fill and grade site as per plan.
Misc
Informational
05/22/2020
Contractor not working at full force but earthwork. Compaction and grading onsite. Weather 54 degrees and could brief shower through the morning. Report was done at 10:45AM.
Misc
Informational
05/22/2020
A lite amount of grading was done it maybe due to the moisture from passed rains.Temperature for today is 61 degrees and cloudy @ 12:39 5/7/20. Olsson Labs was onsite to get soil compaction test .
Misc
Informational
05/22/2020
Contractor continues to grade and excavate work site as per plan.
Misc
Informational
05/22/2020
Contractor continued to grade & excavate work site also they began blasting this week. Today there was no work temperatures in the low to mid 60’s cloudy with rains throughout the day..
Misc
Informational
05/22/2020
Contractor installed Geogrid on 5/21/20 covering it with 6” of rural 5.
Misc
Informational
06/09/2020
Contractor continued to grade & excvate work site contractor continue blasting 6/8/20 Monday. Contractor plans to continually to grade and excavate site until the meet required grading as per plans.
Grading/Excavation/Fill Inspection Partial 06/22/2020
Misc
Informational
06/09/2020
Contractor continued to grade and fill onsite.
Misc
Informational
06/09/2020
Contractor continued to fill and grade site as per plan.
Misc
Informational
06/09/2020
Contractor not working at full force but earthwork. Compaction and grading onsite. Weather 54 degrees and could brief shower through the morning. Report was done at 10:45AM.
Misc
Informational
06/09/2020
A lite amount of grading was done it maybe due to the moisture from passed rains.Temperature for today is 61 degrees and cloudy @ 12:39 5/7/20. Olsson Labs was onsite to get soil compaction test .
Misc
Informational
06/09/2020
Contractor continues to grade and excavate work site as per plan.
Misc
Informational
06/09/2020
Contractor continued to grade & excavate work site also they began blasting this week. Today there was no work temperatures in the low to mid 60’s cloudy with rains throughout the day..
Misc
Informational
06/09/2020
Contractor installed Geogrid on 5/21/20 covering it with 6” of rural 5.
Misc
Informational
06/09/2020
Contractor continued to grade & excvate work site contractor continue blasting 6/8/20 Monday. Contractor plans to continually to grade and excavate site until the meet required grading as per plans.
Misc
Informational
06/22/2020
Contractor (Clark Const.) continues to grade and excavate site to meet required grade, blasting has also been ongoing. The rock from the blasted has been used as shot rock which stabilize subgrade. The rock is jackhammered into smaller pieces near grading site and used . 6/22/20 Monday cloudy overcast.
Fire Line Construction Inspection Partial 06/30/2020
Misc
Informational
06/30/2020

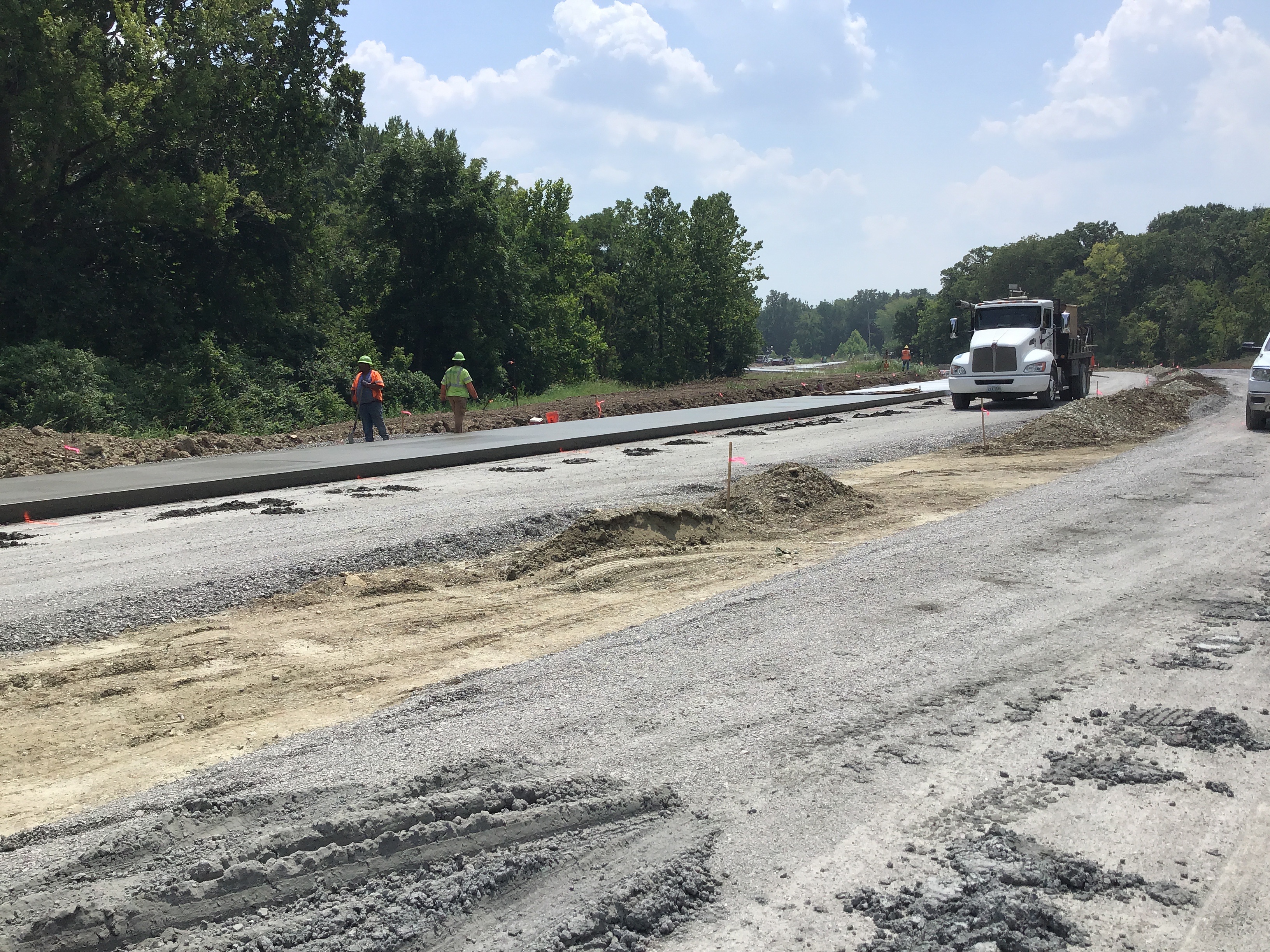

Contractor installed Siamese twin 6” fire protection water mains. Approximately 100’ feet for both lines. 2/90 deg bend on both fire protection lines.
Grading/Excavation/Fill Inspection Partial 07/06/2020
Misc
Informational
06/22/2020
Contractor continued to grade and fill onsite.
Misc
Informational
06/22/2020
Contractor continued to fill and grade site as per plan.
Misc
Informational
06/22/2020
Contractor not working at full force but earthwork. Compaction and grading onsite. Weather 54 degrees and could brief shower through the morning. Report was done at 10:45AM.
Misc
Informational
06/22/2020
A lite amount of grading was done it maybe due to the moisture from passed rains.Temperature for today is 61 degrees and cloudy @ 12:39 5/7/20. Olsson Labs was onsite to get soil compaction test .
Misc
Informational
06/22/2020
Contractor continues to grade and excavate work site as per plan.
Misc
Informational
06/22/2020
Contractor continued to grade & excavate work site also they began blasting this week. Today there was no work temperatures in the low to mid 60’s cloudy with rains throughout the day..
Misc
Informational
06/22/2020
Contractor installed Geogrid on 5/21/20 covering it with 6” of rural 5.
Misc
Informational
06/22/2020
Contractor continued to grade & excvate work site contractor continue blasting 6/8/20 Monday. Contractor plans to continually to grade and excavate site until the meet required grading as per plans.
Misc
Informational
06/22/2020
Contractor (Clark Const.) continues to grade and excavate site to meet required grade, blasting has also been ongoing. The rock from the blasted has been used as shot rock which stabilize subgrade. The rock is jackhammered into smaller pieces near grading site and used . 6/22/20 Monday cloudy overcast.
Misc
Informational
07/06/2020

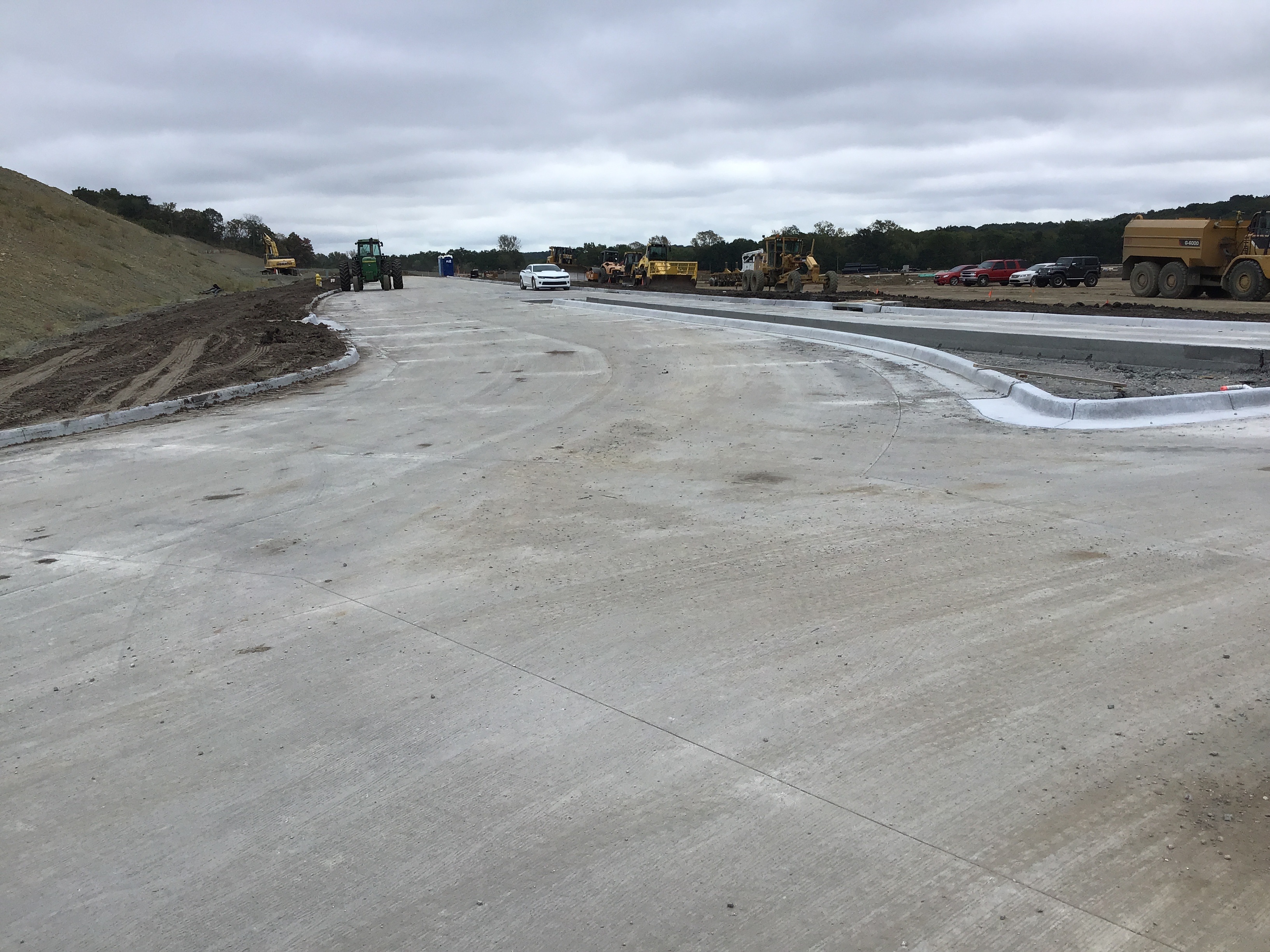

7/6/20 Monday CONTRACTOR - continues to grade low land areas to raise elevation see also (site visit inspection) for information. Rock was broken down to stabilize subgrade.
Grading/Excavation/Fill Inspection Partial 07/13/2020
Misc
Informational
07/06/2020
Contractor continued to grade and fill onsite.
Misc
Informational
07/06/2020
Contractor continued to fill and grade site as per plan.
Misc
Informational
07/06/2020
Contractor not working at full force but earthwork. Compaction and grading onsite. Weather 54 degrees and could brief shower through the morning. Report was done at 10:45AM.
Misc
Informational
07/06/2020
A lite amount of grading was done it maybe due to the moisture from passed rains.Temperature for today is 61 degrees and cloudy @ 12:39 5/7/20. Olsson Labs was onsite to get soil compaction test .
Misc
Informational
07/06/2020
Contractor continues to grade and excavate work site as per plan.
Misc
Informational
07/06/2020
Contractor continued to grade & excavate work site also they began blasting this week. Today there was no work temperatures in the low to mid 60’s cloudy with rains throughout the day..
Misc
Informational
07/06/2020
Contractor installed Geogrid on 5/21/20 covering it with 6” of rural 5.
Misc
Informational
07/06/2020
Contractor continued to grade & excvate work site contractor continue blasting 6/8/20 Monday. Contractor plans to continually to grade and excavate site until the meet required grading as per plans.
Misc
Informational
07/06/2020
Contractor (Clark Const.) continues to grade and excavate site to meet required grade, blasting has also been ongoing. The rock from the blasted has been used as shot rock which stabilize subgrade. The rock is jackhammered into smaller pieces near grading site and used . 6/22/20 Monday cloudy overcast.
Misc
Informational
07/06/2020
7/6/20 Monday CONTRACTOR - continues to grade low land areas to raise elevation see also (site visit inspection) for information. Rock was broken down to stabilize subgrade.
Misc
Informational
07/13/2020

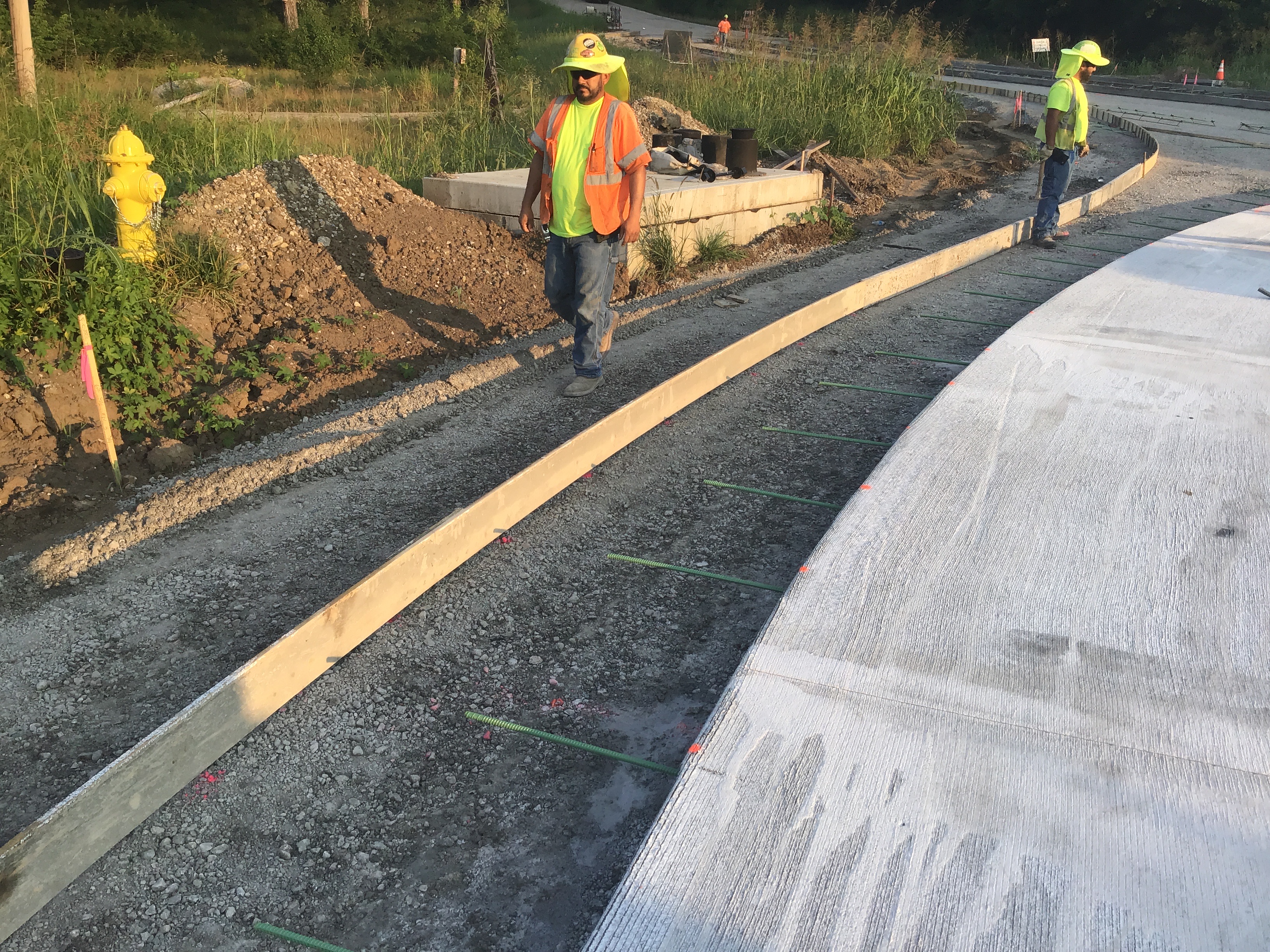

7/13/20 Monday Contractor is still still blast and excavating rock to rise the elevation levels of site. See documentation pics to view site on this day.
Grading/Excavation/Fill Inspection Partial 07/22/2020
Misc
Informational
07/13/2020
Contractor continued to grade and fill onsite.
Misc
Informational
07/13/2020
Contractor continued to fill and grade site as per plan.
Misc
Informational
07/13/2020
Contractor not working at full force but earthwork. Compaction and grading onsite. Weather 54 degrees and could brief shower through the morning. Report was done at 10:45AM.
Misc
Informational
07/13/2020
A lite amount of grading was done it maybe due to the moisture from passed rains.Temperature for today is 61 degrees and cloudy @ 12:39 5/7/20. Olsson Labs was onsite to get soil compaction test .
Misc
Informational
07/13/2020
Contractor continues to grade and excavate work site as per plan.
Misc
Informational
07/13/2020
Contractor continued to grade & excavate work site also they began blasting this week. Today there was no work temperatures in the low to mid 60’s cloudy with rains throughout the day..
Misc
Informational
07/13/2020
Contractor installed Geogrid on 5/21/20 covering it with 6” of rural 5.
Misc
Informational
07/13/2020
Contractor continued to grade & excvate work site contractor continue blasting 6/8/20 Monday. Contractor plans to continually to grade and excavate site until the meet required grading as per plans.
Misc
Informational
07/13/2020
Contractor (Clark Const.) continues to grade and excavate site to meet required grade, blasting has also been ongoing. The rock from the blasted has been used as shot rock which stabilize subgrade. The rock is jackhammered into smaller pieces near grading site and used . 6/22/20 Monday cloudy overcast.
Misc
Informational
07/13/2020
7/6/20 Monday CONTRACTOR - continues to grade low land areas to raise elevation see also (site visit inspection) for information. Rock was broken down to stabilize subgrade.
Misc
Informational
07/13/2020
7/13/20 Monday Contractor is still still blast and excavating rock to rise the elevation levels of site. See documentation pics to view site on this day.
Misc
Informational
07/22/2020

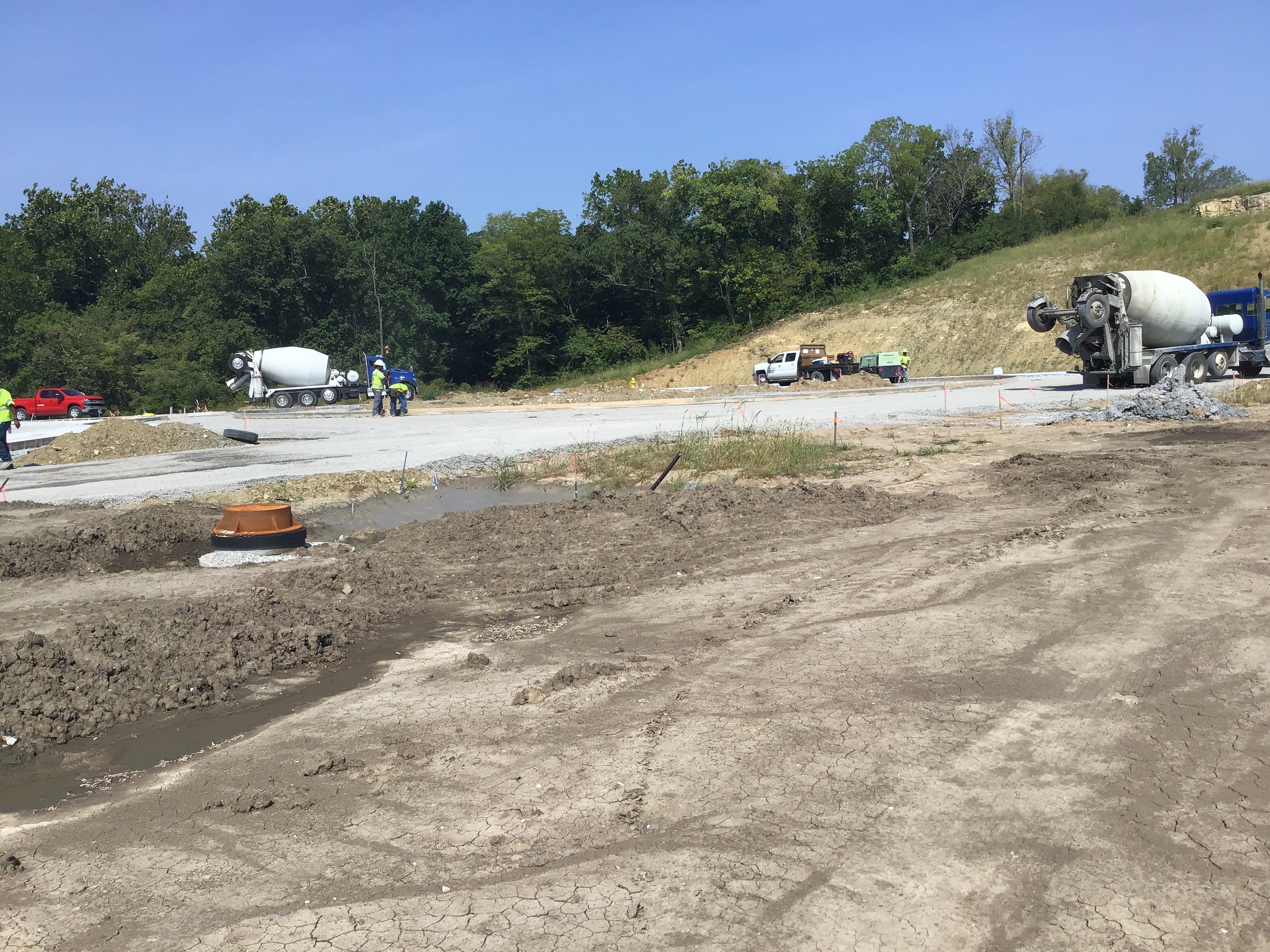

7/22/20 Wednesday Contractor were rain out Monday & Tuesday of this week. The contractor continued to grade site to raise elevation.
Grading/Excavation/Fill Inspection Partial 07/23/2020
Misc
Informational
07/22/2020
Contractor continued to grade and fill onsite.
Misc
Informational
07/22/2020
Contractor continued to fill and grade site as per plan.
Misc
Informational
07/22/2020
Contractor not working at full force but earthwork. Compaction and grading onsite. Weather 54 degrees and could brief shower through the morning. Report was done at 10:45AM.
Misc
Informational
07/22/2020
A lite amount of grading was done it maybe due to the moisture from passed rains.Temperature for today is 61 degrees and cloudy @ 12:39 5/7/20. Olsson Labs was onsite to get soil compaction test .
Misc
Informational
07/22/2020
Contractor continues to grade and excavate work site as per plan.
Misc
Informational
07/22/2020
Contractor continued to grade & excavate work site also they began blasting this week. Today there was no work temperatures in the low to mid 60’s cloudy with rains throughout the day..
Misc
Informational
07/22/2020
Contractor installed Geogrid on 5/21/20 covering it with 6” of rural 5.
Misc
Informational
07/22/2020
Contractor continued to grade & excvate work site contractor continue blasting 6/8/20 Monday. Contractor plans to continually to grade and excavate site until the meet required grading as per plans.
Misc
Informational
07/22/2020
Contractor (Clark Const.) continues to grade and excavate site to meet required grade, blasting has also been ongoing. The rock from the blasted has been used as shot rock which stabilize subgrade. The rock is jackhammered into smaller pieces near grading site and used . 6/22/20 Monday cloudy overcast.
Misc
Informational
07/22/2020
7/6/20 Monday CONTRACTOR - continues to grade low land areas to raise elevation see also (site visit inspection) for information. Rock was broken down to stabilize subgrade.
Misc
Informational
07/22/2020
7/13/20 Monday Contractor is still still blast and excavating rock to rise the elevation levels of site. See documentation pics to view site on this day.
Misc
Informational
07/22/2020
7/22/20 Wednesday Contractor were rain out Monday & Tuesday of this week. The contractor continued to grade site to raise elevation.
Misc
Informational
07/23/2020
7/23/20 Thursday Contractor continued with blast and excavating rock and soil to rise elevation of site.
Grading/Excavation/Fill Inspection Partial 07/28/2020
Misc
Informational
07/23/2020
Contractor continued to grade and fill onsite.
Misc
Informational
07/23/2020
Contractor continued to fill and grade site as per plan.
Misc
Informational
07/23/2020
Contractor not working at full force but earthwork. Compaction and grading onsite. Weather 54 degrees and could brief shower through the morning. Report was done at 10:45AM.
Misc
Informational
07/23/2020
A lite amount of grading was done it maybe due to the moisture from passed rains.Temperature for today is 61 degrees and cloudy @ 12:39 5/7/20. Olsson Labs was onsite to get soil compaction test .
Misc
Informational
07/23/2020
Contractor continues to grade and excavate work site as per plan.
Misc
Informational
07/23/2020
Contractor continued to grade & excavate work site also they began blasting this week. Today there was no work temperatures in the low to mid 60’s cloudy with rains throughout the day..
Misc
Informational
07/23/2020
Contractor installed Geogrid on 5/21/20 covering it with 6” of rural 5.
Misc
Informational
07/23/2020
Contractor continued to grade & excvate work site contractor continue blasting 6/8/20 Monday. Contractor plans to continually to grade and excavate site until the meet required grading as per plans.
Misc
Informational
07/23/2020
Contractor (Clark Const.) continues to grade and excavate site to meet required grade, blasting has also been ongoing. The rock from the blasted has been used as shot rock which stabilize subgrade. The rock is jackhammered into smaller pieces near grading site and used . 6/22/20 Monday cloudy overcast.
Misc
Informational
07/23/2020
7/6/20 Monday CONTRACTOR - continues to grade low land areas to raise elevation see also (site visit inspection) for information. Rock was broken down to stabilize subgrade.
Misc
Informational
07/23/2020
7/13/20 Monday Contractor is still still blast and excavating rock to raise the elevation levels of site. See documentation pics to view site on this day.
Misc
Informational
07/23/2020
7/22/20 Wednesday Contractor were rain out Monday & Tuesday of this week. The contractor continued to grade site to raise elevation.
Misc
Informational
07/23/2020
7/23/20 Thursday Contractor continued with blast and excavating rock and soil to raise elevation of site.
Misc
Informational
07/28/2020
7/28/20 Tuesday Contractor continued excavating rock and soil to raise elevation of site. Rains fell Monday 7/27/20 so there was no site work
Sanitary - Material Verification Partial 08/03/2020
Misc
Informational
08/03/2020

8/3/20 Monday Material Verification 8” sanitary SD-26 pipe is on site. Waiting for permits to clear to began installation of sanitary main.
Grading/Excavation/Fill Inspection Partial 08/03/2020
Misc
Informational

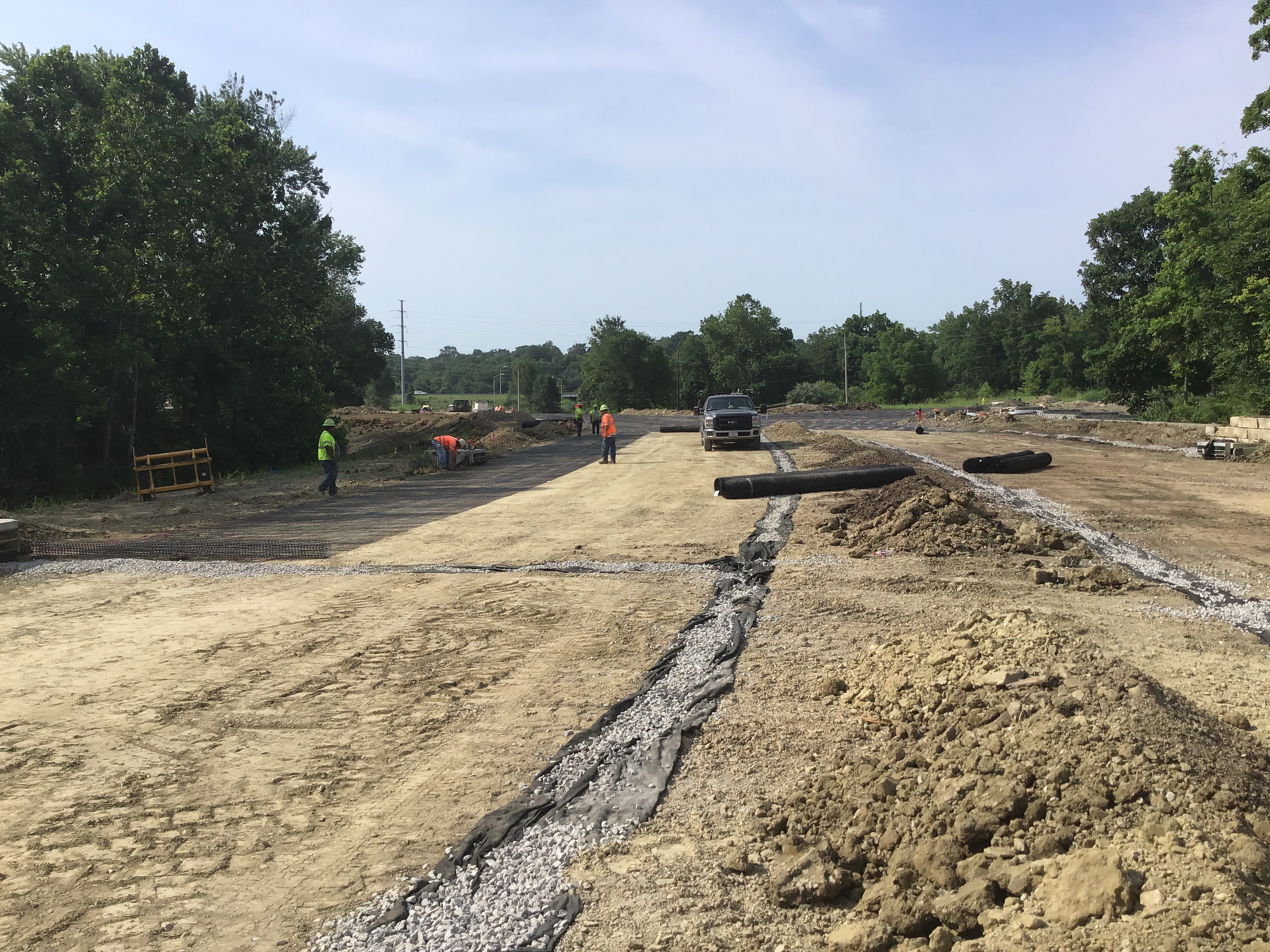

07/28/2020
Contractor continued to grade and fill onsite.
Misc
Informational
07/28/2020
Contractor continued to fill and grade site as per plan.
Misc
Informational
07/28/2020
Contractor not working at full force but earthwork. Compaction and grading onsite. Weather 54 degrees and could brief shower through the morning. Report was done at 10:45AM.
Misc
Informational
07/28/2020
A lite amount of grading was done it maybe due to the moisture from passed rains.Temperature for today is 61 degrees and cloudy @ 12:39 5/7/20. Olsson Labs was onsite to get soil compaction test .
Misc
Informational
07/28/2020
Contractor continues to grade and excavate work site as per plan.
Misc
Informational
07/28/2020
Contractor continued to grade & excavate work site also they began blasting this week. Today there was no work temperatures in the low to mid 60’s cloudy with rains throughout the day..
Misc

Informational
07/28/2020
Contractor installed Geogrid on 5/21/20 covering it with 6” of rural 5.
Misc
Informational
07/28/2020
Contractor continued to grade & excvate work site contractor continue blasting 6/8/20 Monday. Contractor plans to continually to grade and excavate site until the meet required grading as per plans.
Misc
Informational
07/28/2020
Contractor (Clark Const.) continues to grade and excavate site to meet required grade, blasting has also been ongoing. The rock from the blasted has been used as shot rock which stabilize subgrade. The rock is jackhammered into smaller pieces near grading site and used . 6/22/20 Monday cloudy overcast.
Misc
Informational
07/28/2020
7/6/20 Monday CONTRACTOR - continues to grade low land areas to raise elevation see also (site visit inspection) for information. Rock was broken down to stabilize subgrade.
Misc
Informational
07/28/2020
7/13/20 Monday Contractor is still still blast and excavating rock to raise the elevation levels of site. See documentation pics to view site on this day.
Misc
Informational
07/28/2020
7/22/20 Wednesday Contractor were rain out Monday & Tuesday of this week. The contractor continued to grade site to raise elevation.
Misc
Informational
07/28/2020
7/23/20 Thursday Contractor continued with blast and excavating rock and soil to raise elevation of site.
Misc
Informational
07/28/2020
7/28/20 Tuesday Contractor continued excavating rock and soil to raise elevation of site. Rains fell Monday 7/27/20 so there was no site work
Misc
Informational
08/03/2020

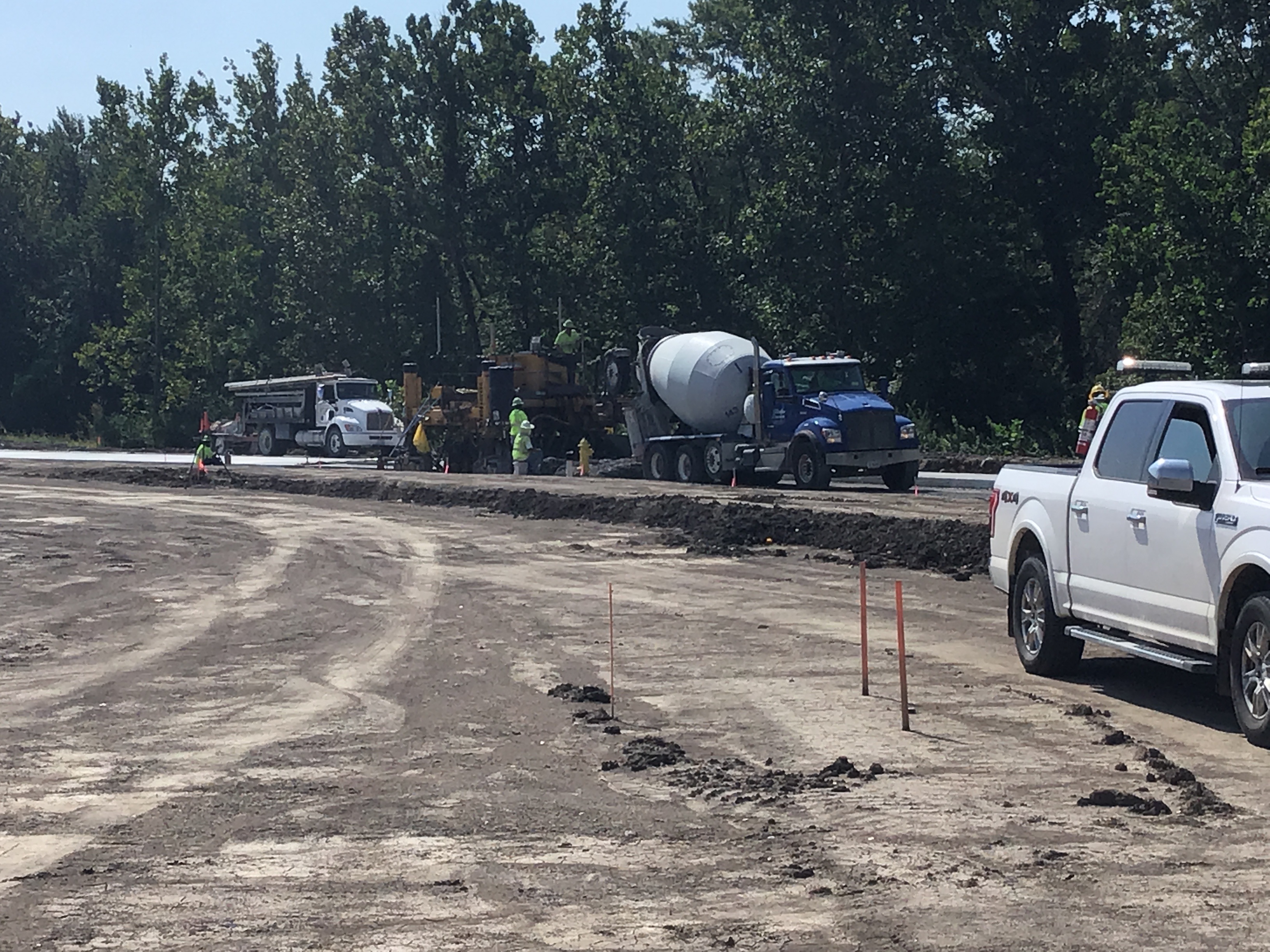

8/3/20 Monday contractor waiting for bore test of site before they continue grading site. Possible large deposit of Shell Rock which is not desirable for fill. No construction work at site today.
Storm - Pipe Partial 09/23/2020
Misc
Informational
09/23/2020
Contractor ( Clarkson Const. ) began excavation for Storm line 4100. Constrution began on the Eastside of View High Road see sheet 13 of 34. Storm Line 4100 will run parallel to the existing Triple Storm. Contractor manage to install one 12X12 section of the line. Contractor believes they will be able to install two additional section of 12x12 storm line.
Storm - Pipe Partial 09/24/2020
Misc
Informational
09/23/2020
Contractor ( Clarkson Const. ) began excavation for Storm line 4100. Constrution began on the Eastside of View High Road see sheet 13 of 34. Storm Line 4100 will run parallel to the existing Triple Storm. Contractor manage to install one 12X12 section of the line.
Misc
Informational
09/24/2020
9/24/20 Thursday Contractor was able to install two Sections of 12x12 of storm line 4100 on 9/23/20. 3:05 PM contractor has installed 5 Section they may possibly excavate more to prepare for the next six Section before they finish work today. Contractor ( Clarkson Const. ) have began to excavate the road to install storm line 4100.
Storm - Pipe Partial 09/25/2020
Misc
Informational
09/24/2020
Contractor ( Clarkson Const. ) began excavation for Storm line 4100. Constrution began on the Eastside of View High Road see sheet 13 of 34. Storm Line 4100 will run parallel to the existing Triple Storm. Contractor manage to install one 12X12 section of the line.
Misc
Informational
09/24/2020
9/24/20 Thursday Contractor was able to install to 12x12 section of storm line 4100 on 9/23/20.
Misc
Informational
09/25/2020
9/25/20 Friday Contractor was able to 5 section of 12’x12’ RCB storm Line on 9/24/20. Excavation of View High Road began. Contractor control install 12’x12’ RCB storm Line to cross View High Road. Contract installed 7 section of 12”x12” RCB for storm Line 4100. Contractor backfilled excavation across View High Drive.
Misc
Informational
09/28/2020
Storm Sewer Construction Inspection Partial 09/29/2020
Misc
Informational
09/29/2020
9/29/30 Tuesday Contractor continued to install 12”X12” RCB Storm Line 4100 ( see DE Storm - Pipe for early progress reports ) contractor laid over seven section 9/28/20 Monday. Contractor has continued excavation and installation across View High Dr as-per plans ( Pg. 13 of 43 ). Olsson was doing compaction test as the contractor backfilled Storm Sewer Line 4100. Olsson reported that the lift numbers looked good.
Storm Sewer Construction Inspection Partial 09/30/2020
Misc
Informational
09/29/2020
9/29/20 Tuesday Contractor continued to install 12”X12” RCB Storm Line 4100 ( see DE Storm - Pipe for early progress reports ) contractor laid over seven section 9/28/20 Monday. Contractor has continued excavation and installation across View High Dr as-per plans ( Pg. 13 of 43 ).
Misc
Informational
09/30/2020
9/30/20 Wednesday Contractor continued back fill Storm Line 4100 while Ollson Testing Lab tested lifts.
Storm Sewer Construction Inspection Partial 10/01/2020
Misc
Informational
09/30/2020
9/29/20 Tuesday Contractor continued to install 12”X12” RCB Storm Line 4100 ( see DE Storm - Pipe for early progress reports ) contractor laid over seven section 9/28/20 Monday. Contractor has continued excavation and installation across View High Dr as-per plans ( Pg. 13 of 43 ).
Misc
Informational
09/30/2020
9/30/20 Wednesday Contractor continued back fill Storm Line 4100 while Ollson Testing Lab tested lifts.
Misc
Informational
10/01/2020
10/1/20 Thursday Contractor continued to backfilled the Storm Line 4100. Contractor began to excavate for the Wing Wall as-per project plan.
Storm Sewer Construction Inspection Partial 10/02/2020
Misc
Informational
10/01/2020
9/29/20 Tuesday Contractor continued to install 12”X12” RCB Storm Line 4100 ( see DE Storm - Pipe for early progress reports ) contractor laid over seven section 9/28/20 Monday. Contractor has continued excavation and installation across View High Dr as-per plans ( Pg. 13 of 43 ).
Misc
Informational
10/01/2020
9/30/20 Wednesday Contractor continued back fill Storm Line 4100 while Ollson Testing Lab tested lifts.
Misc
Informational
10/01/2020
10/1/20 Thursday Contractor continued to backfilled the Storm Line 4100. Contractor began to excavate for the Wing Wall as-per project plan.
Misc
Informational
10/02/2020
10/2/20 Friday Contractor continues to backfill the Storm line 4100 in lifts and remove excavated soil to other site areas to raise elevation levels.
Storm Sewer Construction Inspection Partial 10/12/2020
Misc
Informational
10/02/2020
9/29/20 Tuesday Contractor continued to install 12”X12” RCB Storm Line 4100 ( see DE Storm - Pipe for early progress reports ) contractor laid over seven section 9/28/20 Monday. Contractor has continued excavation and installation across View High Dr as-per plans ( Pg. 13 of 43 ).
Misc
Informational
10/02/2020
9/30/20 Wednesday Contractor continued back fill Storm Line 4100 while Ollson Testing Lab tested lifts.
Misc
Informational
10/02/2020
10/1/20 Thursday Contractor continued to backfilled the Storm Line 4100. Contractor began to excavate for the Wing Wall as-per project plan.
Misc
Informational
10/02/2020
10/2/20 Friday Contractor continues to backfill the Storm line 4100 in lifts and remove excavated soil to other site areas to raise elevation levels.
Misc
Informational
10/12/2020
10/12/20 Monday Contractor began to frame and from for Plate Forms and Toe Walls on the West & East side of Storm Line 4100 that extends across View High Drive 10/5 thru 10/9. Contractor poured Plate Form on the Westside of Storm Line 4100 as per project plans.
Storm Sewer Construction Inspection Partial 10/13/2020
Misc
Informational
10/12/2020
9/29/20 Tuesday Contractor continued to install 12”X12” RCB Storm Line 4100 ( see DE Storm - Pipe for early progress reports ) contractor laid over seven section 9/28/20 Monday. Contractor has continued excavation and installation across View High Dr as-per plans ( Pg. 13 of 43 ).
Misc
Informational
10/12/2020
9/30/20 Wednesday Contractor continued back fill Storm Line 4100 while Ollson Testing Lab tested lifts.
Misc
Informational
10/12/2020
10/1/20 Thursday Contractor continued to backfilled the Storm Line 4100. Contractor began to excavate for the Wing Wall as-per project plan.
Misc
Informational
10/12/2020
10/2/20 Friday Contractor continues to backfill the Storm line 4100 in lifts and remove excavated soil to other site areas to raise elevation levels.
Misc
Informational
10/12/2020
10/12/20 Monday Contractor began to frame and from for Plate Forms and Toe Walls on the West & East side of Storm Line 4100 that extends across View High Drive 10/5 thru 10/9. Contractor poured Plate Form on the Westside of Storm Line 4100 as per project plans.
Misc
Informational

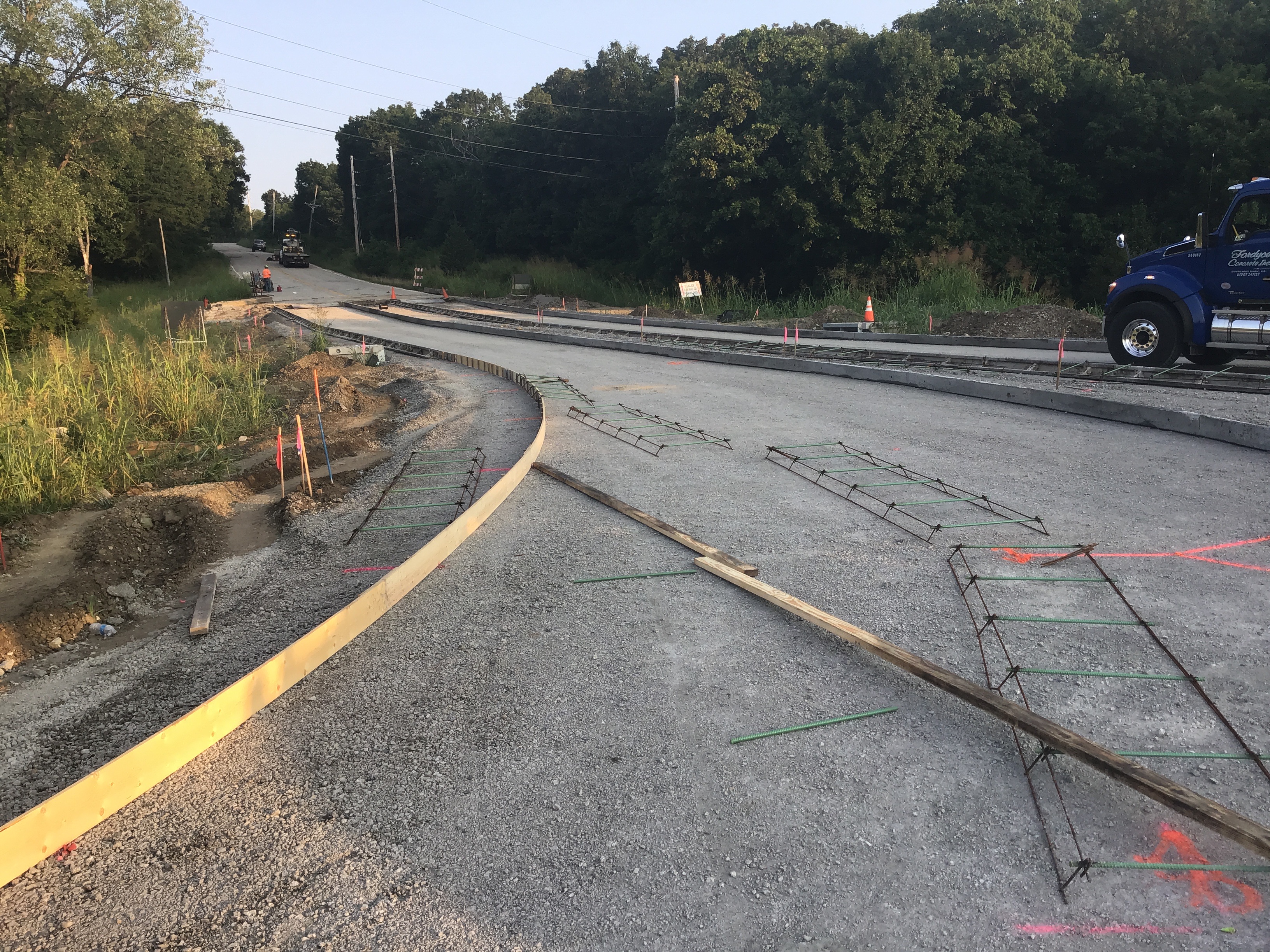

10/13/2020
10/13/20 Tuesday Contractor continued to frame forms for Toe Walls on the Westside of Storm Line 4100. Concrete pour is schedule for tomorrow.
Storm Sewer Construction Inspection Partial 10/14/2020
Misc
Informational
10/13/2020
9/29/20 Tuesday Contractor continued to install 12”X12” RCB Storm Line 4100 ( see DE Storm - Pipe for early progress reports ) contractor laid over seven section 9/28/20 Monday. Contractor has continued excavation and installation across View High Dr as-per plans ( Pg. 13 of 43 ).
Misc
Informational
10/13/2020
9/30/20 Wednesday Contractor continued back fill Storm Line 4100 while Ollson Testing Lab tested lifts.
Misc
Informational
10/13/2020
10/1/20 Thursday Contractor continued to backfilled the Storm Line 4100. Contractor began to excavate for the Wing Wall as-per project plan.
Misc
Informational
10/13/2020
10/2/20 Friday Contractor continues to backfill the Storm line 4100 in lifts and remove excavated soil to other site areas to raise elevation levels.
Misc
Informational
10/13/2020
10/12/20 Monday Contractor began to frame and from for Plate Forms and Toe Walls on the West & East side of Storm Line 4100 that extends across View High Drive 10/5 thru 10/9. Contractor poured Plate Form on the Westside of Storm Line 4100 as per project plans.
Misc
Informational
10/13/2020
10/13/20 Tuesday Contractor continued to frame forms for Toe Walls on the Westside of Storm Line 4100. Concrete pour is schedule for tomorrow.
Misc
Informational
10/14/2020

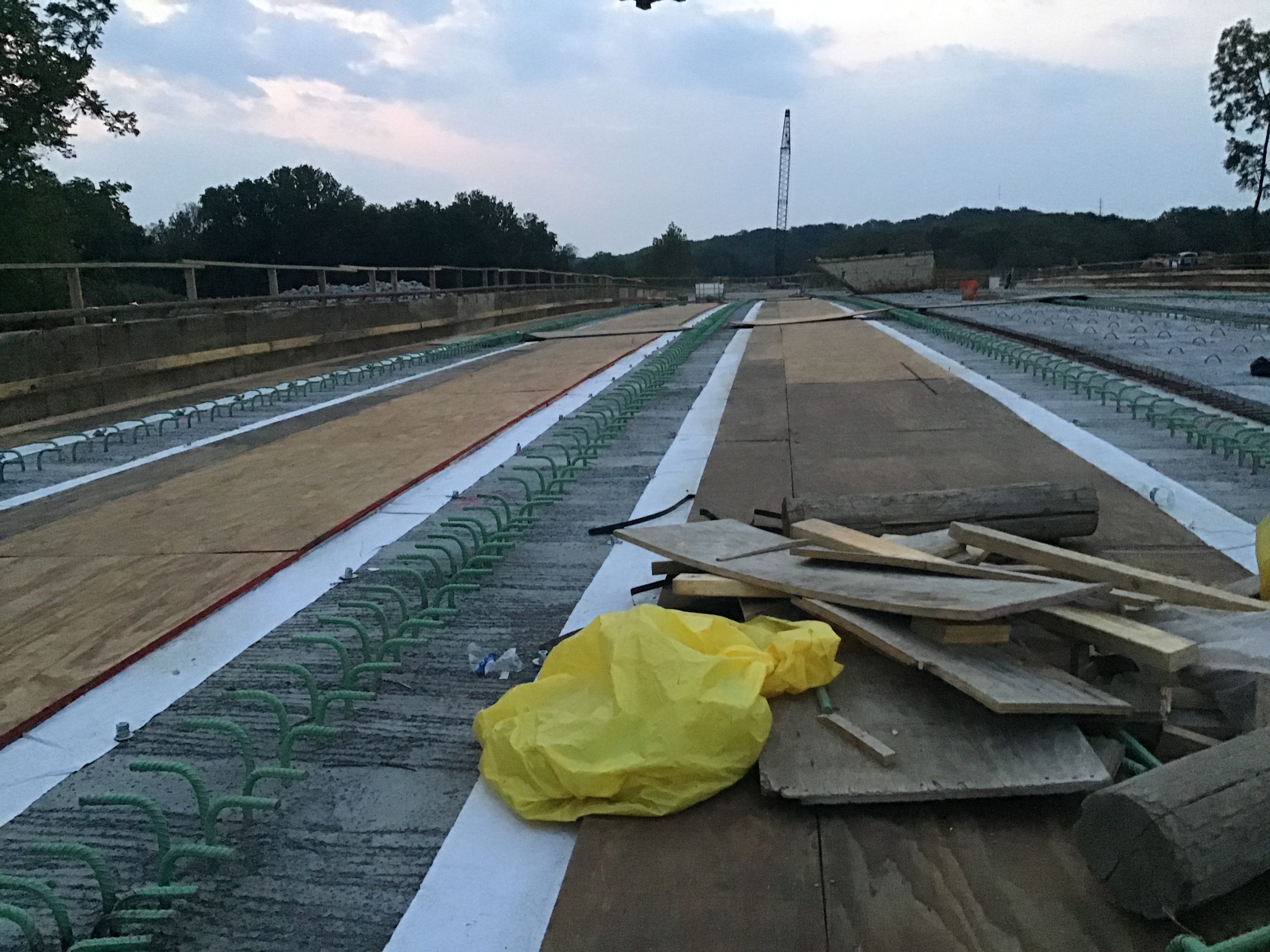

10/14/20 Wednesday Contractor poured the Platform on the Eastside of Storm Line 4100 and continued to frame Toe Wall on the Westside.
Storm Sewer Construction Inspection Partial 10/15/2020
Misc
Informational
10/14/2020
9/29/20 Tuesday Contractor continued to install 12”X12” RCB Storm Line 4100 ( see DE Storm - Pipe for early progress reports ) contractor laid over seven section 9/28/20 Monday. Contractor has continued excavation and installation across View High Dr as-per plans ( Pg. 13 of 43 ).
Misc
Informational
10/14/2020
9/30/20 Wednesday Contractor continued back fill Storm Line 4100 while Ollson Testing Lab tested lifts.
Misc
Informational
10/14/2020
10/1/20 Thursday Contractor continued to backfilled the Storm Line 4100. Contractor began to excavate for the Wing Wall as-per project plan.
Misc
Informational
10/14/2020
10/2/20 Friday Contractor continues to backfill the Storm line 4100 in lifts and remove excavated soil to other site areas to raise elevation levels.
Misc
Informational
10/14/2020
10/12/20 Monday Contractor began to frame and from for Plate Forms and Toe Walls on the West & East side of Storm Line 4100 that extends across View High Drive 10/5 thru 10/9. Contractor poured Plate Form on the Westside of Storm Line 4100 as per project plans.
Misc
Informational
10/14/2020
10/13/20 Tuesday Contractor continued to frame forms for Toe Walls on the Westside of Storm Line 4100. Concrete pour is schedule for tomorrow.
Misc
Informational
10/14/2020
10/14/20 Wednesday Contractor poured the Platform on the Eastside of Storm Line 4100 and continued to frame Toe Wall on the Westside.
Misc
Informational
10/15/2020
Misc
Informational
10/15/2020
10/15/20 Thursday Contractor continued to work on and framing Toe Wall for Storm Line 4100.
Storm Sewer Construction Inspection Partial 10/16/2020
Misc
Informational
10/15/2020
9/29/20 Tuesday Contractor continued to install 12”X12” RCB Storm Line 4100 ( see DE Storm - Pipe for early progress reports ) contractor laid over seven section 9/28/20 Monday. Contractor has continued excavation and installation across View High Dr as-per plans ( Pg. 13 of 43 ).
Misc
Informational
10/15/2020
9/30/20 Wednesday Contractor continued back fill Storm Line 4100 while Ollson Testing Lab tested lifts.
Misc
Informational
10/15/2020
10/1/20 Thursday Contractor continued to backfilled the Storm Line 4100. Contractor began to excavate for the Wing Wall as-per project plan.
Misc
Informational
10/15/2020
10/2/20 Friday Contractor continues to backfill the Storm line 4100 in lifts and remove excavated soil to other site areas to raise elevation levels.
Misc
Informational
10/15/2020
10/12/20 Monday Contractor began to frame and from for Plate Forms and Toe Walls on the West & East side of Storm Line 4100 that extends across View High Drive 10/5 thru 10/9. Contractor poured Plate Form on the Westside of Storm Line 4100 as per project plans.
Misc
Informational
10/15/2020
10/13/20 Tuesday Contractor continued to frame forms for Toe Walls on the Westside of Storm Line 4100. Concrete pour is schedule for tomorrow.
Misc
Informational
10/15/2020
10/14/20 Wednesday Contractor poured the Platform on the Eastside of Storm Line 4100 and continued to frame Toe Wall on the Westside.
Misc
Informational
10/15/2020
Misc
Informational
10/15/2020
10/15/20 Thursday Contractor continued to work on and framing Toe Wall for Storm Line 4100.
Misc
Informational
10/16/2020

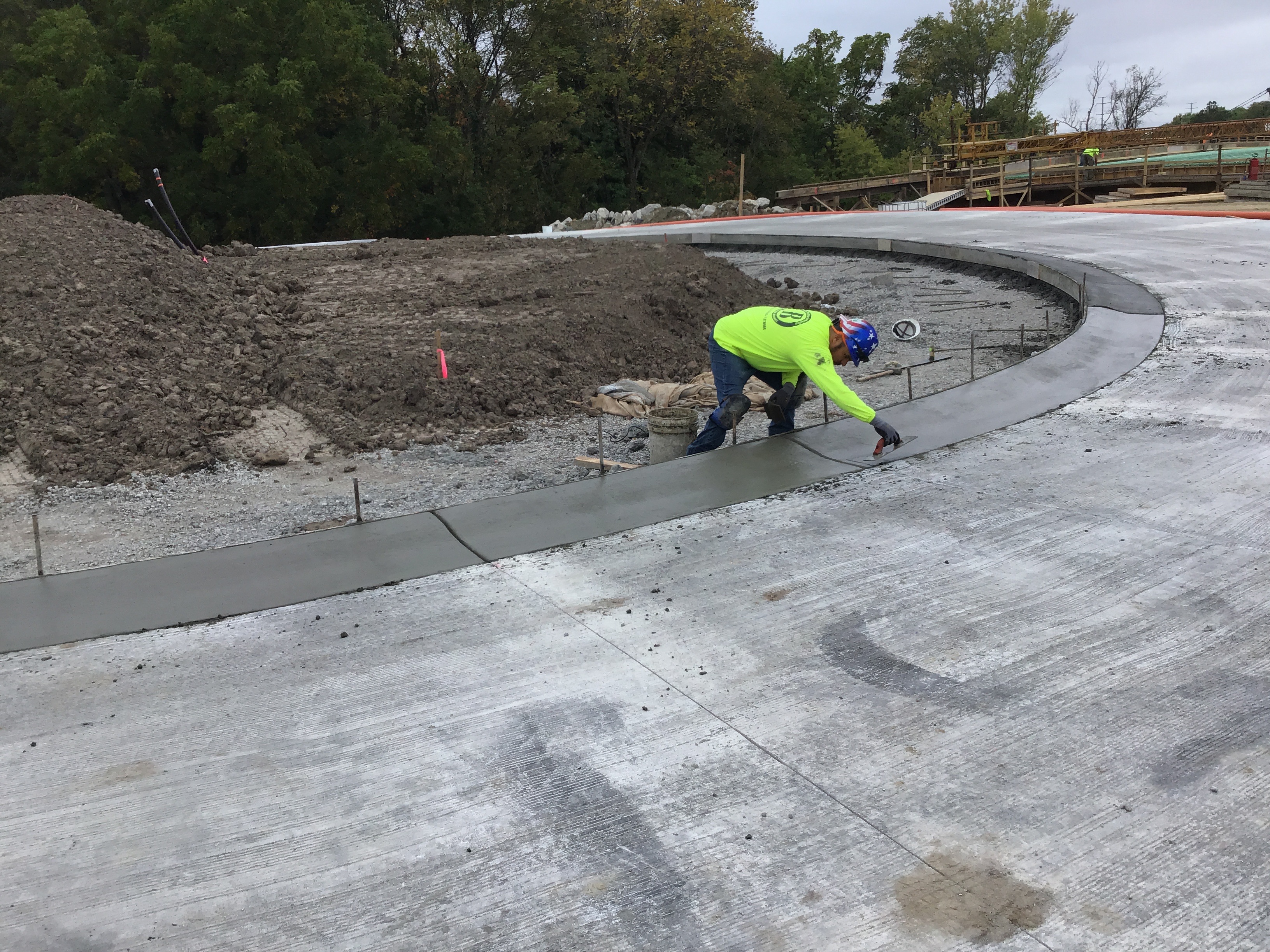

Contractor poured Wing Walls for the Westside of 4100 Storm Line as-per project plans.
Site Visit Partial 10/16/2020
PW-Misc
Informational

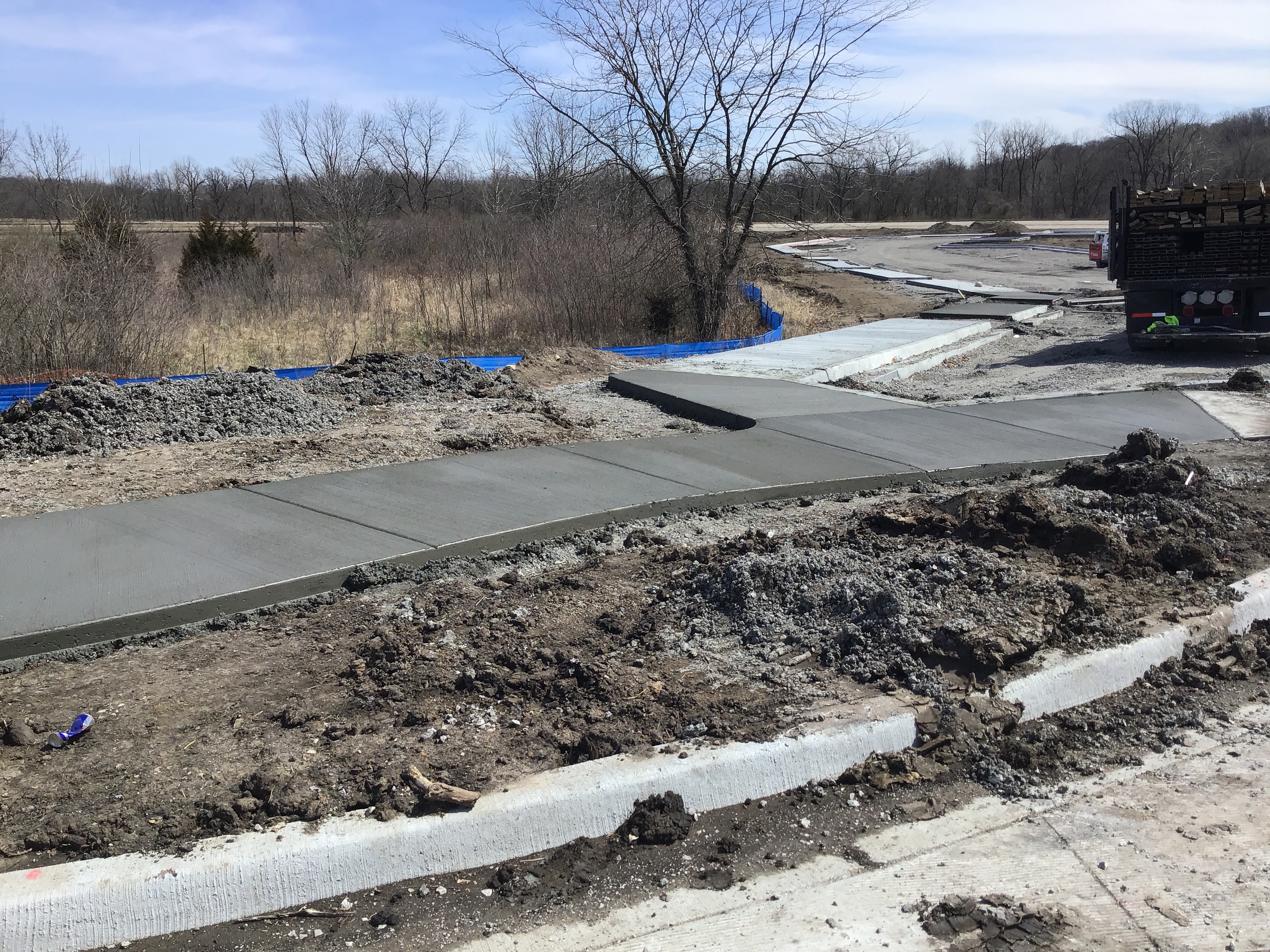

05/24/2019
The crossing in the Little Blue has been removed. All equipment and debris has also been removed from the floodway. The contractors will not be working in the floodway and when they are near the floodway it will be staked and marked so it is clear as to where they need to be. As of now this is putting an end to the Stop Work Order.Steve Robbins 04/08/2019 9:47 AM
Miscellaneous Correction
Informational
05/24/2019
This project cannot have anymore work done except finish the storm line on 300 and toe-wall.John Jackson will be checking on this to make sure it gets wrapped up. No work until further notice.
Misc
Informational
06/30/2020

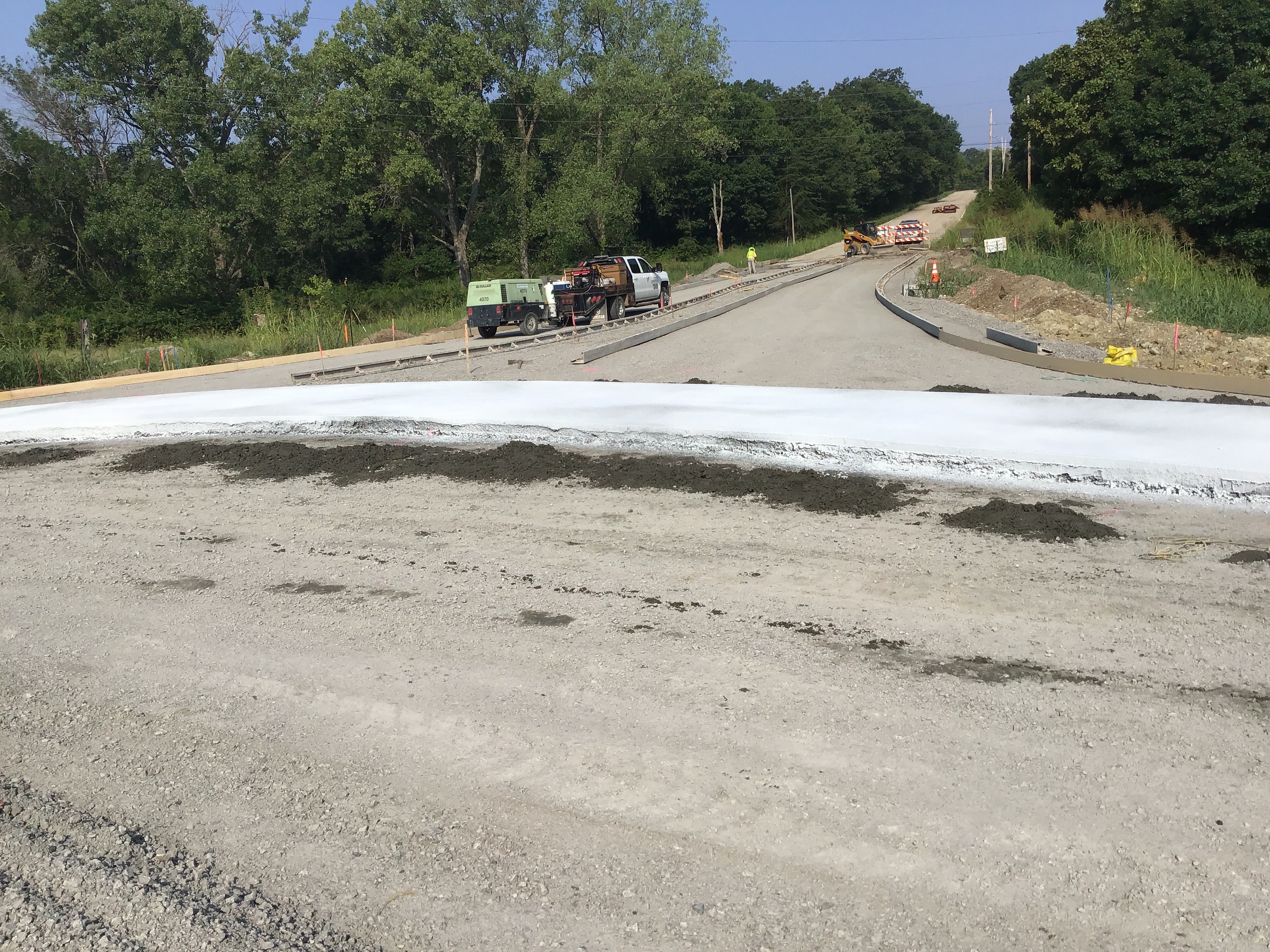

Overview of project continual blasting of rock & soil on the highest elevated hill. The excavated materials is redistributed to raise the elevation of site as per plans. Rock is being jack hammer to create stabilzed subgrade.The soil density is being tested by third party inspection Ollson. The waterways are protected by proper errosion control at this time no work is being preformed directly over water. We will continue to assess errosion control. 6-30-20 Tuesday
Misc
Informational
10/16/2020

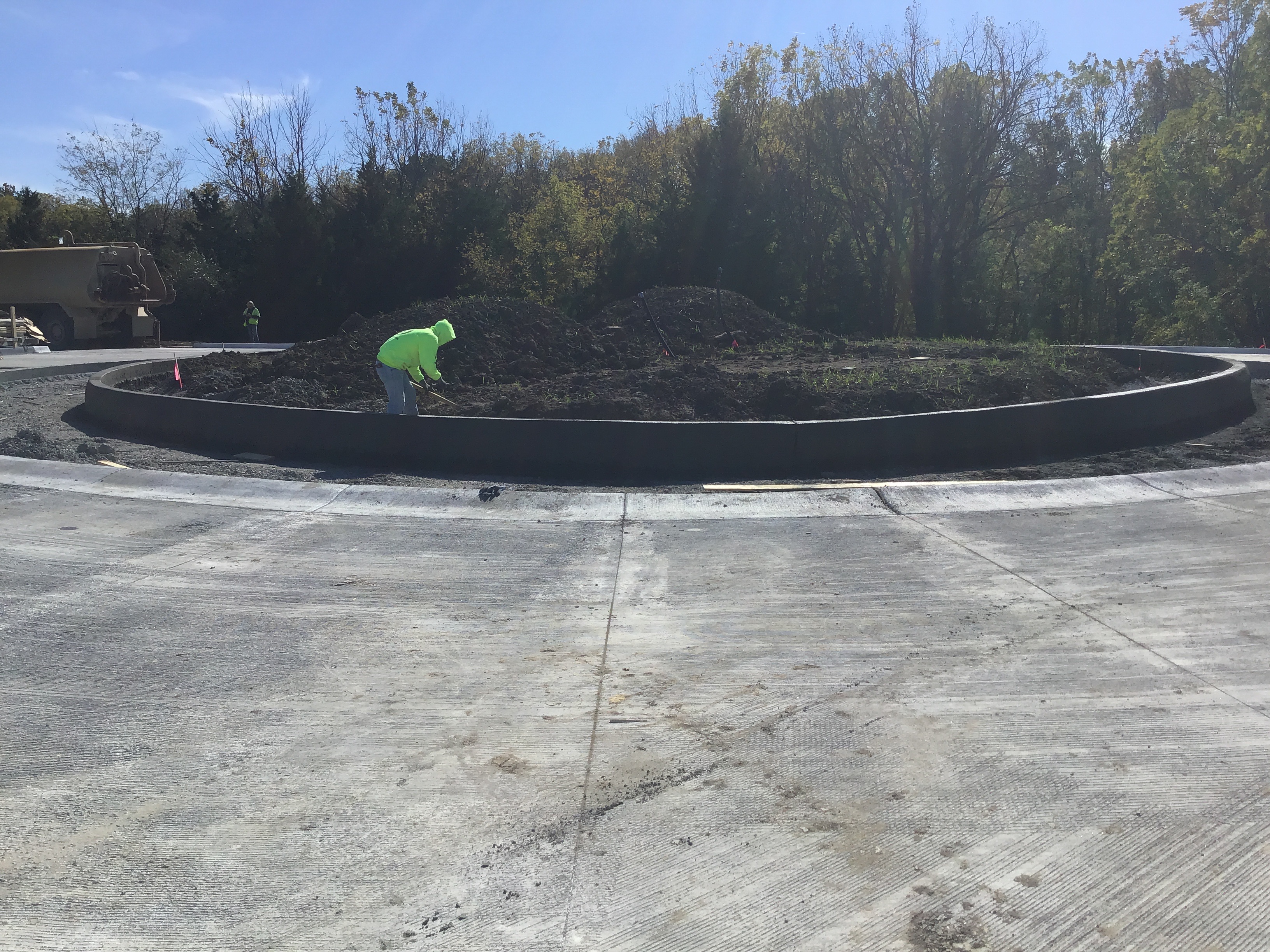

Contractor restarted grading this week of site .
Misc
Informational
12/20/2021

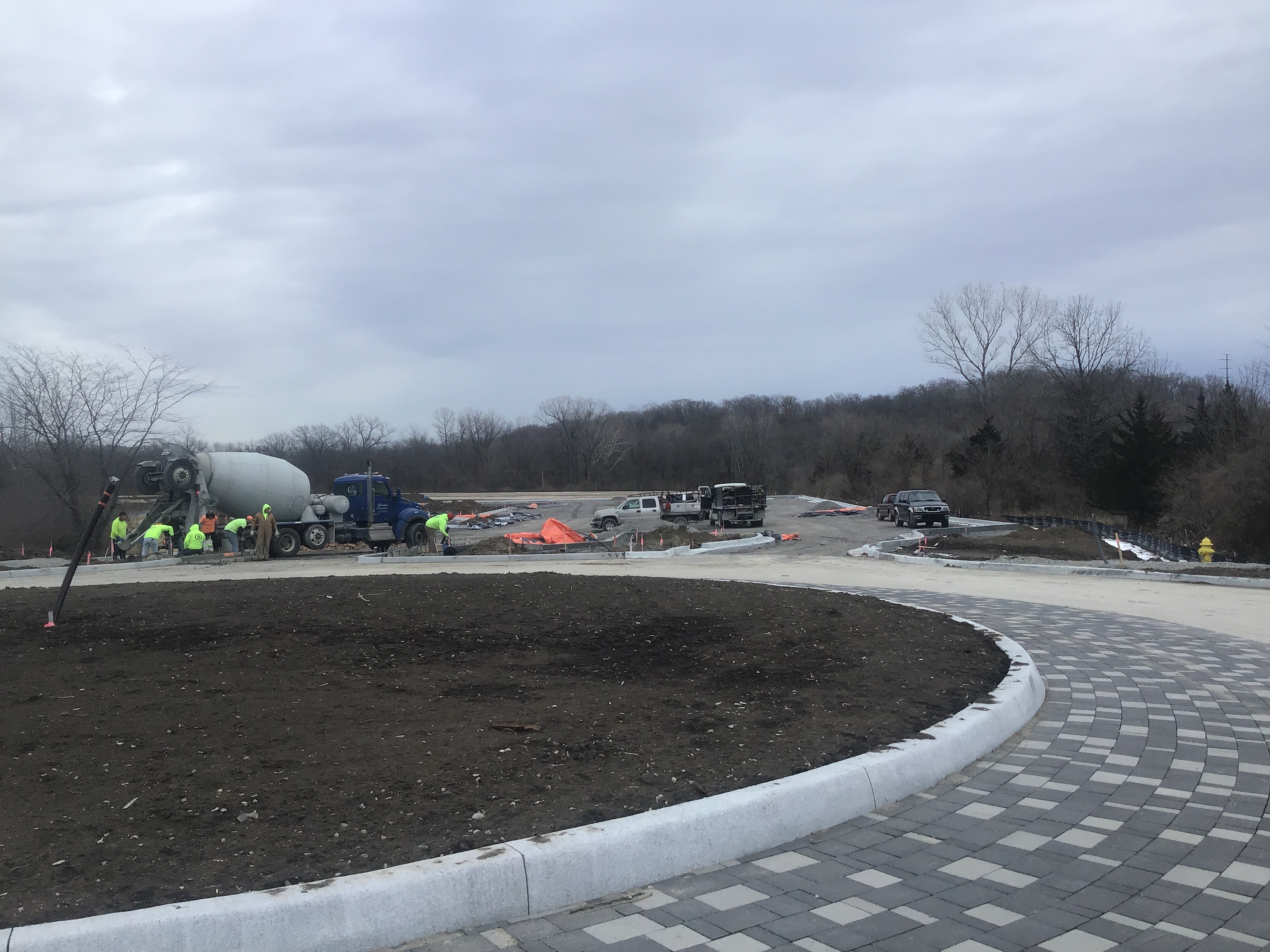

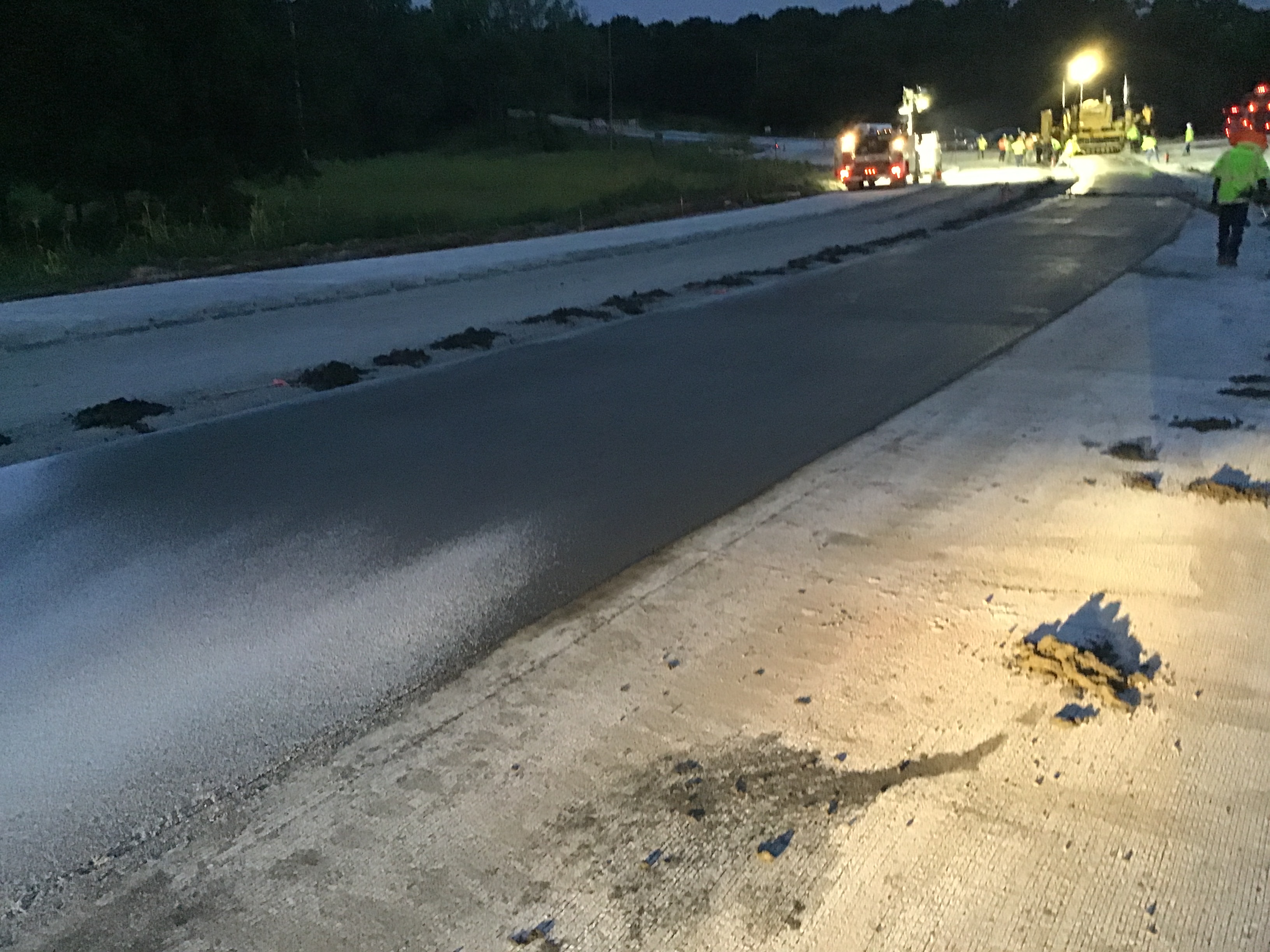

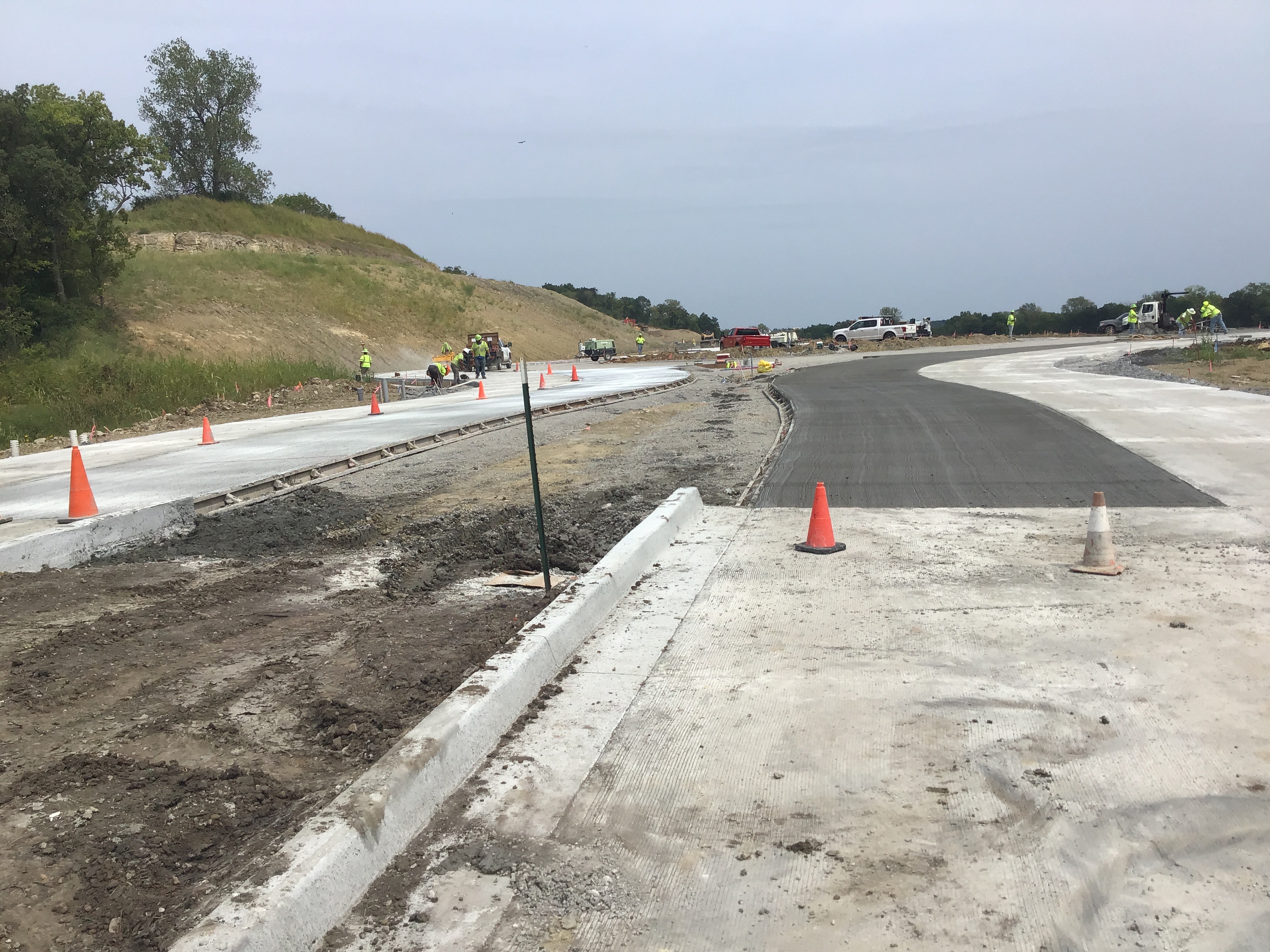

12/20/21 Monday Concrete was poured along River Road plat form near the sanitary plant station and some sidewalk. 02/09/22 Wednesday No work was performed today onsite. 02/10/22 Thursday Met on site with my supervisor (Steve Robbins) & Casey of Fogel Anderson Construction to determine what is need for Contractor to begin building vertical. The utilities that are mark public or private require different amounts for bonding and responsibilities. Met with Westhues Electrical Company to inspect conduit and ground wires on River Road for junction boxes to be installed for street lights and Evergy.
Misc
Informational

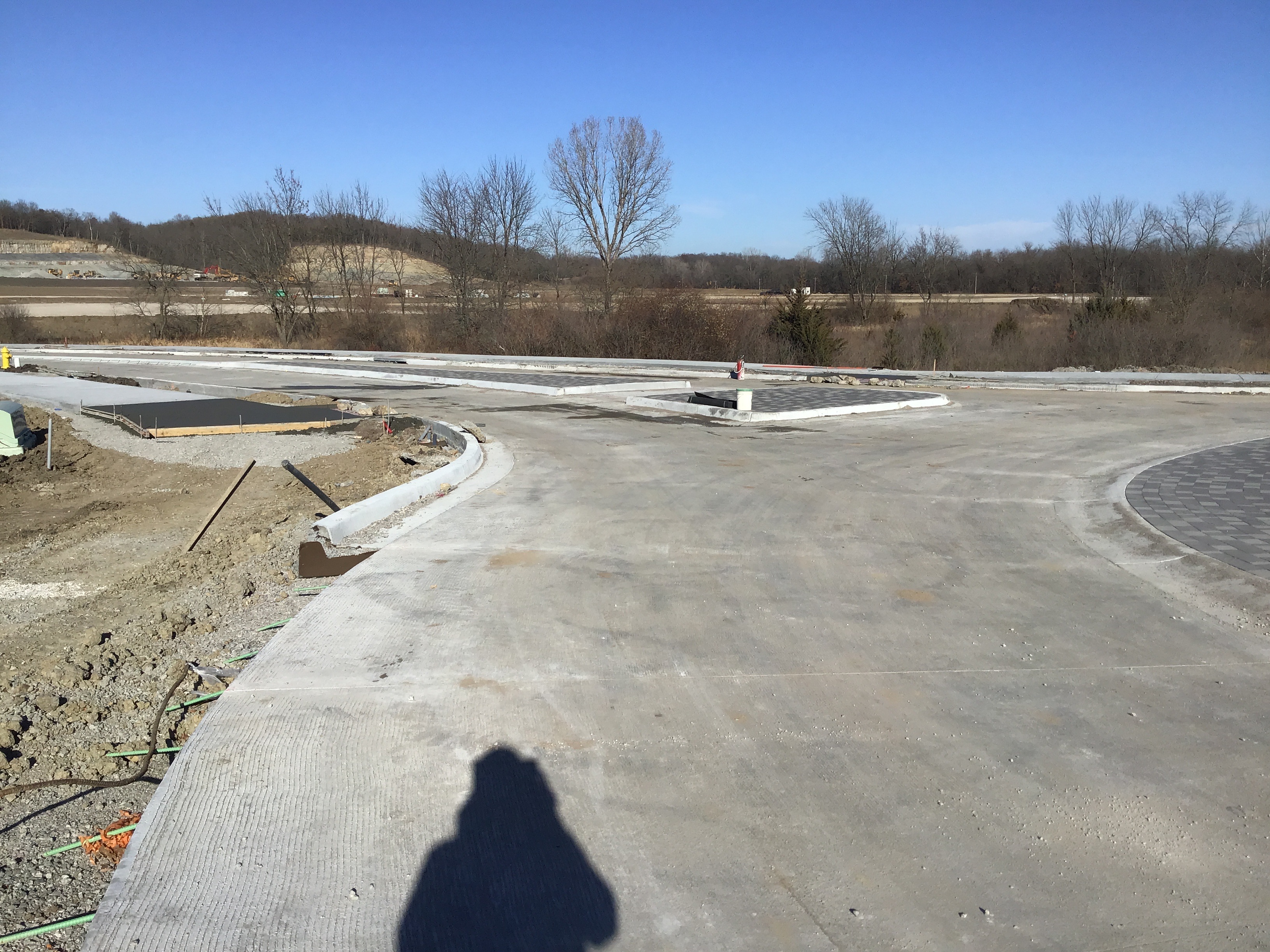

02/24/2022
02/24/22 Thursday No work site due snow and cold weather condition throughout the week. 04/04/22 Monday (Black&McDonald) Running conduit along the Westside of River Road for transformer and a enclosures (power sources).
Grading/Excavation/Fill Inspection Partial 10/17/2020
Misc
Informational
10/17/2020

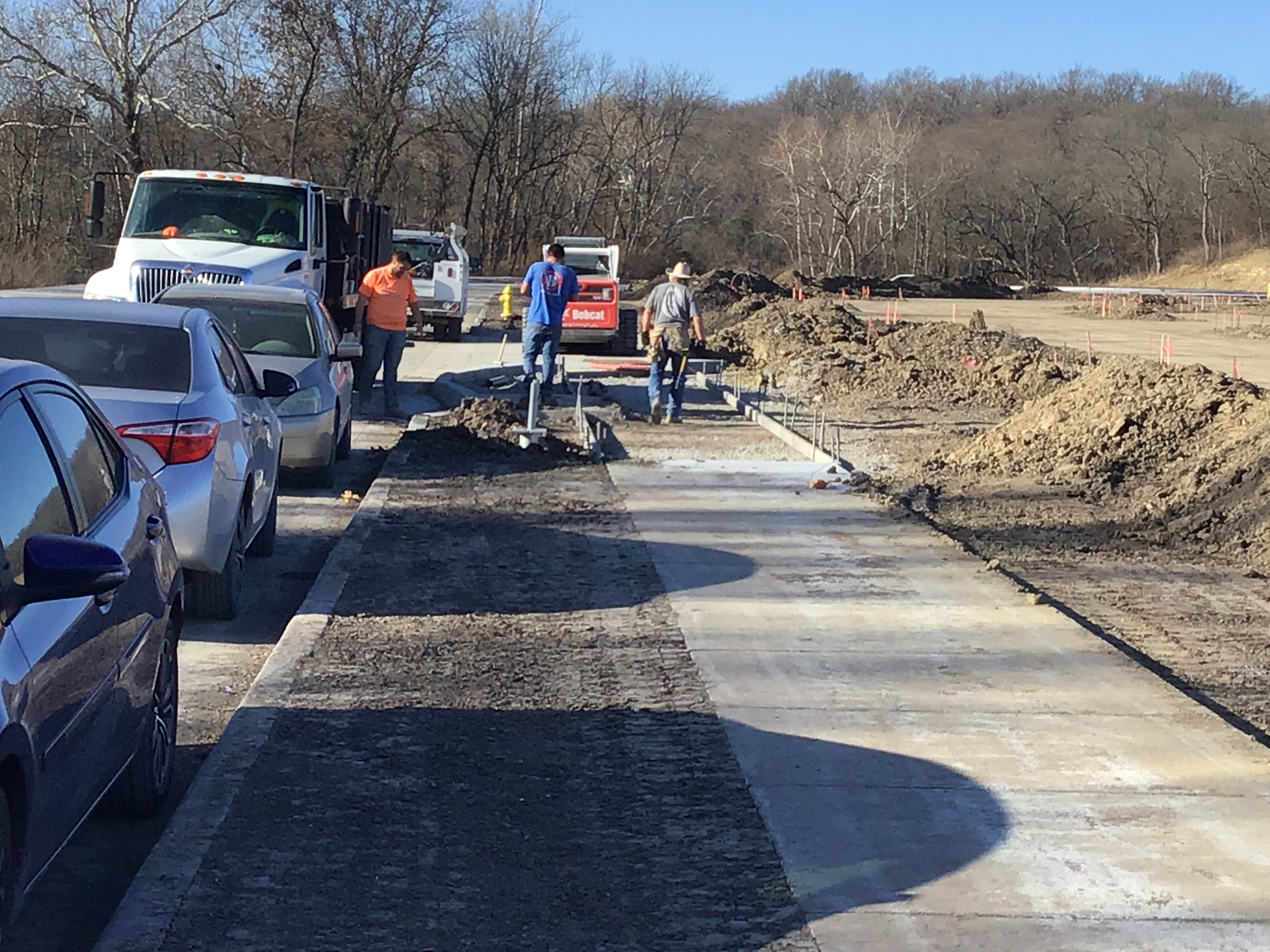

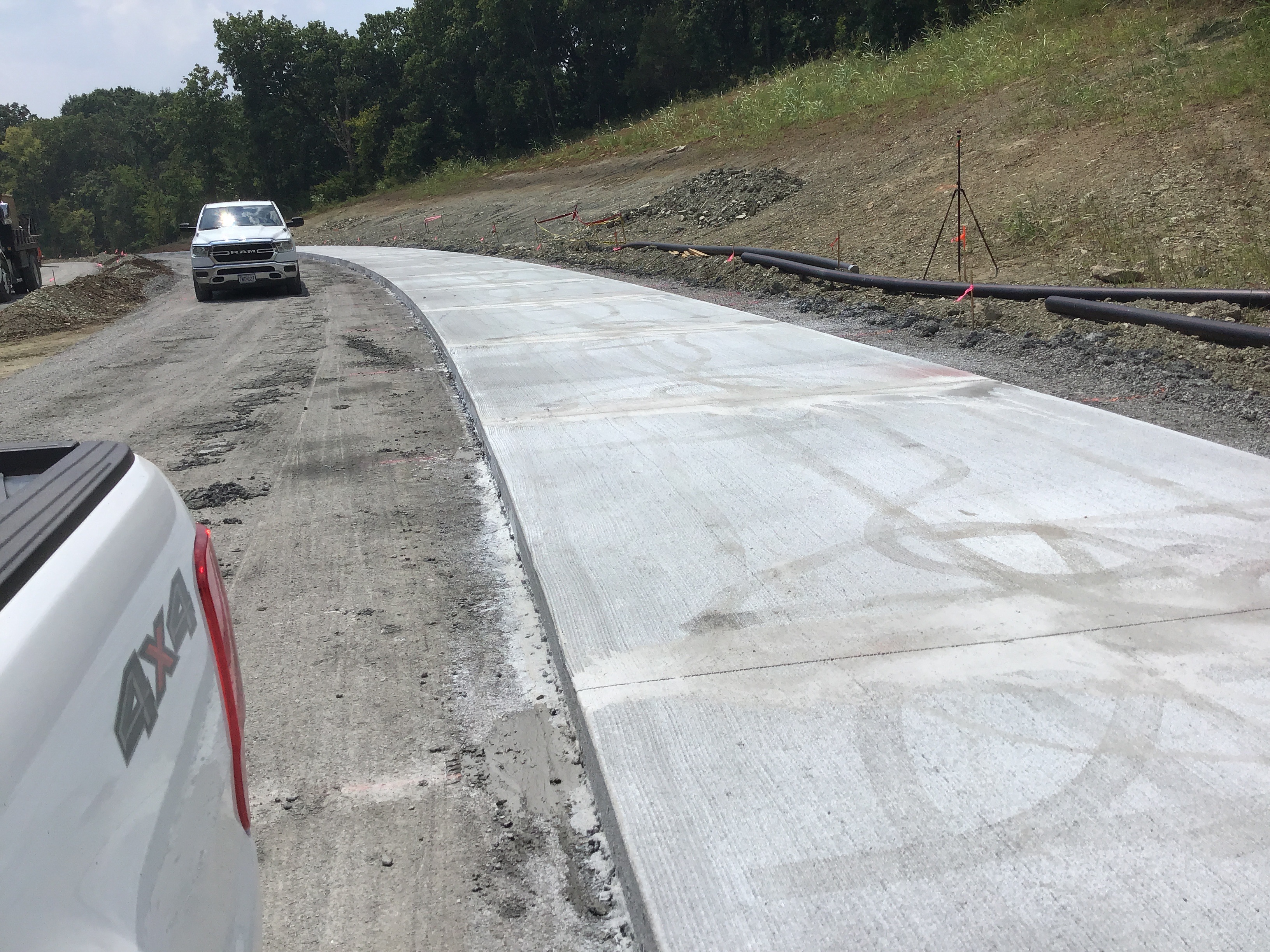

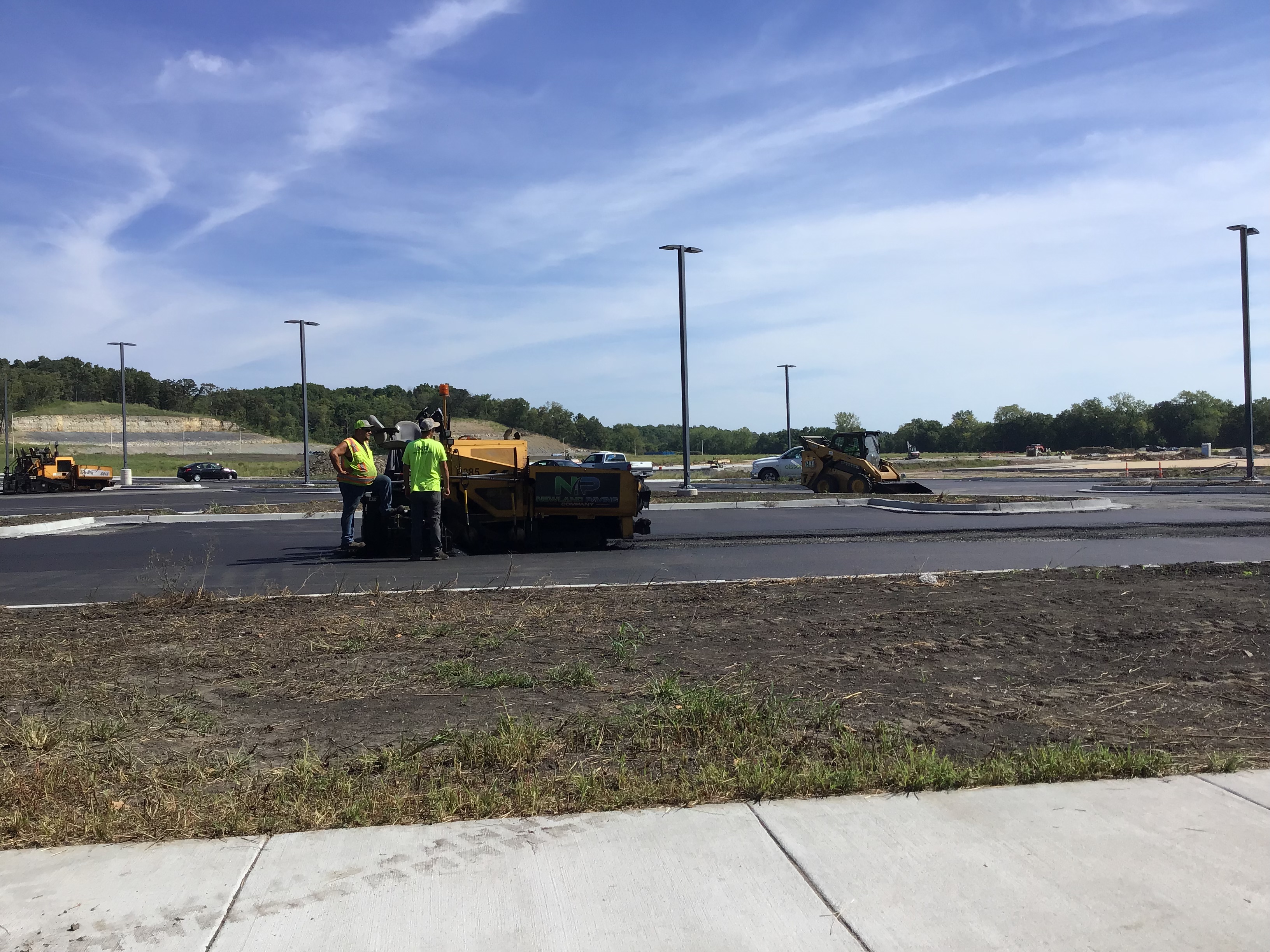

10/17/20 Saturday Contractor has been grading the site again for about a week. The location of grading & excavating is near the site entrance off of View High Drive just North of I-470 Hwy.
Storm Sewer Construction Inspection Partial 10/19/2020
Misc
Informational
10/16/2020
9/29/20 Tuesday Contractor continued to install 12”X12” RCB Storm Line 4100 ( see DE Storm - Pipe for early progress reports ) contractor laid over seven section 9/28/20 Monday. Contractor has continued excavation and installation across View High Dr as-per plans ( Pg. 13 of 43 ).
Misc
Informational
10/16/2020
9/30/20 Wednesday Contractor continued back fill Storm Line 4100 while Ollson Testing Lab tested lifts.
Misc
Informational
10/16/2020
10/1/20 Thursday Contractor continued to backfilled the Storm Line 4100. Contractor began to excavate for the Wing Wall as-per project plan.
Misc
Informational
10/16/2020
10/2/20 Friday Contractor continues to backfill the Storm line 4100 in lifts and remove excavated soil to other site areas to raise elevation levels.
Misc
Informational
10/16/2020
10/12/20 Monday Contractor began to frame and from for Plate Forms and Toe Walls on the West & East side of Storm Line 4100 that extends across View High Drive 10/5 thru 10/9. Contractor poured Plate Form on the Westside of Storm Line 4100 as per project plans.
Misc
Informational
10/16/2020
10/13/20 Tuesday Contractor continued to frame forms for Toe Walls on the Westside of Storm Line 4100. Concrete pour is schedule for tomorrow.
Misc
Informational
10/16/2020
10/14/20 Wednesday Contractor poured the Platform on the Eastside of Storm Line 4100 and continued to frame Toe Wall on the Westside.
Misc
Informational
10/16/2020
Misc
Informational
10/16/2020
10/15/20 Thursday Contractor continued to work on and framing Toe Wall for Storm Line 4100.
Misc
Informational
10/16/2020
Contractor poured Wing Walls for the Westside of 4100 Storm Line as-per project plans.
Misc
Informational
10/19/2020
10/19/20 Monday Contractor worked forming Wing Walls on the Eastside of 4100 Storm Line as-per project plans to prepare for concrete pour later in the week.
Grading/Excavation/Fill Inspection Partial 10/19/2020
Misc
Informational
08/03/2020
Contractor continued to grade and fill onsite.
Misc
Informational
08/03/2020
Contractor continued to fill and grade site as per plan.
Misc
Informational
08/03/2020
Contractor not working at full force but earthwork. Compaction and grading onsite. Weather 54 degrees and could brief shower through the morning. Report was done at 10:45AM.
Misc
Informational
08/03/2020
A lite amount of grading was done it maybe due to the moisture from passed rains.Temperature for today is 61 degrees and cloudy @ 12:39 5/7/20. Olsson Labs was onsite to get soil compaction test .
Misc
Informational
08/03/2020
Contractor continues to grade and excavate work site as per plan.
Misc
Informational
08/03/2020
Contractor continued to grade & excavate work site also they began blasting this week. Today there was no work temperatures in the low to mid 60’s cloudy with rains throughout the day..
Misc
Informational
08/03/2020
Contractor installed Geogrid on 5/21/20 covering it with 6” of rural 5.
Misc
Informational
08/03/2020
Contractor continued to grade & excvate work site contractor continue blasting 6/8/20 Monday. Contractor plans to continually to grade and excavate site until the meet required grading as per plans.
Misc
Informational
08/03/2020
Contractor (Clark Const.) continues to grade and excavate site to meet required grade, blasting has also been ongoing. The rock from the blasted has been used as shot rock which stabilize subgrade. The rock is jackhammered into smaller pieces near grading site and used . 6/22/20 Monday cloudy overcast.
Misc
Informational
08/03/2020
7/6/20 Monday CONTRACTOR - continues to grade low land areas to raise elevation see also (site visit inspection) for information. Rock was broken down to stabilize subgrade.
Misc
Informational
08/03/2020
7/13/20 Monday Contractor is still still blast and excavating rock to raise the elevation levels of site. See documentation pics to view site on this day.
Misc
Informational
08/03/2020
7/22/20 Wednesday Contractor were rain out Monday & Tuesday of this week. The contractor continued to grade site to raise elevation.
Misc
Informational
08/03/2020
7/23/20 Thursday Contractor continued with blast and excavating rock and soil to raise elevation of site.
Misc
Informational
08/03/2020
7/28/20 Tuesday Contractor continued excavating rock and soil to raise elevation of site. Rains fell Monday 7/27/20 so there was no site work
Misc
Informational
08/03/2020
8/3/20 Monday contractor waiting for bore test of site before they continue grading site. Possible large deposit of Shell Rock which is not desirable for fill. No construction work at site today.
Misc
Informational
10/19/2020
10/19/20 Monday Contractor continues to work on the grading of site.

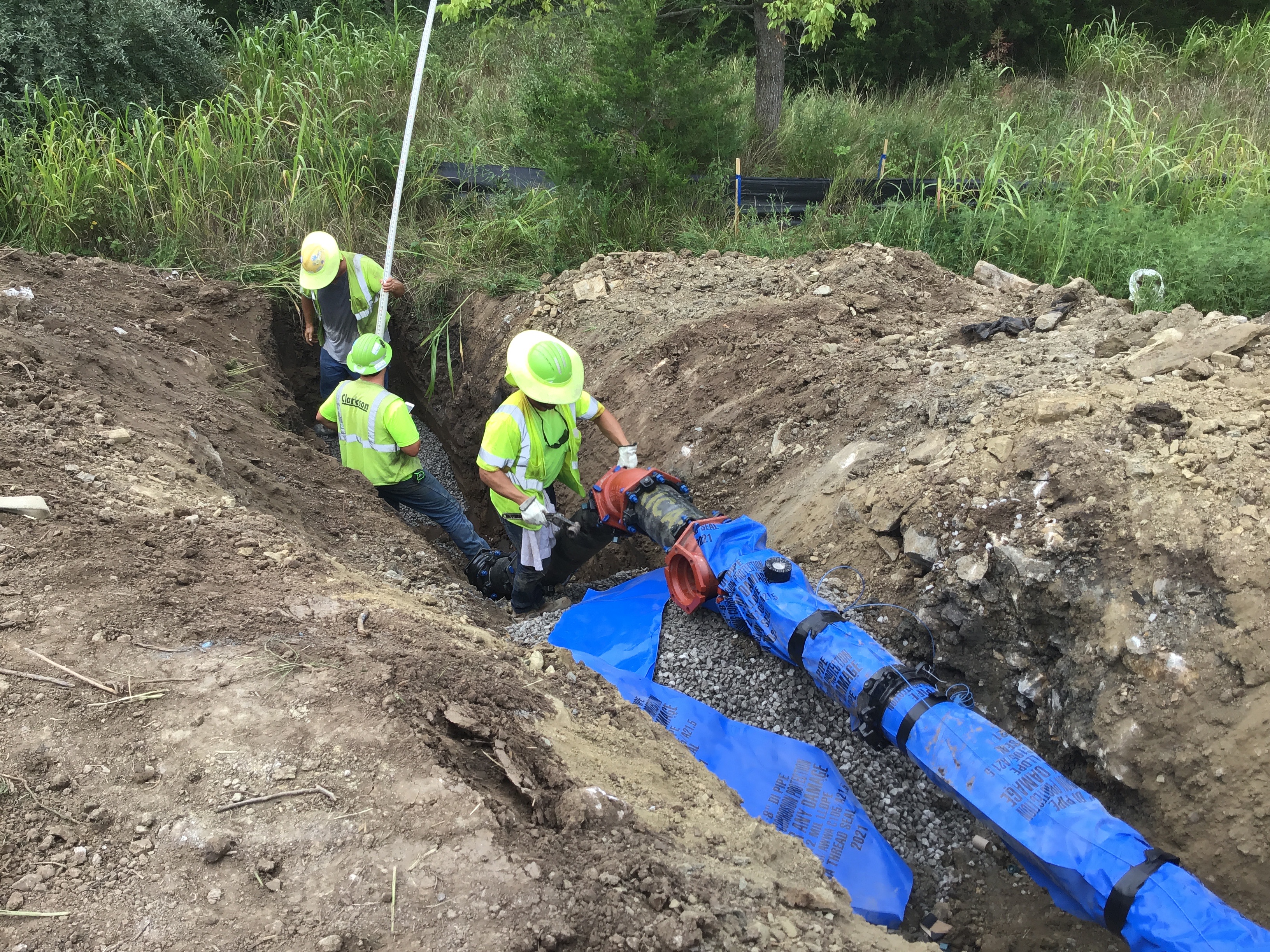

Storm Sewer Construction Inspection Partial 10/21/2020
Misc
Informational
10/19/2020
9/29/20 Tuesday Contractor continued to install 12”X12” RCB Storm Line 4100 ( see DE Storm - Pipe for early progress reports ) contractor laid over seven section 9/28/20 Monday. Contractor has continued excavation and installation across View High Dr as-per plans ( Pg. 13 of 43 ).
Misc
Informational
10/19/2020
9/30/20 Wednesday Contractor continued back fill Storm Line 4100 while Ollson Testing Lab tested lifts.
Misc
Informational
10/19/2020
10/1/20 Thursday Contractor continued to backfilled the Storm Line 4100. Contractor began to excavate for the Wing Wall as-per project plan.
Misc
Informational
10/19/2020
10/2/20 Friday Contractor continues to backfill the Storm line 4100 in lifts and remove excavated soil to other site areas to raise elevation levels.
Misc
Informational
10/19/2020
10/12/20 Monday Contractor began to frame and from for Plate Forms and Toe Walls on the West & East side of Storm Line 4100 that extends across View High Drive 10/5 thru 10/9. Contractor poured Plate Form on the Westside of Storm Line 4100 as per project plans.
Misc
Informational
10/19/2020
10/13/20 Tuesday Contractor continued to frame forms for Toe Walls on the Westside of Storm Line 4100. Concrete pour is schedule for tomorrow.
Misc
Informational
10/19/2020
10/14/20 Wednesday Contractor poured the Platform on the Eastside of Storm Line 4100 and continued to frame Toe Wall on the Westside.
Misc
Informational
10/19/2020
Misc
Informational
10/19/2020
10/15/20 Thursday Contractor continued to work on and framing Toe Wall for Storm Line 4100.
Misc
Informational
10/19/2020
Contractor poured Wing Walls for the Westside of 4100 Storm Line as-per project plans.
Misc
Informational
10/19/2020
10/19/20 Monday Contractor worked forming Wing Walls on the Eastside of 4100 Storm Line as-per project plans to prepare for concrete pour later in the week.
Misc
Informational
10/21/2020
10/21/20 Wednesday Contractor continued working on Wing Walls o Storm Line 4100.

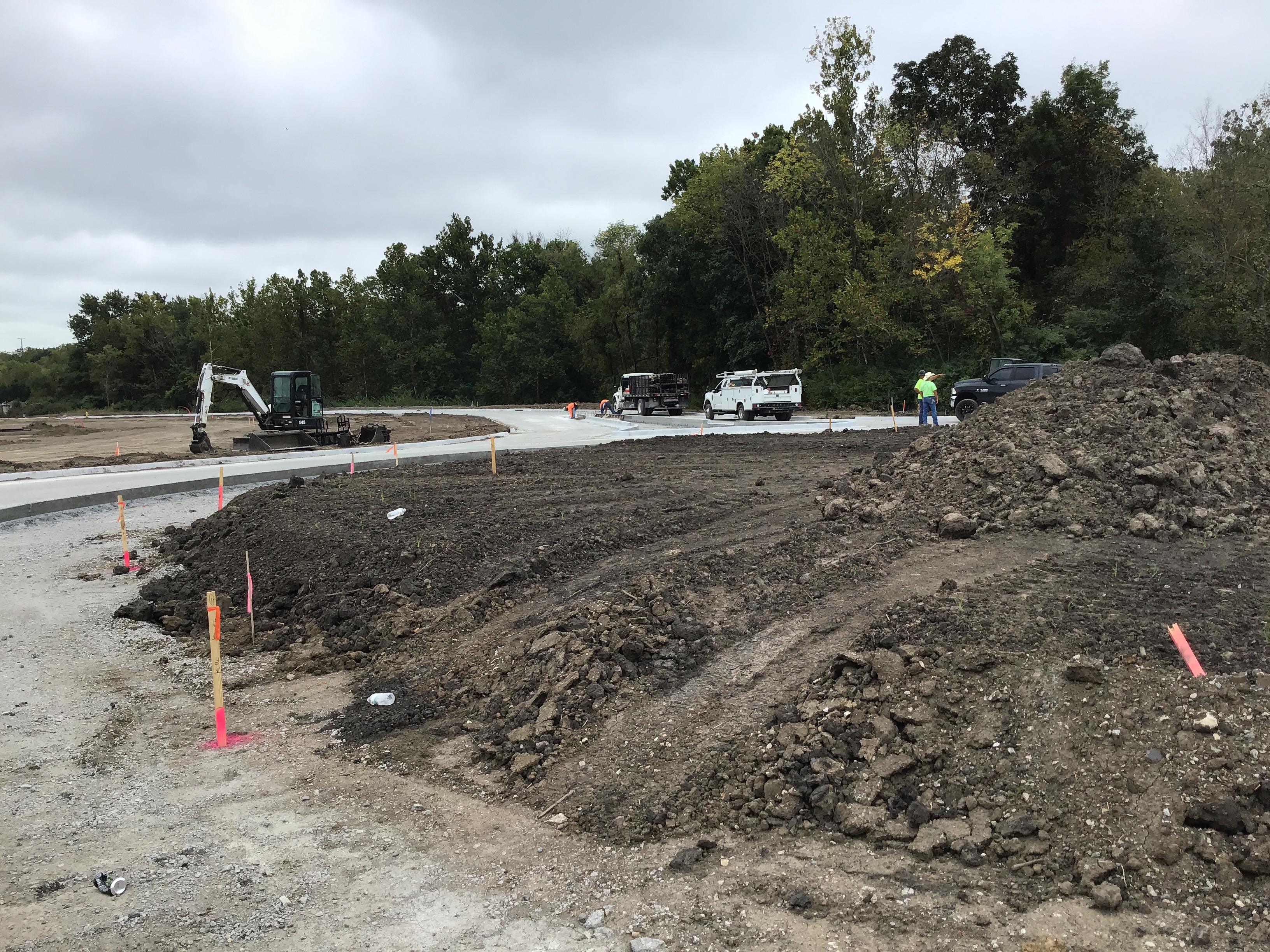

Grading/Excavation/Fill Inspection Partial 10/21/2020
Misc
Informational
10/19/2020
10/17/20 Saturday Contractor has been grading the site again for about a week. The location of grading & excavating is near the site entrance off of View High Drive just North of I-470 Hwy.
Misc
Informational
10/21/2020
10/21/20 Contractor continued grading and filling site as-per plan. Work was stopped early today due to rainy weather conditions.
Storm Sewer Construction Inspection Partial 10/22/2020
Misc
Informational
10/21/2020
9/29/20 Tuesday Contractor continued to install 12”X12” RCB Storm Line 4100 ( see DE Storm - Pipe for early progress reports ) contractor laid over seven section 9/28/20 Monday. Contractor has continued excavation and installation across View High Dr as-per plans ( Pg. 13 of 43 ).
Misc
Informational
10/21/2020
9/30/20 Wednesday Contractor continued back fill Storm Line 4100 while Ollson Testing Lab tested lifts.
Misc
Informational
10/21/2020
10/1/20 Thursday Contractor continued to backfilled the Storm Line 4100. Contractor began to excavate for the Wing Wall as-per project plan.
Misc
Informational
10/21/2020
10/2/20 Friday Contractor continues to backfill the Storm line 4100 in lifts and remove excavated soil to other site areas to raise elevation levels.
Misc
Informational
10/21/2020
10/12/20 Monday Contractor began to frame and from for Plate Forms and Toe Walls on the West & East side of Storm Line 4100 that extends across View High Drive 10/5 thru 10/9. Contractor poured Plate Form on the Westside of Storm Line 4100 as per project plans.
Misc
Informational
10/21/2020
10/13/20 Tuesday Contractor continued to frame forms for Toe Walls on the Westside of Storm Line 4100. Concrete pour is schedule for tomorrow.
Misc
Informational
10/21/2020
10/14/20 Wednesday Contractor poured the Platform on the Eastside of Storm Line 4100 and continued to frame Toe Wall on the Westside.
Misc
Informational
10/21/2020
Misc
Informational
10/21/2020
10/15/20 Thursday Contractor continued to work on and framing Toe Wall for Storm Line 4100.
Misc
Informational
10/21/2020
Contractor poured Wing Walls for the Westside of 4100 Storm Line as-per project plans.
Misc
Informational
10/21/2020
10/19/20 Monday Contractor worked forming Wing Walls on the Eastside of 4100 Storm Line as-per project plans to prepare for concrete pour later in the week.
Misc
Informational
10/21/2020
10/21/20 Wednesday Contractor continued working on Wing Walls o Storm Line 4100.
Misc
Informational
10/22/2020
10/22/20 Thursday Contractor continues to prepare Eastside of Storm Line 4100 to pour Wing Walls.
Grading/Excavation/Fill Inspection Partial 11/18/2020
Misc
Informational
10/21/2020
10/17/20 Saturday Contractor has been grading the site again for about a week. The location of grading & excavating is near the site entrance off of View High Drive just North of I-470 Hwy.
Misc
Informational
10/21/2020
10/21/20 Contractor continued grading and filling site as-per plan. Work was stopped early today due to rainy weather conditions.
Misc
Informational
11/18/2020
11/17/20 Wednesday Contractor was working on grading and backfilling at various locations on site.
Storm Sewer Construction Inspection Partial 11/18/2020
Misc
Informational
10/22/2020
9/29/20 Tuesday Contractor continued to install 12”X12” RCB Storm Line 4100 ( see DE Storm - Pipe for early progress reports ) contractor laid over seven section 9/28/20 Monday. Contractor has continued excavation and installation across View High Dr as-per plans ( Pg. 13 of 43 ).
Misc
Informational
10/22/2020
9/30/20 Wednesday Contractor continued back fill Storm Line 4100 while Ollson Testing Lab tested lifts.
Misc
Informational
10/22/2020
10/1/20 Thursday Contractor continued to backfilled the Storm Line 4100. Contractor began to excavate for the Wing Wall as-per project plan.
Misc
Informational
10/22/2020
10/2/20 Friday Contractor continues to backfill the Storm line 4100 in lifts and remove excavated soil to other site areas to raise elevation levels.
Misc
Informational
10/22/2020
10/12/20 Monday Contractor began to frame and from for Plate Forms and Toe Walls on the West & East side of Storm Line 4100 that extends across View High Drive 10/5 thru 10/9. Contractor poured Plate Form on the Westside of Storm Line 4100 as per project plans.
Misc
Informational
10/22/2020
10/13/20 Tuesday Contractor continued to frame forms for Toe Walls on the Westside of Storm Line 4100. Concrete pour is schedule for tomorrow.
Misc
Informational
10/22/2020
10/14/20 Wednesday Contractor poured the Platform on the Eastside of Storm Line 4100 and continued to frame Toe Wall on the Westside.
Misc
Informational
10/22/2020
Misc
Informational
10/22/2020
10/15/20 Thursday Contractor continued to work on and framing Toe Wall for Storm Line 4100.
Misc
Informational
10/22/2020
Contractor poured Wing Walls for the Westside of 4100 Storm Line as-per project plans.
Misc
Informational
10/22/2020
10/19/20 Monday Contractor worked forming Wing Walls on the Eastside of 4100 Storm Line as-per project plans to prepare for concrete pour later in the week.
Misc
Informational
10/22/2020
10/21/20 Wednesday Contractor continued working on Wing Walls o Storm Line 4100.
Misc
Informational
10/22/2020
10/22/20 Thursday Contractor continues to prepare Eastside of Storm Line 4100 to pour Wing Walls.
Misc
Informational
11/18/2020

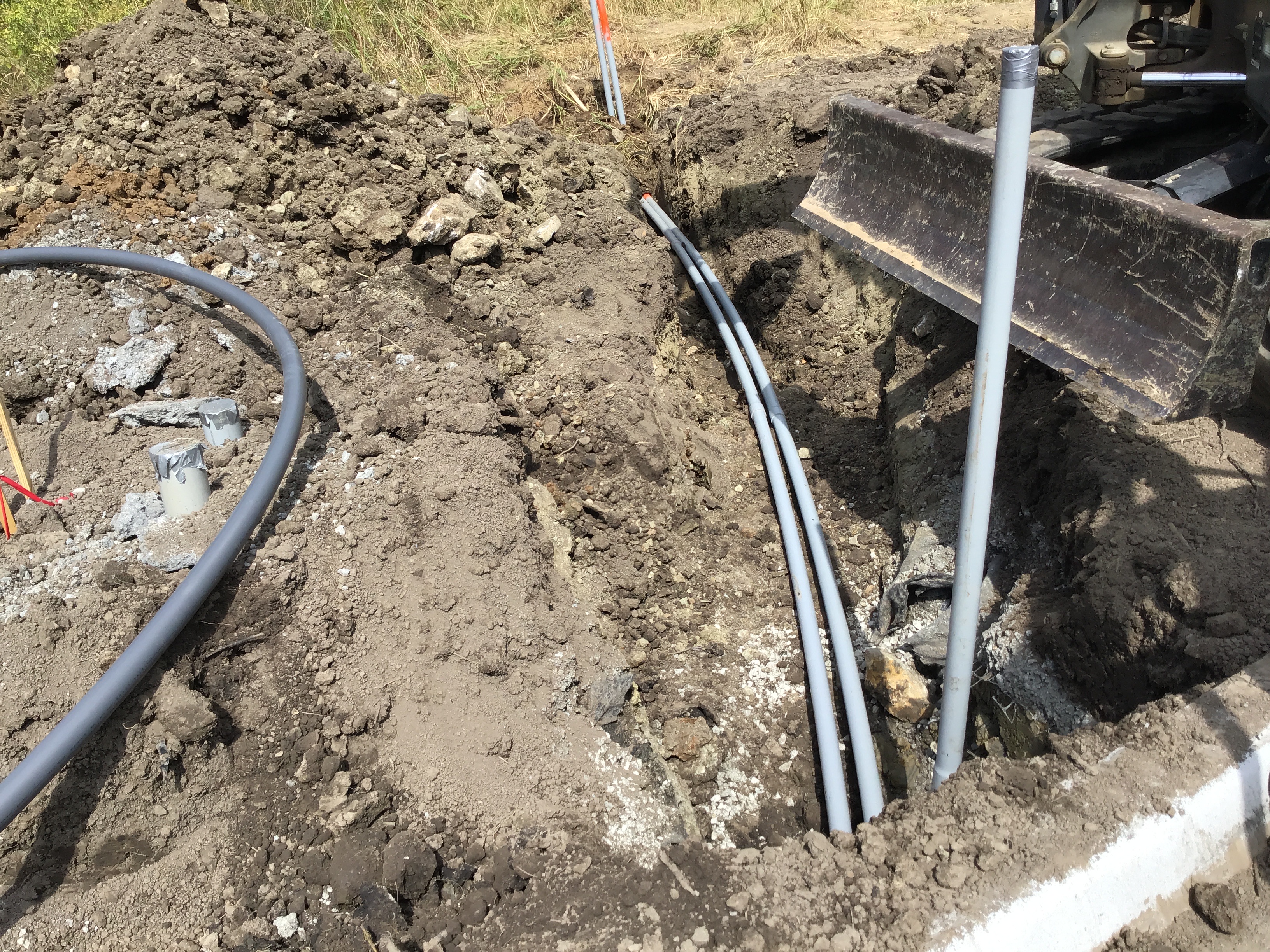

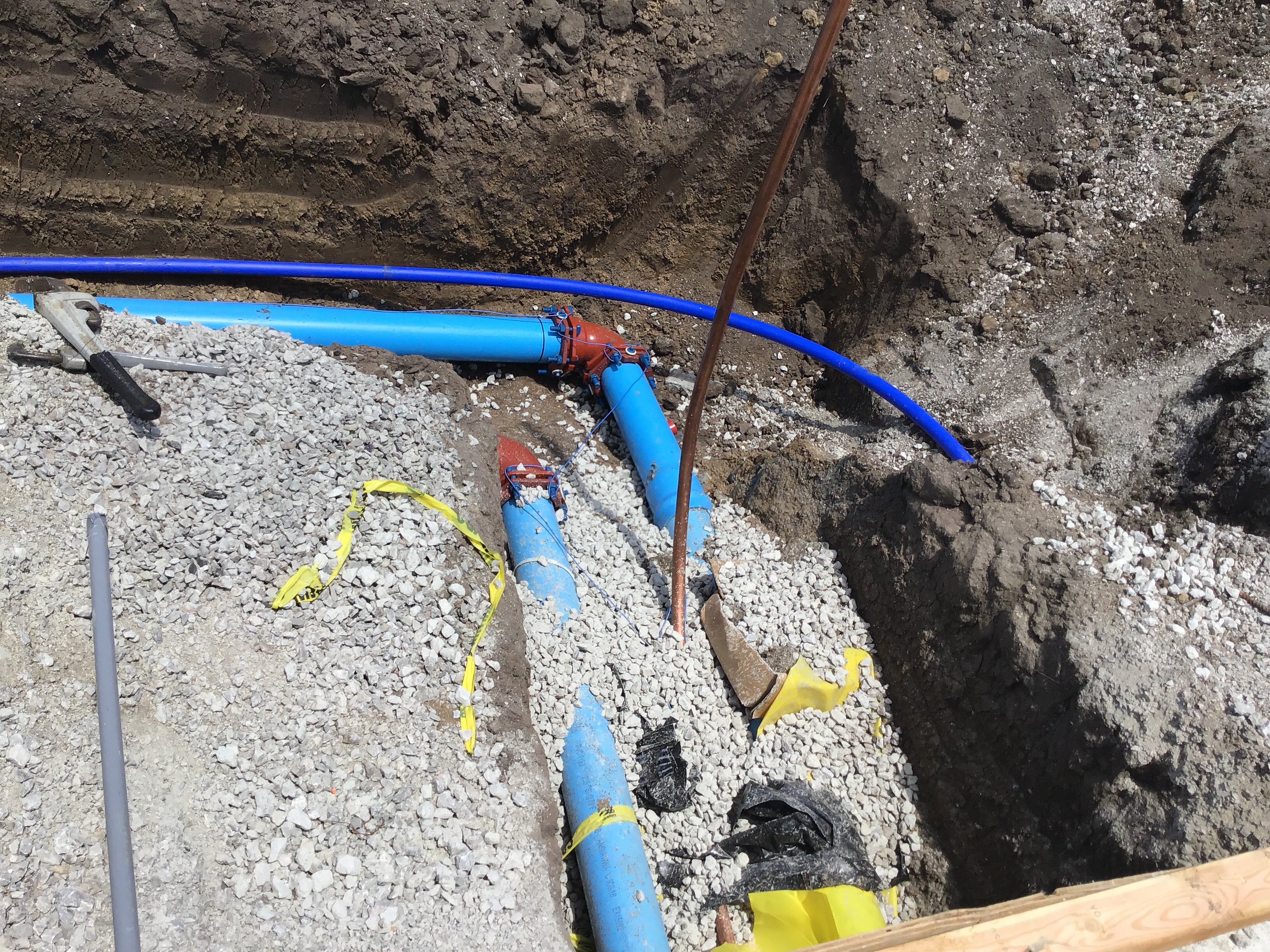

11/18/20 Wednesday Installed corrugated piping between the detention basin as-per plan.
Grading/Excavation/Fill Inspection Partial 11/19/2020
Misc
Informational
11/18/2020
10/17/20 Saturday Contractor has been grading the site again for about a week. The location of grading & excavating is near the site entrance off of View High Drive just North of I-470 Hwy.
Misc
Informational
11/18/2020
10/21/20 Contractor continued grading and filling site as-per plan. Work was stopped early today due to rainy weather conditions.
Misc
Informational
11/18/2020
11/17/20 Wednesday Contractor was working on grading and backfilling at various locations on site.
Misc
Informational
11/19/2020
11/19/20 Thursday Clarkson Dirty Crew continue to grade and excavate areas on project for building pads and site as-per plan.
Grading/Excavation/Fill Inspection Partial 11/20/2020
Misc
Informational
11/19/2020
10/17/20 Saturday Contractor has been grading the site again for about a week. The location of grading & excavating is near the site entrance off of View High Drive just North of I-470 Hwy.
Misc
Informational
11/19/2020
10/21/20 Contractor continued grading and filling site as-per plan. Work was stopped early today due to rainy weather conditions.
Misc
Informational
11/19/2020
11/17/20 Wednesday Contractor was working on grading and backfilling at various locations on site.
Misc
Informational
11/19/2020
11/19/20 Thursday Clarkson Dirty Crew continue to grade and excavate areas on project for building pads and site as-per plan.
Misc
Informational
11/20/2020
11/20/20 Friday Contractor continues to grade and excavate project site.
Storm - Material Verification Partial 12/11/2020
Misc
Informational
12/11/2020
12/11/20 Friday Storm piping and MH on site. I will contact contractor to verify if any work was done onsite.
Grading/Excavation/Fill Inspection Partial 12/14/2020
Misc
Informational
11/20/2020
10/17/20 Saturday Contractor has been grading the site again for about a week. The location of grading & excavating is near the site entrance off of View High Drive just North of I-470 Hwy.
Misc
Informational
11/20/2020
10/21/20 Contractor continued grading and filling site as-per plan. Work was stopped early today due to rainy weather conditions.
Misc
Informational
11/20/2020
11/17/20 Wednesday Contractor was working on grading and backfilling at various locations on site.
Misc
Informational
11/20/2020
11/19/20 Thursday Clarkson Dirty Crew continue to grade and excavate areas on project for building pads and site as-per plan.
Misc
Informational
11/20/2020
11/20/20 Friday Contractor continues to grade and excavate project site.
Misc
Informational
12/14/2020
12/14/20 Contractor continues massive grading and excavating on project site. Sanitary ( Kansas City ) work has started on site.
Grading/Excavation/Fill Inspection Partial 12/17/2020
Misc
Informational
12/14/2020
10/17/20 Saturday Contractor has been grading the site again for about a week. The location of grading & excavating is near the site entrance off of View High Drive just North of I-470 Hwy.
Misc
Informational
12/14/2020
10/21/20 Contractor continued grading and filling site as-per plan. Work was stopped early today due to rainy weather conditions.
Misc
Informational
12/14/2020
11/17/20 Wednesday Contractor was working on grading and backfilling at various locations on site.
Misc
Informational
12/14/2020
11/19/20 Thursday Clarkson Dirty Crew continue to grade and excavate areas on project for building pads and site as-per plan.
Misc
Informational
12/14/2020
11/20/20 Friday Contractor continues to grade and excavate project site.
Misc
Informational
12/14/2020
12/14/20 Contractor continues massive grading and excavating on project site. Sanitary ( Kansas City ) work has started on site.
Misc
Informational
12/17/2020
12/17/20 Thursday 9:40AM Major excavation and backfill throughout the project site to raise the elevation levels.
Grading/Excavation/Fill Inspection Partial 12/18/2020
Misc
Informational
12/17/2020
10/17/20 Saturday Contractor has been grading the site again for about a week. The location of grading & excavating is near the site entrance off of View High Drive just North of I-470 Hwy.
Misc
Informational
12/17/2020
10/21/20 Contractor continued grading and filling site as-per plan. Work was stopped early today due to rainy weather conditions.
Misc
Informational
12/17/2020
11/17/20 Wednesday Contractor was working on grading and backfilling at various locations on site.
Misc
Informational
12/17/2020
11/19/20 Thursday Clarkson Dirty Crew continue to grade and excavate areas on project for building pads and site as-per plan.
Misc
Informational
12/17/2020
11/20/20 Friday Contractor continues to grade and excavate project site.
Misc
Informational
12/17/2020
12/14/20 Contractor continues massive grading and excavating on project site. Sanitary ( Kansas City ) work has started on site.
Misc
Informational
12/17/2020
12/17/20 Thursday 9:40AM Major excavation and backfill throughout the project site to raise the elevation levels.
Misc
Informational
12/18/2020
12/18/20 Friday 10:00AM Continued excavation and backfilling on project site
Storm - Outlet Structure Partial 12/21/2020
Misc
Informational
04/28/2020

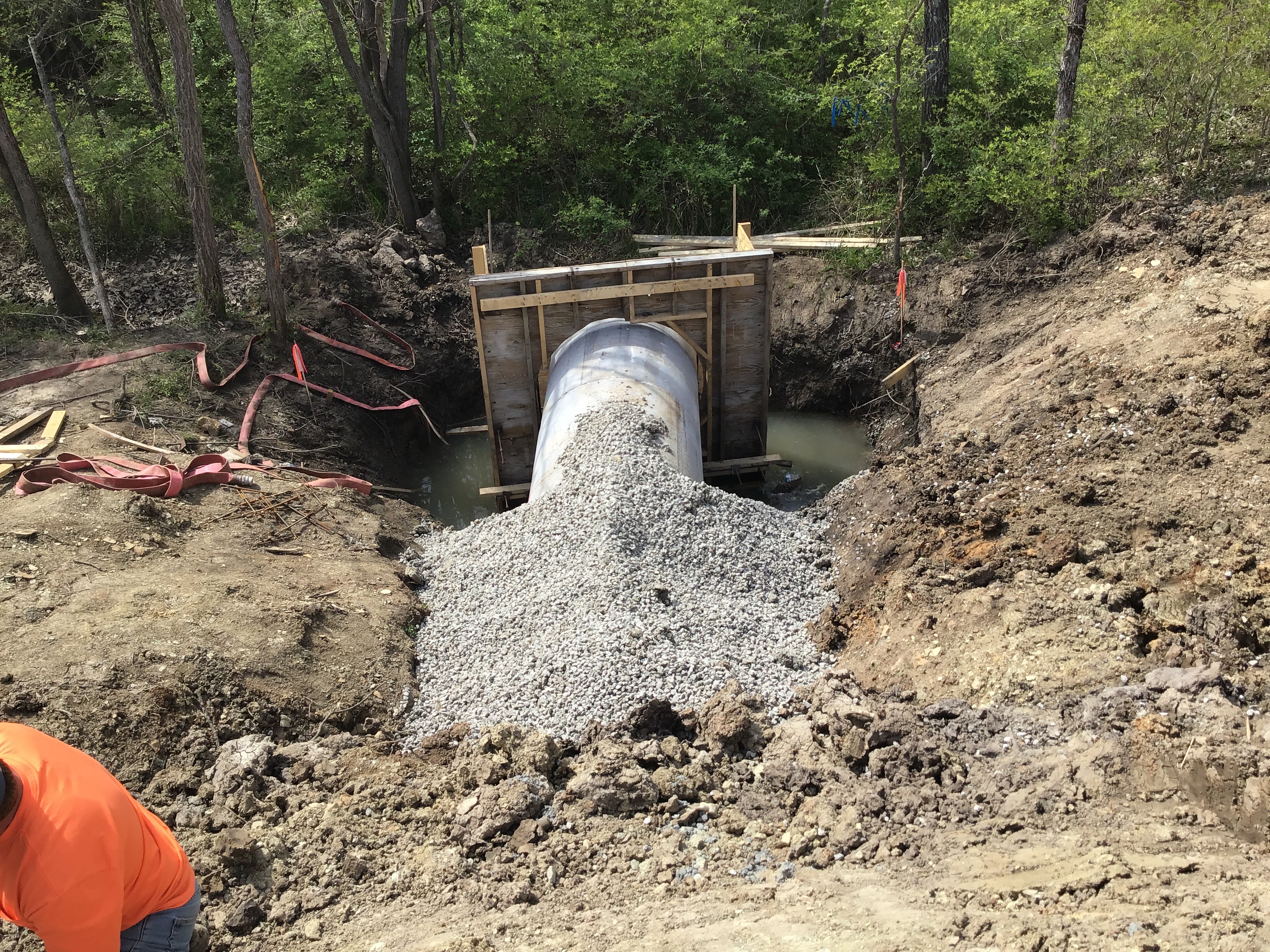

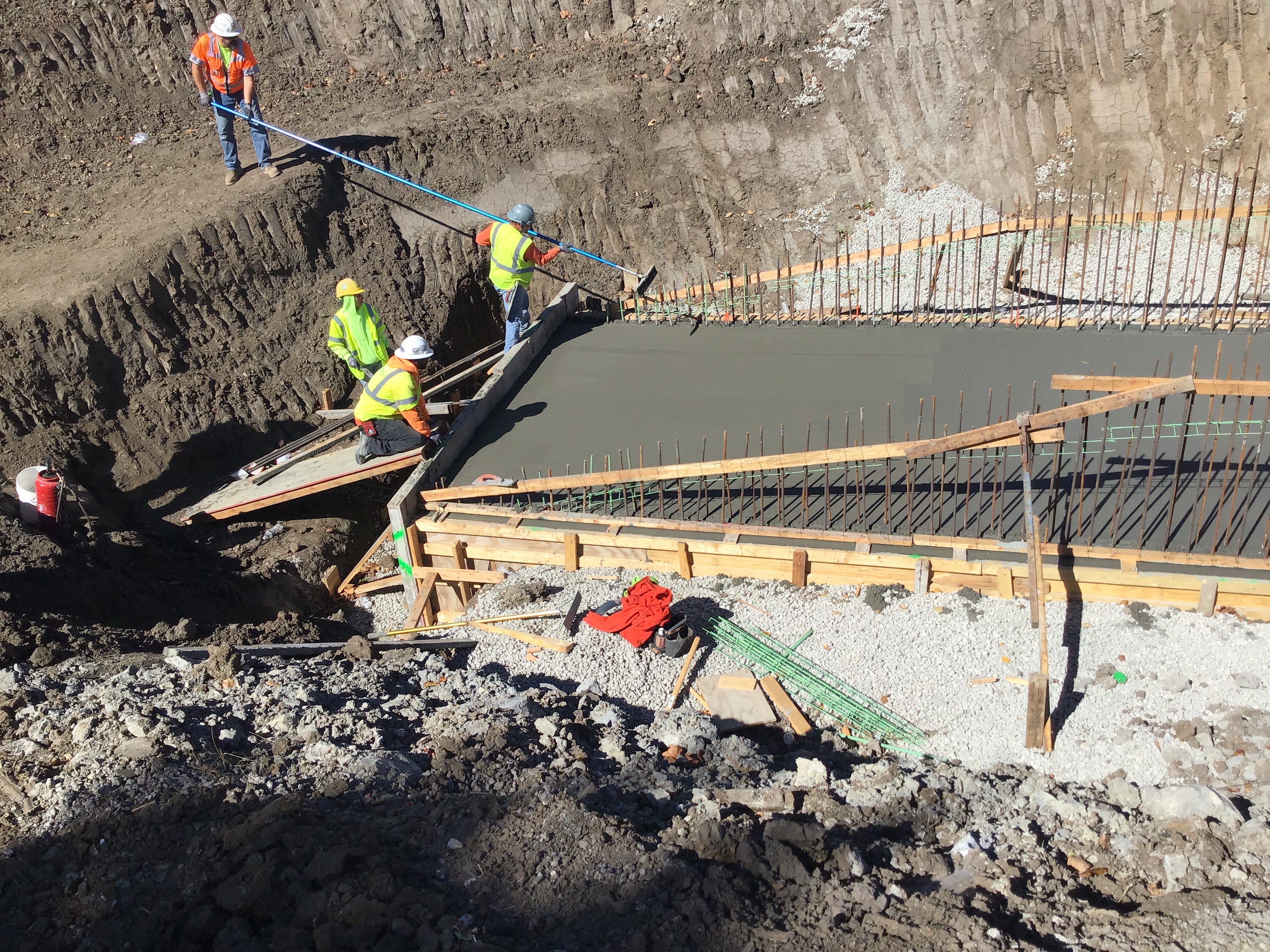

Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
04/28/2020
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
04/28/2020

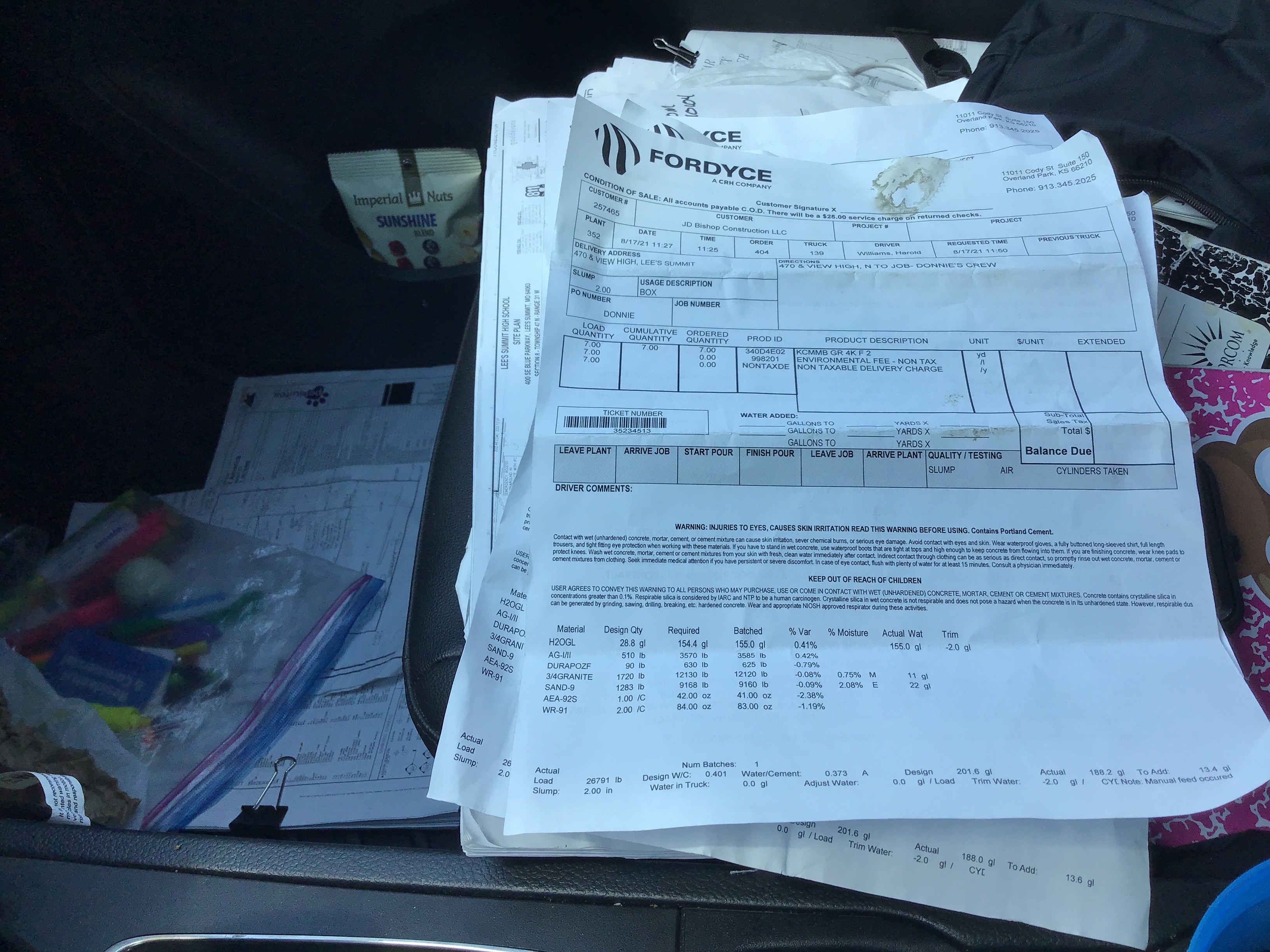

Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
04/28/2020
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
04/28/2020
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
04/28/2020
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
04/28/2020
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
12/21/2020
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Storm - Outlet Structure Partial 12/21/2020
Misc
Informational
12/21/2020
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
12/21/2020
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
12/21/2020
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
12/21/2020
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
12/21/2020
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
12/21/2020
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
12/21/2020
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
12/21/2020
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
12/21/2020
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Storm - Outlet Structure Partial 12/22/2020
Misc
Informational
12/21/2020

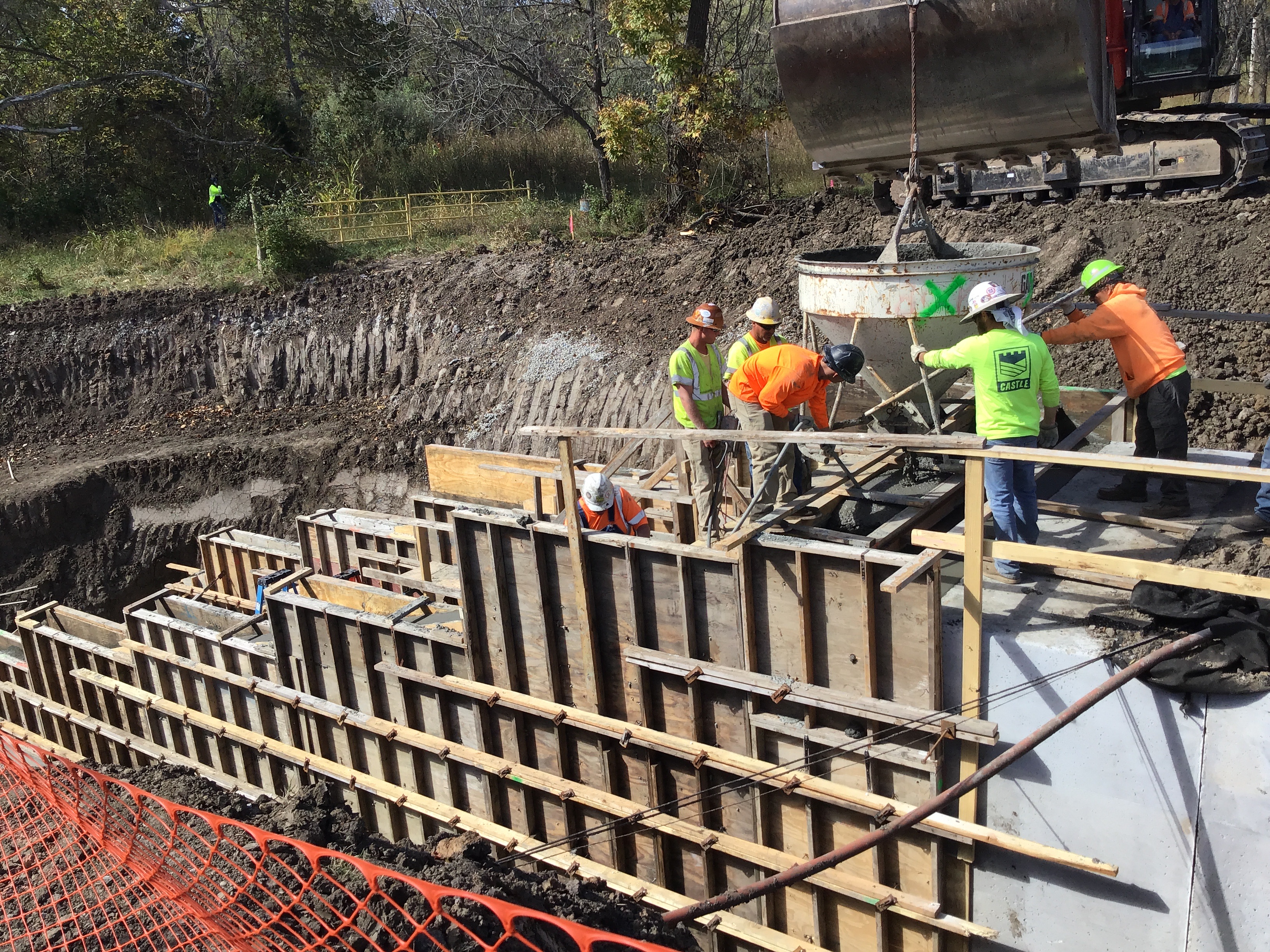

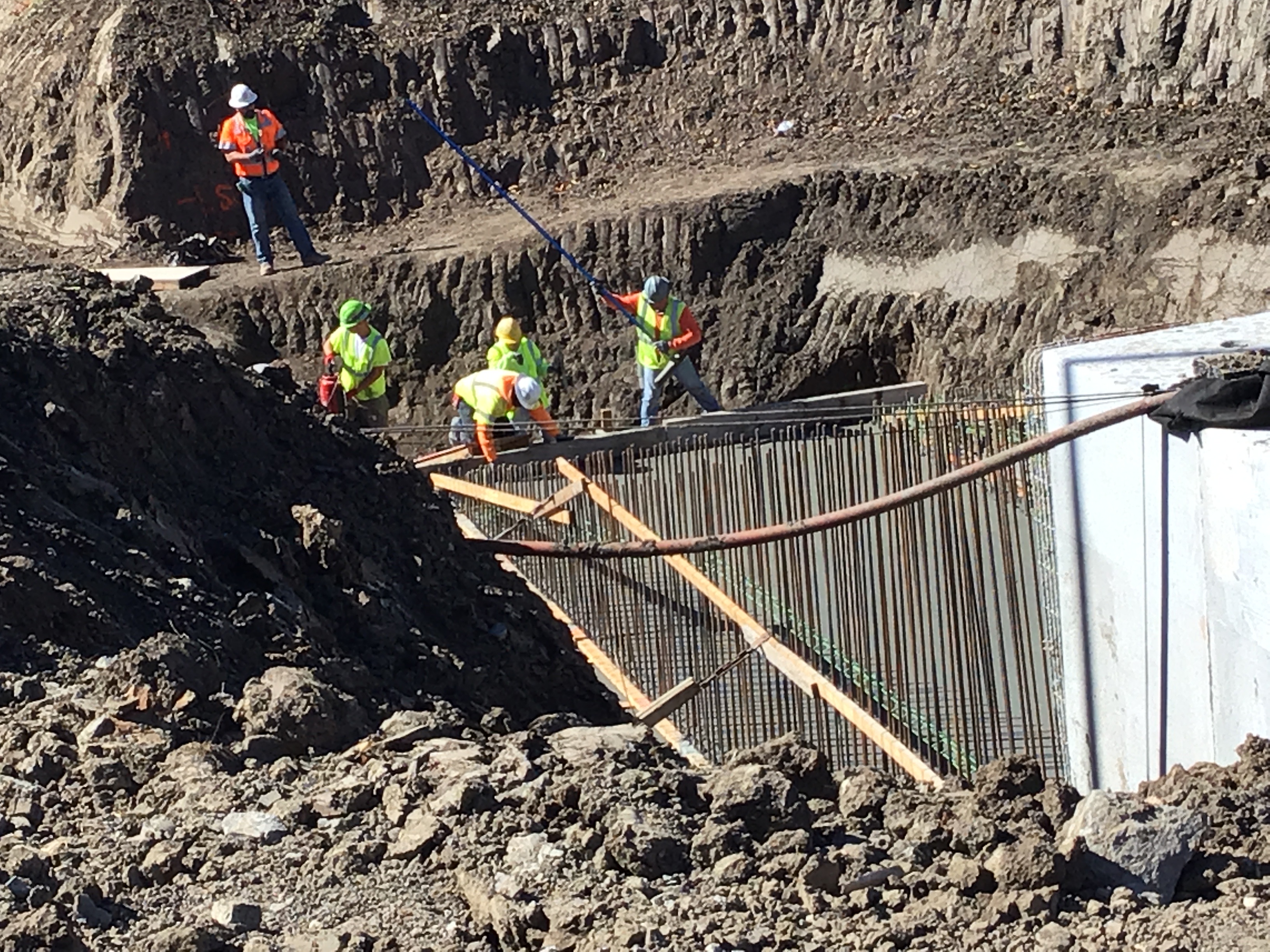

Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
12/21/2020
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
12/21/2020
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
12/21/2020
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
12/21/2020
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
12/21/2020
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
12/21/2020
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
12/21/2020
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
12/21/2020
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
12/22/2020
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Storm - Outlet Structure Partial 12/23/2020
Misc
Informational
12/22/2020
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
12/22/2020
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
12/22/2020
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
12/22/2020
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
12/22/2020
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
12/22/2020
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
12/22/2020
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
12/22/2020
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
12/22/2020
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
12/22/2020
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Misc
Informational
12/23/2020
12/23/20 Wednesday 12:20PM Contractor Continued to install Mid section of storm Junction Box 700. Work on the storm line will restart at the beginning of next year.
Storm - Outlet Structure Partial 01/05/2021
Misc
Informational
12/23/2020
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
12/23/2020
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
12/23/2020
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
12/23/2020
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
12/23/2020
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
12/23/2020
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
12/23/2020
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
12/23/2020
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
12/23/2020
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
12/23/2020
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Misc
Informational
12/23/2020
12/23/20 Wednesday 12:20PM Contractor Continued to install Mid section of storm Junction Box 700. Work on the storm line will restart at the beginning of next year.
Misc
Informational
01/05/2021
1/5/21 Tuesday 1:00PM Contractor installed approximately 70’ of storm pipe from (installed 12/22/20) 4’x8’ Junction Box 701 to (installed 1/5/21) 4’x8’ Curb Inlet 702. Concrete collars were poured for junction box 701.
Storm - Outlet Structure Partial 01/06/2021
Misc
Informational
01/05/2021
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
01/05/2021
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
01/05/2021
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
01/05/2021
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
01/05/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
01/05/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
01/05/2021
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
01/05/2021
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
01/05/2021
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
01/05/2021
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Misc
Informational
01/05/2021
12/23/20 Wednesday 12:20PM Contractor Continued to install Mid section of storm Junction Box 700. Work on the storm line will restart at the beginning of next year.
Misc
Informational
01/05/2021
1/5/21 Tuesday 1:00PM Contractor installed approximately 70’ of storm pipe from (installed 12/22/20) 4’x8’ Junction Box 701 to (installed 1/5/21) 4’x8’ Curb Inlet 702. Concrete collars were poured for junction box 701.
Misc
Informational
01/06/2021
1/6/21 Wednesday 10:30AM Contractor installed approximately 35’ of storm pipe and 9’x4’ Storm Inlet 703. Contractor had to cease work due to rainfall. Contractor will try to continue later in the week.
Storm - Outlet Structure Partial 01/07/2021
Misc
Informational
01/06/2021
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
01/06/2021
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
01/06/2021
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
01/06/2021
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
01/06/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
01/06/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
01/06/2021
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
01/06/2021
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
01/06/2021
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
01/06/2021
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Misc
Informational
01/06/2021
12/23/20 Wednesday 12:20PM Contractor Continued to install Mid section of storm Junction Box 700. Work on the storm line will restart at the beginning of next year.
Misc
Informational
01/06/2021
1/5/21 Tuesday 1:00PM Contractor installed approximately 70’ of storm pipe from (installed 12/22/20) 4’x8’ Junction Box 701 to (installed 1/5/21) 4’x8’ Curb Inlet 702. Concrete collars were poured for junction box 701.
Misc
Informational
01/06/2021
1/6/21 Wednesday 10:30AM Contractor installed approximately 35’ of storm pipe and 9’x4’ Storm Inlet 703. Contractor had to cease work due to rainfall. Contractor will try to continue later in the week.
Misc
Informational
01/07/2021
1/7/21 Thursday 3:10PM Contractor (Clarkston Greg crew) installed approximately 55’ from 703 to 10’x5’ Inside (non setback)Storm Inlet 704. Concrete collars will be poured tomorrow. Contractor will send picture do to the very muddy condition of site from the week.
Storm - Outlet Structure Partial 01/08/2021
Misc
Informational
01/07/2021
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
01/07/2021
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
01/07/2021
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
01/07/2021
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
01/07/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
01/07/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
01/07/2021
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
01/07/2021
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
01/07/2021
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
01/07/2021
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Misc
Informational
01/07/2021
12/23/20 Wednesday 12:20PM Contractor Continued to install Mid section of storm Junction Box 700. Work on the storm line will restart at the beginning of next year.
Misc
Informational
01/07/2021
1/5/21 Tuesday 1:00PM Contractor installed approximately 70’ of storm pipe from (installed 12/22/20) 4’x8’ Junction Box 701 to (installed 1/5/21) 4’x8’ Curb Inlet 702. Concrete collars were poured for junction box 701.
Misc
Informational
01/07/2021
1/6/21 Wednesday 10:30AM Contractor installed approximately 35’ of storm pipe and 9’x4’ Storm Inlet 703. Contractor had to cease work due to rainfall. Contractor will try to continue later in the week.
Misc
Informational
01/07/2021
1/7/21 Thursday 3:10PM Contractor (Clarkston Greg crew) installed approximately 55’ from 703 to 10’x5’ Inside (non setback)Storm Inlet 704. Concrete collars will be poured tomorrow. Contractor will send picture do to the very muddy condition of site from the week.
Misc
Informational
01/08/2021
1/8/21 Friday 3:30PM Contractor poured collars @ 702,703, & 704. Stacks were installed on structure and backfilling will be done 1/11/21 Monday.
Storm - Outlet Structure Partial 01/11/2021
Misc
Informational
01/08/2021
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
01/08/2021
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
01/08/2021
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
01/08/2021
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
01/08/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
01/08/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
01/08/2021
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
01/08/2021
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
01/08/2021
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
01/08/2021
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Misc
Informational
01/08/2021
12/23/20 Wednesday 12:20PM Contractor Continued to install Mid section of storm Junction Box 700. Work on the storm line will restart at the beginning of next year.
Misc
Informational
01/08/2021
1/5/21 Tuesday 1:00PM Contractor installed approximately 70’ of storm pipe from (installed 12/22/20) 4’x8’ Junction Box 701 to (installed 1/5/21) 4’x8’ Curb Inlet 702. Concrete collars were poured for junction box 701.
Misc
Informational
01/08/2021
1/6/21 Wednesday 10:30AM Contractor installed approximately 35’ of storm pipe and 9’x4’ Storm Inlet 703. Contractor had to cease work due to rainfall. Contractor will try to continue later in the week.
Misc
Informational
01/08/2021
1/7/21 Thursday 3:10PM Contractor (Clarkston Greg crew) installed approximately 55’ from 703 to 10’x5’ Inside (non setback)Storm Inlet 704. Concrete collars will be poured tomorrow. Contractor will send picture do to the very muddy condition of site from the week.
Misc
Informational
01/08/2021
1/8/21 Friday 3:30PM Contractor poured collars @ 702,703, & 704. Stacks were installed on structure and backfilling will be done 1/11/21 Monday.
Misc
Informational
01/11/2021

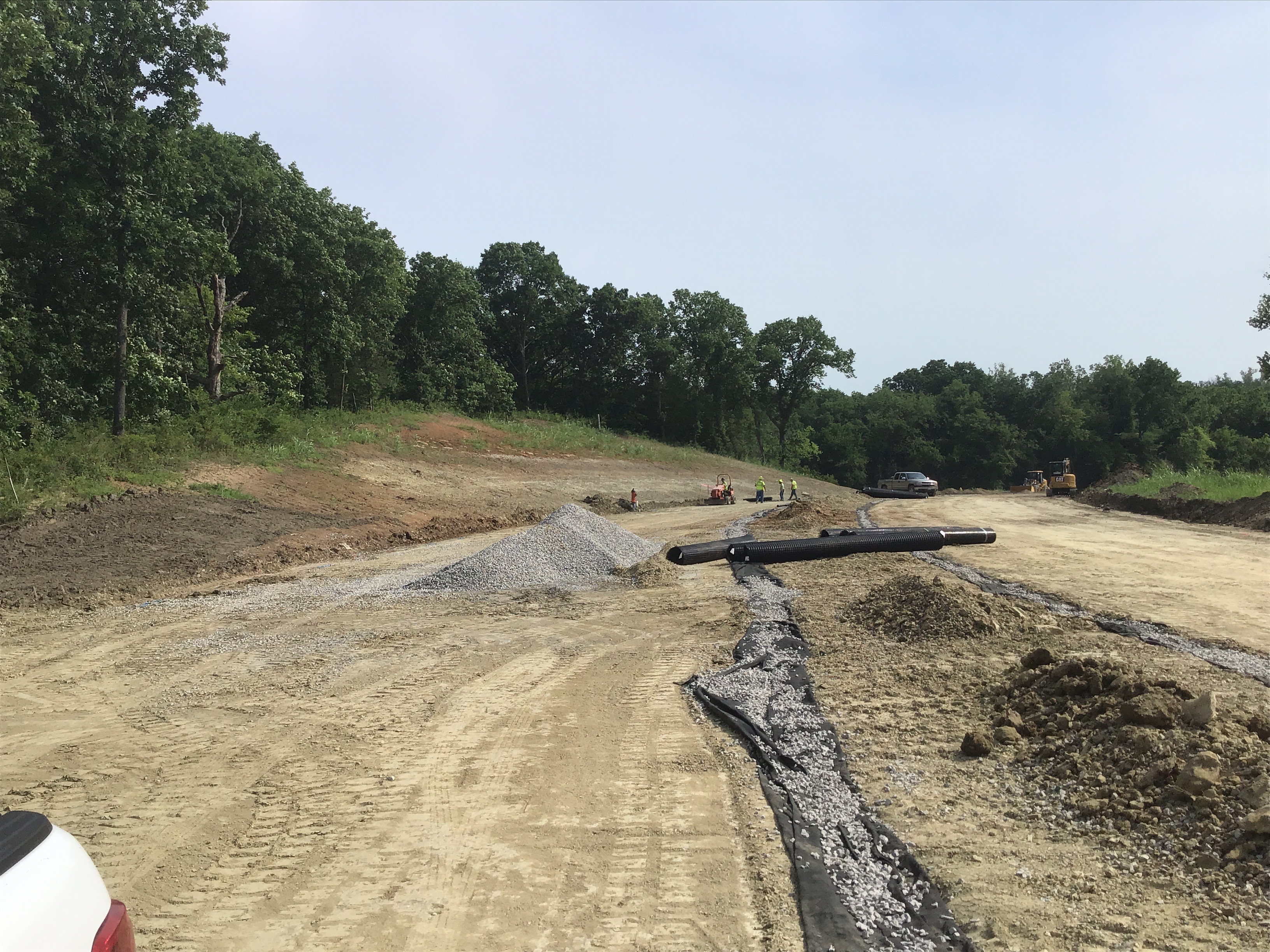

1/11/21 Monday Storm Line #1 contractor installed approximately 32’ of 48” RCP from the Little Blue River side.
Storm - Outlet Structure Partial 01/12/2021
Misc
Informational
01/11/2021
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
01/11/2021
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
01/11/2021
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
01/11/2021
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
01/11/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
01/11/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
01/11/2021

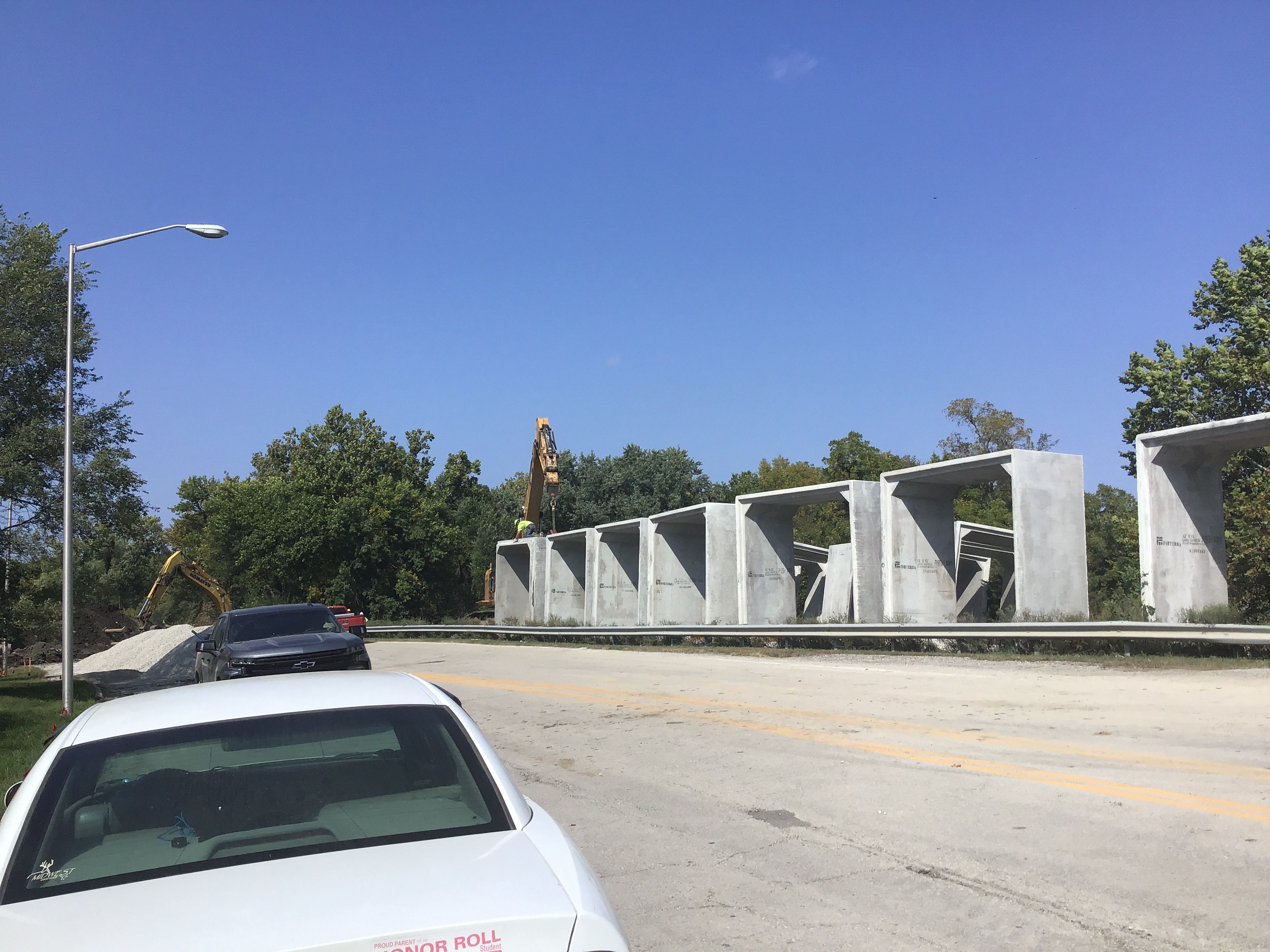

Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
01/11/2021
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
01/11/2021
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
01/11/2021
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Misc
Informational
01/11/2021
12/23/20 Wednesday 12:20PM Contractor Continued to install Mid section of storm Junction Box 700. Work on the storm line will restart at the beginning of next year.
Misc
Informational
01/11/2021
1/5/21 Tuesday 1:00PM Contractor installed approximately 70’ of storm pipe from (installed 12/22/20) 4’x8’ Junction Box 701 to (installed 1/5/21) 4’x8’ Curb Inlet 702. Concrete collars were poured for junction box 701.
Misc
Informational
01/11/2021
1/6/21 Wednesday 10:30AM Contractor installed approximately 35’ of storm pipe and 9’x4’ Storm Inlet 703. Contractor had to cease work due to rainfall. Contractor will try to continue later in the week.
Misc
Informational
01/11/2021
1/7/21 Thursday 3:10PM Contractor (Clarkston Greg crew) installed approximately 55’ from 703 to 10’x5’ Inside (non setback)Storm Inlet 704. Concrete collars will be poured tomorrow. Contractor will send picture do to the very muddy condition of site from the week.
Misc
Informational
01/11/2021
1/8/21 Friday 3:30PM Contractor poured collars @ 702,703, & 704. Stacks were installed on structure and backfilling will be done 1/11/21 Monday.
Misc
Informational
01/11/2021
1/11/21 Monday Storm Line #1 contractor installed approximately 32’ of 48” RCP from the Little Blue River side.
Misc
Informational
01/12/2021
11/12/21 Tuesday Storm Line #1 or 100 stakes were not set properly, survey crew will come out and retake storm line if necessary. Contractor (Clarkston Greg) crew will move bacK to Storm Line 700.
Storm - Outlet Structure Partial 01/12/2021
Misc
Informational
01/12/2021

Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
01/12/2021
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
01/12/2021
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
01/12/2021
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
01/12/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
01/12/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
01/12/2021
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
01/12/2021
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
01/12/2021
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
01/12/2021
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Misc
Informational
01/12/2021
12/23/20 Wednesday 12:20PM Contractor Continued to install Mid section of storm Junction Box 700. Work on the storm line will restart at the beginning of next year.
Misc
Informational
01/12/2021
1/5/21 Tuesday 1:00PM Contractor installed approximately 70’ of storm pipe from (installed 12/22/20) 4’x8’ Junction Box 701 to (installed 1/5/21) 4’x8’ Curb Inlet 702. Concrete collars were poured for junction box 701.
Misc
Informational
01/12/2021
1/6/21 Wednesday 10:30AM Contractor installed approximately 35’ of storm pipe and 9’x4’ Storm Inlet 703. Contractor had to cease work due to rainfall. Contractor will try to continue later in the week.
Misc
Informational
01/12/2021
1/7/21 Thursday 3:10PM Contractor (Clarkston Greg crew) installed approximately 55’ from 703 to 10’x5’ Inside (non setback)Storm Inlet 704. Concrete collars will be poured tomorrow. Contractor will send picture do to the very muddy condition of site from the week.
Misc
Informational
01/12/2021
1/8/21 Friday 3:30PM Contractor poured collars @ 702,703, & 704. Stacks were installed on structure and backfilling will be done 1/11/21 Monday.
Misc
Informational
01/12/2021
1/11/21 Monday Storm Line #1 contractor installed approximately 32’ of 48” RCP from the Little Blue River side.
Misc
Informational
01/12/2021
11/12/21 Tuesday Storm Line #1 or 100 stakes were not set properly, survey crew will come out and retake storm line if necessary. Contractor (Clarkston Greg) crew will move bacK to Storm Line 700.
Misc
Informational
01/12/2021
1/12/21 Tuesday Contractor moved back to working on Storm Line 700 and installed piping as-per plans.
Storm - Outlet Structure Partial 01/13/2021
Misc
Informational
01/12/2021
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
01/12/2021
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
01/12/2021
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
01/12/2021
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
01/12/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
01/12/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
01/12/2021
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
01/12/2021
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
01/12/2021
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
01/12/2021
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Misc
Informational
01/12/2021
12/23/20 Wednesday 12:20PM Contractor Continued to install Mid section of storm Junction Box 700. Work on the storm line will restart at the beginning of next year.
Misc
Informational
01/12/2021
1/5/21 Tuesday 1:00PM Contractor installed approximately 70’ of storm pipe from (installed 12/22/20) 4’x8’ Junction Box 701 to (installed 1/5/21) 4’x8’ Curb Inlet 702. Concrete collars were poured for junction box 701.
Misc
Informational
01/12/2021
1/6/21 Wednesday 10:30AM Contractor installed approximately 35’ of storm pipe and 9’x4’ Storm Inlet 703. Contractor had to cease work due to rainfall. Contractor will try to continue later in the week.
Misc
Informational
01/12/2021
1/7/21 Thursday 3:10PM Contractor (Clarkston Greg crew) installed approximately 55’ from 703 to 10’x5’ Inside (non setback)Storm Inlet 704. Concrete collars will be poured tomorrow. Contractor will send picture do to the very muddy condition of site from the week.
Misc
Informational
01/12/2021
1/8/21 Friday 3:30PM Contractor poured collars @ 702,703, & 704. Stacks were installed on structure and backfilling will be done 1/11/21 Monday.
Misc
Informational
01/12/2021
1/11/21 Monday Storm Line #1 contractor installed approximately 32’ of 48” RCP from the Little Blue River side.
Misc
Informational
01/12/2021
11/12/21 Tuesday Storm Line #1 or 100 stakes were not set properly, survey crew will come out and retake storm line if necessary. Contractor (Clarkston Greg) crew will move bacK to Storm Line 700.
Misc
Informational
01/12/2021
1/12/21 Tuesday Contractor moved back to working on Storm Line 700 and installed piping as-per plans.
Misc
Informational
01/13/2021
1/13/21 Wednesday Contractor moved back to Storm Line 100. Surveyor came out and reviewed the stakes errantly placed. It was sent back to the Engineers who approved the location of the already installed piping & structure of Line 100. Approximately 58’ of pipe and 7’X4’ 102 curb inlet was installed. A collar was poured on structure 101 and 102 will be partially poured at 2:00PM.
Grading/Excavation/Fill Inspection Partial 01/13/2021
Misc
Informational
12/18/2020
10/17/20 Saturday Contractor has been grading the site again for about a week. The location of grading & excavating is near the site entrance off of View High Drive just North of I-470 Hwy.
Misc
Informational
12/18/2020
10/21/20 Contractor continued grading and filling site as-per plan. Work was stopped early today due to rainy weather conditions.
Misc
Informational
12/18/2020
11/17/20 Wednesday Contractor was working on grading and backfilling at various locations on site.
Misc
Informational
12/18/2020
11/19/20 Thursday Clarkson Dirty Crew continue to grade and excavate areas on project for building pads and site as-per plan.
Misc
Informational
12/18/2020
11/20/20 Friday Contractor continues to grade and excavate project site.
Misc
Informational
12/18/2020
12/14/20 Contractor continues massive grading and excavating on project site. Sanitary ( Kansas City ) work has started on site.
Misc
Informational
12/18/2020
12/17/20 Thursday 9:40AM Major excavation and backfill throughout the project site to raise the elevation levels.
Misc
Informational
12/18/2020
12/18/20 Friday 10:00AM Continued excavation and backfilling on project site
Misc
Informational
01/13/2021

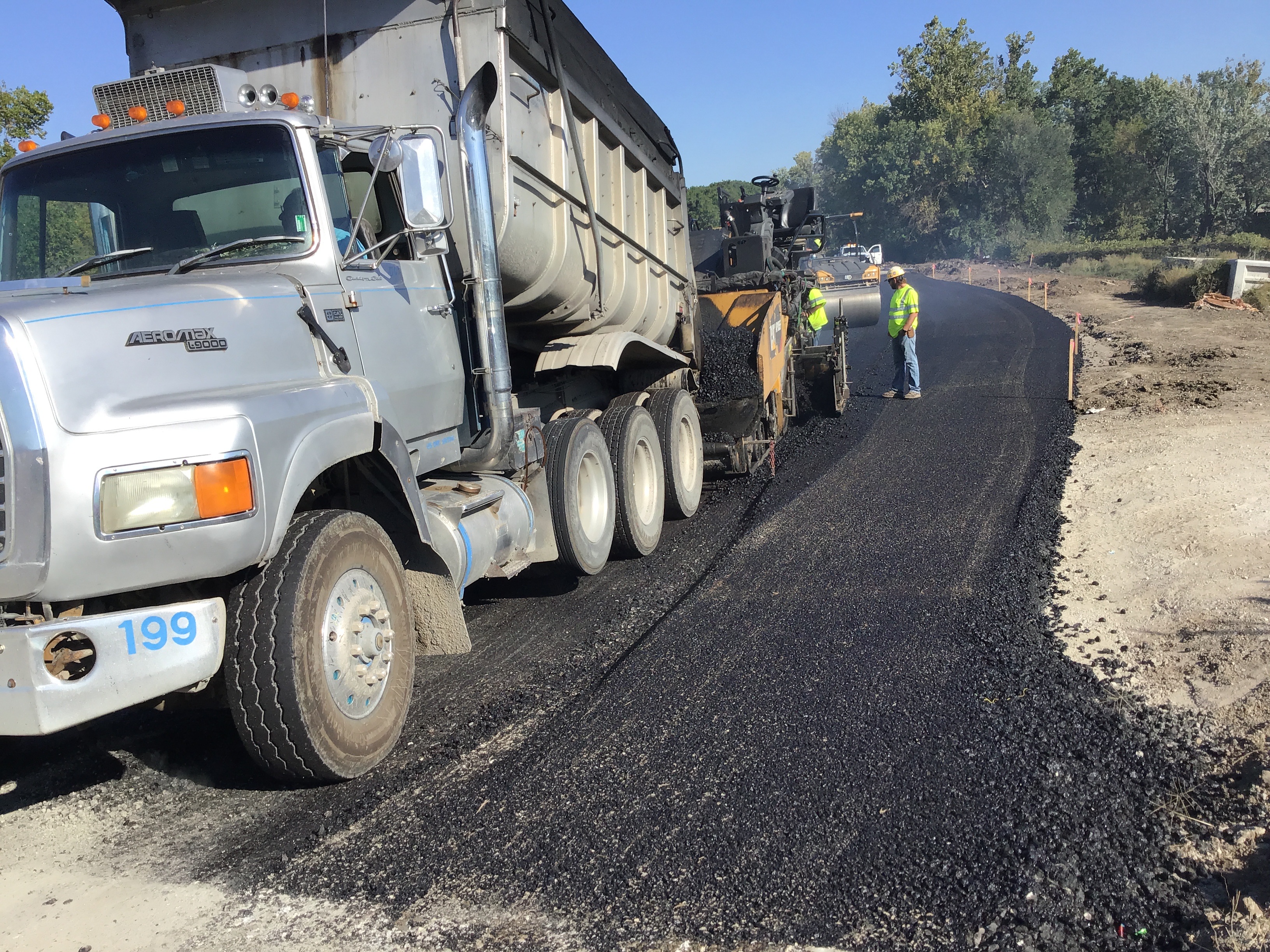

1/13/21 Wednesday Mass Grading continues on the project site .
Storm - Outlet Structure Partial 01/14/2021
Misc
Informational
01/13/2021
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
01/13/2021
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
01/13/2021
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
01/13/2021
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
01/13/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
01/13/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
01/13/2021
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
01/13/2021
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
01/13/2021
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
01/13/2021
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Misc
Informational
01/13/2021
12/23/20 Wednesday 12:20PM Contractor Continued to install Mid section of storm Junction Box 700. Work on the storm line will restart at the beginning of next year.
Misc
Informational
01/13/2021
1/5/21 Tuesday 1:00PM Contractor installed approximately 70’ of storm pipe from (installed 12/22/20) 4’x8’ Junction Box 701 to (installed 1/5/21) 4’x8’ Curb Inlet 702. Concrete collars were poured for junction box 701.
Misc
Informational
01/13/2021
1/6/21 Wednesday 10:30AM Contractor installed approximately 35’ of storm pipe and 9’x4’ Storm Inlet 703. Contractor had to cease work due to rainfall. Contractor will try to continue later in the week.
Misc
Informational
01/13/2021
1/7/21 Thursday 3:10PM Contractor (Clarkston Greg crew) installed approximately 55’ from 703 to 10’x5’ Inside (non setback)Storm Inlet 704. Concrete collars will be poured tomorrow. Contractor will send picture do to the very muddy condition of site from the week.
Misc
Informational
01/13/2021
1/8/21 Friday 3:30PM Contractor poured collars @ 702,703, & 704. Stacks were installed on structure and backfilling will be done 1/11/21 Monday.
Misc
Informational
01/13/2021
1/11/21 Monday Storm Line #1 contractor installed approximately 32’ of 48” RCP from the Little Blue River side.
Misc
Informational
01/13/2021
11/12/21 Tuesday Storm Line #1 or 100 stakes were not set properly, survey crew will come out and retake storm line if necessary. Contractor (Clarkston Greg) crew will move bacK to Storm Line 700.
Misc
Informational
01/13/2021
1/12/21 Tuesday Contractor moved back to working on Storm Line 700 and installed piping as-per plans.
Misc
Informational
01/13/2021
1/13/21 Wednesday Contractor moved back to Storm Line 100. Surveyor came out and reviewed the stakes errantly placed. It was sent back to the Engineers who approved the location of the already installed piping & structure of Line 100. Approximately 58’ of pipe and 7’X4’ 102 curb inlet was installed. A collar was poured on structure 101 and 102 will be partially poured at 2:00PM.
Misc
Informational
01/14/2021
1/14/21 Thursday Contractor moved back to Storm Line 700 and continued to install 60” RCP approximately 520’. Once I receive the project plans and number for Soccer Complex Storm Sewer Inspector will transfer daily progress).
Storm - Outlet Structure Partial 02/05/2021
Misc
Informational
01/14/2021
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
01/14/2021
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
01/14/2021
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
01/14/2021
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
01/14/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
01/14/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
01/14/2021
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
01/14/2021
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
01/14/2021
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
01/14/2021
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Misc
Informational
01/14/2021
12/23/20 Wednesday 12:20PM Contractor Continued to install Mid section of storm Junction Box 700. Work on the storm line will restart at the beginning of next year.
Misc
Informational
01/14/2021
1/5/21 Tuesday 1:00PM Contractor installed approximately 70’ of storm pipe from (installed 12/22/20) 4’x8’ Junction Box 701 to (installed 1/5/21) 4’x8’ Curb Inlet 702. Concrete collars were poured for junction box 701.
Misc
Informational
01/14/2021
1/6/21 Wednesday 10:30AM Contractor installed approximately 35’ of storm pipe and 9’x4’ Storm Inlet 703. Contractor had to cease work due to rainfall. Contractor will try to continue later in the week.
Misc
Informational
01/14/2021
1/7/21 Thursday 3:10PM Contractor (Clarkston Greg crew) installed approximately 55’ from 703 to 10’x5’ Inside (non setback)Storm Inlet 704. Concrete collars will be poured tomorrow. Contractor will send picture do to the very muddy condition of site from the week.
Misc
Informational
01/14/2021
1/8/21 Friday 3:30PM Contractor poured collars @ 702,703, & 704. Stacks were installed on structure and backfilling will be done 1/11/21 Monday.
Misc
Informational
01/14/2021
1/11/21 Monday Storm Line #1 contractor installed approximately 32’ of 48” RCP from the Little Blue River side.
Misc
Informational
01/14/2021
11/12/21 Tuesday Storm Line #1 or 100 stakes were not set properly, survey crew will come out and retake storm line if necessary. Contractor (Clarkston Greg) crew will move bacK to Storm Line 700.
Misc
Informational
01/14/2021
1/12/21 Tuesday Contractor moved back to working on Storm Line 700 and installed piping as-per plans.
Misc
Informational
01/14/2021
1/13/21 Wednesday Contractor moved back to Storm Line 100. Surveyor came out and reviewed the stakes errantly placed. It was sent back to the Engineers who approved the location of the already installed piping & structure of Line 100. Approximately 58’ of pipe and 7’X4’ 102 curb inlet was installed. A collar was poured on structure 101 and 102 will be partially poured at 2:00PM.
Misc
Informational
01/14/2021
1/14/21 Thursday Contractor moved back to Storm Line 700 and continued to install 60” RCP approximately 520’. Once I receive the project plans and number for Soccer Complex Storm Sewer Inspector will transfer daily progress).
Misc
Informational
02/05/2021
2/5/21 Friday Contractor moved back to Storm Line 100 and completed installation except for the last 12’ of were the retain wall is to be installed. Collar was poured on structure 102.
Storm - Outlet Structure Partial 03/09/2021
Misc
Informational
02/05/2021
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
02/05/2021
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
02/05/2021
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
02/05/2021
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
02/05/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
02/05/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
02/05/2021
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
02/05/2021
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
02/05/2021
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
02/05/2021
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Misc
Informational
02/05/2021
12/23/20 Wednesday 12:20PM Contractor Continued to install Mid section of storm Junction Box 700. Work on the storm line will restart at the beginning of next year.
Misc
Informational
02/05/2021
1/5/21 Tuesday 1:00PM Contractor installed approximately 70’ of storm pipe from (installed 12/22/20) 4’x8’ Junction Box 701 to (installed 1/5/21) 4’x8’ Curb Inlet 702. Concrete collars were poured for junction box 701.
Misc
Informational
02/05/2021
1/6/21 Wednesday 10:30AM Contractor installed approximately 35’ of storm pipe and 9’x4’ Storm Inlet 703. Contractor had to cease work due to rainfall. Contractor will try to continue later in the week.
Misc
Informational
02/05/2021
1/7/21 Thursday 3:10PM Contractor (Clarkston Greg crew) installed approximately 55’ from 703 to 10’x5’ Inside (non setback)Storm Inlet 704. Concrete collars will be poured tomorrow. Contractor will send picture do to the very muddy condition of site from the week.
Misc
Informational
02/05/2021
1/8/21 Friday 3:30PM Contractor poured collars @ 702,703, & 704. Stacks were installed on structure and backfilling will be done 1/11/21 Monday.
Misc
Informational
02/05/2021
1/11/21 Monday Storm Line #1 contractor installed approximately 32’ of 48” RCP from the Little Blue River side.
Misc
Informational
02/05/2021
11/12/21 Tuesday Storm Line #1 or 100 stakes were not set properly, survey crew will come out and retake storm line if necessary. Contractor (Clarkston Greg) crew will move bacK to Storm Line 700.
Misc
Informational
02/05/2021
1/12/21 Tuesday Contractor moved back to working on Storm Line 700 and installed piping as-per plans.
Misc
Informational
02/05/2021
1/13/21 Wednesday Contractor moved back to Storm Line 100. Surveyor came out and reviewed the stakes errantly placed. It was sent back to the Engineers who approved the location of the already installed piping & structure of Line 100. Approximately 58’ of pipe and 7’X4’ 102 curb inlet was installed. A collar was poured on structure 101 and 102 will be partially poured at 2:00PM.
Misc
Informational
02/05/2021
1/14/21 Thursday Contractor moved back to Storm Line 700 and continued to install 60” RCP approximately 520’. Once I receive the project plans and number for Soccer Complex Storm Sewer Inspector will transfer daily progress).
Misc
Informational
02/05/2021
2/5/21 Friday Contractor moved back to Storm Line 100 and completed installation except for the last 12’ of were the retain wall is to be installed. Collar was poured on structure 102.
Misc
Informational
03/09/2021
3/9/21 Tuesday Contractor installed 30” RCP from Curb Inlet 201 to 3901 Sta 13+56.19 to 12+13.72 Sheet 8 of 103 View High Parkway. Curb Inlet base 3901 was set.
Storm - Outlet Structure Partial 03/09/2021
Misc
Informational
03/09/2021
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
03/09/2021
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
03/09/2021
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
03/09/2021
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
03/09/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
03/09/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
03/09/2021
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
03/09/2021
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
03/09/2021
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
03/09/2021
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Misc
Informational
03/09/2021
12/23/20 Wednesday 12:20PM Contractor Continued to install Mid section of storm Junction Box 700. Work on the storm line will restart at the beginning of next year.
Misc
Informational
03/09/2021
1/5/21 Tuesday 1:00PM Contractor installed approximately 70’ of storm pipe from (installed 12/22/20) 4’x8’ Junction Box 701 to (installed 1/5/21) 4’x8’ Curb Inlet 702. Concrete collars were poured for junction box 701.
Misc
Informational
03/09/2021
1/6/21 Wednesday 10:30AM Contractor installed approximately 35’ of storm pipe and 9’x4’ Storm Inlet 703. Contractor had to cease work due to rainfall. Contractor will try to continue later in the week.
Misc
Informational
03/09/2021
1/7/21 Thursday 3:10PM Contractor (Clarkston Greg crew) installed approximately 55’ from 703 to 10’x5’ Inside (non setback)Storm Inlet 704. Concrete collars will be poured tomorrow. Contractor will send picture do to the very muddy condition of site from the week.
Misc
Informational
03/09/2021
1/8/21 Friday 3:30PM Contractor poured collars @ 702,703, & 704. Stacks were installed on structure and backfilling will be done 1/11/21 Monday.
Misc
Informational
03/09/2021
1/11/21 Monday Storm Line #1 contractor installed approximately 32’ of 48” RCP from the Little Blue River side.
Misc
Informational
03/09/2021
11/12/21 Tuesday Storm Line #1 or 100 stakes were not set properly, survey crew will come out and retake storm line if necessary. Contractor (Clarkston Greg) crew will move bacK to Storm Line 700.
Misc
Informational
03/09/2021
1/12/21 Tuesday Contractor moved back to working on Storm Line 700 and installed piping as-per plans.
Misc
Informational
03/09/2021
1/13/21 Wednesday Contractor moved back to Storm Line 100. Surveyor came out and reviewed the stakes errantly placed. It was sent back to the Engineers who approved the location of the already installed piping & structure of Line 100. Approximately 58’ of pipe and 7’X4’ 102 curb inlet was installed. A collar was poured on structure 101 and 102 will be partially poured at 2:00PM.
Misc
Informational
03/09/2021
1/14/21 Thursday Contractor moved back to Storm Line 700 and continued to install 60” RCP approximately 520’. Once I receive the project plans and number for Soccer Complex Storm Sewer Inspector will transfer daily progress).
Misc
Informational
03/09/2021
2/5/21 Friday Contractor moved back to Storm Line 100 and completed installation except for the last 12’ of were the retain wall is to be installed. Collar was poured on structure 102.
Misc
Informational
03/09/2021
3/9/21 Tuesday Contractor installed 30” RCP from Curb Inlet 201 to 3901 Sta 13+56.19 to 12+13.72 Sheet 8 of 103 View High Parkway. Curb Inlet base 3901 was set.
Misc
Informational
03/09/2021
3/9/21 Tuesday Contractor ( Darron crew - Clarkston ) installed RCP from newly installed Curb Inlet 201 to 202. Olsson lab did compaction test for street crossing of storm pipe. See pg 8 of 103.
Misc
Informational
03/09/2021
3/9/21 Tuesday Contractor ( Darron crew - Clarkston ) poured invert and collars on storm structure Curb Inlet 2600 & 2601 on View High Road ( Curb Inlets bases were installed 3/8/21 Monday ).
Storm - Outlet Structure Partial 03/10/2021
Misc
Informational
03/09/2021
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
03/09/2021
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
03/09/2021
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
03/09/2021
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
03/09/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
03/09/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
03/09/2021
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
03/09/2021
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
03/09/2021
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
03/09/2021
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Misc
Informational
03/09/2021
12/23/20 Wednesday 12:20PM Contractor Continued to install Mid section of storm Junction Box 700. Work on the storm line will restart at the beginning of next year.
Misc
Informational
03/09/2021
1/5/21 Tuesday 1:00PM Contractor installed approximately 70’ of storm pipe from (installed 12/22/20) 4’x8’ Junction Box 701 to (installed 1/5/21) 4’x8’ Curb Inlet 702. Concrete collars were poured for junction box 701.
Misc
Informational
03/09/2021
1/6/21 Wednesday 10:30AM Contractor installed approximately 35’ of storm pipe and 9’x4’ Storm Inlet 703. Contractor had to cease work due to rainfall. Contractor will try to continue later in the week.
Misc
Informational
03/09/2021
1/7/21 Thursday 3:10PM Contractor (Clarkston Greg crew) installed approximately 55’ from 703 to 10’x5’ Inside (non setback)Storm Inlet 704. Concrete collars will be poured tomorrow. Contractor will send picture do to the very muddy condition of site from the week.
Misc
Informational
03/09/2021
1/8/21 Friday 3:30PM Contractor poured collars @ 702,703, & 704. Stacks were installed on structure and backfilling will be done 1/11/21 Monday.
Misc
Informational
03/09/2021
1/11/21 Monday Storm Line #1 contractor installed approximately 32’ of 48” RCP from the Little Blue River side.
Misc
Informational
03/09/2021
11/12/21 Tuesday Storm Line #1 or 100 stakes were not set properly, survey crew will come out and retake storm line if necessary. Contractor (Clarkston Greg) crew will move bacK to Storm Line 700.
Misc
Informational
03/09/2021
1/12/21 Tuesday Contractor moved back to working on Storm Line 700 and installed piping as-per plans.
Misc
Informational
03/09/2021
1/13/21 Wednesday Contractor moved back to Storm Line 100. Surveyor came out and reviewed the stakes errantly placed. It was sent back to the Engineers who approved the location of the already installed piping & structure of Line 100. Approximately 58’ of pipe and 7’X4’ 102 curb inlet was installed. A collar was poured on structure 101 and 102 will be partially poured at 2:00PM.
Misc
Informational
03/09/2021
1/14/21 Thursday Contractor moved back to Storm Line 700 and continued to install 60” RCP approximately 520’. Once I receive the project plans and number for Soccer Complex Storm Sewer Inspector will transfer daily progress).
Misc
Informational
03/09/2021
2/5/21 Friday Contractor moved back to Storm Line 100 and completed installation except for the last 12’ of were the retain wall is to be installed. Collar was poured on structure 102.
Misc
Informational
03/09/2021
3/9/21 Tuesday Contractor installed 30” RCP from Curb Inlet 201 to 3901 Sta 13+56.19 to 12+13.72 Sheet 8 of 103 View High Parkway. Curb Inlet base 3901 was set.
Misc
Informational
03/09/2021
3/9/21 Tuesday Contractor ( Darron crew - Clarkston ) installed RCP from newly installed Curb Inlet 201 to 202. Olsson lab did compaction test for street crossing of storm pipe. See pg 8 of 103.
Misc
Informational
03/09/2021
3/9/21 Tuesday Contractor ( Darron crew - Clarkston ) poured invert and
Misc
Informational
03/10/2021
3/10/21 Wednesday Correction - contractor installed storm line from Curb Inlet 102 to 201 on 3/9/21 Tuesday. See sheet 8 of 103. Contractor installing 24” corrugated storm pipe from Curb Inlet 202
Storm Sewer Construction Inspection Partial 03/11/2021
Misc
Informational
11/18/2020
9/29/20 Tuesday Contractor continued to install 12”X12” RCB Storm Line 4100 ( see DE Storm - Pipe for early progress reports ) contractor laid over seven section 9/28/20 Monday. Contractor has continued excavation and installation across View High Dr as-per plans ( Pg. 13 of 43 ).
Misc
Informational
11/18/2020
9/30/20 Wednesday Contractor continued back fill Storm Line 4100 while Ollson Testing Lab tested lifts.
Misc
Informational
11/18/2020
10/1/20 Thursday Contractor continued to backfilled the Storm Line 4100. Contractor began to excavate for the Wing Wall as-per project plan.
Misc
Informational
11/18/2020
10/2/20 Friday Contractor continues to backfill the Storm line 4100 in lifts and remove excavated soil to other site areas to raise elevation levels.
Misc
Informational
11/18/2020
10/12/20 Monday Contractor began to frame and from for Plate Forms and Toe Walls on the West & East side of Storm Line 4100 that extends across View High Drive 10/5 thru 10/9. Contractor poured Plate Form on the Westside of Storm Line 4100 as per project plans.
Misc
Informational
11/18/2020
10/13/20 Tuesday Contractor continued to frame forms for Toe Walls on the Westside of Storm Line 4100. Concrete pour is schedule for tomorrow.
Misc
Informational
11/18/2020
10/14/20 Wednesday Contractor poured the Platform on the Eastside of Storm Line 4100 and continued to frame Toe Wall on the Westside.
Misc
Informational
11/18/2020
Misc
Informational
11/18/2020
10/15/20 Thursday Contractor continued to work on and framing Toe Wall for Storm Line 4100.
Misc
Informational
11/18/2020
Contractor poured Wing Walls for the Westside of 4100 Storm Line as-per project plans.
Misc
Informational
11/18/2020
10/19/20 Monday Contractor worked forming Wing Walls on the Eastside of 4100 Storm Line as-per project plans to prepare for concrete pour later in the week.
Misc
Informational
11/18/2020
10/21/20 Wednesday Contractor continued working on Wing Walls o Storm Line 4100.
Misc
Informational
11/18/2020
10/22/20 Thursday Contractor continues to prepare Eastside of Storm Line 4100 to pour Wing Walls.
Misc
Informational
11/18/2020
11/18/20 Wednesday Installed corrugated piping between the detention basin as-per plan.
Misc
Informational
03/11/2021
3/11/21 Thursday Contractor ( Clarkson - Gregg crew ) installed inlet 402 108’ of 18” RCP from 402 to 3601 Inlet. Approximately 74’ of 18” HPDE from Inlet 201 to inlet 3901 and installed curb inlet 3901. Clarkson - Darron crew installed 109’ of 18” between CI-205 & 206, 134’ of 18” between CI-206 & Structure 207. Set 15” RCP end section poured collar on 27 & toe wall. Poured inverts & collars on 203-206.
Storm Sewer Construction Inspection Partial 03/30/2021
Misc
Informational
03/11/2021
9/29/20 Tuesday Contractor continued to install 12”X12” RCB Storm Line 4100 ( see DE Storm - Pipe for early progress reports ) contractor laid over seven section 9/28/20 Monday. Contractor has continued excavation and installation across View High Dr as-per plans ( Pg. 13 of 43 ).
Misc
Informational
03/11/2021
9/30/20 Wednesday Contractor continued back fill Storm Line 4100 while Ollson Testing Lab tested lifts.
Misc
Informational
03/11/2021
10/1/20 Thursday Contractor continued to backfilled the Storm Line 4100. Contractor began to excavate for the Wing Wall as-per project plan.
Misc
Informational
03/11/2021
10/2/20 Friday Contractor continues to backfill the Storm line 4100 in lifts and remove excavated soil to other site areas to raise elevation levels.
Misc
Informational
03/11/2021
10/12/20 Monday Contractor began to frame and from for Plate Forms and Toe Walls on the West & East side of Storm Line 4100 that extends across View High Drive 10/5 thru 10/9. Contractor poured Plate Form on the Westside of Storm Line 4100 as per project plans.
Misc
Informational
03/11/2021
10/13/20 Tuesday Contractor continued to frame forms for Toe Walls on the Westside of Storm Line 4100. Concrete pour is schedule for tomorrow.
Misc
Informational
03/11/2021
10/14/20 Wednesday Contractor poured the Platform on the Eastside of Storm Line 4100 and continued to frame Toe Wall on the Westside.
Misc
Informational
03/11/2021
Misc
Informational
03/11/2021
10/15/20 Thursday Contractor continued to work on and framing Toe Wall for Storm Line 4100.
Misc
Informational
03/11/2021
Contractor poured Wing Walls for the Westside of 4100 Storm Line as-per project plans.
Misc
Informational
03/11/2021
10/19/20 Monday Contractor worked forming Wing Walls on the Eastside of 4100 Storm Line as-per project plans to prepare for concrete pour later in the week.
Misc
Informational
03/11/2021
10/21/20 Wednesday Contractor continued working on Wing Walls o Storm Line 4100.
Misc
Informational
03/11/2021
10/22/20 Thursday Contractor continues to prepare Eastside of Storm Line 4100 to pour Wing Walls.
Misc
Informational
03/11/2021
11/18/20 Wednesday Installed corrugated piping between the detention basin as-per plan.
Misc
Informational
03/11/2021
3/11/21 Thursday Contractor ( Clarkson - Gregg crew ) installed inlet 402 108’ of 18” RCP from 402 to 3601 Inlet. Approximately 74’ of 18” HPDE from Inlet 201 to inlet 3901 and installed curb inlet 3901. Clarkson - Darron crew installed 109’ of 18” between CI-205 & 206, 134’ of 18” between CI-206 & Structure 207. Set 15” RCP end section poured collar on 27 & toe wall. Poured inverts & collars on 203-206.
Misc
Informational
03/30/2021
3/30/21 Tuesday Contractor ( Clarkson - Darron crew ) installed C.I. (Curb Inlets) 404,403, 402,3601,401,400,3801,& 501A from 3/25 to 3/30 majority of collars and inverts were poured.
Storm Sewer Construction Inspection Partial 03/31/2021
Misc
Informational
03/30/2021
9/29/20 Tuesday Contractor continued to install 12”X12” RCB Storm Line 4100 ( see DE Storm - Pipe for early progress reports ) contractor laid over seven section 9/28/20 Monday. Contractor has continued excavation and installation across View High Dr as-per plans ( Pg. 13 of 43 ).
Misc
Informational
03/30/2021
9/30/20 Wednesday Contractor continued back fill Storm Line 4100 while Ollson Testing Lab tested lifts.
Misc
Informational
03/30/2021
10/1/20 Thursday Contractor continued to backfilled the Storm Line 4100. Contractor began to excavate for the Wing Wall as-per project plan.
Misc
Informational
03/30/2021
10/2/20 Friday Contractor continues to backfill the Storm line 4100 in lifts and remove excavated soil to other site areas to raise elevation levels.
Misc
Informational
03/30/2021
10/12/20 Monday Contractor began to frame and from for Plate Forms and Toe Walls on the West & East side of Storm Line 4100 that extends across View High Drive 10/5 thru 10/9. Contractor poured Plate Form on the Westside of Storm Line 4100 as per project plans.
Misc
Informational
03/30/2021
10/13/20 Tuesday Contractor continued to frame forms for Toe Walls on the Westside of Storm Line 4100. Concrete pour is schedule for tomorrow.
Misc
Informational
03/30/2021
10/14/20 Wednesday Contractor poured the Platform on the Eastside of Storm Line 4100 and continued to frame Toe Wall on the Westside.
Misc
Informational
03/30/2021
Misc
Informational
03/30/2021
10/15/20 Thursday Contractor continued to work on and framing Toe Wall for Storm Line 4100.
Misc
Informational
03/30/2021
Contractor poured Wing Walls for the Westside of 4100 Storm Line as-per project plans.
Misc
Informational
03/30/2021
10/19/20 Monday Contractor worked forming Wing Walls on the Eastside of 4100 Storm Line as-per project plans to prepare for concrete pour later in the week.
Misc
Informational
03/30/2021
10/21/20 Wednesday Contractor continued working on Wing Walls o Storm Line 4100.
Misc
Informational
03/30/2021
10/22/20 Thursday Contractor continues to prepare Eastside of Storm Line 4100 to pour Wing Walls.
Misc
Informational
03/30/2021
11/18/20 Wednesday Installed corrugated piping between the detention basin as-per plan.
Misc
Informational
03/30/2021
3/11/21 Thursday Contractor ( Clarkson - Gregg crew ) installed inlet 402 108’ of 18” RCP from 402 to 3601 Inlet. Approximately 74’ of 18” HPDE from Inlet 201 to inlet 3901 and installed curb inlet 3901. Clarkson - Darron crew installed 109’ of 18” between CI-205 & 206, 134’ of 18” between CI-206 & Structure 207. Set 15” RCP end section poured collar on 27 & toe wall. Poured inverts & collars on 203-206.
Misc
Informational
03/30/2021
3/30/21 Tuesday Contractor ( Clarkson - Darron crew ) installed C.I. (Curb Inlets) 404,403, 402,3601,401,400,3801,& 501A from 3/25 to 3/30 majority of collars and inverts were poured.
Misc
Informational
03/31/2021
3/31/21 Wednesday Contractor ( Clarkson - Darron crew ) 3/24/21 Wednesday installed storm Line 4000- which was approximately 44’ of 15” RCP then set CI-4401. They worked on Line 400, tied pipe into Wing wall & installed approximately 45 of HDPE then set CI-401. They were rain out around 2:00PM. Today they back filled around CIs.
Storm - Outlet Structure Partial 04/02/2021
Misc
Informational
03/10/2021

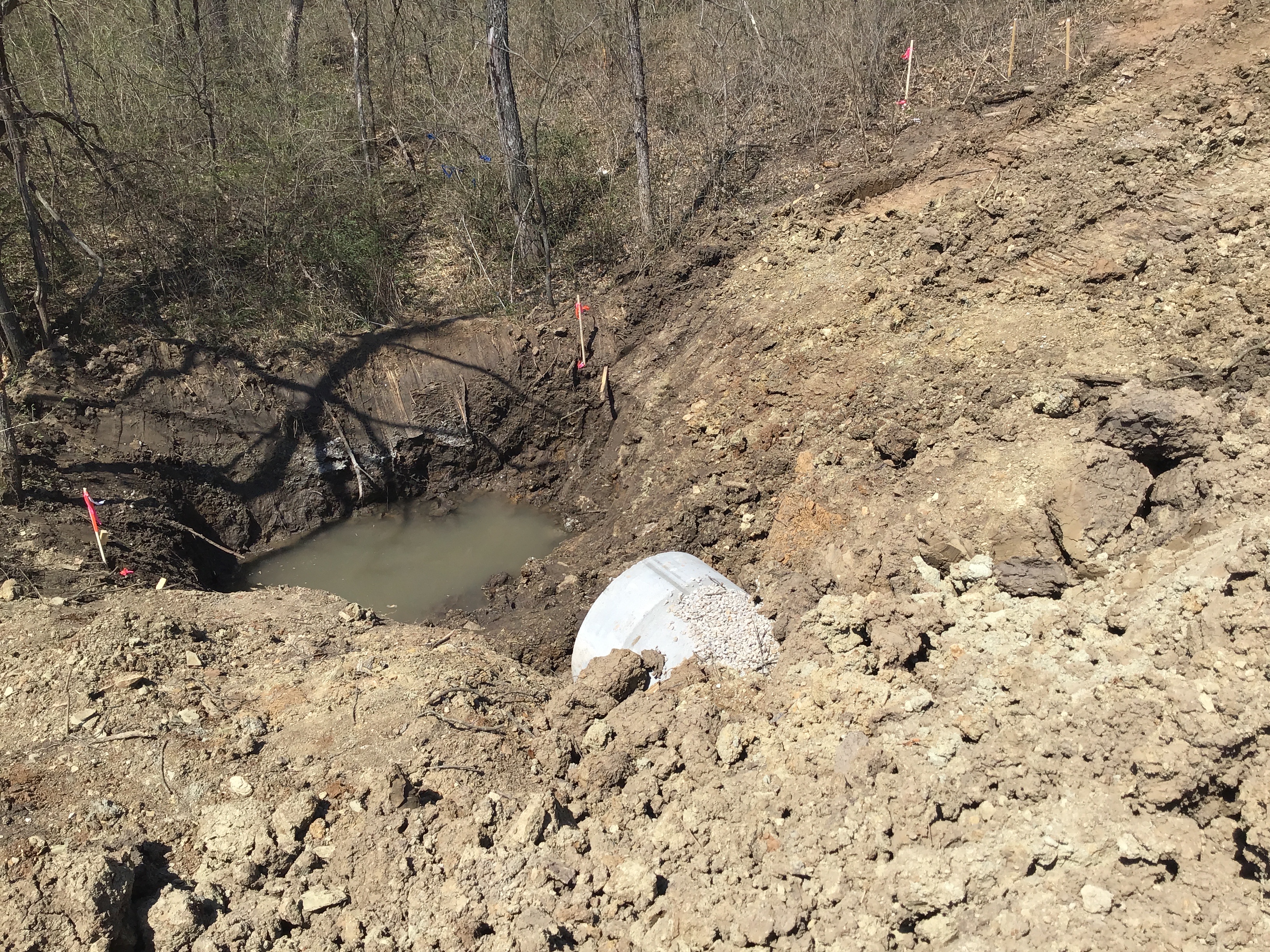

Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
03/10/2021
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
03/10/2021
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
03/10/2021
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
03/10/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
03/10/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
03/10/2021
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
03/10/2021
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
03/10/2021
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
03/10/2021
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Misc
Informational
03/10/2021
12/23/20 Wednesday 12:20PM Contractor Continued to install Mid section of storm Junction Box 700. Work on the storm line will restart at the beginning of next year.
Misc
Informational
03/10/2021
1/5/21 Tuesday 1:00PM Contractor installed approximately 70’ of storm pipe from (installed 12/22/20) 4’x8’ Junction Box 701 to (installed 1/5/21) 4’x8’ Curb Inlet 702. Concrete collars were poured for junction box 701.
Misc
Informational
03/10/2021
1/6/21 Wednesday 10:30AM Contractor installed approximately 35’ of storm pipe and 9’x4’ Storm Inlet 703. Contractor had to cease work due to rainfall. Contractor will try to continue later in the week.
Misc
Informational
03/10/2021
1/7/21 Thursday 3:10PM Contractor (Clarkston Greg crew) installed approximately 55’ from 703 to 10’x5’ Inside (non setback)Storm Inlet 704. Concrete collars will be poured tomorrow. Contractor will send picture do to the very muddy condition of site from the week.
Misc
Informational
03/10/2021
1/8/21 Friday 3:30PM Contractor poured collars @ 702,703, & 704. Stacks were installed on structure and backfilling will be done 1/11/21 Monday.
Misc
Informational
03/10/2021
1/11/21 Monday Storm Line #1 contractor installed approximately 32’ of 48” RCP from the Little Blue River side.
Misc
Informational
03/10/2021
11/12/21 Tuesday Storm Line #1 or 100 stakes were not set properly, survey crew will come out and retake storm line if necessary. Contractor (Clarkston Greg) crew will move bacK to Storm Line 700.
Misc
Informational
03/10/2021
1/12/21 Tuesday Contractor moved back to working on Storm Line 700 and installed piping as-per plans.
Misc
Informational
03/10/2021
1/13/21 Wednesday Contractor moved back to Storm Line 100. Surveyor came out and reviewed the stakes errantly placed. It was sent back to the Engineers who approved the location of the already installed piping & structure of Line 100. Approximately 58’ of pipe and 7’X4’ 102 curb inlet was installed. A collar was poured on structure 101 and 102 will be partially poured at 2:00PM.
Misc
Informational
03/10/2021
1/14/21 Thursday Contractor moved back to Storm Line 700 and continued to install 60” RCP approximately 520’. Once I receive the project plans and number for Soccer Complex Storm Sewer Inspector will transfer daily progress).
Misc
Informational
03/10/2021
2/5/21 Friday Contractor moved back to Storm Line 100 and completed installation except for the last 12’ of were the retain wall is to be installed. Collar was poured on structure 102.
Misc
Informational
03/10/2021
3/9/21 Tuesday Contractor installed 30” RCP from Curb Inlet 201 to 3901 Sta 13+56.19 to 12+13.72 Sheet 8 of 103 View High Parkway. Curb Inlet base 3901 was set.
Misc
Informational
03/10/2021
3/9/21 Tuesday Contractor ( Darron crew - Clarkston ) installed RCP from newly installed Curb Inlet 201 to 202. Olsson lab did compaction test for street crossing of storm pipe. See pg 8 of 103.
Misc
Informational
03/10/2021
3/9/21 Tuesday Contractor ( Darron crew - Clarkston ) poured invert and
Misc
Informational
03/10/2021
3/10/21 Wednesday Correction - contractor installed storm line from Curb Inlet 102 to 201 on 3/9/21 Tuesday. See sheet 8 of 103. Contractor installing 24” corrugated storm pipe from Curb Inlet 202
Misc
Informational
03/10/2021
3/10/21 Wednesday Contractor installed 24” corrugated storm pipe from Curb Inlet 203 to 4’ Dia Manhole 204. Contractor poured inverts and collars on installed structure.
Misc
Informational
04/02/2021
4/2/21 Friday Contractor GBA resurveyed structure 103 for Toe-wall installation by Clarkson. Wall construction will begin next week.
Storm Sewer Construction Inspection Partial 04/12/2021
Misc
Informational
04/12/2021
4/12/21 Monday Contractor (Clarkson - Gregg crew) backfilled and placed gravel on curb inlets along View High Parkway.
Storm - Outlet Structure Partial 04/15/2021
Misc
Informational
04/02/2021
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
04/02/2021
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
04/02/2021
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
04/02/2021
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
04/02/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
04/02/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
04/02/2021
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
04/02/2021
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
04/02/2021
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
04/02/2021
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Misc
Informational
04/02/2021
12/23/20 Wednesday 12:20PM Contractor Continued to install Mid section of storm Junction Box 700. Work on the storm line will restart at the beginning of next year.
Misc
Informational
04/02/2021
1/5/21 Tuesday 1:00PM Contractor installed approximately 70’ of storm pipe from (installed 12/22/20) 4’x8’ Junction Box 701 to (installed 1/5/21) 4’x8’ Curb Inlet 702. Concrete collars were poured for junction box 701.
Misc
Informational
04/02/2021
1/6/21 Wednesday 10:30AM Contractor installed approximately 35’ of storm pipe and 9’x4’ Storm Inlet 703. Contractor had to cease work due to rainfall. Contractor will try to continue later in the week.
Misc
Informational
04/02/2021
1/7/21 Thursday 3:10PM Contractor (Clarkston Greg crew) installed approximately 55’ from 703 to 10’x5’ Inside (non setback)Storm Inlet 704. Concrete collars will be poured tomorrow. Contractor will send picture do to the very muddy condition of site from the week.
Misc
Informational
04/02/2021
1/8/21 Friday 3:30PM Contractor poured collars @ 702,703, & 704. Stacks were installed on structure and backfilling will be done 1/11/21 Monday.
Misc
Informational
04/02/2021
1/11/21 Monday Storm Line #1 contractor installed approximately 32’ of 48” RCP from the Little Blue River side.
Misc
Informational
04/02/2021
11/12/21 Tuesday Storm Line #1 or 100 stakes were not set properly, survey crew will come out and retake storm line if necessary. Contractor (Clarkston Greg) crew will move bacK to Storm Line 700.
Misc
Informational
04/02/2021
1/12/21 Tuesday Contractor moved back to working on Storm Line 700 and installed piping as-per plans.
Misc
Informational
04/02/2021
1/13/21 Wednesday Contractor moved back to Storm Line 100. Surveyor came out and reviewed the stakes errantly placed. It was sent back to the Engineers who approved the location of the already installed piping & structure of Line 100. Approximately 58’ of pipe and 7’X4’ 102 curb inlet was installed. A collar was poured on structure 101 and 102 will be partially poured at 2:00PM.
Misc
Informational
04/02/2021
1/14/21 Thursday Contractor moved back to Storm Line 700 and continued to install 60” RCP approximately 520’. Once I receive the project plans and number for Soccer Complex Storm Sewer Inspector will transfer daily progress).
Misc
Informational
04/02/2021
2/5/21 Friday Contractor moved back to Storm Line 100 and completed installation except for the last 12’ of were the retain wall is to be installed. Collar was poured on structure 102.
Misc
Informational
04/02/2021
3/9/21 Tuesday Contractor installed 30” RCP from Curb Inlet 201 to 3901 Sta 13+56.19 to 12+13.72 Sheet 8 of 103 View High Parkway. Curb Inlet base 3901 was set.
Misc
Informational
04/02/2021
3/9/21 Tuesday Contractor ( Darron crew - Clarkston ) installed RCP from newly installed Curb Inlet 201 to 202. Olsson lab did compaction test for street crossing of storm pipe. See pg 8 of 103.
Misc
Informational
04/02/2021
3/9/21 Tuesday Contractor ( Darron crew - Clarkston ) poured invert and
Misc
Informational
04/02/2021
3/10/21 Wednesday Correction - contractor installed storm line from Curb Inlet 102 to 201 on 3/9/21 Tuesday. See sheet 8 of 103. Contractor installing 24” corrugated storm pipe from Curb Inlet 202
Misc
Informational
04/02/2021
3/10/21 Wednesday Contractor installed 24” corrugated storm pipe from Curb Inlet 203 to 4’ Dia Manhole 204. Contractor poured inverts and collars on installed structure.
Misc
Informational
04/02/2021
4/2/21 Friday Contractor GBA resurveyed structure 103 for Toe-wall installation by Clarkson. Wall construction will begin next week.
Misc
Informational
04/15/2021
4/15/21 Thursday Contractor (Clarkson - Bridge crew) poured toe-wall floor on Storm line 100 4/14/21 Wednesday and today (Clarkson - Gregg crew) installed the rest of the storm line 100 to the formed frame of the toe-wall.
Storm - Outlet Structure Partial 04/21/2021
Misc
Informational
04/15/2021
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
04/15/2021
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
04/15/2021
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
04/15/2021
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
04/15/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
04/15/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
04/15/2021
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
04/15/2021
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
04/15/2021
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
04/15/2021
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Misc
Informational
04/15/2021
12/23/20 Wednesday 12:20PM Contractor Continued to install Mid section of storm Junction Box 700. Work on the storm line will restart at the beginning of next year.
Misc
Informational
04/15/2021
1/5/21 Tuesday 1:00PM Contractor installed approximately 70’ of storm pipe from (installed 12/22/20) 4’x8’ Junction Box 701 to (installed 1/5/21) 4’x8’ Curb Inlet 702. Concrete collars were poured for junction box 701.
Misc
Informational
04/15/2021
1/6/21 Wednesday 10:30AM Contractor installed approximately 35’ of storm pipe and 9’x4’ Storm Inlet 703. Contractor had to cease work due to rainfall. Contractor will try to continue later in the week.
Misc
Informational
04/15/2021
1/7/21 Thursday 3:10PM Contractor (Clarkston Greg crew) installed approximately 55’ from 703 to 10’x5’ Inside (non setback)Storm Inlet 704. Concrete collars will be poured tomorrow. Contractor will send picture do to the very muddy condition of site from the week.
Misc
Informational
04/15/2021
1/8/21 Friday 3:30PM Contractor poured collars @ 702,703, & 704. Stacks were installed on structure and backfilling will be done 1/11/21 Monday.
Misc
Informational
04/15/2021
1/11/21 Monday Storm Line #1 contractor installed approximately 32’ of 48” RCP from the Little Blue River side.
Misc
Informational
04/15/2021
11/12/21 Tuesday Storm Line #1 or 100 stakes were not set properly, survey crew will come out and retake storm line if necessary. Contractor (Clarkston Greg) crew will move bacK to Storm Line 700.
Misc
Informational
04/15/2021
1/12/21 Tuesday Contractor moved back to working on Storm Line 700 and installed piping as-per plans.
Misc
Informational
04/15/2021
1/13/21 Wednesday Contractor moved back to Storm Line 100. Surveyor came out and reviewed the stakes errantly placed. It was sent back to the Engineers who approved the location of the already installed piping & structure of Line 100. Approximately 58’ of pipe and 7’X4’ 102 curb inlet was installed. A collar was poured on structure 101 and 102 will be partially poured at 2:00PM.
Misc
Informational
04/15/2021
1/14/21 Thursday Contractor moved back to Storm Line 700 and continued to install 60” RCP approximately 520’. Once I receive the project plans and number for Soccer Complex Storm Sewer Inspector will transfer daily progress).
Misc
Informational
04/15/2021
2/5/21 Friday Contractor moved back to Storm Line 100 and completed installation except for the last 12’ of were the retain wall is to be installed. Collar was poured on structure 102.
Misc
Informational
04/15/2021
3/9/21 Tuesday Contractor installed 30” RCP from Curb Inlet 201 to 3901 Sta 13+56.19 to 12+13.72 Sheet 8 of 103 View High Parkway. Curb Inlet base 3901 was set.
Misc
Informational
04/15/2021
3/9/21 Tuesday Contractor ( Darron crew - Clarkston ) installed RCP from newly installed Curb Inlet 201 to 202. Olsson lab did compaction test for street crossing of storm pipe. See pg 8 of 103.
Misc
Informational
04/15/2021
3/9/21 Tuesday Contractor ( Darron crew - Clarkston ) poured invert and
Misc
Informational
04/15/2021
3/10/21 Wednesday Correction - contractor installed storm line from Curb Inlet 102 to 201 on 3/9/21 Tuesday. See sheet 8 of 103. Contractor installing 24” corrugated storm pipe from Curb Inlet 202
Misc
Informational
04/15/2021
3/10/21 Wednesday Contractor installed 24” corrugated storm pipe from Curb Inlet 203 to 4’ Dia Manhole 204. Contractor poured inverts and collars on installed structure.
Misc
Informational
04/15/2021
4/2/21 Friday Contractor GBA resurveyed structure 103 for Toe-wall installation by Clarkson. Wall construction will begin next week.
Misc
Informational
04/15/2021
4/15/21 Thursday Contractor (Clarkson - Bridge crew) poured toe-wall floor on Storm line 100 4/14/21 Wednesday and today (Clarkson - Gregg crew) installed the rest of the storm line 100 to the formed frame of the toe-wall.
Misc
Informational
04/21/2021
Contractor Clarkson bridge crew pour the form around the end of storm outlet for Line 100. Picture will be taken after forms have been removed to verify visual inspection.
Storm - Outlet Structure Partial 04/22/2021
Misc
Informational
04/21/2021
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
04/21/2021
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
04/21/2021
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
04/21/2021
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
04/21/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
04/21/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
04/21/2021
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
04/21/2021
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
04/21/2021
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
04/21/2021
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Misc
Informational
04/21/2021
12/23/20 Wednesday 12:20PM Contractor Continued to install Mid section of storm Junction Box 700. Work on the storm line will restart at the beginning of next year.
Misc
Informational
04/21/2021
1/5/21 Tuesday 1:00PM Contractor installed approximately 70’ of storm pipe from (installed 12/22/20) 4’x8’ Junction Box 701 to (installed 1/5/21) 4’x8’ Curb Inlet 702. Concrete collars were poured for junction box 701.
Misc
Informational
04/21/2021
1/6/21 Wednesday 10:30AM Contractor installed approximately 35’ of storm pipe and 9’x4’ Storm Inlet 703. Contractor had to cease work due to rainfall. Contractor will try to continue later in the week.
Misc
Informational
04/21/2021
1/7/21 Thursday 3:10PM Contractor (Clarkston Greg crew) installed approximately 55’ from 703 to 10’x5’ Inside (non setback)Storm Inlet 704. Concrete collars will be poured tomorrow. Contractor will send picture do to the very muddy condition of site from the week.
Misc
Informational
04/21/2021
1/8/21 Friday 3:30PM Contractor poured collars @ 702,703, & 704. Stacks were installed on structure and backfilling will be done 1/11/21 Monday.
Misc
Informational
04/21/2021
1/11/21 Monday Storm Line #1 contractor installed approximately 32’ of 48” RCP from the Little Blue River side.
Misc
Informational
04/21/2021
11/12/21 Tuesday Storm Line #1 or 100 stakes were not set properly, survey crew will come out and retake storm line if necessary. Contractor (Clarkston Greg) crew will move bacK to Storm Line 700.
Misc
Informational
04/21/2021
1/12/21 Tuesday Contractor moved back to working on Storm Line 700 and installed piping as-per plans.
Misc
Informational
04/21/2021
1/13/21 Wednesday Contractor moved back to Storm Line 100. Surveyor came out and reviewed the stakes errantly placed. It was sent back to the Engineers who approved the location of the already installed piping & structure of Line 100. Approximately 58’ of pipe and 7’X4’ 102 curb inlet was installed. A collar was poured on structure 101 and 102 will be partially poured at 2:00PM.
Misc
Informational
04/21/2021
1/14/21 Thursday Contractor moved back to Storm Line 700 and continued to install 60” RCP approximately 520’. Once I receive the project plans and number for Soccer Complex Storm Sewer Inspector will transfer daily progress).
Misc
Informational
04/21/2021
2/5/21 Friday Contractor moved back to Storm Line 100 and completed installation except for the last 12’ of were the retain wall is to be installed. Collar was poured on structure 102.
Misc
Informational
04/21/2021
3/9/21 Tuesday Contractor installed 30” RCP from Curb Inlet 201 to 3901 Sta 13+56.19 to 12+13.72 Sheet 8 of 103 View High Parkway. Curb Inlet base 3901 was set.
Misc
Informational
04/21/2021
3/9/21 Tuesday Contractor ( Darron crew - Clarkston ) installed RCP from newly installed Curb Inlet 201 to 202. Olsson lab did compaction test for street crossing of storm pipe. See pg 8 of 103.
Misc
Informational
04/21/2021
3/9/21 Tuesday Contractor ( Darron crew - Clarkston ) poured invert and
Misc
Informational
04/21/2021
3/10/21 Wednesday Correction - contractor installed storm line from Curb Inlet 102 to 201 on 3/9/21 Tuesday. See sheet 8 of 103. Contractor installing 24” corrugated storm pipe from Curb Inlet 202
Misc
Informational
04/21/2021
3/10/21 Wednesday Contractor installed 24” corrugated storm pipe from Curb Inlet 203 to 4’ Dia Manhole 204. Contractor poured inverts and collars on installed structure.
Misc
Informational
04/21/2021
4/2/21 Friday Contractor GBA resurveyed structure 103 for Toe-wall installation by Clarkson. Wall construction will begin next week.
Misc
Informational
04/21/2021
4/15/21 Thursday Contractor (Clarkson - Bridge crew) poured toe-wall floor on Storm line 100 4/14/21 Wednesday and today (Clarkson - Gregg crew) installed the rest of the storm line 100 to the formed frame of the toe-wall.
Misc
Informational
04/21/2021
Contractor Clarkson bridge crew pour the form around the end of storm outlet for Line 100. Picture will be taken after forms have been removed to verify visual inspection.
Misc
Informational
04/22/2021
4/22/21 Thursday Contractor (Clarkson Bridge crew) pull form off the storm outlet Line 100 that is part of the toe-wall. 8/16/21 Monday (Clarkson - Darron crew) Contractor working on curb inlet that need be adjusted to match curbs and through to be poured tomorrow 8/17/21 Tuesday.
Storm Sewer Construction Inspection Partial 05/07/2021
Misc
Informational
05/07/2021
4/12/21 Monday Contractor (Clarkson - Gregg crew) backfilled and placed gravel on curb inlets along View High Parkway. 05/07/21 Friday Contractor (Clarkson - Gregg crew) set the top of 7’X4’ curb inlet 1202 (existing). Contractor plans to install 100’ of 24” RCP pipe from structure 1202 to 3301 Manhole. Approximately 80’ of 24” RCP from 3301 towards future structure to be installed 3302 (8’X5’ cub inlet). Contractor also plans to pour collars and invert @ Structure 3301. 5/17/21 Thursday Contractor (Clarkson - Gregg crew) installed storm pipe and structures on Line 600 from structure 603 to 605 inverts and collars have been poured. See PRSUB202202246 for additional information.
Storm Sewer Construction Inspection Partial 07/12/2021
Misc
Informational
07/12/2021
4/12/21 Monday Contractor (Clarkson - Gregg crew) backfilled and placed gravel on curb inlets along View High Parkway. 05/07/21 Friday Contractor (Clarkson - Gregg crew) set the top of 7’X4’ curb inlet 1202 (existing). Contractor plans to install 100’ of 24” RCP pipe from structure 1202 to 3301 Manhole. Approximately 80’ of 24” RCP from 3301 towards future structure to be installed 3302 (8’X5’ cub inlet). Contractor also plans to pour collars and invert @ Structure 3301. 5/17/21 Thursday Contractor (Clarkson - Gregg crew) installed storm pipe and structures on Line 600 from structure 603 to 605 inverts and collars have been poured. See PRSUB202202246 for additional information. 7/12/21 Monday Gregg Crew Clarkson Const. Contractor begin installation of 4” underdrains Round-About , Curb &, Island drains last week. Inner and Outer 4” drains were installed today as-per plan. (See page 12 of 103 for details of 4” drains) Curb and Island was installed last week. 4” pipe Drains tie-in to Storm Inlet 2602 View High Drive & 203 View High Pkwy. 7/13/21 Tuesday (Clarkson Gregg’s Crew) Continued installation of 4” drain on View High Drive & Pkwy. 7/14/21 Wednesday (Clarkson Gregg’s Crew) Continued installation of 4”drains on the Northside of View High Pkwy. ( See page 13 of 103 ) 4 LF of 4” PE underdrains and in which Curb Inlets they are connected as-per project plans. 7/19/21 Monday (Clarkson Gregg’s Crew) Installed 18”FES # 600 Installed approximately 118’ 0f 18” rep from inlet 600 to 601 Installed approximately 35’ of 18” RCP from inlet 601 to 602 Installed inlet 601(6’x3’) & installed 602 (5’x4’) and poured 5yds of concrete for collars and inverts. 7/20/21 Tuesday (Clarkson Gregg’s Crew) Installed 150’ of 15” HDPE from 602 to 603 on storm line on River Road. Contractor installed approximately 540’ of 4” under drain along View High Parkway. 7/21/21 Wednesday (Clarkson Gregg’s Crew) Contractor poured collars & inverts on storm inlets 600’s, 900’s & 3303 that were not completed. Contractor continued to install under/edge drains along View High Pkwy. 8/3/21 Tuesday On Thursday 7/29/21 Nyloplast 2204 A & B were installed. Contractor installed Nyloplast 2205 A & B, 2201 A & B and approximately 173’ of 15” corrugated storm pipe 8/2/21. Nyloplast 2202 A & B, 1901 A & B was installed today . Continued installation of storm pipe on line 1700, Nyloplast 1701 was set with approximately 50’ of 15” storm pipe. 8/17/21 Tuesday (Clarkson - Darron crew) Contractor worked on adjust 13 storm curb inlet View High Pkwy (CI) to proper height for curbs & inlet throughs 8/16/17. Contractor began installation of underdrains on 8/16/21 & poured collars on underdrains continued 8/17/21 River Road see project plans. 323’ of underdrains from inlet 3302 up to 90 deg turn at the roundabout on River Road 8/12/21 Thursday.
Pavement-Stabilized Subgrade Partial 07/13/2021
Misc
Informational
07/13/2021
7/13/21 Tuesday (Clarkson Chris Noyes Project Superintendent) Contractor for the road construction installed Geogrid on View High Drive as part of the subgrade stabilization process. 7/14/21 Wednesday (Clarkson - Carlson Chris Street Crew) Contractor continued installing Geogrid on the View High Drive round-about & Southside (Eastbound Lane) of View High Pkwy. 7/15/21 Thursday (Clarkson - Carlson Chris Street Crew) Contractor continued installing Geogrid down View High Pkwy (East & Westbound Lanes). Contractor applied 6” of rock (Dense Compacted Aggregate) over Geogrid. 7/20/21 Tuesday Continued installation of Geogrid on View High Pkwy as per project plans. 7/21/21 Wednesday Clarkson Gregg Crew continued installing underdrains on View High Pkwy. (Side note: I wittiness electrical contractor crossing road on View High Pkwy. I talked with Kevin of Fogel-Anderson about the width bucket, depth and aggregate that was used as backfilled. He informed me that at least one of the excavation as done with flow-able fill. The back hoe bucket was change to meet the specifications. So, as-per Casey Williams Project Manager & Kevin Project Manager Assistant they approve Westhues Electric . Jamie Ryan of Westhues Electric talked with about his subcontractors work and he said they got a bigger (24”) bucket today so, they could use aggregate in their excavation and he was given these direction by Fogel-Anderson.) 7/26/21 Monday (Clarkson Greg Crew) Contractor was installing View High Pkwy Geogrid & aggregate on View High Pkwy. 7/28/21 Wednesday Contractor is work on adding aggregate over Geogrid on View High Drive & Pkwy to install curbs. 7/29/21 Thursday (Clarkson Street Crew - Chris Noyes Project Superintendent) Contractor continued to prepare streets for curb and asphalt pavement. Grading aggregate to its proper level on the streets. 7/30/21 Friday (Clarkson Street Crew - Chris Noyes Project Superintendent) Contractor continued to prepare streets for curb and asphalt pavement. Grading aggregate to its proper level on the streets. Curb installation is schedule for Monday starting at 4:00AM. 8/18/21 Wednesday (Clarkson - Gregg crew) Contractor continued installing Geogrid on project along River Road. 8/20/21 Friday Contractor 8/19/21 completed the installation of Geogrid on River Road also installation rural 5 for covering as per plan. Contractor continued to install covering of Geogrid for subgrade stabilization for roads to be installed. 8/23/21 Monday Contractor continued to install cover over Geogrid on River Road, third party inspection Olsson said compaction numbers were within tolerances .
Curb - Proof Roll Partial 07/28/2021
Misc
Informational
07/28/2021
Proof roll of View High Drive & 3/4 of Pkwy were approved by third party inspection Olsson.
Pavement-Proof Roll Partial 07/28/2021
Misc
Informational
07/28/2021
Proof roll of View High Drive & 3/4 of Pkwy were approved by third party inspection Olsson.
Public Curb Inspection Partial 08/02/2021
Misc
Informational
08/02/2021
8/17/21 Tuesday (J D Bishop Const. Concrete) Contractor poured the throughs of curb inlets (CI). 8/18/21 Wednesday (J D Bishop Const. Concrete) Contractor poured curbs on View High Drive & View High Parkway approximately 220 yards of concrete. 8/19/21 Thursday (J D Bishop Const. Concrete) Contractor continued pouring curbs on View Drive & View High Parkway. Check with Olsson third party inspection sample have met specification qualifications. 8/20/21 Friday (J D Bishop Const. Concrete) Contractor finished pouring the through of storm inlets on View High Drive & View High Parkway. Completed pavement of road end just before River Road. 8/23/21 Monday (Clarkson Gregg crew) Contractor had to remove curbs on View High Drive from inside island. Project changes were made and island was not to be installed but used as part of the road. 8/26/21 Thursday (J D Bishop Const. Concrete) Contractor install approximately 40yards of concrete closing islands on View High Dr. & Pkwy. 9/21/21 Tuesday (J D Bishop Const. Concrete) Contractor pouring approximately 330yds of concrete curbs and storm through along View High Drive, View High Pkwy, & River Road. 9/23/21 Thursday (J D Bishop Const. Concrete) Contractor is pouring curbs for the island along View High Pkwy and River Road. 9/29/21 Wednesday (J D Bishop Const. Concrete) Contractor is pouring curbs for the island @ View High Dr & View High Pkwy and View High Pkwy & River Road. The contractor poured the base for islands that will be filled with bricks. Approximately 50 yards of concrete will be poured. 10/01/21 Friday (J D Bishop Const. Concrete) Contractor pour curbs @ the around about on River Road @ the East bridge. Curb tongues @ River Road & View High Pkwy. 10/14/21 Thursday (J D Bishop Const. Concrete) Contractor pouring curbs around abutment of West bridge on View High Drive. Approximately 40 yards of concrete will be poured today. 10/21/21 Thursday (J D Bishop Const. Concrete) Contractor pour floor for round-about on View High Pkwy & River Road, the inner curb of the round-bout @ the end of River Road (directly across from East bridge.
Pavement-Surface Partial 08/02/2021
Misc
Informational
08/02/2021
8/2/21 Monday (Praderio Dominic Project Sup. - Concrete crew) Contractor began pouring concrete @ 4:00AM. Olsson (third party testing) was onsite to began testing. Projection for final yardage of concrete poured for today by (Fordcye Concrete Inc.) shall be approximately 1100 to 1200 yards of concrete. Street pavement will resume tomorrow around 7:00AM. Contractor finished concrete paving around 4:00PM. 8/3/21 Tuesday (Praderio Dominic Project Superintendent - Concrete crew) Contractor began pourIng areas that required manual hand roll on View High Drive. Contractor dowel in newly poured concrete to bind concrete to be poured for pavement-surface. 8/4/21 Wednesday (Praderio Dominic Superintendent - Concrete crew) Construction continued preparation installing dowels, making saw cuts, and allowing concrete to properly cure. Contractor will begin pouring concrete at 4:00AM 8/5/21 Thursday. 8/5/21 Thursday Praderio Dominic Superintendent - Concrete crew) Pavement construction began at 4:00AM, equipment malfunction delayed operation. By 5:00AM pavement operations were back on tracks, yardage projection are between 1100 - 1200. 8/10/21 Tuesday Contractor continued preparation to pour concrete on View High Drive & Pkwy, Driving rebar to tie in street pavement. 8/16/21 Monday Contractor continued preparation for curbs to be poured by installing rebar to tie-in curbs. 8/19/21 Thursday (Clarkson Gregg Crew) Contractor has been installing Geogrid and underdrains since yesterday along River Road as per plans . 9/2/21 Thursday (Praderio Dominic Superintendent - Concrete crew) Contractor continued to pour concrete roadway on View High Pkwy & River Rd. They restarted last along these streets. Approximately 100 yards will be poured today and 500 yards tomorrow weather permitting. 9/7/21 Tuesday (Praderio Dominic Superintendent - Concrete crew) Contractor was unable to pour concrete on 9/3/21 Friday due inclement, so work was started today along River Road. Approximately 500 yards should poured today. 9/9/21 Thursday (Praderio Dominic Superintendent - Concrete crew) Contractor poured roundabout on View High Pkwy & River Road. 9/15/21 Wednesday (Praderio Dominic Superintendent - Concrete crew) Contractor continued to pour concrete on the round about @ the South end of River Road. The estimate for road surface construction is 350 yds of concrete on job site. 9/21/21 Tuesday of Thursday Wednesday (Superior Bowen) Contractor pouring the curbs along River Road & View High Pkwy approximately 200 yds of concrete will be poured today.
Storm - Outlet Structure Partial 08/19/2021
Misc
Informational
08/19/2021
8/19/21 Thursday (Clarkson Gregg crew) Began modifications of junction box 707 to area field inlet by cutting to entrance on both side of the inlet. They will add to steep channel flumes for entrance of water into storm system. 9/10/21 Friday (Clarkson Gregg - crew) Contractor had to adjust ( raise) all the storm boxes to the proper height (match street) along River Road. Inspector will ensure storm boxes and storm line is clean and clear at a later date.
Water Line - Coliform Test 1 Passed 08/23/2021
Misc
Informational
08/23/2021
8/23/21 Monday Coliform test passed 8/20/21 Friday
Water Line - Coliform Test 2 Passed 08/23/2021
Misc
Informational
08/23/2021
8/23/21 Monday Coliform test 2 passed on 8/21/21.
Underground Electrical Inspection - Commercial Partial 09/23/2021
Misc
Informational
09/23/2021
9/23/21 Thursday Westhues Electric - Jamie Ryan Electrical conduit for lights were installed from the first Around About on View High Dr. down Veiw High Pkwy & down River Rd See project plans pg. 55 & 56. 9/29/21 Wednesday Westhues Electric - Jamie Ryan Electrical conduit for lights were installed along View High Dr & View High Pkwy. Contractor backfilled excavation for street lights conduit. 9/30/21 Thursday Westhues Electric - Jamie Ryan Continued installation of conduit for street light. 10/04/21 Monday Westhues Electric - Jamie Ryan Continued installation of conduit for street on the North side of View High Pkwy. 10/05/21 Tuesday Westhues Electric - Jamie Ryan Continued installation of conduit on the South side of View High Pkwy & West side of River Road.
Pavement-Stabilized Subgrade Partial 09/27/2021
Misc
Informational
07/13/2021
7/13/21 Tuesday Contractor for the road construction installed Geogrid on View High Drive as part of the subgrade stabilization process.
Misc
Informational
09/27/2021
9/27/21 Monday Superior Bowen Contractor began installation of asphalt 2/3“ and an half inch base as ( recycled APWA Type 1R). Approximately 313 tons asphalt will be used today along View High Drive.
Misc
Informational
12/02/2021
12/02/21 Thursday General note contractors continued to grade subgrade throughout the project. Future road to Soccer fields are being graded, East of River Road and East bridge at the roundabout.
Sidewalk Inspection Partial 09/29/2021
Misc
Informational
09/29/2021
9/29/21 Wednesday (J D Bishop) The walking path that goes around the roundabout poured concrete floor to install for bricks walkway.
Misc
Informational
10/22/2021
10/22/21 Friday ( J D Bishop Concrete Const.) Installing ADA crossing by the West bridge on View High Drive.
Water Line - Construction Inspection Passed 10/29/2021
Misc
Informational
06/30/2020
Contractor began installing 2” blue poly water main from the building to the existing meter. This was place on the wrong permit !
Misc
Informational
06/30/2020
Contractor began installing 2” blue poly water main from the building to the existing meter. SEE inspection above!
Misc
Informational
07/15/2021
7/15/21 Thursday (Clarkson Gregg Crew) Began installing Private water line Line C across View High Pkwy just west of River Road see page 15 of 103. Contractor installed 8” water main C900 PVC approximately 82’ from Sta 0+00 to 0+82. An 8” valve and a 45 deg bend was installed today. 7/28/21 Wednesday Contractor said they received and RFI to complete the rest Line C. A Meter then a Backflow Preventer will be installed approximately between Sta. 1+10 & 1+50. Then continued to 8” DIP water line after Backflow Preventer which is Lees Summit’s water main. 7/29/21 Thursday (Clarkson Gregg Crew) Contractor installed 22.5 degree bend at Sta. 1+60, 1-6” LS FH at Sta. 2+00 , 45 degree bend at Sta. 3+03.30 on private Line C. The Line is 8” DIP locking restraint gasket water pipe. Contractor continues to work on installation of private line 12:00PM. 8/2/21 Monday (Clarkson Gregg Crew) Contractor continued installation of water line on River Road just before Sta. 5+00 (FH). Contractor had installed to approximately Sta. 8+50 @ 2:30PM. Two 45 degree bends were eliminated from around CIs at Sta 3+96 to 4+20 & Sta 5+20 to 5+44 on private line C. FH was installed at Sta. 7+00 and 45 bends were eliminated at Sta. 8+01 to 8+28 around CI, Fogel-Anderson was informed about need changes due to improperly staking that crossed other utilities. Deflection of water line in able early allowed for required clearance. Contractor plans to have concrete come at 3:00PM for tees and bends on water main. Water installation was stopped around Sta. 9+30. 8/3/21 Tuesday (Clarkson Gregg Crew) Contractor continued to install water main 8” from Sta. 9+30 to around 12+70. The contractor stop just short of crossing the street of River Road as-per plan. Contractor pour backing blocks behind tees and bends that were installed today. 8/4/21 Wednesday (Clarkson Gregg Crew) Contractor completed the installation of 8” on River Road Private water line. Changes to project plans will be reflected on as-built. 8/5/21 Thursday (Clarkson Gregg Crew) Water line was not completed 45 degree bends then valve and blow-off assembly straddle blocks will be poured as-per project. All other bend and tee will be poured today. 8/10/21 Tuesday (Clarkson Gregg Crew) Meter Pit & Back flow vaults were installed . Contractor is trying to pressure test Private Line C @ 150 psi. 8/12/21 Thursday Private Line C passed pressure test @160 psi from Backflow Preventer to the end of the line . Contractor found and replace defective slip joint on piping with 2/ 8” sleeve and 3’ Pup all fittings were mega lugged. The proximitie of the Sta. 5+05 adjacent to Fire Hydrant. 8/16/21 Monday Contractor chlorinated Private Line C around 8:30AM. 10/29/21 Friday Contractor with Lee’s Summit Water Dept. was able to locate water main across I- 470.
Sidewalk Inspection Partial 11/03/2021
Misc
Informational
09/29/2021
9/29/21 Wednesday The walking path that goes around the roundabout poured concrete floor to install for bricks walkway. 11/03/21 Wednesday Contractor installed sidewalks along River Road on Monday 11/01/21.
Sidewalk Inspection Partial 11/03/2021
Misc
Informational
11/03/2021
11/03/21 Wednesday Contractor installed pavers on roundabout and medians on View High Drive. 11/11/21 Thursday Contractor completed the paver installation in roundabout & medians along View High Drive from last week and this week. JD Bishop is pouring concrete today for sidewalks along View High Parkway. Contractor will pour approximately 100 yards of concrete today. Temperature are not Project to dip below freezing today, but are for the weekend, contractor has blankets to cover sidewalks on site. 11/12/21 Friday JD Bishop continues to pour sidewalks along View High Parkway. 11/15/21 Monday (BC Hardscapes) BC Hardscapes have been installing the paver in the roundabout, islands and medians. They working at the East Bridge and River Road. 12/01/21 Wednesday JD Bishop Continued to pour sidewalk on View High Drive running toward the Westside bridge. Sidewalk was being poured along View High Parkway & Drive. Additional sidewalk were being poured on View High Parkway past River Road. 12/06/21 Monday JD Bishop Poured sidewalks approximately 60 yards of concrete along River Road up to the roundabout (near the East bridge). Contractor began to cover concrete with blankets. 12/09/21 Thursday JD Bishop Continued pouring sidewalk @ the roundabout on River Road. Also contractor is forming sidewalk along River Road. Approximately 20yds of concrete was poured. 02/16/22 Wednesday JD Bishop Contractor is pouring sidewalks & ADA ramps on the Eastside of River Road across from the East bridge. Approximately 20yds to 25yds will be poured today. ( Curbs for parking lot East of the East Bridge and Roundabout on River Road was installed approximately a month ago.) 04/04/22 Monday JD Bishop Contractor poured sidewalk that was removed due to imperfection in sidewalk. Approximately 60’ of 6’ width sidewalk .
Pavement-Curb Construction Partial 12/16/2021
Misc
Informational
12/16/2021
12/16/21 Thursday (JD Bishop) The curb were done in the parking lot on 12/15/21 Wednesday approximately 4000ft curbs took 220yds concrete. Today contractor will pour circumferences and islands in parking lot area ( South of View High Pkwy & East of River Rd ). 01/24/22 Monday (JD Bishop) Continued pouring curbs for parking lo just East of the East bridge @ the Roundabout on River Road. Last week the curbs were poured and covered with blankets. Finish the islands in parking lots.
Rough Electrical Inspection - Commercial Partial 5/20/2022 05/20/2022
Misc
Informational
05/20/2022
PIERS FOR PEDESTALS FOR STREET LIGHT CONTROLS CONDUIT IN PIER, DRIVEN GROUND ROD IN PLACE (1) @ 3151, (1) @ 3130, (1) @ 1ST ROUNDABOUT/BRIDGE 24 X 36
Site Visit Partial 06/21/2022
Misc
Informational
10/16/2020
Contractor work on site until 12:00AM due to rains. Grading & Ollson continued compaction test.
Misc
Informational
06/21/2022
06/21/22 Tuesday No work on site. Taking pictures of related materials for underground utilities to be installed to verify it is approved materials. Unable to take pictures due to the location either it be remote or interference.
Storm - Outlet Structure Partial 07/20/2022
Misc
Informational
04/22/2021
Clarkston Cons. Poured approximately 10.5 yds of concrete for the Storm Outlet #3 wing walls .
Misc
Informational
04/22/2021
21/34 pg of plan details the construction Upstream Wingwalls that were installed and poured 4/14/20. Pictures of event were taken. Concrete tickets will be collected 4/15/20.
Misc
Informational
04/22/2021
Collected the last concrete ticket for the pour on Upstream Wingwalls and Toe. Contractor continued to form the structure for the vertical walls. Vertical Forms may be ready to pour on Friday 4/17/20.
Misc
Informational
04/22/2021
Contractor poured 13.5yd of concrete to complete the Upstream inner and outer Wingwalls.Ticket were collected from the pour.
Misc
Informational
04/22/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
04/22/2021
Contractor moved back to Downstream Toe Wall to finish pour that was stop due to shut down of project in 2019. Approximately 15.5 yd of concrete will be use to complete toe wall.
Misc
Informational
04/22/2021
Contractor installed steel pylons on the outflow structure on line 300 to continue to complete Wing wall & Toe wall support.
Misc
Informational
04/22/2021
12/22/20 Monday 8:40AM Contractor ramping to start construction on Line 700. The survey crew to stake the line is delayed, so progress will be slow today.
Misc
Informational
04/22/2021
12/21/20 Monday 2:10PM Contractor (Clarkston Const.) continues to excavate and prepare for the installation of storm line 700.
Misc
Informational
04/22/2021
12/22/20 Tuesday 4:20PM Contractor (Clarkston Const.) continued to work on storm Line 700 60” RCP. Pipe will be installed from 0+25 to 0+75 Junction Box.
Misc
Informational
04/22/2021
12/23/20 Wednesday 12:20PM Contractor Continued to install Mid section of storm Junction Box 700. Work on the storm line will restart at the beginning of next year.
Misc
Informational
04/22/2021
1/5/21 Tuesday 1:00PM Contractor installed approximately 70’ of storm pipe from (installed 12/22/20) 4’x8’ Junction Box 701 to (installed 1/5/21) 4’x8’ Curb Inlet 702. Concrete collars were poured for junction box 701.
Misc
Informational
04/22/2021
1/6/21 Wednesday 10:30AM Contractor installed approximately 35’ of storm pipe and 9’x4’ Storm Inlet 703. Contractor had to cease work due to rainfall. Contractor will try to continue later in the week.
Misc
Informational
04/22/2021
1/7/21 Thursday 3:10PM Contractor (Clarkston Greg crew) installed approximately 55’ from 703 to 10’x5’ Inside (non setback)Storm Inlet 704. Concrete collars will be poured tomorrow. Contractor will send picture do to the very muddy condition of site from the week.
Misc
Informational
04/22/2021
1/8/21 Friday 3:30PM Contractor poured collars @ 702,703, & 704. Stacks were installed on structure and backfilling will be done 1/11/21 Monday.
Misc
Informational
04/22/2021
1/11/21 Monday Storm Line #1 contractor installed approximately 32’ of 48” RCP from the Little Blue River side.
Misc
Informational
04/22/2021
11/12/21 Tuesday Storm Line #1 or 100 stakes were not set properly, survey crew will come out and retake storm line if necessary. Contractor (Clarkston Greg) crew will move bacK to Storm Line 700.
Misc
Informational
04/22/2021
1/12/21 Tuesday Contractor moved back to working on Storm Line 700 and installed piping as-per plans.
Misc
Informational
04/22/2021
1/13/21 Wednesday Contractor moved back to Storm Line 100. Surveyor came out and reviewed the stakes errantly placed. It was sent back to the Engineers who approved the location of the already installed piping & structure of Line 100. Approximately 58’ of pipe and 7’X4’ 102 curb inlet was installed. A collar was poured on structure 101 and 102 will be partially poured at 2:00PM.
Misc
Informational
04/22/2021
1/14/21 Thursday Contractor moved back to Storm Line 700 and continued to install 60” RCP approximately 520’. Once I receive the project plans and number for Soccer Complex Storm Sewer Inspector will transfer daily progress).
Misc
Informational
04/22/2021
2/5/21 Friday Contractor moved back to Storm Line 100 and completed installation except for the last 12’ of were the retain wall is to be installed. Collar was poured on structure 102.
Misc
Informational
04/22/2021
3/9/21 Tuesday Contractor installed 30” RCP from Curb Inlet 201 to 3901 Sta 13+56.19 to 12+13.72 Sheet 8 of 103 View High Parkway. Curb Inlet base 3901 was set.
Misc
Informational
04/22/2021
3/9/21 Tuesday Contractor ( Darron crew - Clarkston ) installed RCP from newly installed Curb Inlet 201 to 202. Olsson lab did compaction test for street crossing of storm pipe. See pg 8 of 103.
Misc
Informational
04/22/2021
3/9/21 Tuesday Contractor ( Darron crew - Clarkston ) poured invert and
Misc
Informational
04/22/2021
3/10/21 Wednesday Correction - contractor installed storm line from Curb Inlet 102 to 201 on 3/9/21 Tuesday. See sheet 8 of 103. Contractor installing 24” corrugated storm pipe from Curb Inlet 202
Misc
Informational
04/22/2021
3/10/21 Wednesday Contractor installed 24” corrugated storm pipe from Curb Inlet 203 to 4’ Dia Manhole 204. Contractor poured inverts and collars on installed structure.
Misc
Informational
04/22/2021
4/2/21 Friday Contractor GBA resurveyed structure 103 for Toe-wall installation by Clarkson. Wall construction will begin next week.
Misc
Informational
04/22/2021
4/15/21 Thursday Contractor (Clarkson - Bridge crew) poured toe-wall floor on Storm line 100 4/14/21 Wednesday and today (Clarkson - Gregg crew) installed the rest of the storm line 100 to the formed frame of the toe-wall.
Misc
Informational
04/22/2021
Contractor Clarkson bridge crew pour the form around the end of storm outlet for Line 100. Picture will be taken after forms have been removed to verify visual inspection.
Misc
Informational
04/22/2021
4/22/21 Thursday Contractor (Clarkson Bridge crew) pull form off the storm outlet Line 100 that is part of the toe-wall.
Misc
Informational
07/20/2022
07/20/22 Wednesday JMJ ( Clarkson - Darron ) Bob & Matt inspected storm outlet structure that need to grouted inside lip of the curb inlets, cracks to lids and clean up debris in curb inlets. I related this information to Clarkson supervisor Darron. He will let me know when his crew arrives to complete the work.
Pavement-Proof Roll Passed 08/23/2022
Misc
Informational
07/28/2021
Proof roll of View High Drive & 3/4 of Pkwy were approved by third party inspection Olsson.
Misc
Informational
08/23/2022
08/23/22 Tuesday JMJ ( Thorne & Son Asphalt ) Parking lots 1& 2 passed proof roll inspection, Olsson was the third party inspector.
Pavement-Aggregate Base Partial 08/24/2022
Misc
Informational
03/11/2021
08/24/22 Wednesday JMJ ( Thorne & Son Construction ) Contractor laying type 5R APWA on the small parking lot East of NW River Rd & NW Paragon Pkwy. Third party inspector is Olsson which will performed the required test.
Pavement-Aggregate Base Partial 08/24/2022
Misc
Informational
08/24/2022
08/24/22 Wednesday JMJ ( Thorne & Son Construction ) Contractor laying type 5R APWA on the small parking lot East of NW River Rd & NW Paragon Pkwy. Third party inspector is Olsson which will performed the required test. ( Newland Paving Co. ) are the actual sub-contractor completing the work.
Pavement-Aggregate Base Partial 08/25/2022
Misc
Informational
08/24/2022
08/24/22 Wednesday JMJ ( Thorne & Son Construction ) Contractor laying type 5R APWA on the small parking lot East of NW River Rd & NW Paragon Pkwy. Third party inspector is Olsson which will performed the required test. ( Newland Paving Co. ) are the actual sub-contractor completing the work. 08/25/22 Thursday JMJ ( Newland Paving Co. ) Contractor began laying type 5R APWA on parking lot East of NW River Rd & South of NW View High Drive.
Pavement-Aggregate Base Partial 09/01/2022
Misc
Informational
08/25/2022
08/24/22 Wednesday JMJ ( Thorne & Son Construction ) Contractor laying type 5R APWA on the small parking lot East of NW River Rd & NW Paragon Pkwy. Third party inspector is Olsson which will performed the required test. ( Newland Paving Co. ) are the actual sub-contractor completing the work. 08/25/22 Thursday JMJ ( Newland Paving Co. ) Contractor began laying type 5R APWA on parking lot East of NW River Rd & South of NW View High Pkwy. 09/01/22 Thursday JMJ ( Newland Paving Co. ) Contractor restarted laying 5R APWA on parking on 08/31/22 Wednesday. Contractor continued working installation of parking of NW River & South NW View High Pkwy.
Pavement-Surface Partial 09/01/2022
Misc
Informational
09/01/2022
09/01/22 Thursday JMJ ( Newland Pavement Co. ) The small parking lot East of River Rd & Paragon Pkwy placing Tack on lot before surface asphalt was laid.
Pavement-Surface Partial 09/02/2022
Misc
Informational
09/01/2022
8/2/21 Monday (Praderio Dominic Project Sup. - Concrete crew) Contractor began pouring concrete @ 4:00AM. Olsson (third party testing) was onsite to began testing. Projection for final yardage of concrete poured for today by (Fordcye Concrete Inc.) shall be approximately 1100 to 1200 yards of concrete. Street pavement will resume tomorrow around 7:00AM. Contractor finished concrete paving around 4:00PM. 8/3/21 Tuesday (Praderio Dominic Project Superintendent - Concrete crew) Contractor began pourIng areas that required manual hand roll on View High Drive. Contractor dowel in newly poured concrete to bind concrete to be poured for pavement-surface. 8/4/21 Wednesday (Praderio Dominic Superintendent - Concrete crew) Construction continued preparation installing dowels, making saw cuts, and allowing concrete to properly cure. Contractor will begin pouring concrete at 4:00AM 8/5/21 Thursday. 8/5/21 Thursday Praderio Dominic Superintendent - Concrete crew) Pavement construction began at 4:00AM, equipment malfunction delayed operation. By 5:00AM pavement operations were back on tracks, yardage projection are between 1100 - 1200. 8/10/21 Tuesday Contractor continued preparation to pour concrete on View High Drive & Pkwy, Driving rebar to tie in street pavement. 8/16/21 Monday Contractor continued preparation for curbs to be poured by installing rebar to tie-in curbs. 8/19/21 Thursday (Clarkson Gregg Crew) Contractor has been installing Geogrid and underdrains since yesterday along River Road as per plans . 9/2/21 Thursday (Praderio Dominic Superintendent - Concrete crew) Contractor continued to pour concrete roadway on View High Pkwy & River Rd. They restarted last along these streets. Approximately 100 yards will be poured today and 500 yards tomorrow weather permitting. 9/7/21 Tuesday (Praderio Dominic Superintendent - Concrete crew) Contractor was unable to pour concrete on 9/3/21 Friday due inclement, so work was started today along River Road. Approximately 500 yards should poured today. 9/9/21 Thursday (Praderio Dominic Superintendent - Concrete crew) Contractor poured roundabout on View High Pkwy & River Road. 9/15/21 Wednesday (Praderio Dominic Superintendent - Concrete crew) Contractor continued to pour concrete on the round about @ the South end of River Road. The estimate for road surface construction is 350 yds of concrete on job site. 9/21/21 Tuesday of Thursday Wednesday (Superior Bowen) Contractor pouring the curbs along River Road & View High Pkwy approximately 200 yds of concrete will be poured today.
Misc
Informational
09/02/2022
09/02/22 Friday JMJ ( Newland Pavement ) Contractor began to lay asphalt type 5 Virgin APWA, East River Road & Paragon Pkwy ( small parking lot ).
Miscellaneous PWORKS Inspection Passed 10/07/2022
Misc
Informational
10/22/2021
10/07/22 Friday JMJ ( JD Bishop ) Contractor grouted manhole back face of throat, any clearing spaces for lid & storm box, and patch manhole covers that have cracks. Meeting with Chance Hollingsworth of Clarkson Construction.
Record Drawing Review Passed 10/13/2022 10/14/2022
Misc
Informational
05/20/2022
PIERS FOR PEDESTALS FOR STREET LIGHT CONTROLS CONDUIT IN PIER, DRIVEN GROUND ROD IN PLACE (1) @ 3151, (1) @ 3130, (1) @ 1ST ROUNDABOUT/BRIDGE 24 X 36
Misc
Informational
10/14/2022
10/14/22 Friday JMJ Record Drawing are approved by inspector .
Water Line - Construction Inspection Partial 3/2/2023 3/2/2023 03/02/2023
Misc
Informational
06/30/2020
Contractor began installing 2” blue poly water main from the building to the existing meter.
Misc
Informational
06/30/2020
Contractor began installing 2” blue poly water main from the building to the existing meter.
Misc
Informational
03/02/2023
03/02/23 Thursday JMJ ( Clarkson Construction CO. Greg Crew ) Contractor has re-installed approximately 60' of 12" PVC water pipe with 2/12" Sleeve with mega lugs. Pipe was swab and will be blown off for approximately 2 hours. 1 bacterial sample will be taken. Water main was removed to install Blue Valley 16" ductile sanitary main to property.
Final Completion - Field Engineering Final Completion 03/13/2025
Misc
Informational
03/13/2025
3-13-25 RH. All work is completed and passed. Good for final completion.
Documents & Images
Date Uploaded File Type Document Name
10/29/2018 Letter DE-Permit
03/27/2019 Letter DE-Daily Inspection Summary
03/27/2019 Letter DE-Daily Inspection Summary
03/27/2019 Letter DE-Daily Inspection Summary
03/27/2019 19 (1)
03/27/2019 Letter DE-Daily Inspection Summary
04/01/2019 Letter INSPECTION SUMMARY
04/02/2019 IMG Paragon Star 4/1/19 (1) L 300
04/02/2019 IMG Paragon Star 4/1/19 (2) L 300
04/02/2019 Letter DE-Daily Inspection Summary
04/02/2019 Letter DE-Daily Inspection Summary
04/05/2019 Letter DE-Site Visit Inspection
04/05/2019 IMG_0118
04/05/2019 IMG_0126
04/10/2019 Letter DE-Daily Inspection Summary
04/10/2019 Letter DE-Daily Inspection Summary
04/10/2019 IMG_0173 Embankment Matting
04/10/2019 IMG_0174 Embankment Matting
04/10/2019 Letter DE-Site Visit Inspection
04/11/2019 Letter DE-Daily Inspection Summary
04/11/2019 Letter DE-Daily Inspection Summary
10/23/2018 Receipt Receipt for transaction: 2018-006959
04/12/2019 image1
04/16/2019 Letter DE-Daily Inspection Summary
04/16/2019 IMG_0221 KC 24"Sanitary Main
04/12/2019 Letter INSPECTION SUMMARY
04/12/2019 image0
04/10/2019 IMG_0148 Silt fencing down
04/10/2019 Letter INSPECTION SUMMARY
04/10/2019 Letter DE-Daily Inspection Summary
04/10/2019 Letter DE-Daily Inspection Summary
04/08/2019 Letter DE-Daily Inspection Summary
04/03/2019 Letter DE-Daily Inspection Summary
04/04/2019 Letter Stop Work Order
04/04/2019 Letter DE-Site Visit Inspection
04/04/2019 IMG_PS 4/4/19 Bridge Removal ? Unauthorized
04/04/2019 Letter DE-Daily Inspection Summary
04/04/2019 IMG_PS 4/3/19 Line 500
04/04/2019 Letter DE-Daily Inspection Summary
04/03/2019 IMG_Paragon Star 4/2/19 Line 300 Limit stake offset
04/03/2019 IMG_ Paragon Star 4/2/19 Line 300 backfill
03/29/2019 IMG Pargaon Star Line 300 (3)
03/29/2019 IMG Paragon Star Line 300 (2)
03/29/2019 IMG Paragon Star Line 300 (1)
04/12/2019 image2
04/11/2019 Photograph image
04/11/2019 2019.4.11 29 Erosion Control-Phase 3 Rev 1
04/16/2019 IMG_0222 Concrete Encased 24" Sanitary Main
04/16/2019 Letter DE-Daily Inspection Summary
04/16/2019 Letter DE-Daily Inspection Summary
04/16/2019 Letter Stop Work Order
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter DE-Daily Inspection Summary
04/16/2019 Letter DE-Daily Inspection Summary
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter DE-Daily Inspection Summary
04/16/2019 Letter DE-Daily Inspection Summary
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
04/17/2019 12720C4050-29 Erosion Control
04/16/2019 Letter INSPECTION SUMMARY
04/25/2019 IMG_0237 Monday Line 300 Toe Wall Construction
04/25/2019 IMG_0254 Tuesday Line 300 Toe Wall Construction
04/25/2019 IMG_0256 Wednesday Line 300 Toe Wall Constructiion
04/26/2019 Letter DE-Daily Inspection Summary
05/24/2019 Letter DE-Daily Inspection Summary
07/08/2019 Letter DE-Daily Inspection Summary
07/09/2019 Letter INSPECTION SUMMARY
07/09/2019 Letter INSPECTION SUMMARY
03/25/2020 Letter INSPECTION SUMMARY
03/25/2020 Letter INSPECTION SUMMARY
03/25/2020 Letter INSPECTION SUMMARY
03/25/2020 Letter INSPECTION SUMMARY
03/25/2020 Letter DE-Daily Inspection Summary
03/25/2020 Letter INSPECTION SUMMARY
03/25/2020 Letter DE-Daily Inspection Summary
03/25/2020 Letter INSPECTION SUMMARY
03/25/2020 Letter Stop Work Order
03/26/2020 Letter INSPECTION SUMMARY
04/06/2020 Receipt Receipt for transaction:2020-001407
04/08/2020 Letter DE-Daily Inspection Summary
04/09/2020 Receipt Receipt for transaction:2020-001479
04/10/2020 Approved Plans Approved set Paragon Star Mass Grading Plans 4.10.20
04/15/2020 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
04/20/2020 Letter INSPECTION SUMMARY
04/21/2020 Letter INSPECTION SUMMARY
04/21/2020 Letter INSPECTION SUMMARY
04/21/2020 Letter INSPECTION SUMMARY
04/21/2020 Letter INSPECTION SUMMARY
04/21/2020 Letter INSPECTION SUMMARY
04/23/2020 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
04/28/2020 Letter INSPECTION SUMMARY
04/29/2020 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter DE-Daily Inspection Summary
05/07/2020 Letter INSPECTION SUMMARY
05/19/2020 Letter INSPECTION SUMMARY
05/19/2020 Letter INSPECTION SUMMARY
05/19/2020 Letter INSPECTION SUMMARY
04/16/2019 Letter DE-Daily Inspection Summary
05/22/2020 Letter INSPECTION SUMMARY
05/22/2020 Letter INSPECTION SUMMARY
05/28/2020 Letter INSPECTION SUMMARY
05/28/2020 Letter INSPECTION SUMMARY
06/09/2020 Letter INSPECTION SUMMARY
06/09/2020 Letter INSPECTION SUMMARY
04/16/2019 Letter DE-Daily Inspection Summary
06/30/2020 Photograph image fire lines & domestic water 1.jpg
06/30/2020 Photograph image fire lines & domestic water 2.jpg
06/30/2020 Letter INSPECTION SUMMARY
06/30/2020 Letter INSPECTION SUMMARY
06/30/2020 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter DE-Daily Inspection Summary
07/13/2020 Photograph image.jpg
07/13/2020 Letter INSPECTION SUMMARY
07/22/2020 Letter INSPECTION SUMMARY
07/23/2020 Letter INSPECTION SUMMARY
07/28/2020 Letter INSPECTION SUMMARY
08/03/2020 Letter INSPECTION SUMMARY
08/03/2020 Letter INSPECTION SUMMARY
09/23/2020 Photograph image.jpg0
09/23/2020 Letter INSPECTION SUMMARY
09/23/2020 Letter INSPECTION SUMMARY
09/24/2020 Photograph image.jpg1
09/24/2020 Photograph image.jpg2
09/24/2020 Photograph image.jpg3
09/24/2020 Photograph image.jpg4
09/24/2020 Photograph image.jpg5
04/16/2019 Letter Stop Work Order
04/16/2019 Letter INSPECTION SUMMARY
09/25/2020 Photograph image.jpg6
09/25/2020 image.jpg7
09/25/2020 Letter INSPECTION SUMMARY
04/16/2019 Letter Stop Work Order
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter Stop Work Order
04/16/2019 Letter DE-Site Visit Inspection
04/16/2019 Letter DE-Site Visit Inspection
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
09/30/2020 Letter INSPECTION SUMMARY
10/01/2020 Letter INSPECTION SUMMARY
10/02/2020 Letter INSPECTION SUMMARY
10/09/2020 Receipt Receipt for transaction:2020-006853
10/12/2020 Photograph image.jpg
10/12/2020 Photograph image.jpg0
10/12/2020 Photograph image.jpg1
10/12/2020 Photograph image.jpg2
10/12/2020 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
10/14/2020 Photograph image.jpg3
10/14/2020 Photograph image.jpg4
10/14/2020 Letter INSPECTION SUMMARY
10/14/2020 Letter DE-Permit
10/15/2020 Letter INSPECTION SUMMARY
10/15/2020 Letter INSPECTION SUMMARY
10/15/2020 Letter INSPECTION SUMMARY
10/16/2020 Approved Plans Paragon Star Public Street and Storm Sewer Plans Approved 10.16.20
10/16/2020 Photograph image.jpg5
10/16/2020 Photograph image.jpg6
10/16/2020 Letter INSPECTION SUMMARY
10/16/2020 Photograph image.jpg7
10/16/2020 image.jpg8
10/16/2020 Letter INSPECTION SUMMARY
10/17/2020 image.jpg9
10/17/2020 Photograph image.jpg10
10/17/2020 Letter INSPECTION SUMMARY
10/19/2020 Letter INSPECTION SUMMARY
10/19/2020 Letter INSPECTION SUMMARY
10/21/2020 Letter INSPECTION SUMMARY
10/21/2020 Letter INSPECTION SUMMARY
10/22/2020 Letter INSPECTION SUMMARY
11/18/2020 Letter INSPECTION SUMMARY
11/18/2020 Letter INSPECTION SUMMARY
11/19/2020 Letter INSPECTION SUMMARY
11/20/2020 Letter INSPECTION SUMMARY
11/20/2020 Letter INSPECTION SUMMARY
12/14/2020 Letter INSPECTION SUMMARY
12/14/2020 Letter INSPECTION SUMMARY
04/16/2019 Letter DE-Site Visit Inspection
04/18/2019 Letter DE-Daily Inspection Summary
09/24/2020 Letter INSPECTION SUMMARY
12/21/2020 Letter INSPECTION SUMMARY
09/24/2020 Letter INSPECTION SUMMARY
09/28/2020 Letter INSPECTION SUMMARY
12/23/2020 Letter INSPECTION SUMMARY
01/05/2021 Letter INSPECTION SUMMARY
01/06/2021 Letter INSPECTION SUMMARY
01/07/2021 Letter INSPECTION SUMMARY
01/07/2021 Letter INSPECTION SUMMARY
01/08/2021 Letter INSPECTION SUMMARY
01/08/2021 Letter INSPECTION SUMMARY
01/11/2021 Letter INSPECTION SUMMARY
01/12/2021 Letter INSPECTION SUMMARY
01/12/2021 Photograph image.jpg12
01/12/2021 Photograph image.jpg13
01/12/2021 Letter INSPECTION SUMMARY
01/13/2021 Photograph image.jpg14
01/13/2021 Photograph image.jpg15
01/13/2021 Photograph image.jpg16
01/13/2021 Photograph image.jpg17
01/13/2021 Photograph image.jpg18
01/13/2021 Letter INSPECTION SUMMARY
01/13/2021 Letter INSPECTION SUMMARY
01/14/2021 Photograph image.jpg19
01/14/2021 Photograph image.jpg20
01/14/2021 Letter INSPECTION SUMMARY
01/14/2021 Letter INSPECTION SUMMARY
02/05/2021 Letter INSPECTION SUMMARY
03/09/2021 Letter INSPECTION SUMMARY
03/09/2021 Photograph image.jpg21
03/09/2021 Photograph image.jpg22
03/09/2021 Letter INSPECTION SUMMARY
09/28/2020 image.jpg8
03/10/2021 Photograph image.jpg23
03/10/2021 Letter INSPECTION SUMMARY
03/11/2021 Letter INSPECTION SUMMARY
03/15/2021 Plans RFI 11 View High Dr Transition Approved
03/30/2021 Letter INSPECTION SUMMARY
03/31/2021 Letter INSPECTION SUMMARY
04/02/2021 Photograph image.jpg24
04/02/2021 Letter INSPECTION SUMMARY
09/28/2020 image.jpg9
04/15/2021 image.jpg25.jpg
04/15/2021 Photograph image.jpg26
04/15/2021 Letter INSPECTION SUMMARY
04/15/2021 Letter INSPECTION SUMMARY
04/21/2021 Letter INSPECTION SUMMARY
04/21/2021 Letter INSPECTION SUMMARY
09/29/2020 Photograph image.jpg10
09/29/2020 Photograph image.jpg11
05/07/2021 Letter INSPECTION SUMMARY
05/07/2021 Letter INSPECTION SUMMARY
07/12/2021 Letter INSPECTION SUMMARY
07/12/2021 Photograph image.jpg28
07/12/2021 Letter INSPECTION SUMMARY
07/13/2021 64789279217__51D99510-279E-499A-9F53-4AD157137EF5.MOV
07/13/2021 Letter INSPECTION SUMMARY
07/13/2021 Letter INSPECTION SUMMARY
07/14/2021 Photograph image.jpg29
07/14/2021 Photograph image.jpg30
07/14/2021 Photograph image.jpg31
07/15/2021 Photograph image.jpg32
07/15/2021 Photograph image.jpg33
07/28/2021 Letter INSPECTION SUMMARY
07/28/2021 Letter INSPECTION SUMMARY
08/02/2021 Photograph image.jpg34
08/02/2021 Letter INSPECTION SUMMARY
08/02/2021 Letter INSPECTION SUMMARY
09/29/2020 Letter INSPECTION SUMMARY
09/29/2020 Letter INSPECTION SUMMARY
08/02/2021 Photograph image.jpg37
08/02/2021 Photograph image.jpg38
08/02/2021 Letter INSPECTION SUMMARY
08/02/2021 Letter INSPECTION SUMMARY
08/03/2021 Photograph image.jpg39
08/03/2021 Photograph image.jpg40
08/03/2021 Photograph image.jpg41
08/03/2021 Photograph image.jpg42
08/03/2021 Photograph image.jpg43
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
08/03/2021 Photograph image.jpg46
08/05/2021 Photograph image.jpg47
08/05/2021 Photograph image.jpg48
08/05/2021 Photograph image.jpg49
08/05/2021 Photograph image.jpg50
08/05/2021 Photograph image.jpg51
08/05/2021 Photograph image.jpg52
08/05/2021 Photograph image.jpg53
08/05/2021 Photograph image.jpg54
08/05/2021 Photograph image.jpg55
08/05/2021 Photograph image.jpg56
08/05/2021 Photograph image.jpg57
08/05/2021 64988805624__AFD68063-959A-4895-8781-3F8CF1CA0A01.MOV
08/16/2021 Letter INSPECTION SUMMARY
08/17/2021 image.jpg58
08/17/2021 Photograph image.jpg59
08/17/2021 Photograph image.jpg60
08/17/2021 Photograph image.jpg61
08/19/2021 Letter INSPECTION SUMMARY
08/23/2021 Letter INSPECTION SUMMARY
08/23/2021 Letter INSPECTION SUMMARY
08/23/2021 Letter INSPECTION SUMMARY
08/25/2021 WO#1EH1712 - 1st Water sample
08/25/2021 WO#1EH1869 - 2nd Water sample
09/02/2021 Photograph image.jpg62
09/02/2021 Photograph image.jpg63
09/02/2021 image.jpg64
09/07/2021 image.jpg65
09/07/2021 image.jpg66
09/10/2021 image.jpg67
09/10/2021 image.jpg68
04/24/2020 Letter INSPECTION SUMMARY
04/24/2020 Letter INSPECTION SUMMARY
05/07/2020 Letter INSPECTION SUMMARY
05/07/2020 Letter INSPECTION SUMMARY
05/07/2020 61056622656__BB599EE5-8ED9-4905-ADEA-49BE1D606BF5
05/07/2020 Letter INSPECTION SUMMARY
05/22/2020 Letter INSPECTION SUMMARY
06/22/2020 Letter INSPECTION SUMMARY
07/06/2020 Letter INSPECTION SUMMARY
07/06/2020 Letter INSPECTION SUMMARY
12/22/2020 Photograph image.jpg11
12/22/2020 Letter INSPECTION SUMMARY
03/09/2021 Letter INSPECTION SUMMARY
04/12/2021 Letter INSPECTION SUMMARY
04/22/2021 Photograph image.jpg27
04/22/2021 Letter INSPECTION SUMMARY
10/13/2020 Letter INSPECTION SUMMARY
12/17/2020 Letter INSPECTION SUMMARY
12/18/2020 Letter INSPECTION SUMMARY
12/21/2020 Letter INSPECTION SUMMARY
08/02/2021 Photograph image.jpg35
08/02/2021 Photograph image.jpg36
08/03/2021 Photograph image.jpg44
08/03/2021 Photograph image.jpg45
09/10/2021 Letter INSPECTION SUMMARY
09/23/2021 image.jpg69
09/23/2021 Letter INSPECTION SUMMARY
09/27/2021 image.jpg70
09/27/2021 image.jpg71
09/27/2021 Letter INSPECTION SUMMARY
09/27/2021 image.jpg72
09/27/2021 Letter INSPECTION SUMMARY
09/29/2021 Letter INSPECTION SUMMARY
09/29/2021 image.jpg73
09/29/2021 image.jpg74
09/29/2021 Letter INSPECTION SUMMARY
09/30/2021 image.jpg75
10/01/2021 image.jpg76
10/01/2021 image.jpg77
10/01/2021 image.jpg78
10/01/2021 image.jpg79
10/21/2021 image.jpg80
10/22/2021 Letter INSPECTION SUMMARY
10/22/2021 image.jpg81
10/29/2021 Letter INSPECTION SUMMARY
11/11/2021 Letter INSPECTION SUMMARY
12/09/2021 image.jpg82
12/09/2021 image.jpg83
12/09/2021 image.jpg84
12/16/2021 Letter INSPECTION SUMMARY
12/20/2021 Letter INSPECTION SUMMARY
01/24/2022 image.jpg85
01/24/2022 Letter INSPECTION SUMMARY
02/08/2022 image.jpg86
04/04/2022 Photograph image
04/04/2022 image0
05/20/2022 Letter INSPECTION SUMMARY
05/20/2022 Letter INSPECTION SUMMARY
06/21/2022 Letter INSPECTION SUMMARY
06/21/2022 67752282871__4BF0A06E-DBE5-4CF2-82B3-E3306B25B31E
06/21/2022 Letter INSPECTION SUMMARY
06/21/2022 image1
07/20/2022 Letter INSPECTION SUMMARY
08/23/2022 Letter INSPECTION SUMMARY
08/24/2022 892B6D04-4241-4797-9CDD-C0380BBD7042
08/24/2022 Letter INSPECTION SUMMARY
08/24/2022 Letter INSPECTION SUMMARY
08/25/2022 Base Aggregate South NW View High PKWY Parking Lot
08/25/2022 Asphalt tickets from Parking Lot East of NW Paragon PKWY
08/25/2022 Letter INSPECTION SUMMARY
09/01/2022 Photograph Parking Lot South of NW View High Drive
09/01/2022 Letter INSPECTION SUMMARY
09/01/2022 Letter INSPECTION SUMMARY
09/01/2022 Letter INSPECTION SUMMARY
09/02/2022 Photograph Parking Lot
09/02/2022 Letter INSPECTION SUMMARY
09/14/2022 Letter DE-Certificate of Substantial Completion Single Lot
09/14/2022 Paragon Star Public Street and Storm Substantial Completion
09/22/2022 Letter DE-Certificate of Substantial Completion Single Lot
09/22/2022 Paragon Star View High Pky and River Dr. Improvements-Public Storm Substantial Completion
09/22/2022 Letter DE-Punch List
09/22/2022 Letter Paragon Star View High Pky and River Dr. Improvements-Public Storm Punch List
10/06/2022 Plans 2022_9_30 Paragon Star Street & Storm - Record Dwgs
10/07/2022 Letter INSPECTION SUMMARY
10/14/2022 Letter INSPECTION SUMMARY
03/02/2023 Letter INSPECTION SUMMARY
03/02/2023 Photograph Water 12 re-connection
03/02/2023 Photograph Water 12 re-connection 1
03/02/2023 Photograph Water 12 re-connection 2
03/02/2023 Letter INSPECTION SUMMARY
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
