Summary


PRSITESITE20183804
Development - Site
Final Acceptance
JOHN KNOX VILLAGE
DEVELOPMENT COMPLETE
SITE REDEVELOPMENT
11/06/2018
12/19/2018
01/24/2023
Locations
Contacts
JOHN KNOX VILLAGE, Address:400 NW MURRAY RD
HAREN CONTRACTING, Address:8035 NIEMAN RD, Phone:(913) 495-9558
ROB DAWSON, Address:HAREN LAUGLIN CONSTRUCTION, Phone:(816) 738-5101
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 11/06/2018 12/13/2018
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
Sanitary Sewer Insp Fees $60.00 $60.00 Paid 12/10/2018
Water Insp Fee $1,566.00 $1,566.00 Paid 12/10/2018
Water Test Fee $200.00 $200.00 Paid 12/10/2018
Storm Sewer Inspection Fee $1,701.75 $1,701.75 Paid 12/10/2018
Paved Surface Inspection Fee $1,861.50 $1,861.50 Paid 12/10/2018
Site Grading Fee $115.50 $115.50 Paid 12/10/2018
After Hours Inspections (Public Works)(Per Hour) $50.00 $50.00 Paid 01/31/2020
After Hours Inspections (Public Works)(Per Hour) $50.00 $50.00 Paid 01/31/2020
After Hours Inspections (Public Works)(Per Hour) $100.00 $100.00 Paid 01/31/2020
After Hours Inspections (Public Works)(Per Hour) $65.00 $65.00 Paid 01/31/2020
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Storm - Material Verification Partial 2/12/2019 02/12/2019
Misc
Informational
02/12/2019
Storm boxes manufactured by Barbour Concrete Company have American Step Company ML-13-NCR steps in them. Storm box covers manufactured by Barbour Concrete Company have EJ 1502-A manhole covers. They are stamped with “STORM” and “City of Lee’s Summit”. The only storm pipe on premises is Advance Drainage System 18650020IB. Will verify the 8, 10, and 12 inch storm pipes when they arrive with the remaining storm system materials.
Storm Sewer Construction Inspection Partial 2/13/2019 03/01/2019
Misc
Informational
03/01/2019
Talked with Wes from Richards Construction about storm box installation and boring beneath walkway for storm and water. They installed storm grate inlets 100 and 120 along with area inlet 110. We used flowfill for backfill on the section of pipe beneath the building. Collars were poured and had sufficient time to set up before backfilling.
Water Line - Construction Inspection Failed 3/8/2019 03/15/2019
Misc
Corrective Action Required
03/15/2019

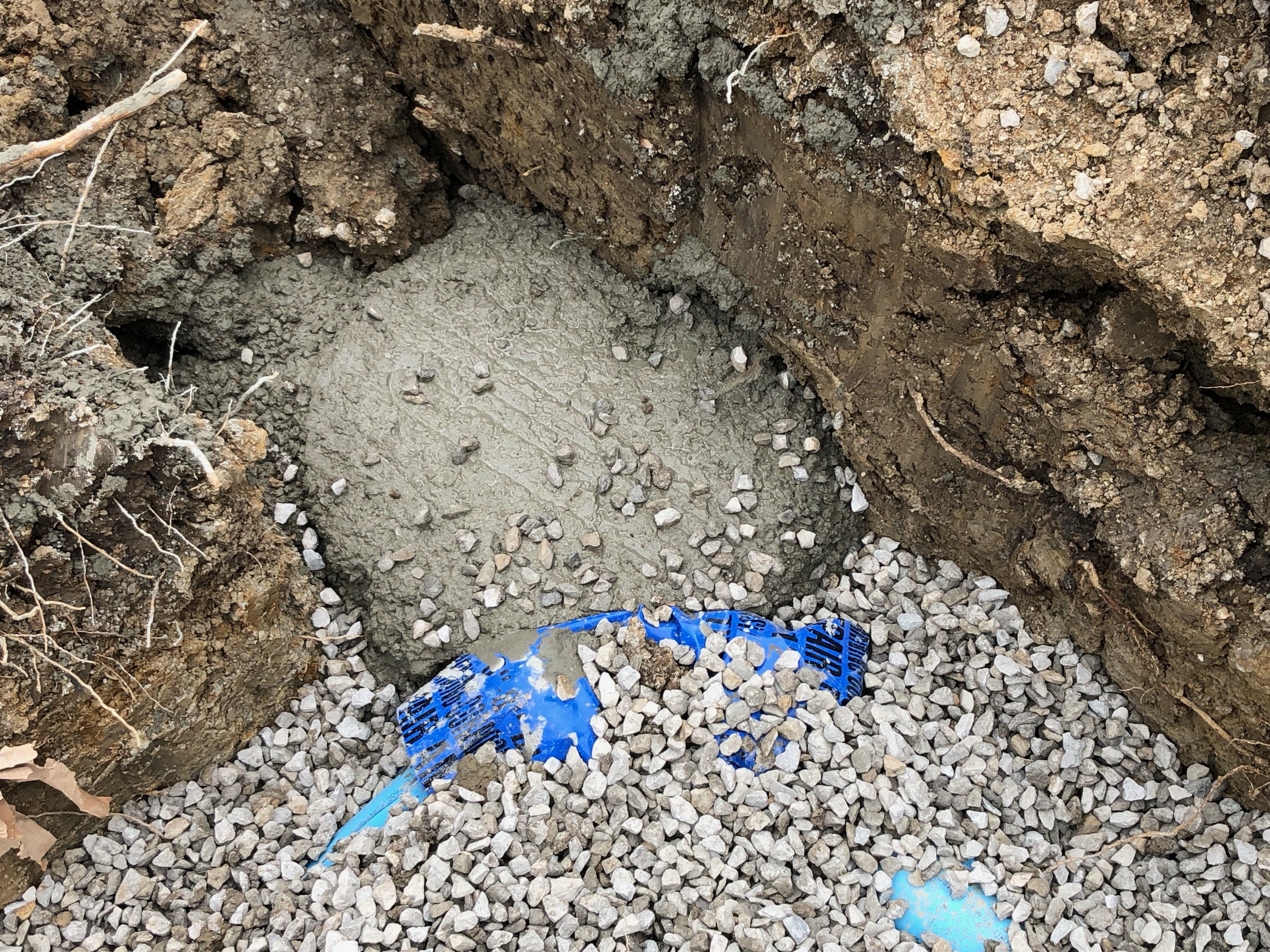

No aggregate below pipe, tracer wire laying on aggregate instead of pipe. Need to dig back up and installed correctly
Water Line - Fire Hydrant Partial 3/15/2019 03/16/2019
Misc
Informational
03/16/2019
Installed Waterous model Pacer (WB-67-250) fire hydrant. Solid concrete pad was placed under the hydrant and a thrust block was poured behind the hydrant.
Water Line - Construction Inspection Partial 3/15/2019 03/16/2019
Misc
Informational
03/16/2019
Richards Construction installed 200 ft of C900 water line. Aggregate and tracer wire was used during the construction. Line still needs to be back filled and utilitie marker tape placed.
Water Line - Thrust Restraint Partial 3/15/2019 03/16/2019
Misc
Informational
03/16/2019
Thrust blacks were poured behind 22 degree and 90 degree bends. Straddle block was poured were the water line needs to go below the gas line.
Water Line - Construction Inspection Partial 3/18/2019 03/18/2019
Misc
Informational
03/16/2019
Richards Construction installed 200 ft of C900 water line. Aggregate and tracer wire was used during the construction. Line still needs to be back filled and utilitie marker tape placed.
Misc
Informational
03/18/2019
Water line was back filled and utility marker tape was placed. Line was chlorinated to above 50 parts per million.
Water Line - Hydrostatic Test Passed 3/18/2019 03/18/2019
Misc
Informational
03/18/2019
Water line was pressurized to 150 psi. Line held 150 psi for 2 hrs
Water Line - Construction Inspection Partial 3/19/2019 03/19/2019
Misc
Informational
03/18/2019
Richards Construction installed 200 ft of C900 water line. Aggregate and tracer wire was used during the construction. Line still needs to be back filled and utilitie marker tape placed.
Misc
Informational
03/18/2019
Water line was back filled and utility marker tape was placed. Line was chlorinated to above 50 parts per million.
Misc
Informational
03/19/2019
Dechlorinated water line for 3 hrs to 10 parts per million.
Water - Material Verification Partial 3/8/2019 04/11/2019
Misc
Informational
03/14/2019
They are using pipe from Sanderson Pipe that meets C900 specs.
Misc
Informational
04/11/2019
Richards Construction is using American Flow Control gate valves. They are also using Megalug connectors.
Water Line - Construction Inspection Partial 4/11/2019 04/12/2019
Misc
Informational
03/19/2019
Richards Construction installed 200 ft of C900 water line. Aggregate and tracer wire was used during the construction. Line still needs to be back filled and utilitie marker tape placed.
Misc
Informational
03/19/2019
Water line was back filled and utility marker tape was placed. Line was chlorinated to above 50 parts per million.
Misc
Informational
03/19/2019
Dechlorinated water line for 3 hrs to 10 parts per million.
Misc
Informational
04/12/2019

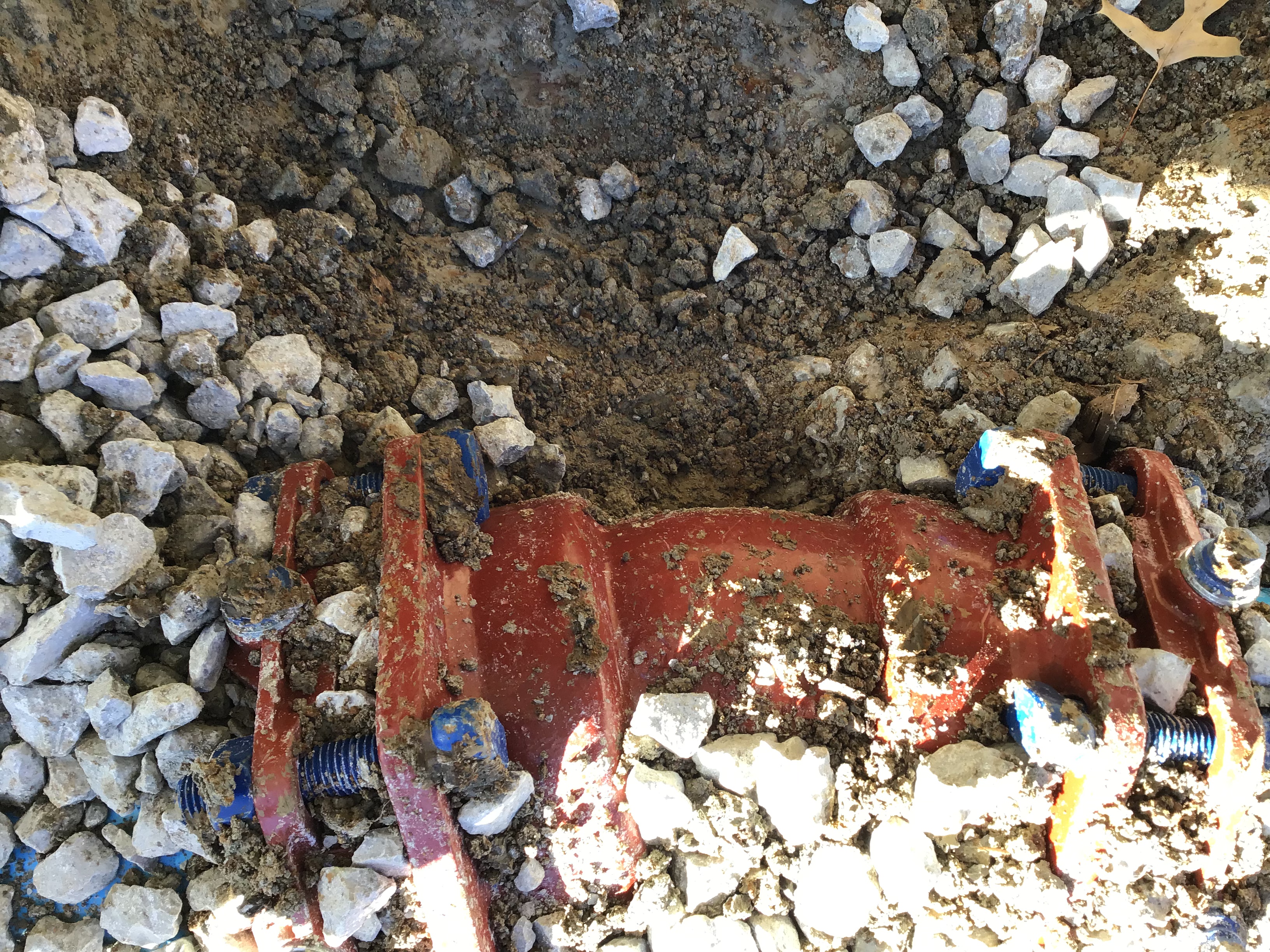

Richards Construction installed a gate valve on the water main during the water tie in. This gate valve allows us to control the water main without shutting off the water main and affecting any more John Knox residences. Thrust blocks for the 45’s will be poured on Friday.
Water Line - Coliform Test 1 Passed 3/20/2019 04/25/2019
Misc
Informational
03/20/2019
Met Wes from Richards Construction. Pulled first water sample from the water main for Bac-T test at 11 AM. Dropped sample off at Keystone Laboratories at 11:49 AM.
Misc
Informational
04/25/2019
Water line passed first Bac-T test performed by Keystone Laboratories. Pulling second Bac-T test.
Water Line - Coliform Test 2 Passed 3/21/2019 04/25/2019
Misc
Informational
03/21/2019
Met with Wes from Richards Construction. Pulled second sample from the water main for the second Bac-T test at 3:35 PM. Dropped sample off at Keystone Laboratories at 4:16 PM
Misc
Informational
04/25/2019
Water line passed second Bac-T test performed by Keystone Laboratories.
Sanitary Sewer Construction Inspection Passed 4/25/2019 04/29/2019
Misc
Informational
04/29/2019
Sanitary line was connected to existing clay sanitary line with hardback Frenco. Drop was encased with concrete and rebar.
Water Line - Thrust Restraint Passed 5/3/2019 05/03/2019
Misc
Informational
03/16/2019
Thrust blacks were poured behind 22 degree and 90 degree bends. Straddle block was poured were the water line needs to go below the gas line.
Misc
Informational
05/03/2019
Thrust blocks were poured behind 22 degrees and 90 degrees bends, along with the end of the fire line.
Fire Line - Hydrostatic Test Passed 5/6/2019 05/07/2019
Misc
Informational
05/07/2019
Fire line passed hydrostatic test of 200 PSI for 2 hrs.
Water Line - Coliform Test 1 Passed 5/9/2019 05/10/2019
Misc
Informational
05/10/2019
First sample passed coliform and E. coli test done by Keystone Laboratories. RP 5-10-19
Water Line - Coliform Test 2 Passed 5/10/2019 05/13/2019
Misc
Informational
05/13/2019
The fire line passed the Coliform and Bac-T test done by Keystone Laboratories. RP 5-13-19
Storm Sewer Construction Inspection Partial 3/20/2019 08/01/2019
Misc
Informational
03/01/2019
Talked with Wes from Richards Construction about storm box installation and boring beneath walkway for storm and water. They installed storm grate inlets 100 and 120 along with area inlet 110. We used flowfill for backfill on the section of pipe beneath the building. Collars were poured and had sufficient time to set up before backfilling.
Misc
Informational
08/01/2019
Joe set Nyloplast drain basins 210, 220, and 230 on 7-30-19. Ben cored out storm box 130 to connect the the drain basins 210, 220, and 230. The collar, storm invert and roof drain still need to be connected. RP 7-31-19
Storm Sewer Construction Inspection Partial 8/1/2019 08/05/2019
Misc
Informational
08/01/2019
Talked with Wes from Richards Construction about storm box installation and boring beneath walkway for storm and water. They installed storm grate inlets 100 and 120 along with area inlet 110. We used flowfill for backfill on the section of pipe beneath the building. Collars were poured and had sufficient time to set up before backfilling.
Misc
Informational
08/01/2019
Joe set Nyloplast drain basins 210, 220, and 230 on 7-30-19. Ben cored out storm box 130 to connect the the drain basins 210, 220, and 230. The collar, storm invert and roof drain still need to be connected. RP 7-31-19
Misc
Informational
08/05/2019
Set Nyloplast drain basins 140 and 150. 150 is the wrong basin, the will cap the extra opening with a plug and backfill with concrete. RP 8-5-19
Storm Sewer Construction Inspection Passed 8/6/2019 08/06/2019
Misc
Informational
08/05/2019
Talked with Wes from Richards Construction about storm box installation and boring beneath walkway for storm and water. They installed storm grate inlets 100 and 120 along with area inlet 110. We used flowfill for backfill on the section of pipe beneath the building. Collars were poured and had sufficient time to set up before backfilling.
Misc
Informational
08/05/2019
Joe set Nyloplast drain basins 210, 220, and 230 on 7-30-19. Ben cored out storm box 130 to connect the the drain basins 210, 220, and 230. The collar, storm invert and roof drain still need to be connected. RP 7-31-19
Misc
Informational
08/05/2019
Set Nyloplast drain basins 140 and 150. 150 is the wrong basin, the will cap the extra opening with a plug and backfill with concrete. RP 8-5-19
Misc
Informational
08/06/2019
Wes’s crew capped the Nyloplast drain basin outlet. Tied in the the 2 roof drains and back filled. RP 8-6-19
Water Line - Construction Inspection Partial 8/13/2019 08/16/2019
Misc
Informational
08/16/2019
Meet with water and Steve Robbins concerning using old water meter and setters for domestic and irrigation lines. Steve is to talk with Brent Boice from Water to decided how we should proceed. RP 8-13-19
Site Visit Partial 8/23/2019 08/23/2019
Misc
Informational
08/23/2019
Met with Rob today to go over water’s decisions concerning fire hydrant, water meter and irrigation meter. He will check will John Knox to determine a decision concerning the irrigation meter. I also dropped off a brand new 2 inch domestic water meter, because their old one was damaged. RP 8-23-19
Misc
Informational
08/23/2019
Met with Rob today to go over water’s decisions concerning fire hydrant, water meter and irrigation meter. He will check will John Knox to determine a decision concerning the irrigation meter. I also dropped off a brand new 2 inch domestic water meter, because their old one was damaged. RP 8-23-19
Site Visit Complete 1/24/2023 01/24/2023
Miscellaneous Correction
Corrective Action Required
01/24/2023
We never received a maintenance bond, checked with Brent from water and everything appears to be ok. We are closing out as it is past the 3 years.
Documents & Images
Date Uploaded File Type Document Name
12/10/2018 Receipt Receipt for transaction: 2018-007528
12/19/2018 Letter DE-Permit

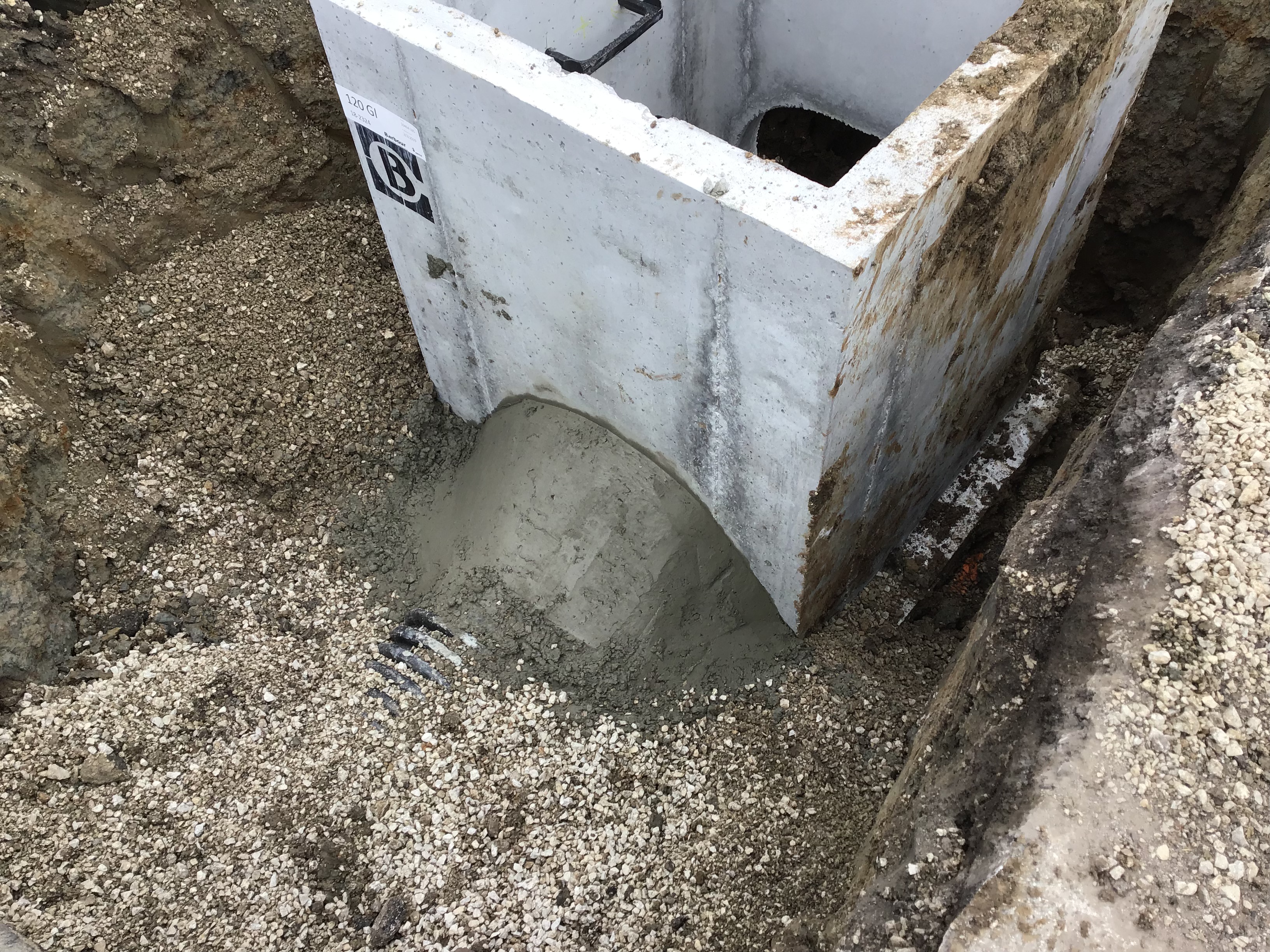

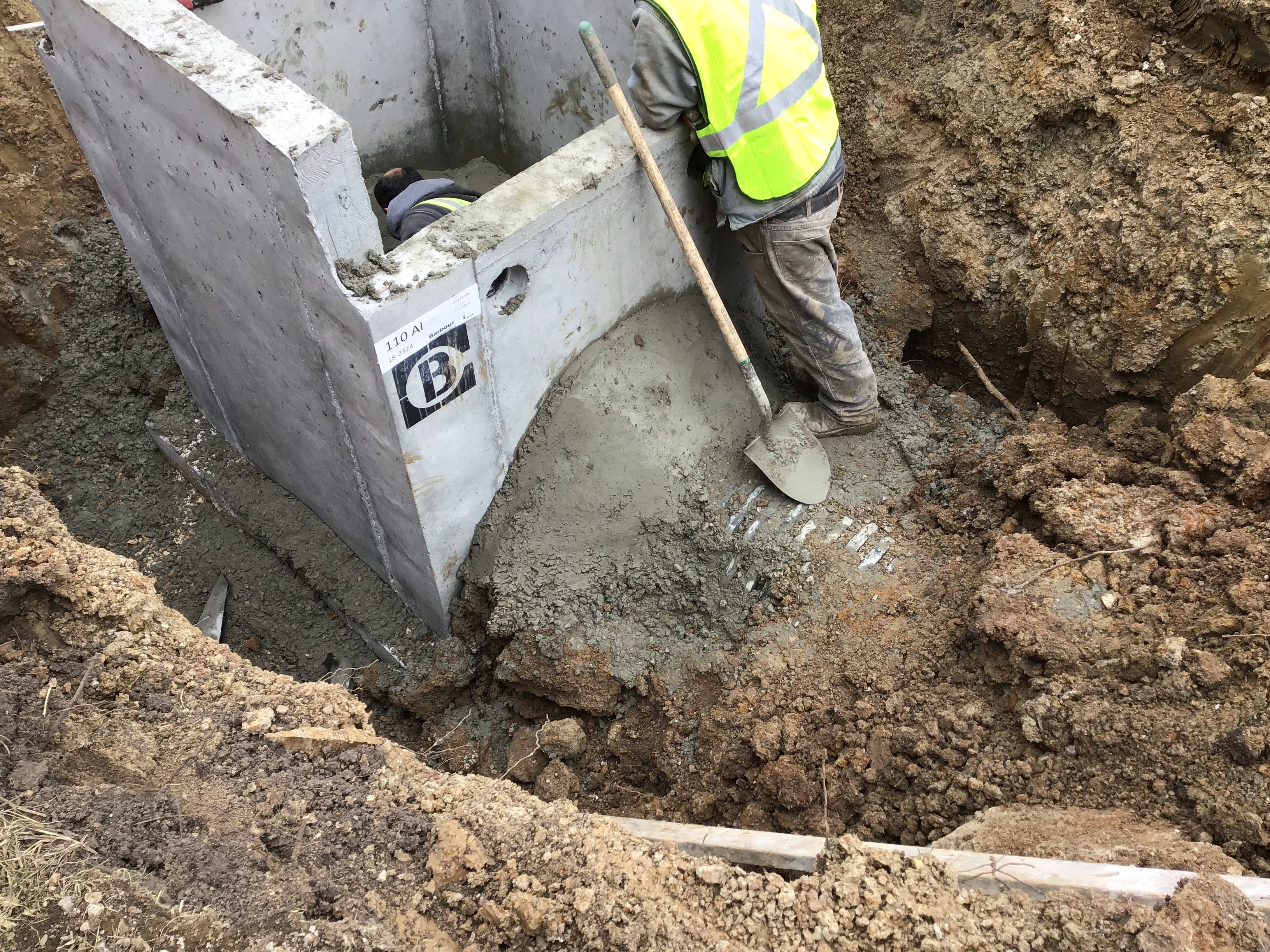

02/12/2019 Storm Box
02/12/2019 Letter INSPECTION SUMMARY
03/01/2019 Letter INSPECTION SUMMARY

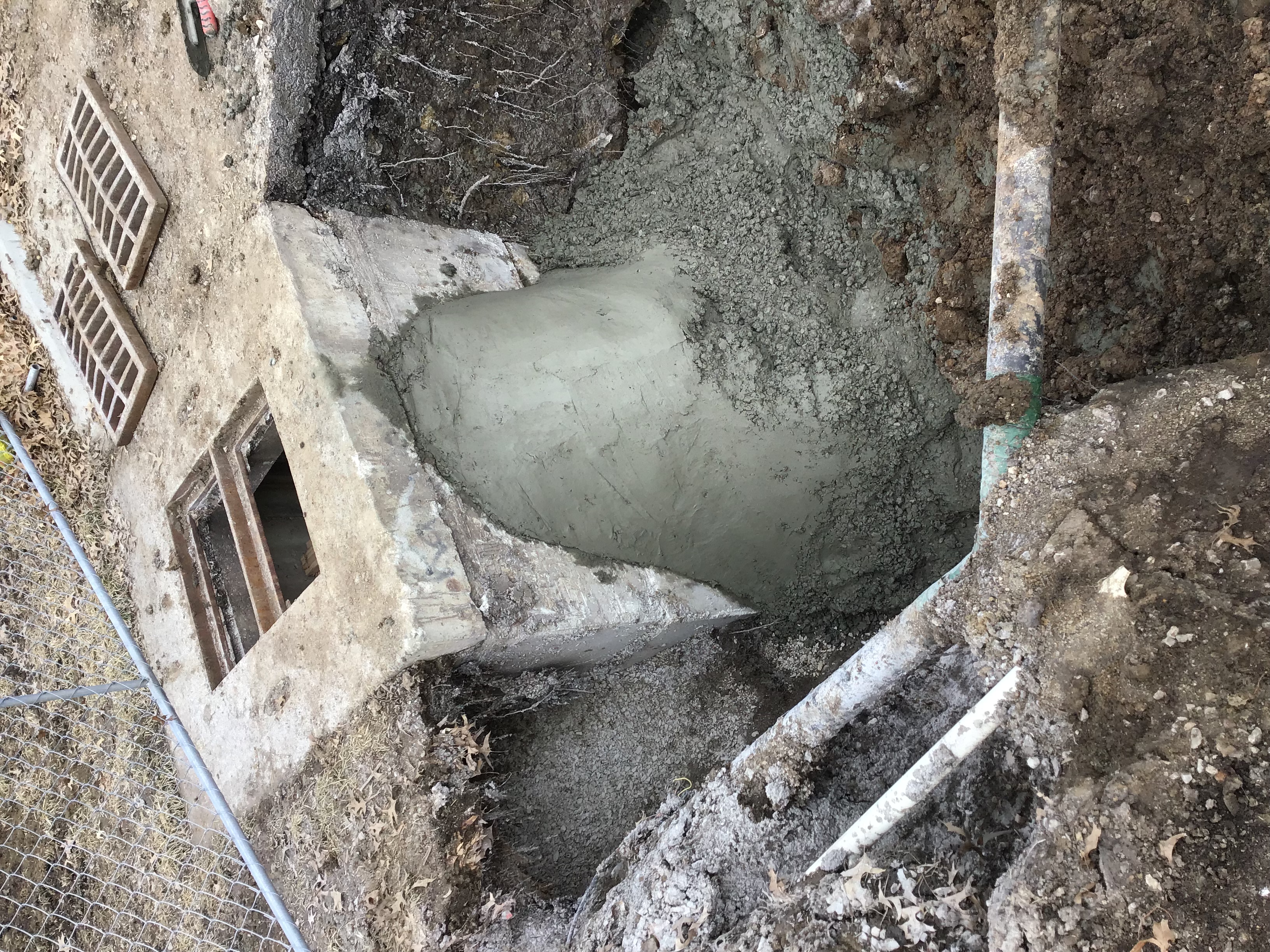

03/01/2019 Existing grate inlet 100
03/01/2019 Area inlet 110
03/01/2019 Grate inlet 120
03/15/2019 Letter INSPECTION SUMMARY
03/15/2019 Tracer wire not on pipe

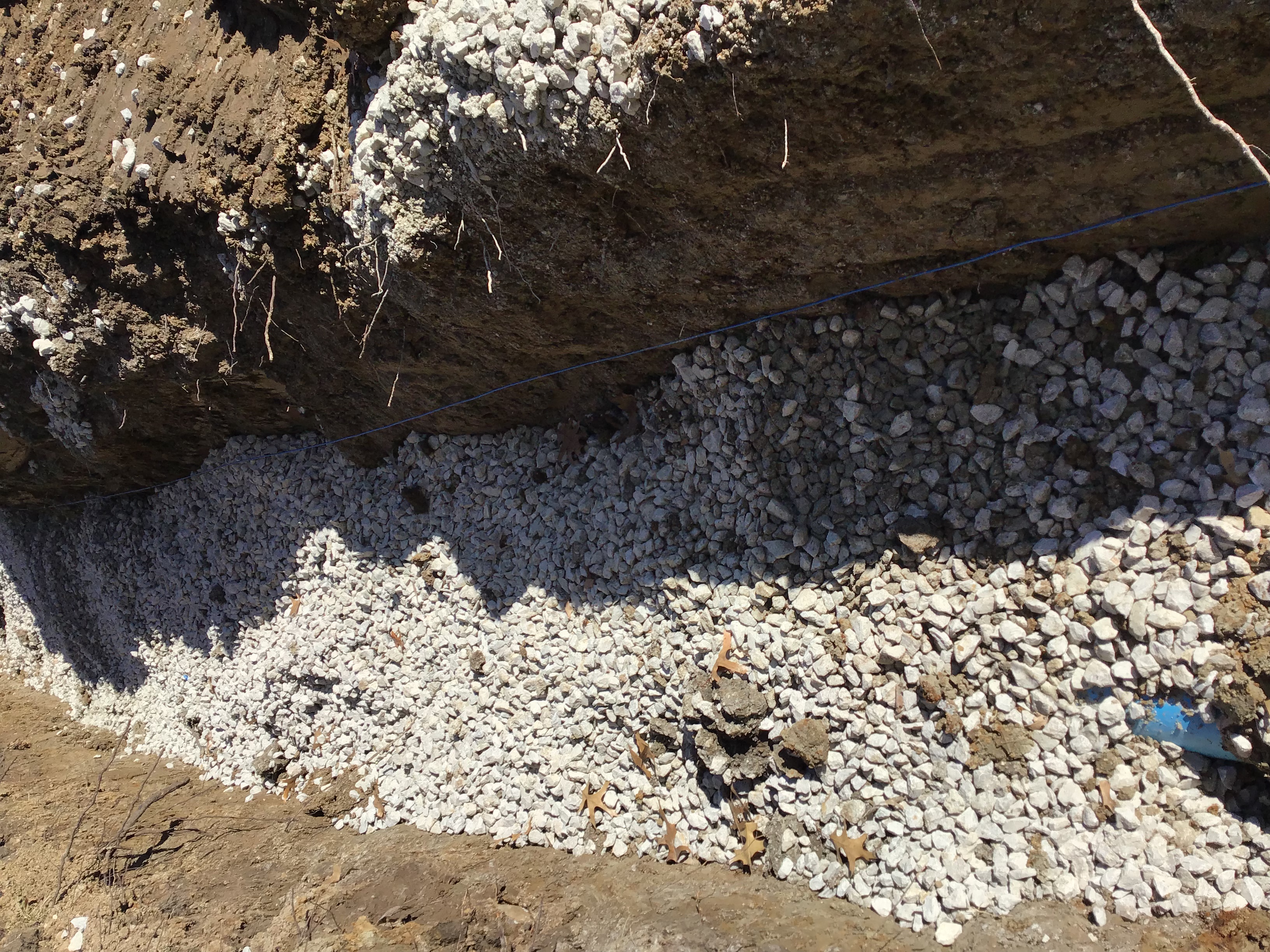

03/15/2019 No aggregate beneath pipe
03/15/2019 No aggregate beneath bend
03/16/2019 Letter INSPECTION SUMMARY
03/16/2019 Letter INSPECTION SUMMARY
03/16/2019 Letter INSPECTION SUMMARY
03/18/2019 Letter INSPECTION SUMMARY
03/18/2019 Letter INSPECTION SUMMARY
03/19/2019 Letter INSPECTION SUMMARY
04/11/2019 Letter INSPECTION SUMMARY
04/12/2019 Letter INSPECTION SUMMARY
04/25/2019 Letter INSPECTION SUMMARY
04/25/2019 Letter INSPECTION SUMMARY
04/25/2019 WO#1C91327 - City of Lees Summit
04/25/2019 WO#1C91525 - City of Lees Summit
04/29/2019 Letter INSPECTION SUMMARY

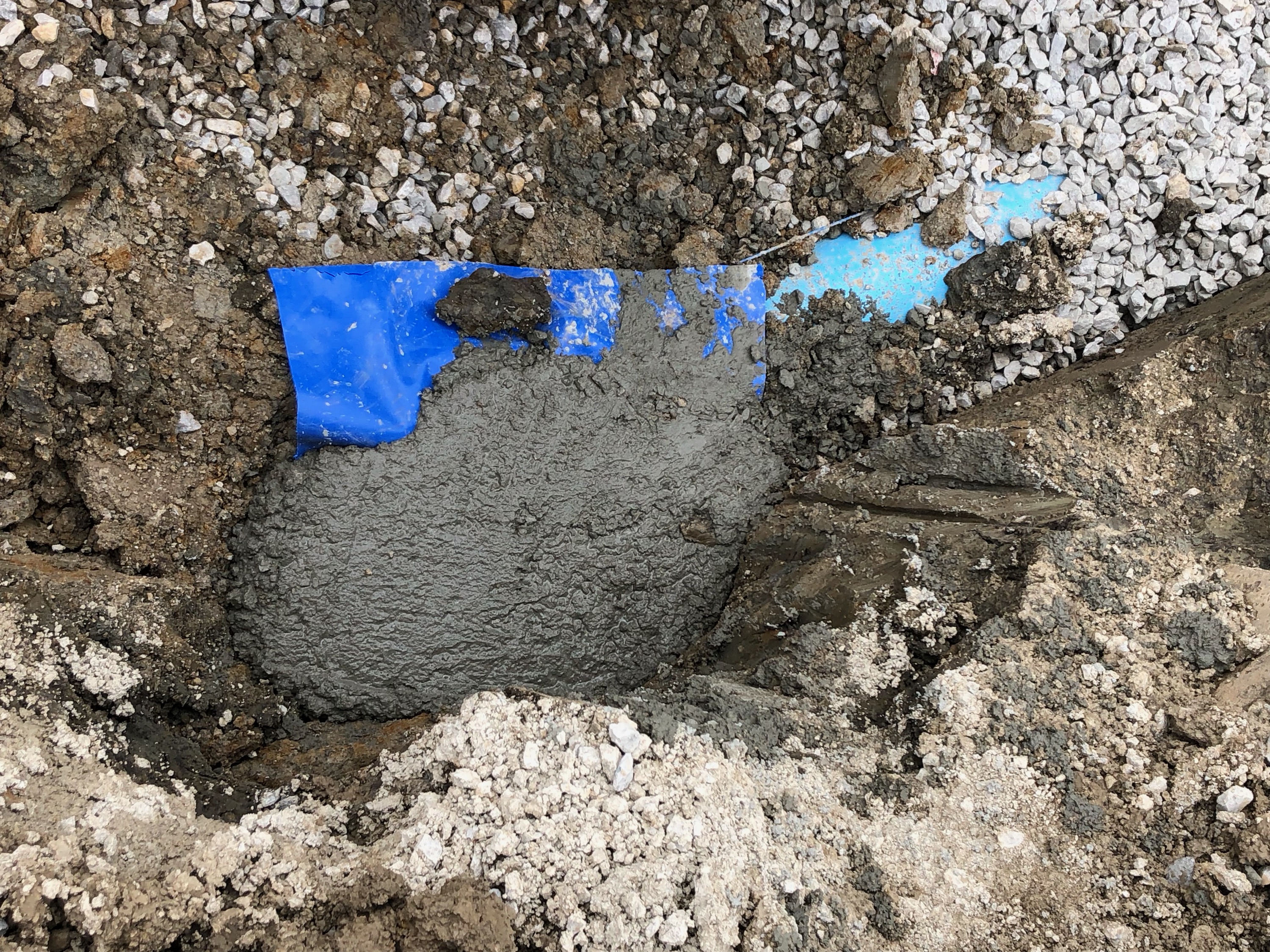

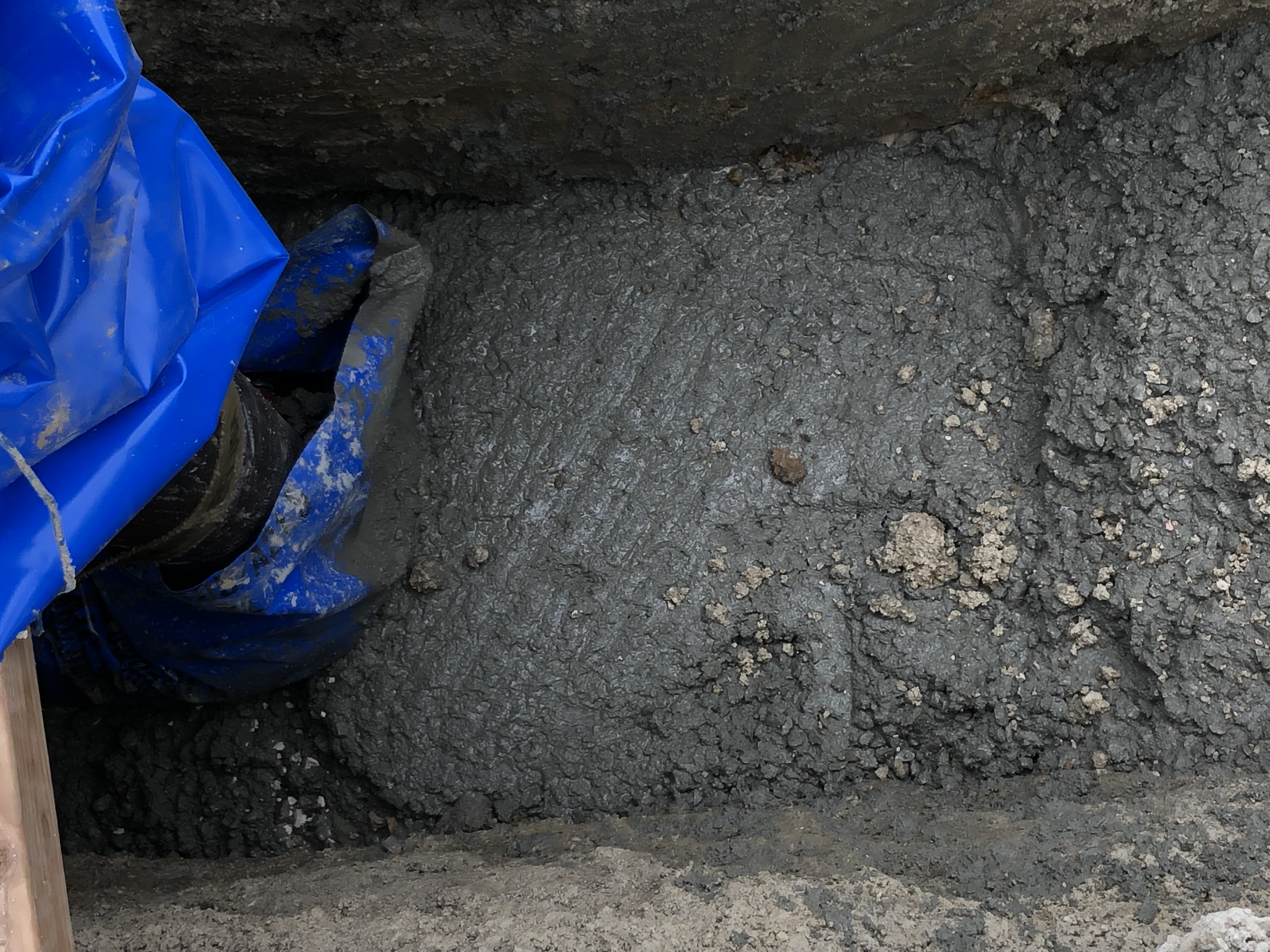

05/03/2019 Thrust blocks

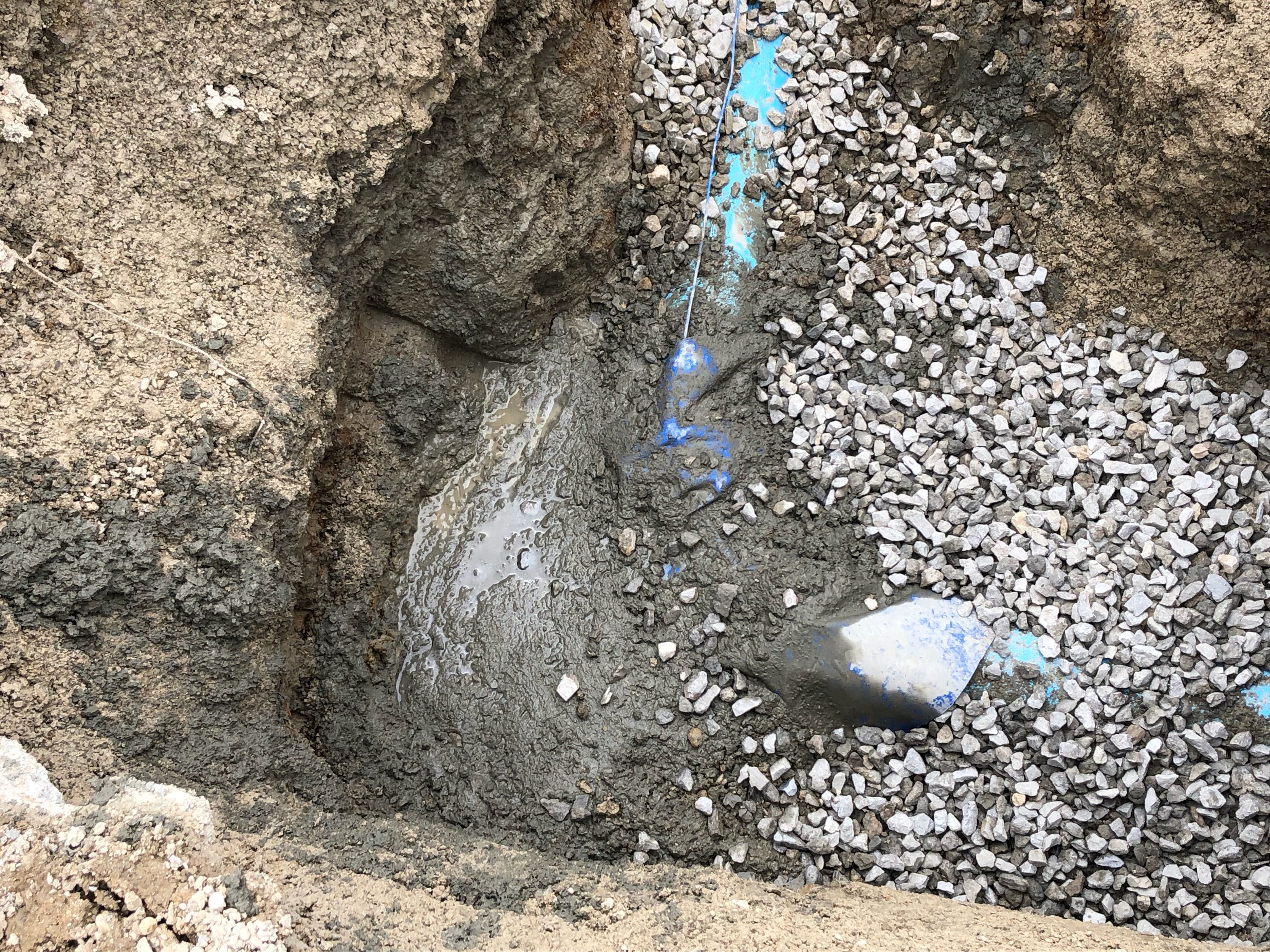

05/03/2019 Thrust blocks0
05/03/2019 Thrust blocks1
05/03/2019 Thrust blocks2
05/03/2019 Letter INSPECTION SUMMARY
05/07/2019 Letter INSPECTION SUMMARY
11/06/2018 Letter Applicant Letter - FDP (DFDP)
05/08/2019 Plans 2019-05-06_JKV UTILITY PLAN
05/10/2019 Letter INSPECTION SUMMARY
05/13/2019 Letter INSPECTION SUMMARY
08/01/2019 Letter INSPECTION SUMMARY
08/05/2019 Letter INSPECTION SUMMARY
08/06/2019 Letter INSPECTION SUMMARY
08/16/2019 Letter INSPECTION SUMMARY
08/23/2019 Letter INSPECTION SUMMARY
01/10/2020 John Knox Village Astoria
01/31/2020 Receipt Receipt for transaction: 2020-000385
01/31/2020 Letter Punch List
04/17/2020 Plans Record Drawing C5.0 - Utility Plan
12/08/2020 Letter DE-Punch List
12/08/2020 Letter DE-Certificate of Substantial Completion Multiple Lot
01/24/2023 Letter DE-Certificate of Final Acceptance (Commercial)
01/24/2023 John Knox Village VAL 400 (Formerly Astoria) Final Acceptance
01/24/2023 Letter INSPECTION SUMMARY
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
