Summary


PRSITE20233869
Development - Site
Final Completion
DIOCESE OF KC-ST JOE REAL ESTATE CORP
DEVELOPMENT COMPLETE
Our Lady of the Presentation Church parking lot expansion. Storm, Street and Site.
08/09/2023
05/13/2024
12/12/2024
Locations
Contacts
DIOCESE OF KC-ST JOE REAL ESTATE CORP, Address:20 W NINTH ST
Kevin Sterrett, Address:Hg Consult, Inc, Phone:(816) 759-2285
ICON GRADING & CONSTRUCTION INC, Address:30806 E ARGO RD, Phone:(816) 806-5565
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 03/26/2024 03/26/2024
Scott Ready
Fees
Paid Fees Amount Paid Owing Date Paid
Storm Sewer Inspection Fee $1,351.50 $1,351.50 Paid 04/11/2024
Paved Surface Inspection Fee $3,878.58 $3,878.58 Paid 04/11/2024
Site Grading Fee $1,536.83 $1,536.83 Paid 04/11/2024
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Site Visit Partial 5/17/2024 5/17/2024 05/17/2024
Misc
Informational
05/17/2024
05/17/24 Friday Pre-construction meet kicked off on Wednesday 05/15/24. No related work schedule until possible next week at the earliest.
Grading/Excavation/Fill Inspection Partial 6/12/2024 6/12/2024 06/12/2024
Misc
Informational
06/12/2024
06/12/24 Wednesday JMJ (ICON) Contractor began to excavating and grading for extend parking lot.
Grading/Excavation/Fill Inspection Partial 6/17/2024 6/17/2024 06/17/2024
Misc
Informational
06/12/2024
06/12/24 Wednesday JMJ (ICON) Contractor began to excavating and grading for extend parking lot. 06/17/24 Monday JMJ (ICON) Contractor continued to excavate and grade as-per plan.
Grading/Excavation/Fill Inspection Partial 6/18/2024 6/18/2024 06/18/2024
Misc
Informational
06/17/2024
06/12/24 Wednesday JMJ (ICON) Contractor began to excavating and grading for extend parking lot. 06/17/24 Monday JMJ (ICON) Contractor continued to excavate and grade as-per plan. 06/18/24 Tuesday JMJ (ICON) Contractor continued to excavate site.
Grading/Excavation/Fill Inspection Partial 6/19/2024 6/19/2024 06/19/2024
Misc
Informational
06/18/2024
06/12/24 Wednesday JMJ (ICON) Contractor began to excavating and grading for extend parking lot. 06/17/24 Monday JMJ (ICON) Contractor continued to excavate and grade as-per plan. 06/18/24 Tuesday JMJ (ICON) Contractor continued to excavate site. 06/19/24 Wednesday JMJ (ICON) Contractor continued to excavate site.
Grading/Excavation/Fill Inspection Partial 6/25/2024 6/25/2024 06/25/2024
Misc
Informational
06/19/2024
06/12/24 Wednesday JMJ (ICON) Contractor began to excavating and grading for extend parking lot. 06/17/24 Monday JMJ (ICON) Contractor continued to excavate and grade as-per plan. 06/18/24 Tuesday JMJ (ICON) Contractor continued to excavate site. 06/19/24 Wednesday JMJ (ICON) Contractor continued to excavate site. 06/25/24 Tuesday JMJ (ICON) Contractor continued to excavate site. as-per project plans.
Erosion Control Inspection Partial 6/26/2024 6/26/2024 06/26/2024
Misc
Informational
06/26/2024
06/26/24 Wednesday JMJ (ICON) Soil erosion measure appear to be functioning.
Storm Sewer Construction Inspection Partial 6/27/2024 6/27/2024 06/27/2024
Misc
Informational
06/27/2024
06/27/24 Thursday JMJ (ICON) Contractor demo exist storm box to prepare to install new box. Contractor is work to drain project of rainwater so they can install storm pipe.
Site Visit Partial 7/1/2024 7/1/2024 07/01/2024
Misc
Informational
05/17/2024
05/17/24 Friday Pre-construction meet kicked off on Wednesday 05/15/24. No related work schedule until possible next week at the earliest.
Misc
Corrective Action Required
07/01/2024
7-1-24 Dustin A, No work being done due to rain
Storm Sewer Construction Inspection Partial 7/9/2024 7/9/2024 07/09/2024
Misc
Informational
06/27/2024
06/27/24 Thursday JMJ (ICON) Contractor demo exist storm box to prepare to install new box. Contractor is work to drain project of rainwater so they can install storm pipe. 07/09/24 Tuesday JMJ (ICON) Contractor installed 1B, 2B, & 3B and 15" HDPE as pre plan. 2B installed the 1" orfice plate toward the existing pipe.
Storm Sewer Construction Inspection Partial 7/10/2024 7/10/2024 07/10/2024
Misc
Informational
07/09/2024
06/27/24 Thursday JMJ (ICON) Contractor demo exist storm box to prepare to install new box. Contractor is work to drain project of rainwater so they can install storm pipe. 07/09/24 Tuesday JMJ (ICON) Contractor installed 1B, 2B, & 3B and 15" HDPE as pre plan. 2B installed the 1" orifice plate toward the existing pipe. 07/10/24 Wednesday JMJ (ICON) Contractor installed approximately 155' of 8" HDPE storm drain that ties in to the storm drain. Contractor poured inverts and collars for storm inlets and storm box.
Storm Sewer Construction Inspection Partial 7/11/2024 7/11/2024 07/11/2024
Misc
Informational
07/10/2024
06/27/24 Thursday JMJ (ICON) Contractor demo exist storm box to prepare to install new box. Contractor is work to drain project of rainwater so they can install storm pipe. 07/09/24 Tuesday JMJ (ICON) Contractor installed 1B, 2B, & 3B and 15" HDPE as pre plan. 2B installed the 1" orifice plate toward the existing pipe. 07/10/24 Wednesday JMJ (ICON) Contractor installed approximately 155' of 8" HDPE storm drain that ties in to the storm drain. Contractor poured inverts and collars for storm inlets and storm box. 07/11/24 Thursday JMJ (ICON) Contractor completed the 8" HDPE pipe to the two down spouts. Contractor connected to the existing to the 6" storm drain pipe.
Site Visit Partial 7/12/2024 7/12/2024 07/12/2024
Misc
Informational
07/01/2024
05/17/24 Friday Pre-construction meet kicked off on Wednesday 05/15/24. No related work schedule until possible next week at the earliest.
Misc
Corrective Action Required
07/01/2024
7-1-24 Dustin A, No work being done due to rain 7/12/24 Friday JMJ Contractor was doing general construction work on site grading for parking lot, survey, planning for toe wall around drain pipe in basin and etc.. .
Storm Sewer Construction Inspection Partial 7/15/2024 7/15/2024 07/15/2024
Misc
Informational
07/11/2024
06/27/24 Thursday JMJ (ICON) Contractor demo exist storm box to prepare to install new box. Contractor is work to drain project of rainwater so they can install storm pipe. 07/09/24 Tuesday JMJ (ICON) Contractor installed 1B, 2B, & 3B and 15" HDPE as pre plan. 2B installed the 1" orifice plate toward the existing pipe. 07/10/24 Wednesday JMJ (ICON) Contractor installed approximately 155' of 8" HDPE storm drain that ties in to the storm drain. Contractor poured inverts and collars for storm inlets and storm box. 07/11/24 Thursday JMJ (ICON) Contractor completed the 8" HDPE pipe to the two down spouts. Contractor connected to the existing to the 6" storm drain pipe. 07/15/24 Monday JMJ (ICON) Contractor demo the existing storm pipes, backfilled, and continued to excavated the site.
Pavement-Stabilized Subgrade Partial 7/17/2024 7/17/2024 07/17/2024
Misc
Informational
07/17/2024
07/17/24 Wednesday JMJ (ICON) Contractor install geo-grid to stabilize the subgrade for future parking lot.
Pavement-Surface Partial 7/23/2024 7/23/2024 07/23/2024
Misc
Informational
07/23/2024
07/23/24 Tuesday (ICON) Contractor began to put forms up for the newly extend parking lot.
Pavement-Proof Roll Passed 7/26/2024 7/26/2024 07/26/2024
Misc
Informational
07/26/2024
07/26/24 Friday JMJ (ICON) Proof roll passed.
Pavement-Curb Construction Partial 7/29/2024 7/29/2024 07/29/2024
Misc
Informational
07/29/2024
07/29/24 Monday JMJ (ICON, Sub-Contractor Quality Pavement) Contractor began to pour curbs for new constructed parking lot as-per plan.
Pavement-Curb Construction Partial 7/30/2024 7/30/2024 07/30/2024
Misc
Informational
07/29/2024
07/29/24 Monday JMJ (ICON, Sub-Contractor Quality Pavement) Contractor began to pour curbs for new constructed parking lot as-per plan. 07/30/24 Tuesday JMJ ( ICON, Sub-Contractor Quality Pavement) Contractor poured concrete on the straight away for the parking lot expansion.
Pavement-Curb Construction Partial 7/31/2024 7/31/2024 07/31/2024
Misc
Informational
07/30/2024
07/29/24 Monday JMJ (ICON, Sub-Contractor Quality Pavement) Contractor began to pour curbs for new constructed parking lot as-per plan. 07/30/24 Tuesday JMJ (ICON, straight away for the parking lot expansion. 07/31/24 Wednesday JMJ (Sub-Contractor Quality Concrete Pavement) Contractor continued to installed curbs islands and brows.
Grading/Excavation/Fill Inspection Partial 7/31/2024 7/31/2024 07/31/2024
Misc
Informational
06/25/2024
06/12/24 Wednesday JMJ (ICON) Contractor began to excavating and grading for extend parking lot. 06/17/24 Monday JMJ (ICON) Contractor continued to excavate and grade as-per plan. 06/18/24 Tuesday JMJ (ICON) Contractor continued to excavate site. 06/19/24 Wednesday JMJ (ICON) Contractor continued to excavate site. 06/25/24 Tuesday JMJ (ICON) Contractor continued to excavate site. as-per project plans. 07/31/24 Wednesday JMJ (ICON) Contractor grade the newly constructed (grass / vegetated area) of project with topsoil.
Pavement-Aggregate Base Partial 8/2/2024 8/2/2024 08/02/2024
Misc
Informational
08/02/2024
08/02/24 Friday JMJ (Contractor ICON, Sub-contractor Tandem Paving Co.) Contractor laid the base asphalt on newly constructed parking lot. (Type 1 recycled APPWA)
Pavement-Surface Partial 8/6/2024 8/6/2024 08/06/2024
Misc
Informational
07/23/2024
07/23/24 Tuesday (ICON) Contractor began to put forms up for the newly extend parking lot. 08/06/24 Tuesday (ICON) Contractor laid the 2" commercial surface coat comparable to type 2 APWWA . Tacking coat was used before surface was installed. Temperature of asphalt fell within acceptable range when was installed.
ESC - (Vegetation/Ground Cover) Partial 8/6/2024 8/6/2024 08/06/2024
Misc
Informational
08/06/2024
08/06/24 Tuesday JMJ Contractor installing trees and shrubs for landscaping. Contractor plans to hydro seed for grass area.
Sidewalk Inspection Partial 8/7/2024 8/7/2024 08/07/2024
Misc
Informational
08/07/2024
08/07/24 Wednesday JMJ ( Quality Custom Construction) Contractor poured sidewalk to the Northwest side of building, note: rebar was installed with no chairs pre-inspection was not requested by contractor.
Site Visit Failed 8/16/2024 08/16/2024
Corrective Action Required
08/16/2024
The required ground cover was not installed at the time of inspection. Please install the required ground cover as depected on the approved PDP.
Corrective Action Required
08/16/2024
A total of 8 ADA stalls are required. No new ADA stalls were provided with this parking lot expansion. Many of the existing ADA stalls are not ADA complained as they are not adjacent to the required hatched aisle. Currently there are only 6 ADA compliant parking stall to serve the existing and new parking lot. This can be rectified by striping off the 3rd parking stall near the gym entrance. Please contact me should you need clarification.
Corrective Action Required
08/16/2024
Many of the ADA stalls do not have the required signage at the head of the stall. Please install the required signage.
Site Visit Partial 8/16/2024 08/16/2024
ESC - (Vegetation/Ground Cover) Partial 8/9/2024 08/20/2024
Misc
Informational
08/06/2024
08/06/24 Tuesday JMJ Contractor installing trees and shrubs for landscaping. Contractor plans to hydro seed for grass area. 08/20/24 Tuesday JMJ Contractor hydroseeded the grass area and the basin. 75% of vegetation must be obtain for final acceptance.
Pavement-Surface Passed 8/9/2024 10/02/2024
Misc
Informational
08/06/2024
07/23/24 Tuesday (ICON) Contractor began to put forms up for the newly extend parking lot. 08/06/24 Tuesday (ICON) Contractor laid the 2" surface coat as per project plans. Tacking coat was used before surface was installed.
Site Visit Partial 10/21/2024 10/21/2024 10/21/2024
Misc
Informational
07/12/2024
05/17/24 Friday Pre-construction meet kicked off on Wednesday 05/15/24. No related work schedule until possible next week at the earliest.
Misc
Corrective Action Required
07/12/2024
7-1-24 Dustin A, No work being done due to rain 7/12/24 Friday JMJ Contractor was doing general construction work on site grading for parking lot, survey, planning for toe wall around drain pipe in basin and etc.. . 10-21-24 Dustin A , No activity
Grading/Excavation/Fill Inspection Passed 12/05/2024
Misc
Informational
07/31/2024
06/12/24 Wednesday JMJ (ICON) Contractor began to excavating and grading for extend parking lot. 06/17/24 Monday JMJ (ICON) Contractor continued to excavate and grade as-per plan. 06/18/24 Tuesday JMJ (ICON) Contractor continued to excavate site. 06/19/24 Wednesday JMJ (ICON) Contractor continued to excavate site. 06/25/24 Tuesday JMJ (ICON) Contractor continued to excavate site. as-per project plans. 07/31/24 Wednesday JMJ (ICON) Contractor grade the newly constructed (grass / vegetated area) of project with topsoil.
Pavement-Curb Construction Passed 12/05/2024
Misc
Informational
07/31/2024
07/29/24 Monday JMJ (ICON, Sub-Contractor Quality Pavement) Contractor began to pour curbs for new constructed parking lot as-per plan. 07/30/24 Tuesday JMJ (ICON, straight away for the parking lot expansion. 07/31/24 Wednesday JMJ (Sub-Contractor Quality Concrete Pavement) Contractor continued to installed curbs islands and brows.
Pavement-Stabilized Subgrade Passed 12/05/2024
Misc
Informational
07/17/2024
07/17/24 Wednesday JMJ (ICON) Contractor install geo-grid to stabilize the subgrade for future parking lot.
Storm Sewer Construction Inspection Passed 12/05/2024
Misc
Informational
07/15/2024
06/27/24 Thursday JMJ (ICON) Contractor demo exist storm box to prepare to install new box. Contractor is work to drain project of rainwater so they can install storm pipe. 07/09/24 Tuesday JMJ (ICON) Contractor installed 1B, 2B, & 3B and 15" HDPE as pre plan. 2B installed the 1" orifice plate toward the existing pipe. 07/10/24 Wednesday JMJ (ICON) Contractor installed approximately 155' of 8" HDPE storm drain that ties in to the storm drain. Contractor poured inverts and collars for storm inlets and storm box. 07/11/24 Thursday JMJ (ICON) Contractor completed the 8" HDPE pipe to the two down spouts. Contractor connected to the existing to the 6" storm drain pipe. 07/15/24 Monday JMJ (ICON) Contractor demo the existing storm pipes, backfilled, and continued to excavated the site.
Sidewalk Inspection Passed 12/05/2024
Misc
Informational
08/07/2024
08/07/24 Wednesday JMJ ( Quality Custom Construction) Contractor poured sidewalk to the Northwest side of building, note: rebar was installed with no chairs pre-inspection was not requested by contractor.
Final Electrical Inspection Passed 12/12/2024 12/12/2024 12/12/2024
Final Completion - Field Engineering Final Completion 12/12/2024
Documents & Images
Date Uploaded File Type Document Name
04/11/2024 Receipt Receipt for transaction:2024-002316
04/11/2024 Approved Plans Approved FDP_Presentation Church Parking Expanson_09132023
05/13/2024 Letter DE-Permit
05/17/2024 Letter INSPECTION SUMMARY
06/17/2024 Letter INSPECTION SUMMARY
06/17/2024 Letter INSPECTION SUMMARY
06/18/2024 Letter INSPECTION SUMMARY
06/19/2024 Letter INSPECTION SUMMARY
06/19/2024 Letter DE-Permit
06/19/2024 Letter INSPECTION SUMMARY
06/25/2024 Letter INSPECTION SUMMARY
06/26/2024 Letter INSPECTION SUMMARY
06/27/2024 Letter INSPECTION SUMMARY
07/01/2024 Letter INSPECTION SUMMARY
07/01/2024 Letter INSPECTION SUMMARY
07/09/2024 Letter INSPECTION SUMMARY
07/10/2024 Letter INSPECTION SUMMARY
07/11/2024 Letter INSPECTION SUMMARY
07/12/2024 Letter INSPECTION SUMMARY
07/15/2024 Letter INSPECTION SUMMARY
07/17/2024 Letter INSPECTION SUMMARY
07/17/2024 Letter INSPECTION SUMMARY
07/23/2024 Letter INSPECTION SUMMARY
07/26/2024 Letter INSPECTION SUMMARY
07/26/2024 Letter INSPECTION SUMMARY
07/29/2024 Letter INSPECTION SUMMARY
07/30/2024 Letter INSPECTION SUMMARY
07/31/2024 Letter INSPECTION SUMMARY
07/31/2024 Letter INSPECTION SUMMARY
07/31/2024 Letter INSPECTION SUMMARY
08/02/2024 Letter INSPECTION SUMMARY
08/06/2024 Letter INSPECTION SUMMARY
08/06/2024 Letter INSPECTION SUMMARY
08/06/2024 Letter INSPECTION SUMMARY

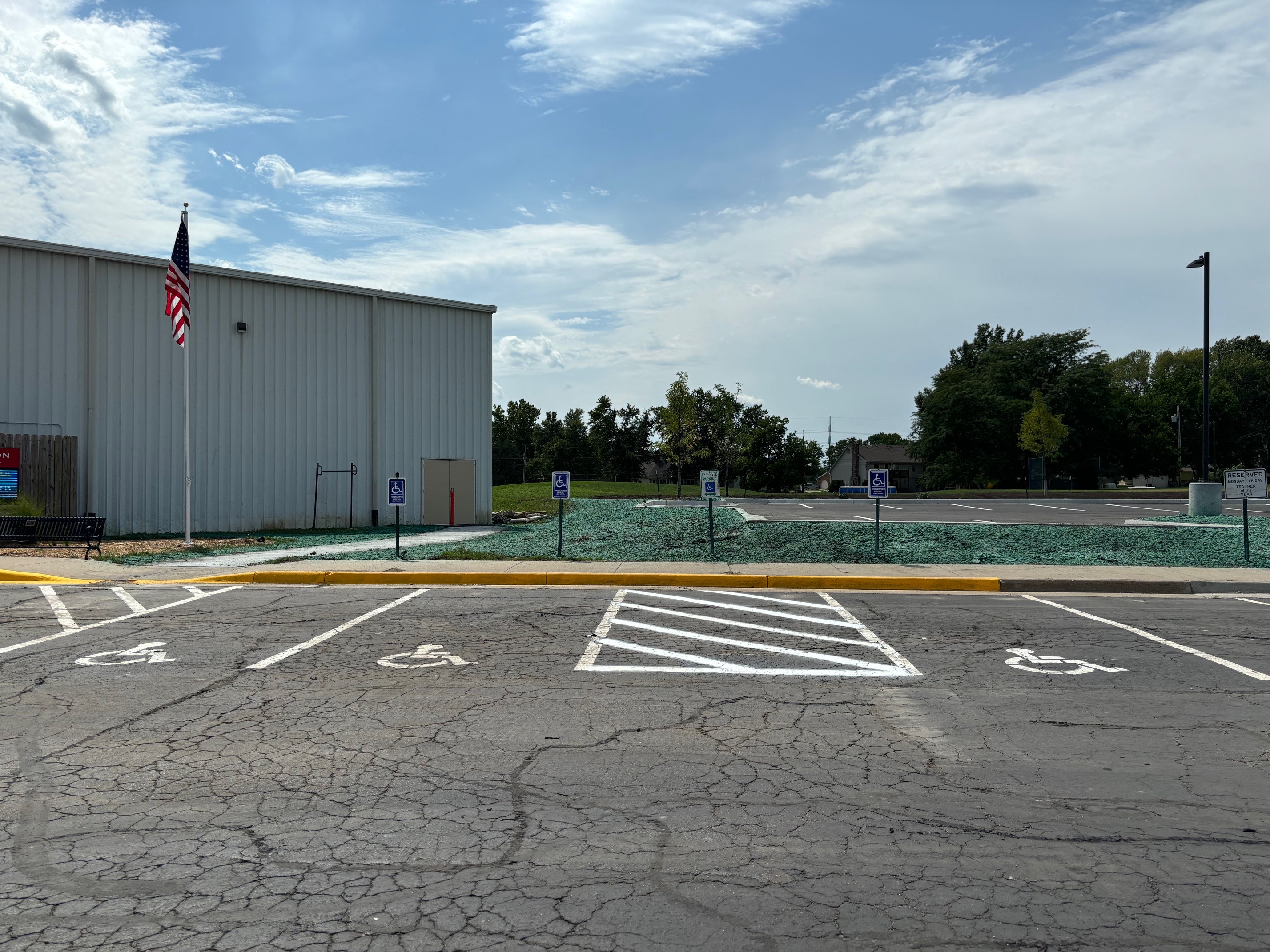

08/16/2024 Photograph ADA Parking Stalls_08162024
08/16/2024 Letter DE-Certificate of Substantial Completion Single Lot
08/16/2024 Letter INSPECTION SUMMARY
08/20/2024 Letter LS Substantial Completion Parking Lot Expansion_Signed_8-20-2024
08/20/2024 Letter INSPECTION SUMMARY
08/20/2024 Letter INSPECTION SUMMARY
10/02/2024 Letter INSPECTION SUMMARY
10/02/2024 Letter INSPECTION SUMMARY
10/21/2024 Letter INSPECTION SUMMARY
12/05/2024 Letter INSPECTION SUMMARY
12/05/2024 Letter INSPECTION SUMMARY
12/05/2024 Letter INSPECTION SUMMARY
12/05/2024 Letter INSPECTION SUMMARY
12/05/2024 Letter INSPECTION SUMMARY
12/12/2024 Letter INSPECTION SUMMARY
Upload Documents
  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:
Browse..





    Portal Home
