Permit Application Status

PRCOM20225393

In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary
PRCOM20225393
Building Permit - Commercial
Certificate of Occupancy
CITY OF LEES SUMMIT
NEW COMMERCIAL
NEW FIRE STATION #5
10/27/2022
01/06/2023
06/27/2024
Locations
Contacts
CITY OF LEES SUMMIT, Address:220 SE GREEN ST
GLMV ARCHITECTURE , Address:9229 WARD PKWY SUITE #210, Phone:(816) 444-4200
MCCOWN GORDON CONSTRUCTION LLC, Address:850 MAIN ST, Phone:(816) 960-1111
PRO CIRCUIT, Address:4925 DERAMUS AVE , Phone:(816) 474-9292
TEMP-CON LLC, Address:15670 S KEELER ST, Phone:(913) 768-4888
RAND CONSTRUCTION COMPANY, Address:1428 W 9TH ST, Phone:(816) 421-4143
MIKE MORGAN, Address:MCCOWN GORDON , Phone:(816) 681-1359
UES dba GEOTECHNOLOGY LLC, Address:5055 ANTIOCH RD, Phone:(913) 438-1900
Reviews
Review Type Outcome Est. Completion Date Completed
Building Plan Review Approved 12/06/2023 11/30/2023
Joe Frogge
Alarm Plan Review Released for Construction 09/06/2023 09/08/2023
Jim Eden
Construction documents for fire alarm systems
Resolved
09/08/2023

2018 IFC 907.1.1- Construction documents. Construction documents for fire alarm systems shall be submitted for review and approval prior to system installation. Construction documents shall include, but not be limited to, all of the following: 1. .A floor plan which indicates the use of all rooms. 2. Locations of alarm-initiating and notification appliances. 3. Alarm control and trouble signaling equipment. 4. Annunciation. 5. Power connection. 6. Battery calculations. 7. Conductor type and sizes. 8. Voltage drop calculations. 9. Manufacturers, model numbers and listing information for equipment, devices and materials. 10. Details of ceiling height and construction. 11. The interface of fire safety control functions. PE Stamped plans received.
Installation acceptance testing
Corrective Action Required
09/08/2023

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. Call (816) 969-1300 to schedule testing.
Alarm Plan Review Rejected 08/14/2023 08/14/2023
Jim Eden
Construction documents for fire alarm systems
Corrective Action Required
08/14/2023

2018 IFC 907.1.1- Construction documents. Construction documents for fire alarm systems shall be submitted for review and approval prior to system installation. Construction documents shall include, but not be limited to, all of the following: 1. .A floor plan which indicates the use of all rooms. 2. Locations of alarm-initiating and notification appliances. 3. Alarm control and trouble signaling equipment. 4. Annunciation. 5. Power connection. 6. Battery calculations. 7. Conductor type and sizes. 8. Voltage drop calculations. 9. Manufacturers, model numbers and listing information for equipment, devices and materials. 10. Details of ceiling height and construction. 11. The interface of fire safety control functions. Action required-Revised plans need to be stamped by a PE.
Miscellaneous Correction
Corrective Action Required
08/14/2023

Correct applicable code to the 2018 IBC.
Miscellaneous Correction
Corrective Action Required
08/14/2023

Provide equipment specifications.
Alarm Plan Review Rejected 06/19/2023
Jim Eden
Miscellaneous Correction
Corrective Action Required
06/19/2023

How is the system being monitored? The alarm shall be remote monitored by Fire Communications (816) 969-7360.
Miscellaneous Correction
Corrective Action Required
06/19/2023

Provide a relay for the kitchen hood/suppression system.
Construction documents for fire alarm systems
Corrective Action Required
06/19/2023

2018 IFC 907.1.1- Construction documents. Construction documents for fire alarm systems shall be submitted for review and approval prior to system installation. Construction documents shall include, but not be limited to, all of the following: 1. .A floor plan which indicates the use of all rooms. 2. Locations of alarm-initiating and notification appliances. 3. Alarm control and trouble signaling equipment. 4. Annunciation. 5. Power connection. 6. Battery calculations. 7. Conductor type and sizes. 8. Voltage drop calculations. 9. Manufacturers, model numbers and listing information for equipment, devices and materials. 10. Details of ceiling height and construction. 11. The interface of fire safety control functions. Plans received. Provide specifications.
Miscellaneous Correction
Corrective Action Required
06/19/2023

Why are there 135CD horn/strobes in the bunk rooms?
Alarm Plan Review Rejected 06/12/2023 06/19/2023
Jim Eden
Miscellaneous Correction
Corrective Action Required
06/19/2023

Miscellaneous Correction
Corrective Action Required
06/19/2023

Misc
Corrective Action Required
06/19/2023

MISC
Corrective Action Required
06/19/2023

How is the system being monitored?
Fire Plan Review Approved with Conditions 04/20/2023 04/20/2023
Jim Eden
Construction documents for fire alarm systems
Informational
04/20/2023

2018 IFC 907.1.1- Construction documents. Construction documents for fire alarm systems shall be submitted for review and approval prior to system installation. Construction documents shall include, but not be limited to, all of the following: 1. .A floor plan which indicates the use of all rooms. 2. Locations of alarm-initiating and notification appliances. 3. Alarm control and trouble signaling equipment. 4. Annunciation. 5. Power connection. 6. Battery calculations. 7. Conductor type and sizes. 8. Voltage drop calculations. 9. Manufacturers, model numbers and listing information for equipment, devices and materials. 10. Details of ceiling height and construction. 11. The interface of fire safety control functions. Action Required: Informational,Noted in Letter deferred submittal. Provide shop drawings for review and approval.
Construction documents - Fire protection systems
Informational
04/20/2023

2018 IFC 901.2- Construction documents. The fire code official shall have the authority to require construction documents and calculations for all fire protection systems and to require permits be issued for the installation, rehabilitation or modification of any fire protection system. Construction documents for fire protection systems shall be submitted for review and approval prior to system installation. Action Required: Informational. Noted in letter deferred submittal. Provide shop drawings for review and approval.
Installation acceptance testing
Informational
04/20/2023

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. Action required: Informational. Call 816-969-1300 to schedule testing.
Knox box required
Corrective Action Required
04/20/2023

2018 IFC 506.1- Where required. Where access to or within a structure or an area is restricted because of secured openings or where immediate access is necessary for life-saving or fire-fighting purposes, the fire code official is authorized to require a key box to be installed in an approved location. The key box shall be of an approved type and shall contain keys to gain necessary access as required by the fire code official. Action needed- The Knox box shall be the Western Missouri Fire Chiefs box, not Lee's Summit, and located 6' AFF by door 109. The box may be ordered at Knoxbox.com.
Sprinkler Plan Review Released for Construction 03/31/2023
Jim Eden
Construction documents - Fire protection systems
Corrective Action Required
03/31/2023

2018 IFC 901.2- Construction documents. The fire code official shall have the authority to require construction documents and calculations for all fire protection systems and to require permits be issued for the installation, rehabilitation or modification of any fire protection system. Construction documents for fire protection systems shall be submitted for review and approval prior to system installation. Stamped plans received March 22, 2023.
Installation acceptance testing
Corrective Action Required
03/31/2023

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. Call (816) 969-1300 to schedule hydrostatic and flow tests.
Special Inspections Review Approved 01/06/2023
Joe Frogge
Building Plan Review Approved with Conditions 01/04/2023 01/03/2023
Joe Frogge
IBC 1704.2 Special Inspections
Resolved
01/03/2023

2018 IBC 1704.2 Special inspections. Where application is made for construction as described in this section, the owner or the registered design professional in responsible charge acting as the owner’s agent shall employ one or more approved agencies to perform inspections during construction on the types of work listed under Section 1705. These inspections are in addition to the inspections identified in Lee’s Summit Code of Ordinances Chapter 7. (see code section for exceptions) Action required: Provide statement of special inspections / letter of responsibility from company contracted to perform special inspections. 12/5/22 - acknowledged in letter
Elevator Equipment Permit
Corrective Action Required
12/27/2022

Prior to the installation or construction of any elevator equipment, an elevator equipment permit shall be obtained from the Missouri Department of Public Safety or its authorized representative. Action required: Comment is informational. 12/5/22 - acknowledged in letter
Elevator Equipment Inspection
Corrective Action Required
12/27/2022

Prior to the operation of any new elevator equipment or the issuance of the operating certificate, such elevator equipment shall be inspected by a licensed inspector. Testing must be performed in accordance with these rules and regulations. The testing must be witnessed by a licensed inspector. Action required: Comment is informational. 12/5/22 - acknowledged in letter
Elevator Certificate of Inspection
Corrective Action Required
12/27/2022

Elevator Safety Act and Rules 701.361 - Each privately owned or operated installation and each installation owned or operated by the state of Missouri or any political subdivision of the state shall have a certificate of inspection and meet the safety code promulgated pursuant to sections 701.350 to 701.380. Action required: Comment is informational. 12/5/22 - acknowledged in letter
IBC 423.1 - Special Occ - Storm Shelters
Resolved
12/29/2022

ICC/NSSA 500 Standard for the Design and Construction of Storm Shelters - 106.1.1 Peer review. A peer review by an independent registered design professional for compliance with the requirements of Chapters 3, 5, 6, and 7 shall be conducted for the following shelter types. 1. Community shelters with occupant load greater than 50. 2. Storm shelters in elementary schools, secondary schools, and day care facilities with an occupant load greater than 16. 3. Storm shelters in Risk Category IV (essential facilities) as defined in Table 1604.5 in the International Building code. Action required: Provide 3rd party peer review for storm shelter. 12/5/22 - Provide verification the items in report have been resolved.
IBC 706.1 Fire and Smoke Protection - General
Resolved
12/29/2022

2018 IBC 706.1 General. Fire walls shall be constructed in accordance with Sections 706.2 through 706.11. The extent and location of such fire walls shall provide a complete separation. Where a fire wall also separates occupancies that are required to be separated by a fire barrier wall, the most restrictive requirements of each separation shall apply. Actions required: - Provide complete UL details that include nail/screw patterns. 12/5/22 - Complete detail for UL 419 required. - - -
Fire Plan Review Approved with Conditions 01/04/2023 01/03/2023
Joe Frogge
Construction documents for fire alarm systems
Corrective Action Required
12/27/2022

2018 IFC 907.1.1- Construction documents. Construction documents for fire alarm systems shall be submitted for review and approval prior to system installation. Construction documents shall include, but not be limited to, all of the following: 1. .A floor plan which indicates the use of all rooms. 2. Locations of alarm-initiating and notification appliances. 3. Alarm control and trouble signaling equipment. 4. Annunciation. 5. Power connection. 6. Battery calculations. 7. Conductor type and sizes. 8. Voltage drop calculations. 9. Manufacturers, model numbers and listing information for equipment, devices and materials. 10. Details of ceiling height and construction. 11. The interface of fire safety control functions. Action Required: Informational,Noted in Letter deferred submittal. Provide shop drawings for review and approval.
Construction documents - Fire protection systems
Corrective Action Required
12/27/2022

2018 IFC 901.2- Construction documents. The fire code official shall have the authority to require construction documents and calculations for all fire protection systems and to require permits be issued for the installation, rehabilitation or modification of any fire protection system. Construction documents for fire protection systems shall be submitted for review and approval prior to system installation. Action Required: Informational. Noted in letter deferred submittal. Provide shop drawings for review and approval.
Installation acceptance testing
Corrective Action Required
12/27/2022

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. Action required: Informational. Call 816-969-1300 to schedule testing.
Licensed Contractors Approved 01/04/2023 12/29/2022
Joe Frogge
Licensed Contractors Approved 12/07/2022 12/20/2022
Mike Weisenborn
LC - MEP Subs
Resolved
12/20/2022

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors. 12/5/22 - Temp-con not currently licensed with us.
Building Plan Review Rejected 12/07/2022 12/05/2022
Joe Frogge
Final Development Plan
Resolved
12/05/2022

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is informational.
IBC 1704.2 Special Inspections
Corrective Action Required
11/30/2022

2018 IBC 1704.2 Special inspections. Where application is made for construction as described in this section, the owner or the registered design professional in responsible charge acting as the owner’s agent shall employ one or more approved agencies to perform inspections during construction on the types of work listed under Section 1705. These inspections are in addition to the inspections identified in Lee’s Summit Code of Ordinances Chapter 7. (see code section for exceptions) Action required: Provide statement of special inspections / letter of responsibility from company contracted to perform special inspections. 12/5/22 - acknowledged in letter
Elevator Equipment Permit
Corrective Action Required
11/30/2022

Prior to the installation or construction of any elevator equipment, an elevator equipment permit shall be obtained from the Missouri Department of Public Safety or its authorized representative. Action required: Comment is informational. 12/5/22 - acknowledged in letter
Elevator Equipment Inspection
Corrective Action Required
11/30/2022

Prior to the operation of any new elevator equipment or the issuance of the operating certificate, such elevator equipment shall be inspected by a licensed inspector. Testing must be performed in accordance with these rules and regulations. The testing must be witnessed by a licensed inspector. Action required: Comment is informational. 12/5/22 - acknowledged in letter
Elevator Certificate of Inspection
Corrective Action Required
11/30/2022

Elevator Safety Act and Rules 701.361 - Each privately owned or operated installation and each installation owned or operated by the state of Missouri or any political subdivision of the state shall have a certificate of inspection and meet the safety code promulgated pursuant to sections 701.350 to 701.380. Action required: Comment is informational. 12/5/22 - acknowledged in letter
IBC 423.1 - Special Occ - Storm Shelters
Corrective Action Required
11/30/2022

ICC/NSSA 500 Standard for the Design and Construction of Storm Shelters - 106.1.1 Peer review. A peer review by an independent registered design professional for compliance with the requirements of Chapters 3, 5, 6, and 7 shall be conducted for the following shelter types. 1. Community shelters with occupant load greater than 50. 2. Storm shelters in elementary schools, secondary schools, and day care facilities with an occupant load greater than 16. 3. Storm shelters in Risk Category IV (essential facilities) as defined in Table 1604.5 in the International Building code. Action required: Provide 3rd party peer review for storm shelter. 12/5/22 - Provide verification the items in report have been resolved.
IBC 706.1 Fire and Smoke Protection - General
Corrective Action Required
11/30/2022

2018 IBC 706.1 General. Fire walls shall be constructed in accordance with Sections 706.2 through 706.11. The extent and location of such fire walls shall provide a complete separation. Where a fire wall also separates occupancies that are required to be separated by a fire barrier wall, the most restrictive requirements of each separation shall apply. Actions required: - Provide complete UL details that include nail/screw patterns. 12/5/22 - Complete detail for UL 419 required. - - -
ICC A117.1 404.2.3.2 Swinging Doors Maneuvering Clearance
Resolved
12/05/2022

ICC A117.1 Section 404.2.3.2 Swinging Doors and gates. Swinging doors and gates shall have maneuvering clearances complying with Table 404.2.3.2. Action required: Provide minimum 18" clearance at latch side of door 100B in Entry Vestibule.
IBC 1109.11 Seating at tables, counters and work surfaces - accessibility
Resolved
12/05/2022

2018 IBC 1109.11 Seating at tables, counters and work surfaces. Where seating or standing space at fixed or built-in tables, counters or work surfaces is provided in accessible spaces, at least 5 percent of the seating and standing spaces, but not less than one, shall be accessible. (see code for exception) Action required: Modify kitchen and casework elevations to show that all countertops will be accessible. Max. 34" high.
IPC 916.3 Island vent installation below flood level rim
Resolved
12/05/2022

2018 IPC 916.3 Vent installation below the fixture flood level rim. The vent located below the flood level rim of the fixture being vented shall be installed as required for drainage piping in accordance with Chapter 7, except for sizing. The vent shall be sized in accordance with Section 906.2. The lowest point of the island fixture vent shall connect full size to the drainage system. The connection shall be to a vertical drain pipe or to the top half of a horizontal drain pipe. Cleanouts shall be provided in the island fixture vent to permit rodding of all vent piping located below the flood level rim of the fixtures. Rodding in both directions shall be permitted through a cleanout. Action required: Modify island fixture vent venting detail A3/P301 to show required cleanouts.
Fire Plan Review Approved with Conditions 12/07/2022 12/05/2022
Ben Hicks
Construction documents for fire alarm systems
Corrective Action Required
11/30/2022

2018 IFC 907.1.1- Construction documents. Construction documents for fire alarm systems shall be submitted for review and approval prior to system installation. Construction documents shall include, but not be limited to, all of the following: 1. .A floor plan which indicates the use of all rooms. 2. Locations of alarm-initiating and notification appliances. 3. Alarm control and trouble signaling equipment. 4. Annunciation. 5. Power connection. 6. Battery calculations. 7. Conductor type and sizes. 8. Voltage drop calculations. 9. Manufacturers, model numbers and listing information for equipment, devices and materials. 10. Details of ceiling height and construction. 11. The interface of fire safety control functions. Action Required: Informational,Noted in Letter deferred submittal. Provide shop drawings for review and approval.
Construction documents - Fire protection systems
Corrective Action Required
11/30/2022

2018 IFC 901.2- Construction documents. The fire code official shall have the authority to require construction documents and calculations for all fire protection systems and to require permits be issued for the installation, rehabilitation or modification of any fire protection system. Construction documents for fire protection systems shall be submitted for review and approval prior to system installation. Action Required: Informational. Noted in letter deferred submittal. Provide shop drawings for review and approval.
Miscellaneous Correction
Resolved
12/05/2022

Provide exit signage above Door(s) 109A and 114A.
Miscellaneous Correction
Resolved
12/05/2022

(C100) Ensure the FDC is far enough north along the wall to keep a hose connected to the FDC from blocking Door 119D.
Misc
Resolved
12/05/2022

Provide a detail for the slide poles and guards.
Installation acceptance testing
Corrective Action Required
12/05/2022

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. Action required: Informational. Call 816-969-1300 to schedule testing.
Fire Plan Review Rejected 11/10/2022 11/10/2022
Jim Eden
Construction documents for fire alarm systems
Corrective Action Required
11/10/2022

2018 IFC 907.1.1- Construction documents. Construction documents for fire alarm systems shall be submitted for review and approval prior to system installation. Construction documents shall include, but not be limited to, all of the following: 1. .A floor plan which indicates the use of all rooms. 2. Locations of alarm-initiating and notification appliances. 3. Alarm control and trouble signaling equipment. 4. Annunciation. 5. Power connection. 6. Battery calculations. 7. Conductor type and sizes. 8. Voltage drop calculations. 9. Manufacturers, model numbers and listing information for equipment, devices and materials. 10. Details of ceiling height and construction. 11. The interface of fire safety control functions. Provide shop drawings for review and approval.
Construction documents - Fire protection systems
Corrective Action Required
11/10/2022

2018 IFC 901.2- Construction documents. The fire code official shall have the authority to require construction documents and calculations for all fire protection systems and to require permits be issued for the installation, rehabilitation or modification of any fire protection system. Construction documents for fire protection systems shall be submitted for review and approval prior to system installation. Provide shop drawings for review and approval.
Miscellaneous Correction
Corrective Action Required
11/10/2022

Provide exit signage above Door(s) 109A and 114A.
Miscellaneous Correction
Corrective Action Required
11/10/2022

(C100) Ensure the FDC is far enough north along the wall to keep a hose connected to the FDC from blocking Door 119D.
Misc
Corrective Action Required
11/10/2022

Provide a detail for the slide poles and guards.
Building Plan Review Rejected 11/10/2022 10/31/2022
Joe Frogge
Final Development Plan
Corrective Action Required
10/31/2022

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is informational.
IBC 1704.2 Special Inspections
Corrective Action Required
10/31/2022

2018 IBC 1704.2 Special inspections. Where application is made for construction as described in this section, the owner or the registered design professional in responsible charge acting as the owner’s agent shall employ one or more approved agencies to perform inspections during construction on the types of work listed under Section 1705. These inspections are in addition to the inspections identified in Lee’s Summit Code of Ordinances Chapter 7. (see code section for exceptions) Action required: Provide statement of special inspections / letter of responsibility from company contracted to perform special inspections.
Elevator Equipment Permit
Corrective Action Required
10/31/2022

Prior to the installation or construction of any elevator equipment, an elevator equipment permit shall be obtained from the Missouri Department of Public Safety or its authorized representative. Action required: Comment is informational.
Elevator Equipment Inspection
Corrective Action Required
10/31/2022

Prior to the operation of any new elevator equipment or the issuance of the operating certificate, such elevator equipment shall be inspected by a licensed inspector. Testing must be performed in accordance with these rules and regulations. The testing must be witnessed by a licensed inspector. Action required: Comment is informational.
Elevator Certificate of Inspection
Corrective Action Required
10/31/2022

Elevator Safety Act and Rules 701.361 - Each privately owned or operated installation and each installation owned or operated by the state of Missouri or any political subdivision of the state shall have a certificate of inspection and meet the safety code promulgated pursuant to sections 701.350 to 701.380. Action required: Comment is informational.
IBC 423.1 - Special Occ - Storm Shelters
Corrective Action Required
10/31/2022

ICC/NSSA 500 Standard for the Design and Construction of Storm Shelters - 106.1.1 Peer review. A peer review by an independent registered design professional for compliance with the requirements of Chapters 3, 5, 6, and 7 shall be conducted for the following shelter types. 1. Community shelters with occupant load greater than 50. 2. Storm shelters in elementary schools, secondary schools, and day care facilities with an occupant load greater than 16. 3. Storm shelters in Risk Category IV (essential facilities) as defined in Table 1604.5 in the International Building code. Action required: Provide 3rd party peer review for storm shelter.
IBC 706.1 Fire and Smoke Protection - General
Corrective Action Required
10/31/2022

2018 IBC 706.1 General. Fire walls shall be constructed in accordance with Sections 706.2 through 706.11. The extent and location of such fire walls shall provide a complete separation. Where a fire wall also separates occupancies that are required to be separated by a fire barrier wall, the most restrictive requirements of each separation shall apply. Actions required: - Provide complete UL details that include nail/screw patterns. - Coordinate fire protection scenarios. Code summary plans don't match floor plans as concerns which walls are rated. - Provide UL detail for 2 hour separation. - Provide UL detail for 2 hour horizontal assemblies.
ICC A117.1 404.2.3.2 Swinging Doors Maneuvering Clearance
Corrective Action Required
10/31/2022

ICC A117.1 Section 404.2.3.2 Swinging Doors and gates. Swinging doors and gates shall have maneuvering clearances complying with Table 404.2.3.2. Action required: Provide minimum 18" clearance at latch side of door 100B in Entry Vestibule.
IBC 1109.11 Seating at tables, counters and work surfaces - accessibility
Corrective Action Required
10/31/2022

2018 IBC 1109.11 Seating at tables, counters and work surfaces. Where seating or standing space at fixed or built-in tables, counters or work surfaces is provided in accessible spaces, at least 5 percent of the seating and standing spaces, but not less than one, shall be accessible. (see code for exception) Action required: Modify kitchen and casework elevations to show that all countertops will be accessible. Max. 34" high.
IPC 916.3 Island vent installation below flood level rim
Corrective Action Required
10/31/2022

2018 IPC 916.3 Vent installation below the fixture flood level rim. The vent located below the flood level rim of the fixture being vented shall be installed as required for drainage piping in accordance with Chapter 7, except for sizing. The vent shall be sized in accordance with Section 906.2. The lowest point of the island fixture vent shall connect full size to the drainage system. The connection shall be to a vertical drain pipe or to the top half of a horizontal drain pipe. Cleanouts shall be provided in the island fixture vent to permit rodding of all vent piping located below the flood level rim of the fixtures. Rodding in both directions shall be permitted through a cleanout. Action required: Modify island fixture vent venting detail A3/P301 to show required cleanouts.
Licensed Contractors Rejected 10/27/2022 10/31/2022
Joe Frogge
LC - MEP Subs
Corrective Action Required
10/31/2022

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors.
Fees
Paid Fees Amount Paid Owing Date Paid
9110078-Valuation Fee for New Commercial $26,400.00 $26,400.00 Paid 01/06/2023
$4,826.25
7232302-Commercial License Tax Fee $4,826.25 $4,826.25 Paid 12/21/2022
$4,826.25
8331401-Water Tap Fee $24,865.00 $24,865.00 Paid 01/06/2023
8350015-Water Meter Fee $3,102.16 $3,102.16 Paid 01/06/2023
8331507-Sanitary Sewer Development Fee $9,230.00 $9,230.00 Paid 01/06/2023
9110068-Storm Fee $2,446.95 $2,446.95 Paid 01/06/2023
91100C9-Water Insp Fee $2,254.05 $2,254.05 Paid 01/06/2023
91100C8-Sanitary Sewer Insp Fees $990.00 $990.00 Paid 01/06/2023
9110081-Paved Surface Inspection Fee $7,011.84 $7,011.84 Paid 01/06/2023
9110071-Site Grading Fee $3,134.40 $3,134.40 Paid 01/06/2023
9110072-Water Test Fee $200.00 $200.00 Paid 01/06/2023
9110073-Right of Way Permit Fee $85.00 $85.00 Paid 01/06/2023
9110078-Temporary Occupancy Fee $50.00 $50.00 Paid 03/20/2024
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.

$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Grading/Excavation/Fill Inspection Partial 1/13/2023 01/13/2023
Misc
Informational
01/13/2023
1-13-22 RH. Contractor has started cutting site down to subgrade. No work for development today.
Grading/Excavation/Fill Inspection Partial 1/23/2023 1/23/2023 01/23/2023
Misc
Informational
01/13/2023
1-13-22 RH. Contractor has started cutting site down to subgrade. No work for development today. 1-23-23 PS Contractor placed compacted material for building. Contractor installing fence for job site, job trailer and temp power
Erosion Control Inspection Residential Partial 1/23/2023 1/23/2023 01/23/2023
Misc
Informational

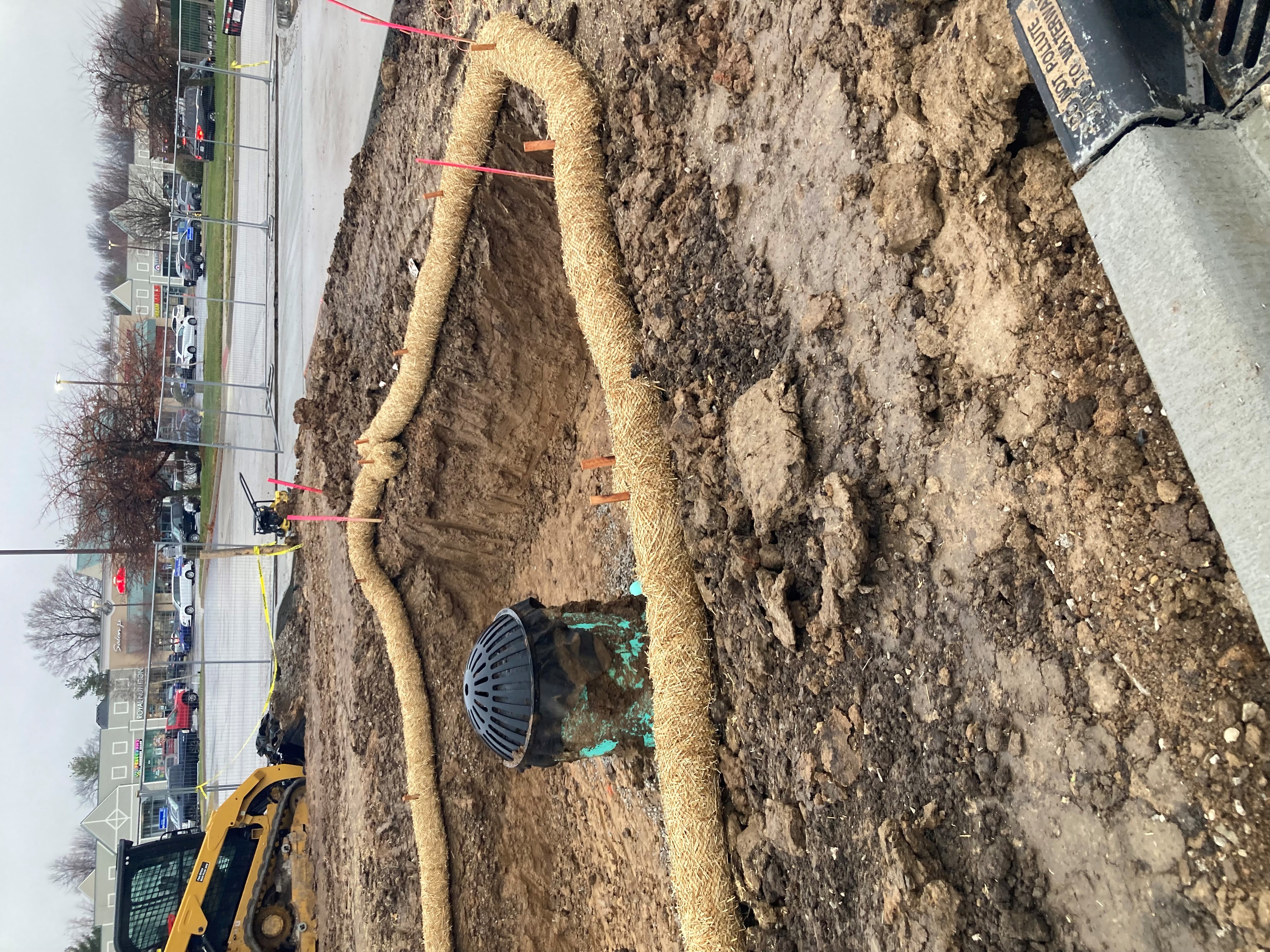

01/23/2023
1-23-23 PS Erosion control within compliance 6-12-23 BR Erosion Control is up and working order 6-19-23 BR Erosion Control is and working order 7-31-23 BR Erosion Control is up and working order 8-15-23 BR Erosion Control is up and working order 8-31-23 BR Erosion Control is up and working order 9-12-23 BR Erosion Control is up and working order 9-26-23 BR Erosion Control is up and working order 10-10-23 BR Erosion Control is up and working order 10-24-23 BR Erosion Control is up and working order 11-7-23 BR Erosion Control is up and working order 11-28-23 BR Erosion Control is up and working order 12-5-23 BR Erosion Control is up and working order 2-9-24 Dustin A, Erosion control has been taken down in prep for sod. Informed contact on site that a form of erosion control would need to be reinstalled if not sodded before next rain
Erosion Control Inspection Partial 1/25/2023 1/25/2023 01/25/2023
Misc
Informational
01/25/2023
1-25-23 PS Erosion control within compliance
Grading/Excavation/Fill Inspection Partial 1/27/2023 1/27/2023 01/27/2023
Misc
Informational
01/23/2023
1-13-22 RH. Contractor has started cutting site down to subgrade. No work for development today. 1-23-23 PS Contractor placed compacted material for building. Contractor installing fence for job site, job trailer and temp power 1-27-23 PS Contractor working on general site work removing spoils piles from project
Erosion Control Inspection Partial 1/30/2023 01/30/2023
Misc
Informational
01/25/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison contorl is up and in working order.
Grading/Excavation/Fill Inspection Partial 1/31/2023 01/31/2023
Misc
Informational
01/27/2023
1-13-22 RH. Contractor has started cutting site down to subgrade. No work for development today. 1-23-23 PS Contractor placed compacted material for building. Contractor installing fence for job site, job trailer and temp power 1-27-23 PS Contractor working on general site work removing spoils piles from project 1-31-23 RH. Contractor continued moving fill and grading site.
Grading/Excavation/Fill Inspection Partial 2/1/2023 2/1/2023 02/01/2023
Misc
Informational
01/31/2023
1-13-22 RH. Contractor has started cutting site down to subgrade. No work for development today. 1-23-23 PS Contractor placed compacted material for building. Contractor installing fence for job site, job trailer and temp power 1-27-23 PS Contractor working on general site work removing spoils piles from project 1-31-23 RH. Contractor continued moving fill and grading site. 2-1-23 PS Contractor continued grading site and fill removal
Erosion Control Inspection Partial 2/2/2023 2/2/2023 02/02/2023
Misc
Informational
01/30/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison control is up and in working order. 2-2-23 PS Erosion control within compliance
Site Visit Partial 2/6/2023 02/06/2023
Misc
Informational
02/02/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development.
Erosion Control Inspection Partial 2/6/2023 02/06/2023
Misc
Informational
02/02/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison control is up and in working order. 2-2-23 PS Erosion control within compliance 2-6-22 RH. Erosion control is up and in working order.
Grading/Excavation/Fill Inspection Partial 2/7/2023 02/07/2023
Misc
Informational
02/01/2023
1-13-22 RH. Contractor has started cutting site down to subgrade. No work for development today. 1-23-23 PS Contractor placed compacted material for building. Contractor installing fence for job site, job trailer and temp power 1-27-23 PS Contractor working on general site work removing spoils piles from project 1-31-23 RH. Contractor continued moving fill and grading site. 2-1-23 PS Contractor continued grading site and fill removal. 2-7-23 RH. Contractor continues to work on building pad.
Grading/Excavation/Fill Inspection Partial 2/8/2023 2/8/2023 02/08/2023
Misc
Informational
02/07/2023
1-13-22 RH. Contractor has started cutting site down to subgrade. No work for development today. 1-23-23 PS Contractor placed compacted material for building. Contractor installing fence for job site, job trailer and temp power 1-27-23 PS Contractor working on general site work removing spoils piles from project 1-31-23 RH. Contractor continued moving fill and grading site. 2-1-23 PS Contractor continued grading site and fill removal. 2-7-23 RH. Contractor continues to work on building pad. 2-8-23 PS Contractor working on building pad and removing spoils pile
Erosion Control Inspection Partial 2/13/2023 02/13/2023
Misc
Informational
02/06/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison control is up and in working order. 2-2-23 PS Erosion control within compliance 2-6-22 RH. Erosion control is up and in working order. 2-13-23 RH. Erosion cotrol is up and in working order.
Site Visit Partial 2/15/2023 2/15/2023 02/15/2023
Misc
Informational
02/06/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site
Site Visit Partial 2/17/2023 02/17/2023
Misc
Informational
02/15/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site.
Erosion Control Inspection Partial 2/22/2023 2/22/2023 02/22/2023
Misc
Informational
02/13/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison control is up and in working order. 2-2-23 PS Erosion control within compliance 2-6-22 RH. Erosion control is up and in working order. 2-13-23 RH. Erosion cotrol is up and in working order. 2-22-23 RH. Erosion Control is up and in working order.
Erosion Control Inspection Partial 2/27/2023 02/27/2023
Misc
Informational
02/22/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison control is up and in working order. 2-2-23 PS Erosion control within compliance 2-6-22 RH. Erosion control is up and in working order. 2-13-23 RH. Erosion cotrol is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order.
Site Visit Partial 2/28/2023 02/28/2023
Misc
Informational
02/17/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today.

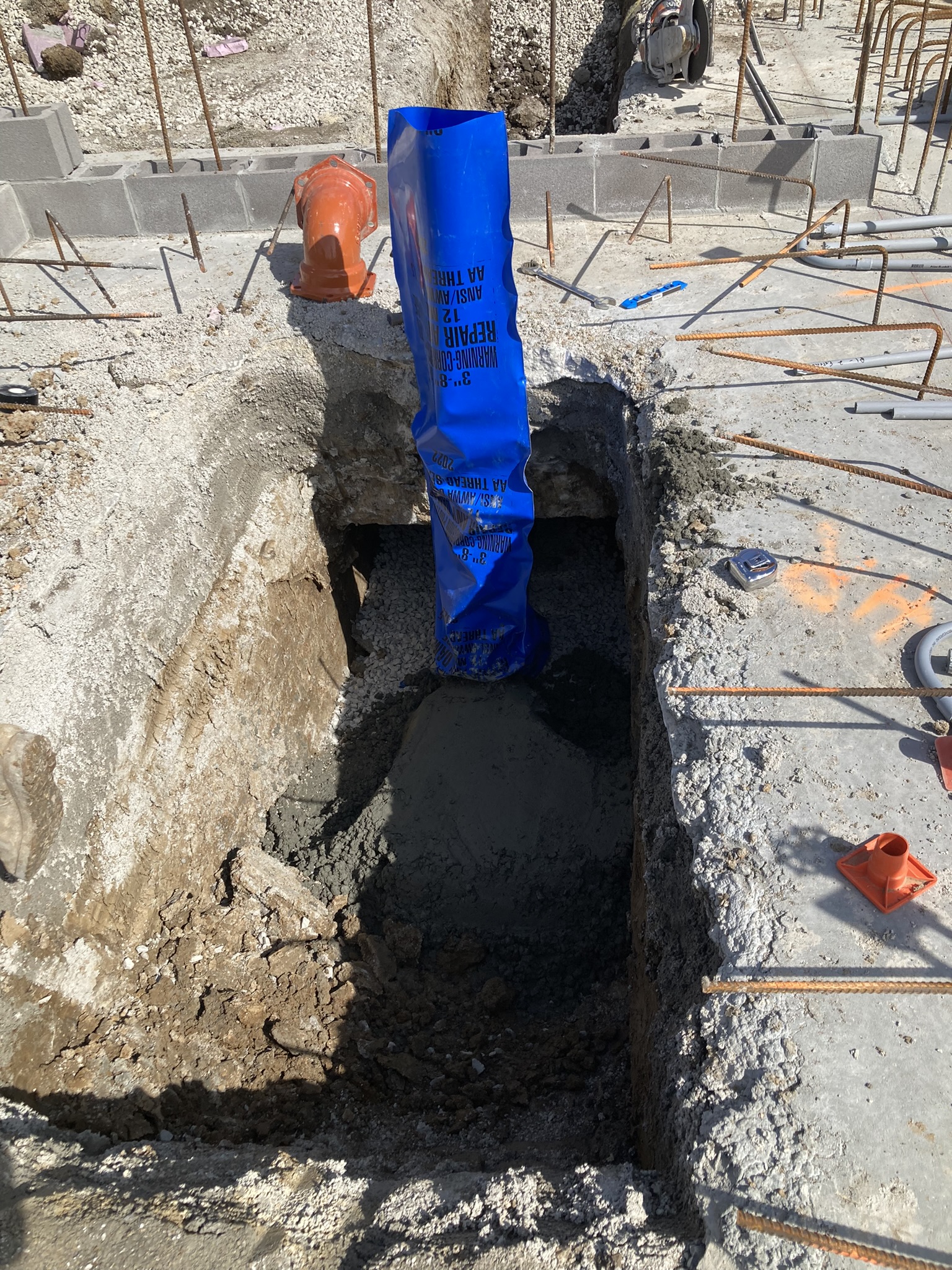

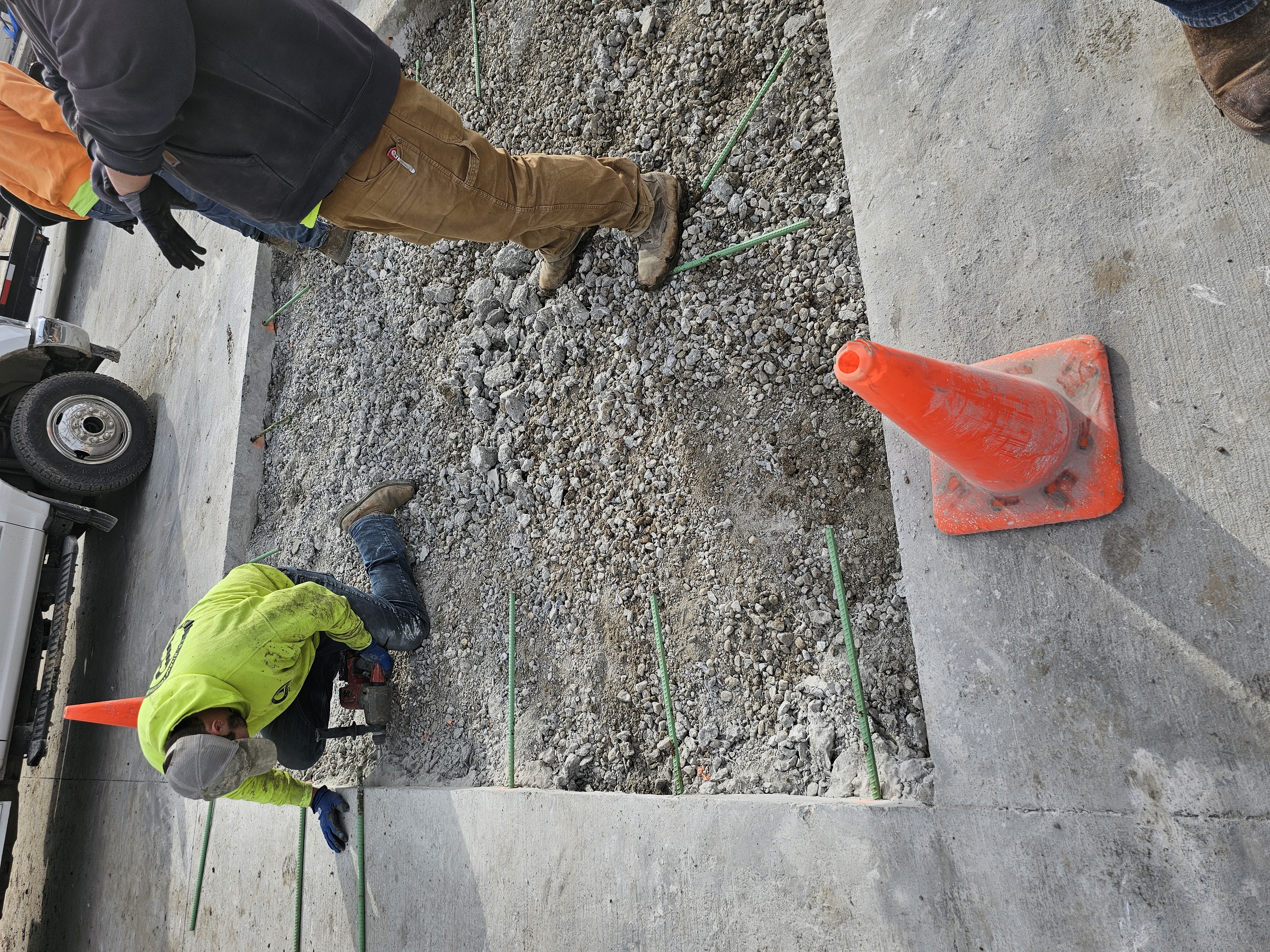

Footing Inspection - Commercial Partial 3/1/2023 (1:00) 3/1/2023 03/01/2023
Misc
Corrective Action Required
03/01/2023
Grade beam and column pads OK below: Line 2 from A to E; GB under rm 111-113 walls
Footing Inspection - Commercial Partial 3/2/2023 (8:00) 3/2/2023 03/02/2023
Misc
Corrective Action Required
03/01/2023
Grade beam and column pads OK below: Line 2 from A to E; GB under rm 111-113 walls; GB north of line A
Site Visit Partial 3/2/2023 3/2/2023 03/02/2023
Misc
Informational
02/28/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development.
Erosion Control Inspection Partial 3/3/2023 3/3/2023 03/03/2023
Misc
Informational
02/27/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison control is up and in working order. 2-2-23 PS Erosion control within compliance 2-6-22 RH. Erosion control is up and in working order. 2-13-23 RH. Erosion cotrol is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order.
Erosion Control Inspection Partial 3/6/2023 03/06/2023
Misc
Informational
03/03/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison control is up and in working order. 2-2-23 PS Erosion control within compliance 2-6-22 RH. Erosion control is up and in working order. 2-13-23 RH. Erosion cotrol is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-6-23 RH. Erosion Control is up and in working order.
Footing Inspection - Commercial Partial 3/7/2023 (11:00) 3/7/2023 03/07/2023
Misc
Corrective Action Required
03/02/2023
Grade beam and column pads OK below: Line 2 from A to E; GB under rm 111-113 walls; GB north of line A; line 9-10 from A to H; elevator pad; col pad at 9/F; retaining wall at back from 1-6.3
Site Visit Partial 3/9/2023 03/09/2023
Misc
Informational
03/07/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain.

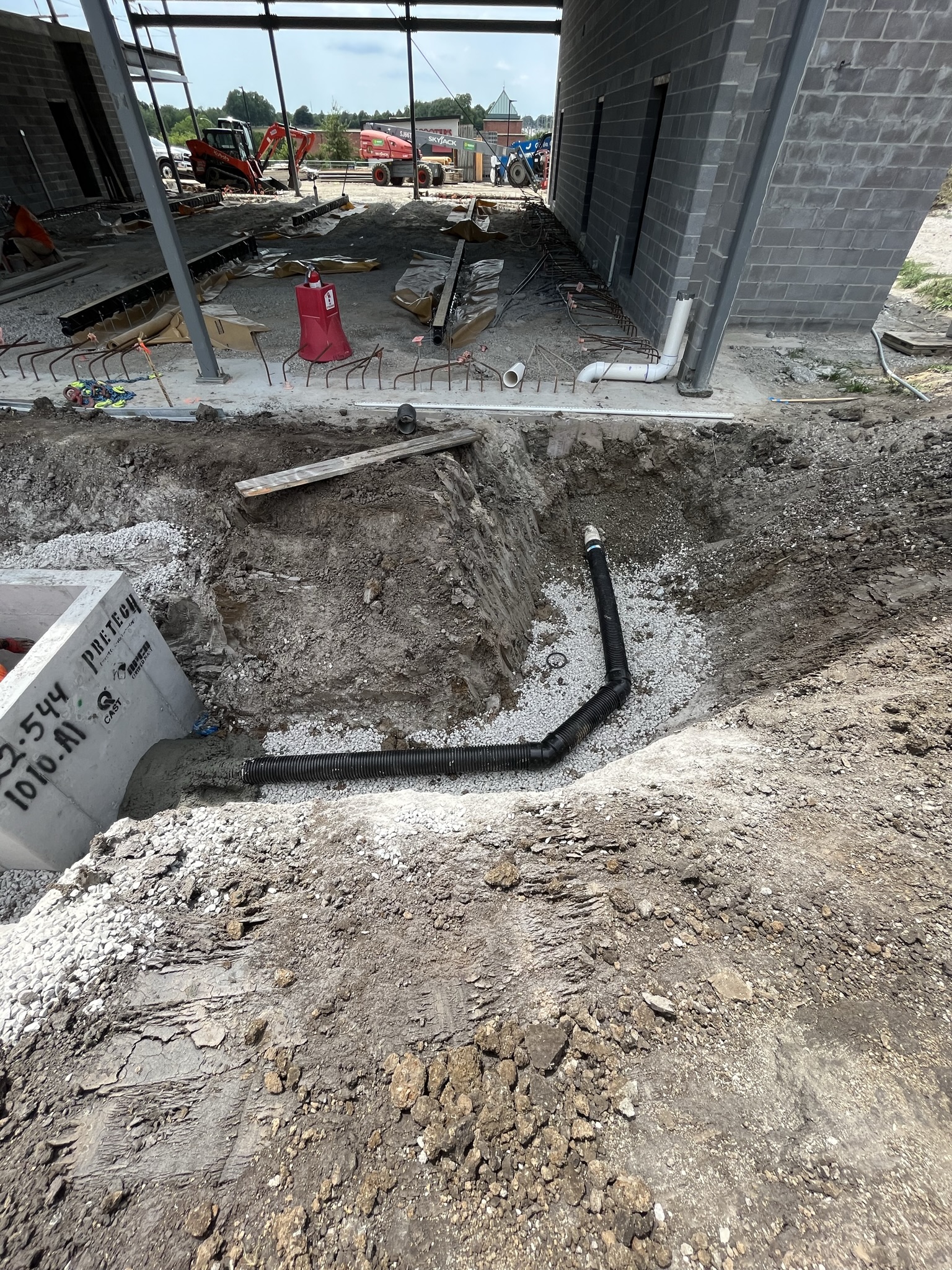

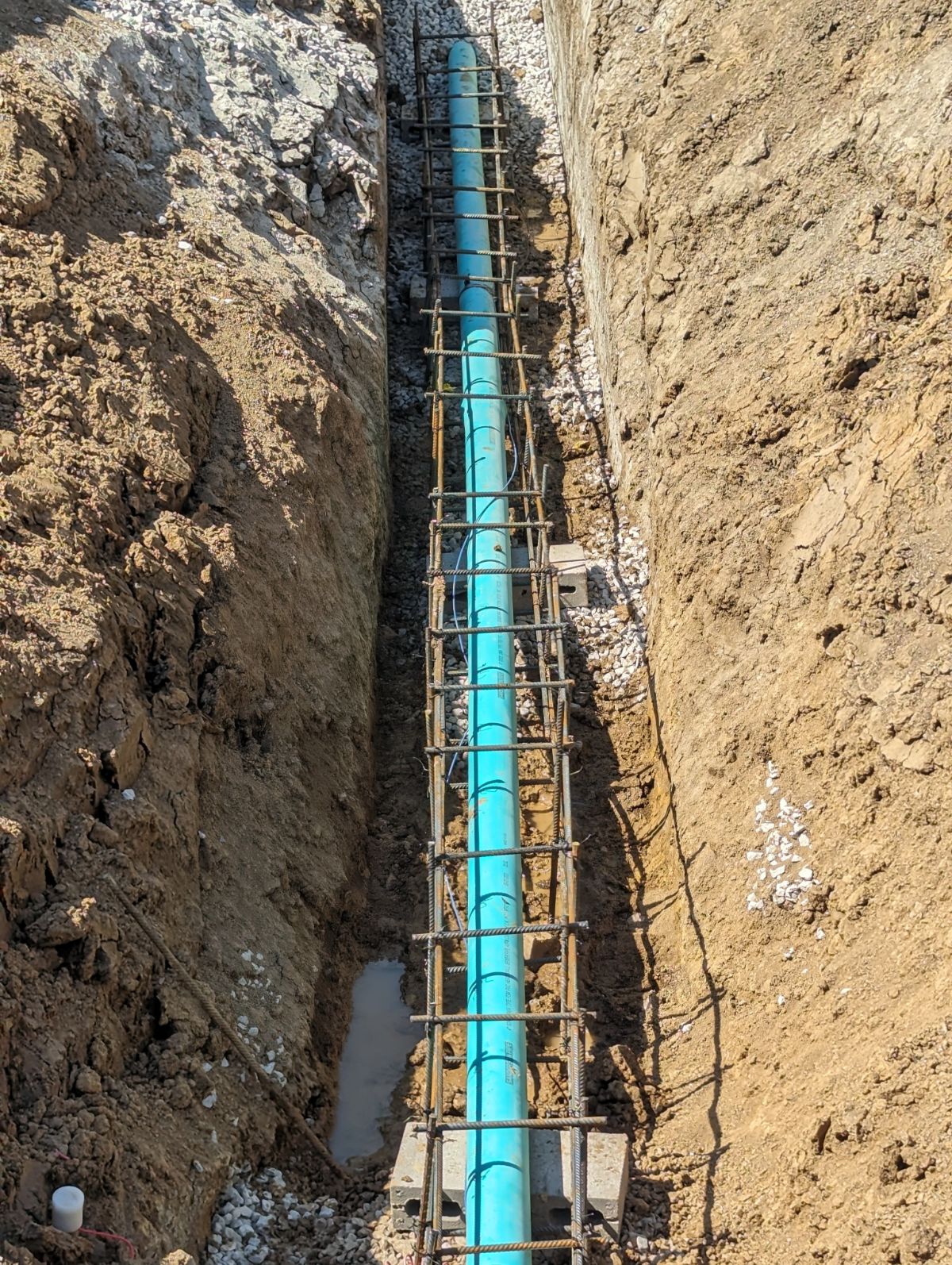

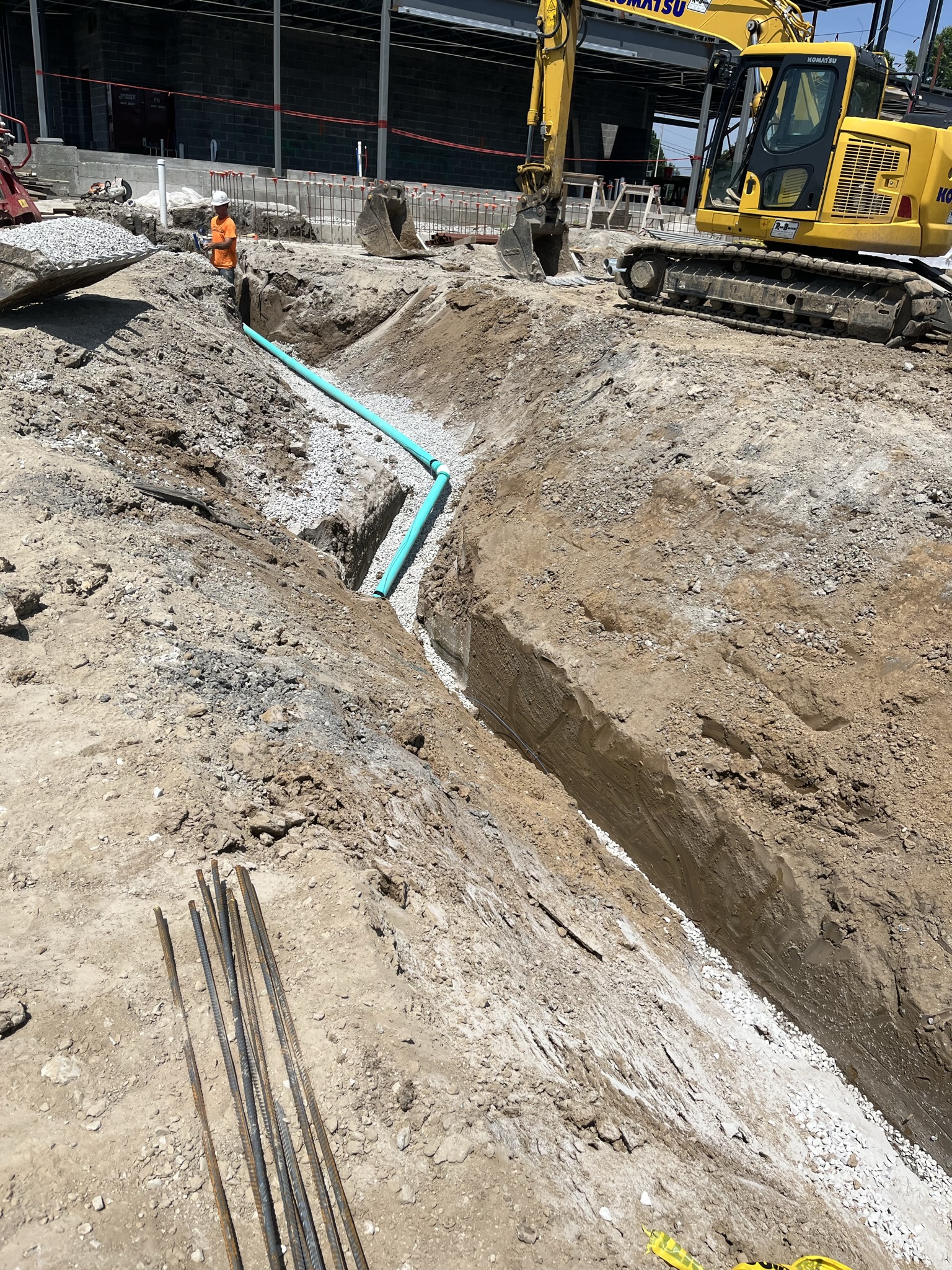

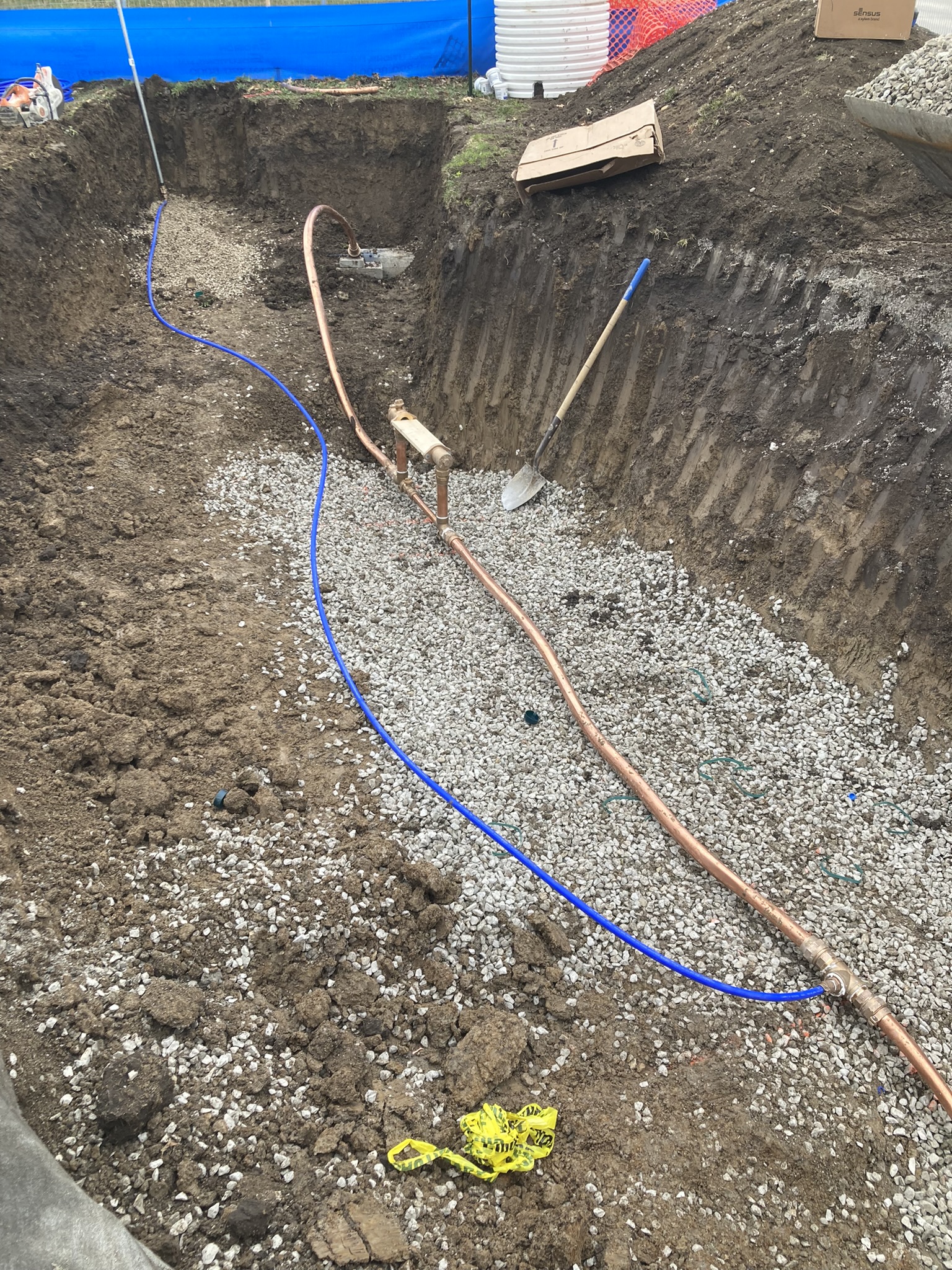

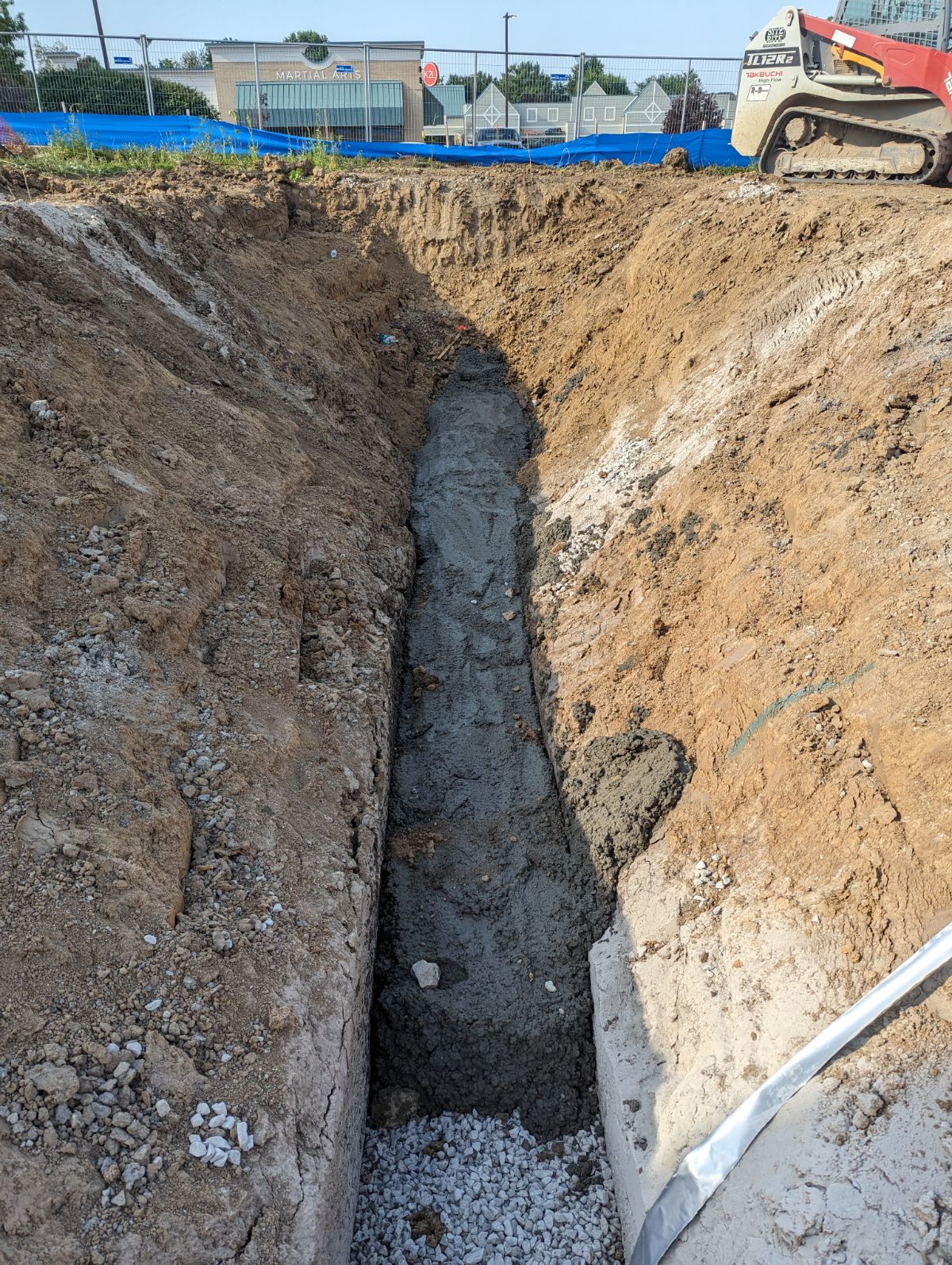

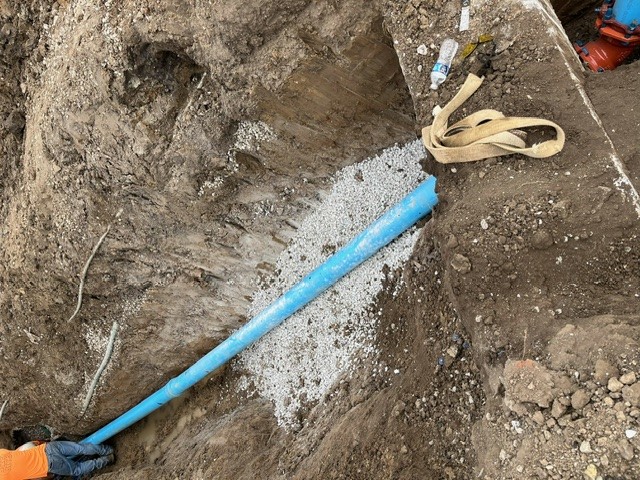

Water Line - Construction Inspection Partial 3/10/2023 03/10/2023
Misc
Informational
03/10/2023
3-10-23 RH. Spoke with Site Rite about water line consturciton. Copper will be used from main to the meter and copper going 10' out from the meter.

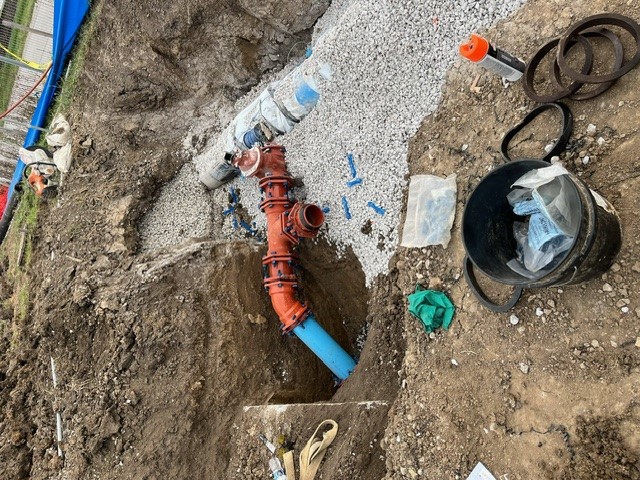

Water Service Inspection Partial 3/13/2023 3/13/2023 03/14/2023
Misc
Informational
03/14/2023
3-13-23 DP. Water dept. told contractor that they are going to sub out the water tap due to it being HDPE. The earliest they can do the tap now is Monday 3/21/23. I had the contractor come and cover the water main with concrete blankets since it will be exposed for so long.
Footing Inspection - Commercial Partial 3/15/2023 (8:00) 3/15/2023 03/15/2023
Misc
Corrective Action Required
03/07/2023
All grade beams and column pads approved to pour, except the retaining walls footing at line K/6-8 and at isolated SW retaining wall section
Site Visit Partial 3/15/2023 03/15/2023
Misc
Informational
03/09/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in.
Erosion Control Inspection Partial 3/17/2023 3/17/2023 03/17/2023
Misc
Informational
03/14/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison control is up and in working order. 2-2-23 PS Erosion control within compliance 2-6-22 RH. Erosion control is up and in working order. 2-13-23 RH. Erosion cotrol is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-6-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion control is up and in working order. 3-17-23 RH. Erosion control is in working order.
Water Line - Construction Inspection Partial 3/20/2023 03/20/2023
Misc
Informational
03/10/2023
3-10-23 RH. Spoke with Site Rite about water line consturciton. Copper will be used from main to the meter and copper going 10' out from the meter. 3-20-23 RH. Contractor ran fire line from slab down and under the footing toward the main. Ductile Iron was used pipe war wrapped and thrust block was poured. Flowable fill will be used around pipe to support footing.
Site Visit Partial 3/21/2023 3/21/2023 03/21/2023
Misc
Informational
03/15/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in.
Site Visit Partial 3/21/2023 3/21/2023 03/21/2023
Misc
Informational
03/21/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain.
Footing Inspection - Commercial Passed 3/21/2023 3/21/2023 03/21/2023
Misc
Resolved
03/21/2023
All grade beams and column pads approved to pour, except the retaining walls footing at line K/6-8 and at isolated SW retaining wall section
Erosion Control Inspection Partial 3/22/2023 3/22/2023 03/22/2023
Misc
Informational
03/17/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison control is up and in working order. 2-2-23 PS Erosion control within compliance 2-6-22 RH. Erosion control is up and in working order. 2-13-23 RH. Erosion cotrol is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-6-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order.
Water Line - Construction Inspection Passed 3/23/2023 3/23/2023 03/23/2023
Misc
Informational
03/20/2023
3-10-23 RH. Spoke with Site Rite about water line consturciton. Copper will be used from main to the meter and copper going 10' out from the meter. 3-20-23 RH. Contractor ran fire line from slab down and under the footing toward the main. Ductile Iron was used pipe war wrapped and thrust block was poured. Flowable fill will be used around pipe to support footing. 3-23-23 RH. Contractor is digging out for water service line today. They will place copper between meter and main then place coper to meter. 10-2-23 BR Contractor is digging out for water main and installed 6'' water fire line into the building. Fire hydrant and water meter for the island sprinkler system was remove from old location to new location. 10-4-23 BR Contractor performed hydrostatic test and pass to LS specification
Site Visit Partial 3/24/2023 3/24/2023 03/24/2023
Misc
Informational
03/21/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for develoment today.
Site Visit Partial 3/27/2023 3/27/2023 03/27/2023
Misc
Informational
03/24/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today.
Site Visit Partial 4/10/2023 03/30/2023
Misc
Informational
03/27/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. Now work being completed for development in the AM.
Underslab Electrical Inspection - Commercial Partial 3/30/2023 3/30/2023 03/30/2023
Misc
Informational
03/30/2023
Underslab electrical ok below: -under rm 111; lv under stair

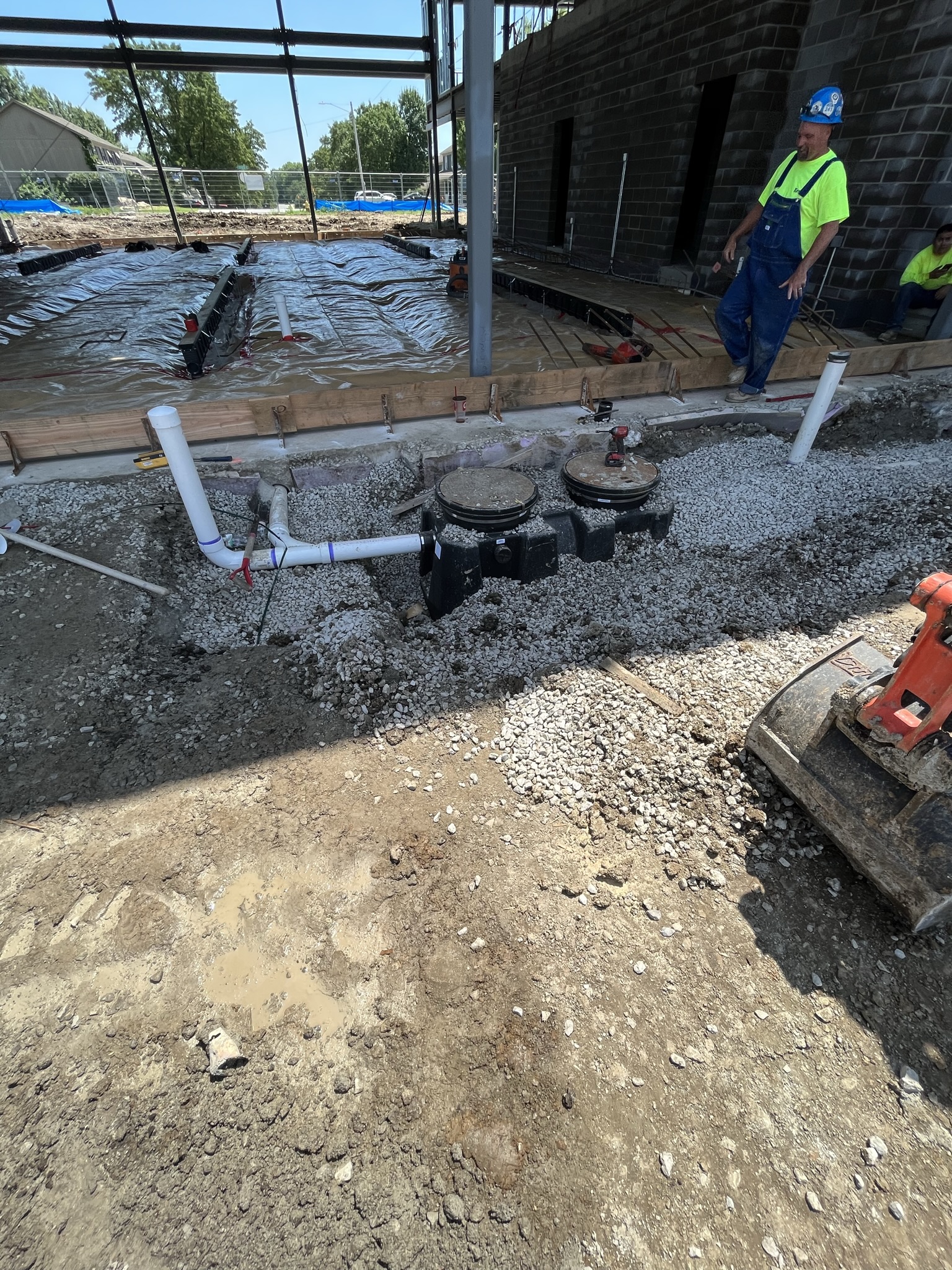

Underslab Plumbing Inspection - Commercial Partial 3/30/2023 3/30/2023 03/30/2023
Misc
Informational
03/30/2023
Underslab plumbing ok below: -Decon/restroom rm 112
Underslab Plumbing Inspection - Commercial Partial 3/31/2023 3/31/2023 03/31/2023
Misc
Informational
03/30/2023
Underslab plumbing ok below: -Decon/restroom rm 112; vehicle bay
Erosion Control Inspection Partial 4/3/2023 4/3/2023 04/03/2023
Misc
Informational
03/22/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison control is up and in working order. 2-2-23 PS Erosion control within compliance 2-6-22 RH. Erosion control is up and in working order. 2-13-23 RH. Erosion cotrol is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-6-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order.
Site Visit Partial 4/3/2023 4/3/2023 04/03/2023
Misc
Informational
03/30/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM.
Underslab Electrical Inspection - Commercial Partial 4/5/2023 04/05/2023
Misc
Informational
03/30/2023
Underslab electrical ok below: -under rm 111; lv under stair; utility&shop
Underslab Plumbing Inspection - Commercial Partial 4/5/2023 04/05/2023
Misc
Informational
03/31/2023
Underslab plumbing ok below: -Decon/restroom rm 112; building drain from utility->vehicle bay->near dining, including floor grade cleanout at east side of building

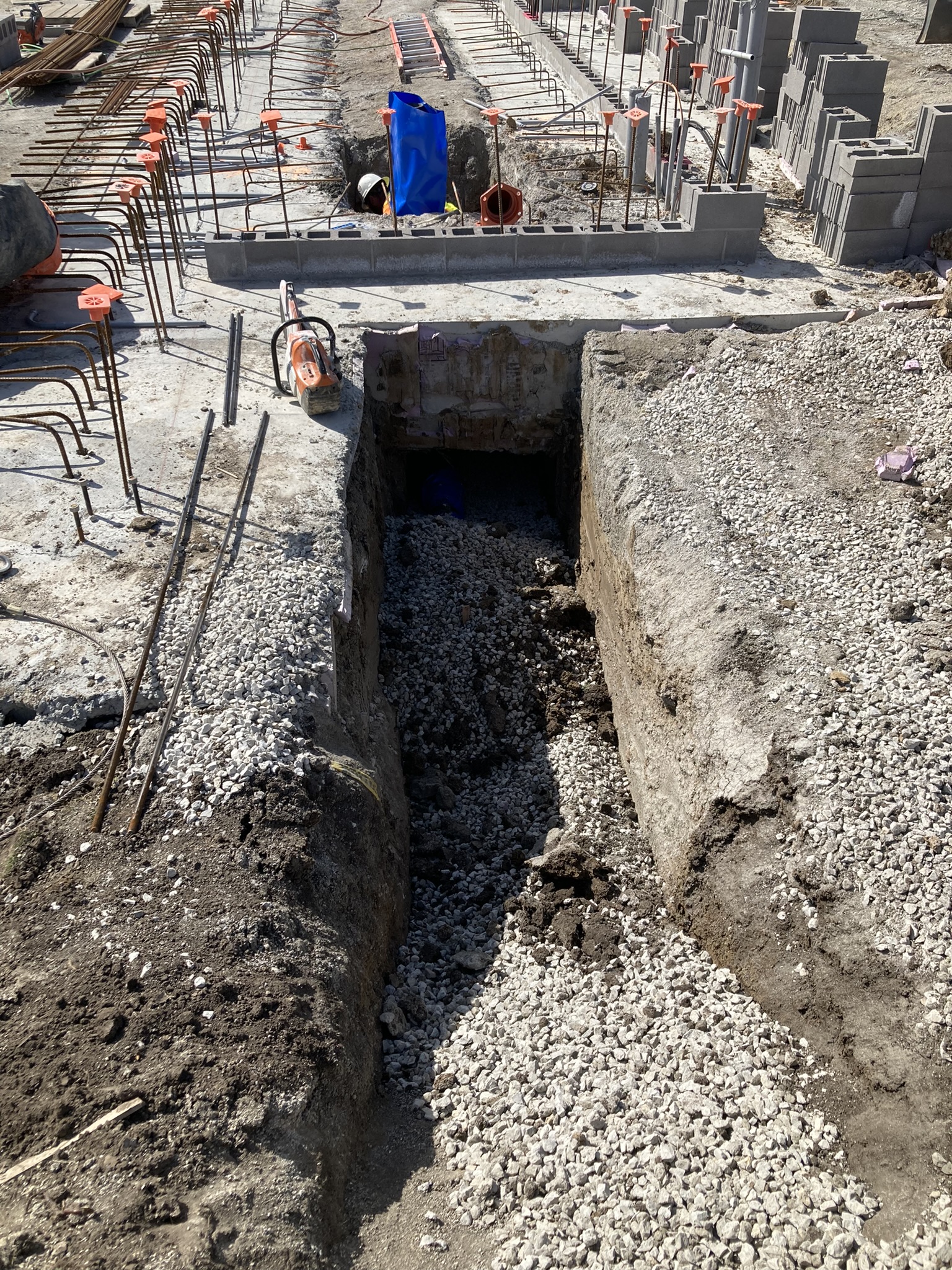

Foundation Inspection - Commercial Partial 4/5/2023 (11:30) 4/5/2023 04/05/2023
Misc
Informational
04/05/2023
Foundation wall OK: -Ramp walls and F.walls at SW corner of building
Site Visit Partial 4/10/2023 04/10/2023
Misc
Informational
04/03/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM.

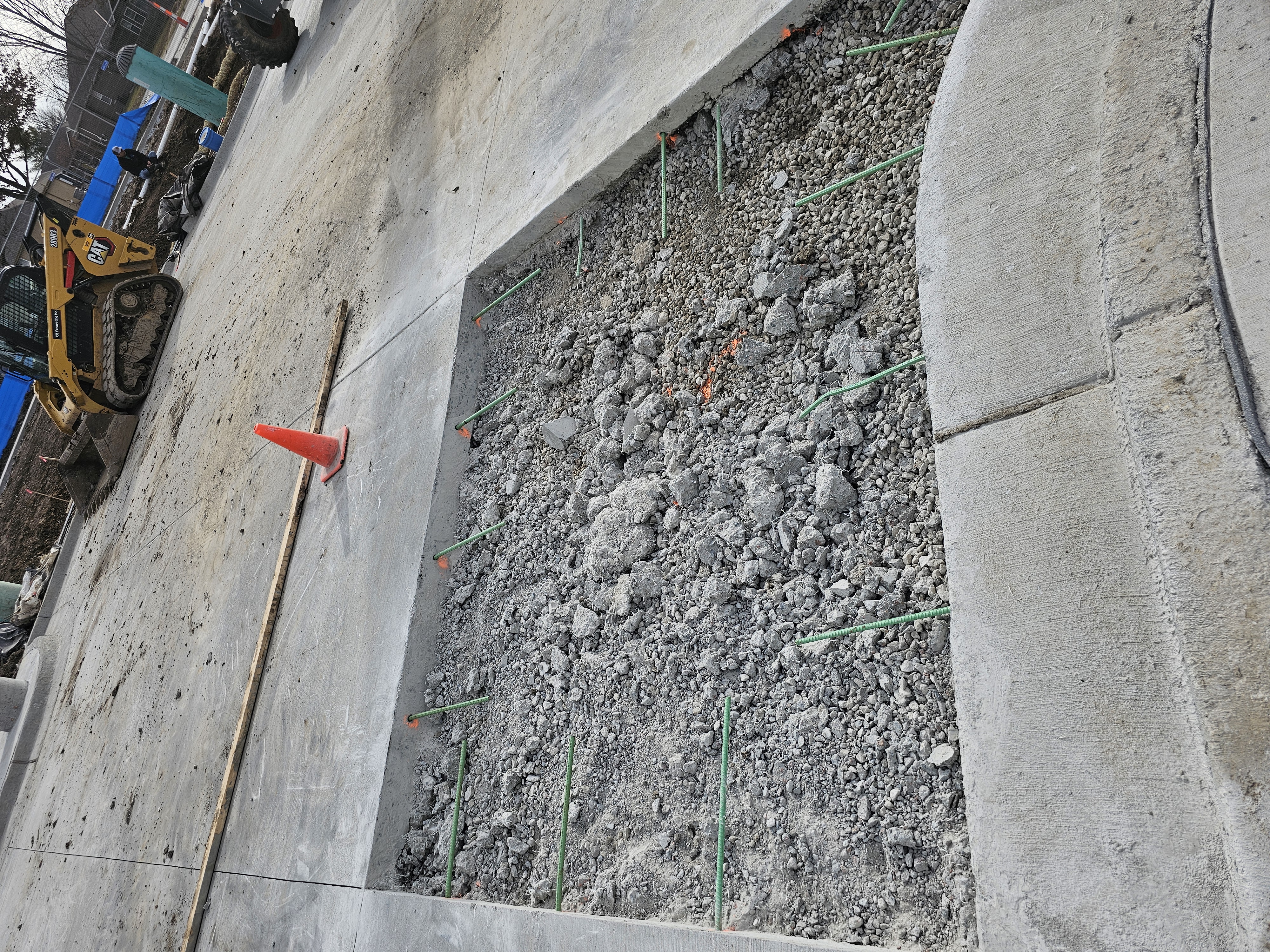

Sidewalk Inspection Partial 4/10/2023 04/10/2023
Site Visit Partial 4/11/2023 4/11/2023 04/11/2023
Misc
Informational
04/10/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM.
Site Visit Partial 4/12/2023 4/12/2023 04/12/2023
Misc
Informational
04/11/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No Work for devlopmnt in the AM.
Underslab Plumbing Inspection - Commercial Partial 4/12/2023 04/12/2023
Misc
Informational
04/05/2023
Underslab plumbing ok below: -Decon/restroom rm 112; building drain from utility->vehicle bay->near dining, including floor grade cleanout at east side of building; kitchen and restrooms
Underslab Plumbing Inspection - Commercial Passed 4/17/2023 4/17/2023 04/17/2023
Misc
Resolved
04/17/2023
Underslab plumbing ok below: -Decon/restroom rm 112; building drain from utility->vehicle bay->near dining, including floor grade cleanout at east side of building; kitchen and restrooms
Erosion Control Inspection Partial 4/18/2023 4/18/2023 04/18/2023
Misc
Informational
04/03/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison control is up and in working order. 2-2-23 PS Erosion control within compliance 2-6-22 RH. Erosion control is up and in working order. 2-13-23 RH. Erosion cotrol is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-6-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order. 4-18-23 RH. Erosion control is up and in working order. 8-14-23 BR Erosion control is up and working order
Site Visit Partial 4/19/2023 04/19/2023
Misc
Informational
04/12/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No work for development in the AM. 4-19-23 RH. No work for development in the AM.
Erosion Control Inspection Partial 4/20/2023 4/20/2023 04/20/2023
Misc
Informational
04/18/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison control is up and in working order. 2-2-23 PS Erosion control within compliance 2-6-22 RH. Erosion control is up and in working order. 2-13-23 RH. Erosion cotrol is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-6-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order. 4-18-23 RH. Erosion control is up and in working order. 4-20-23 RH. Erosion control is up and in working order.
Site Visit Partial 4/21/2023 4/21/2023 04/21/2023
Misc
Informational
04/19/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No work for development in the AM. 4-19-23 RH. No work for development in the AM. 4-21-23 RH. Masons are on site working on the building. No work for development in the AM.
Erosion Control Inspection Partial 4/24/2023 4/24/2023 04/24/2023
Misc
Informational
04/20/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison control is up and in working order. 2-2-23 PS Erosion control within compliance 2-6-22 RH. Erosion control is up and in working order. 2-13-23 RH. Erosion cotrol is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-6-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order. 4-18-23 RH. Erosion control is up and in working order. 4-20-23 RH. Erosion control is up and in working order. 4-24-23 RH. Erosion control is up and in working order.
Site Visit Partial 4/24/2023 4/24/2023 04/24/2023
Misc
Informational
04/21/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No work for development in the AM. 4-19-23 RH. No work for development in the AM. 4-21-23 RH. Masons are on site working on the building. No work for development in the AM. 4-24-23 RH. No work for development in the AM.
Suspended Slab Inspection Passed 4/24/2023 (8:00) 4/24/2023 04/24/2023
Site Visit Partial 4/25/2023 04/25/2023
Misc
Informational
04/24/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No work for development in the AM. 4-19-23 RH. No work for development in the AM. 4-21-23 RH. Masons are on site working on the building. No work for development in the AM. 4-24-23 RH. No work for development in the AM. 4-25-23 RH. No work for development in the AM.
Site Visit Partial 4/26/2023 4/26/2023 04/26/2023
Misc
Informational
04/25/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No work for development in the AM. 4-19-23 RH. No work for development in the AM. 4-21-23 RH. Masons are on site working on the building. No work for development in the AM. 4-24-23 RH. No work for development in the AM. 4-25-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM.
Underslab Electrical Inspection - Commercial Partial 4/26/2023 4/26/2023 04/26/2023
Misc
Informational
04/05/2023
Underslab electrical ok below: -under rm 111; lv under stair; utility&shop; ramp; conference room; day room; kitchen;
Footing Inspection - Commercial Passed 4/27/2023 (9:00) 4/27/2023 04/27/2023
Erosion Control Inspection Partial 5/1/2023 05/01/2023
Misc
Informational
04/24/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison control is up and in working order. 2-2-23 PS Erosion control within compliance 2-6-22 RH. Erosion control is up and in working order. 2-13-23 RH. Erosion cotrol is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-6-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order. 4-18-23 RH. Erosion control is up and in working order. 4-20-23 RH. Erosion control is up and in working order. 4-24-23 RH. Erosion control is up and in working order. 5-1-23 RH. Erosion Control is up and in working order.
Site Visit Partial 5/3/2023 5/3/2023 05/03/2023
Misc
Informational
04/26/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No work for development in the AM. 4-19-23 RH. No work for development in the AM. 4-21-23 RH. Masons are on site working on the building. No work for development in the AM. 4-24-23 RH. No work for development in the AM. 4-25-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM.
Site Visit Partial 5/5/2023 05/05/2023
Misc
Informational
05/03/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No work for development in the AM. 4-19-23 RH. No work for development in the AM. 4-21-23 RH. Masons are on site working on the building. No work for development in the AM. 4-24-23 RH. No work for development in the AM. 4-25-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM.
Site Visit Partial 5/10/2023 05/10/2023
Misc
Informational
05/05/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No work for development in the AM. 4-19-23 RH. No work for development in the AM. 4-21-23 RH. Masons are on site working on the building. No work for development in the AM. 4-24-23 RH. No work for development in the AM. 4-25-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM. 5-10-23 RH. No work for development in the AM.
Site Visit Partial 5/15/2023 05/15/2023
Misc
Informational
05/10/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No work for development in the AM. 4-19-23 RH. No work for development in the AM. 4-21-23 RH. Masons are on site working on the building. No work for development in the AM. 4-24-23 RH. No work for development in the AM. 4-25-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM. 5-10-23 RH. No work for development in the AM. 5-15-23 RH. No work for development in the AM.
Erosion Control Inspection Partial 5/15/2023 05/15/2023
Misc
Informational
05/01/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison control is up and in working order. 2-2-23 PS Erosion control within compliance 2-6-22 RH. Erosion control is up and in working order. 2-13-23 RH. Erosion cotrol is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-6-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order. 4-18-23 RH. Erosion control is up and in working order. 4-20-23 RH. Erosion control is up and in working order. 4-24-23 RH. Erosion control is up and in working order. 5-1-23 RH. Erosion Control is up and in working order. 5-15-23 RH. Erosion Control is up and in working order. 6-27-23 BR Erosion Control is up
Site Visit Partial 5/18/2023 05/18/2023
Misc
Informational
05/15/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No work for development in the AM. 4-19-23 RH. No work for development in the AM. 4-21-23 RH. Masons are on site working on the building. No work for development in the AM. 4-24-23 RH. No work for development in the AM. 4-25-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM. 5-10-23 RH. No work for development in the AM. 5-15-23 RH. No work for development in the AM. 5-18-23 RH. No work for development in the AM.
Site Visit Partial 5/19/2023 05/19/2023
Misc
Informational
05/18/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No work for development in the AM. 4-19-23 RH. No work for development in the AM. 4-21-23 RH. Masons are on site working on the building. No work for development in the AM. 4-24-23 RH. No work for development in the AM. 4-25-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM. 5-10-23 RH. No work for development in the AM. 5-15-23 RH. No work for development in the AM. 5-18-23 RH. No work for development in the AM. 5-19-23 RH. No work on site for development in the AM.
Erosion Control Inspection Partial 5/22/2023 05/22/2023
Misc
Informational
05/15/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison control is up and in working order. 2-2-23 PS Erosion control within compliance 2-6-22 RH. Erosion control is up and in working order. 2-13-23 RH. Erosion cotrol is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-6-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order. 4-18-23 RH. Erosion control is up and in working order. 4-20-23 RH. Erosion control is up and in working order. 4-24-23 RH. Erosion control is up and in working order. 5-1-23 RH. Erosion Control is up and in working order. 5-15-23 RH. Erosion Control is up and in working order. 5-22-23 RH. Erosion Control is up and in working order. 6-12-23 BR Erosion Control is up and in working order
Site Visit Partial 5/22/2023 05/22/2023
Misc
Informational
05/19/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No work for development in the AM. 4-19-23 RH. No work for development in the AM. 4-21-23 RH. Masons are on site working on the building. No work for development in the AM. 4-24-23 RH. No work for development in the AM. 4-25-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM. 5-10-23 RH. No work for development in the AM. 5-15-23 RH. No work for development in the AM. 5-18-23 RH. No work for development in the AM. 5-19-23 RH. No work on site for development in the AM. 5-22-23 RH. No work on site for development in the AM.
Erosion Control Inspection Partial 6/5/2023 6/5/2023 06/05/2023
Misc
Informational
05/22/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison control is up and in working order. 2-2-23 PS Erosion control within compliance 2-6-22 RH. Erosion control is up and in working order. 2-13-23 RH. Erosion cotrol is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-6-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order. 4-18-23 RH. Erosion control is up and in working order. 4-20-23 RH. Erosion control is up and in working order. 4-24-23 RH. Erosion control is up and in working order. 5-1-23 RH. Erosion Control is up and in working order. 5-15-23 RH. Erosion Control is up and in working order. 5-22-23 RH. Erosion Control is up and in working order. 6-5-23 BR Erosion control is up and working order. 6-12-23 BR Erosion Control is up and working order 6-19-23 BR Erosion Control is and working order 7-31-23 BR Erosion Control is up and working order 8-15-23 BR Erosion Control is up and working order 8-31-23 BR Erosion Control is up and working order 9-12-23 BR Erosion Control is up and working order 9-26-23 BR Erosion Control is up and working order 10-10-23 BR Erosion Control is up and working order 10-24-23 BR Erosion Control is up and working order 11-7-23 BR Erosion Control is up and working order 11-28-23 BR Erosion Control is up and working order 12-5-23 BR Erosion Control is up and working order
Miscellaneous Inspection Passed 6/7/2023 06/07/2023
Misc
Informational
06/07/2023
Site visit to discuss future inspections.
Site Visit Partial 6/8/2023 6/8/2023 06/08/2023
Misc
Informational
05/22/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No work for development in the AM. 4-19-23 RH. No work for development in the AM. 4-21-23 RH. Masons are on site working on the building. No work for development in the AM. 4-24-23 RH. No work for development in the AM. 4-25-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM. 5-10-23 RH. No work for development in the AM. 5-15-23 RH. No work for development in the AM. 5-18-23 RH. No work for development in the AM. 5-19-23 RH. No work on site for development in the AM. 5-22-23 RH. No work on site for development in the AM. 6-8-23 BR No work for development
Underslab Electrical Inspection - Commercial Partial 6/27/2023 06/27/2023
Misc
Informational
04/26/2023
Underslab electrical ok below: -under rm 111; lv under stair; utility&shop; ramp; conference room; day room; kitchen;west end garage bays
Underslab Electrical Inspection - Commercial Partial 6/27/2023 06/27/2023
Misc
Informational
06/27/2023
Underslab electrical ok below: -under rm 111; lv under stair; utility&shop; ramp; conference room; day room; kitchen;East end garage bays
Suspended Slab Inspection Passed 6/30/2023 6/30/2023 06/30/2023

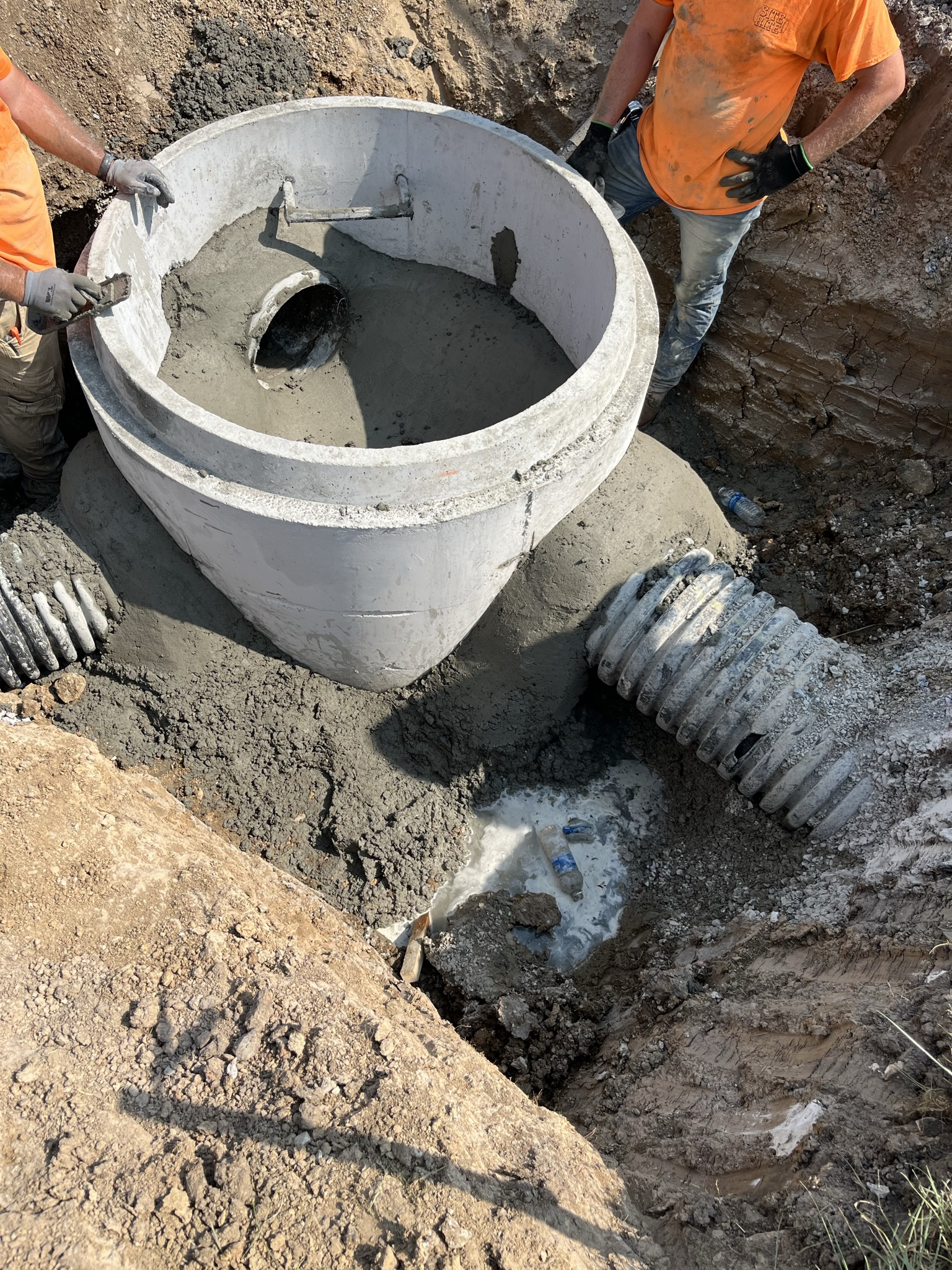

Sewer Service Inspection Partial 6/30/2023 06/30/2023
Misc
Informational
06/30/2023
6-30-23 BR 4' PVC was installed and concrete encasement was reinforced with rebar and poured.

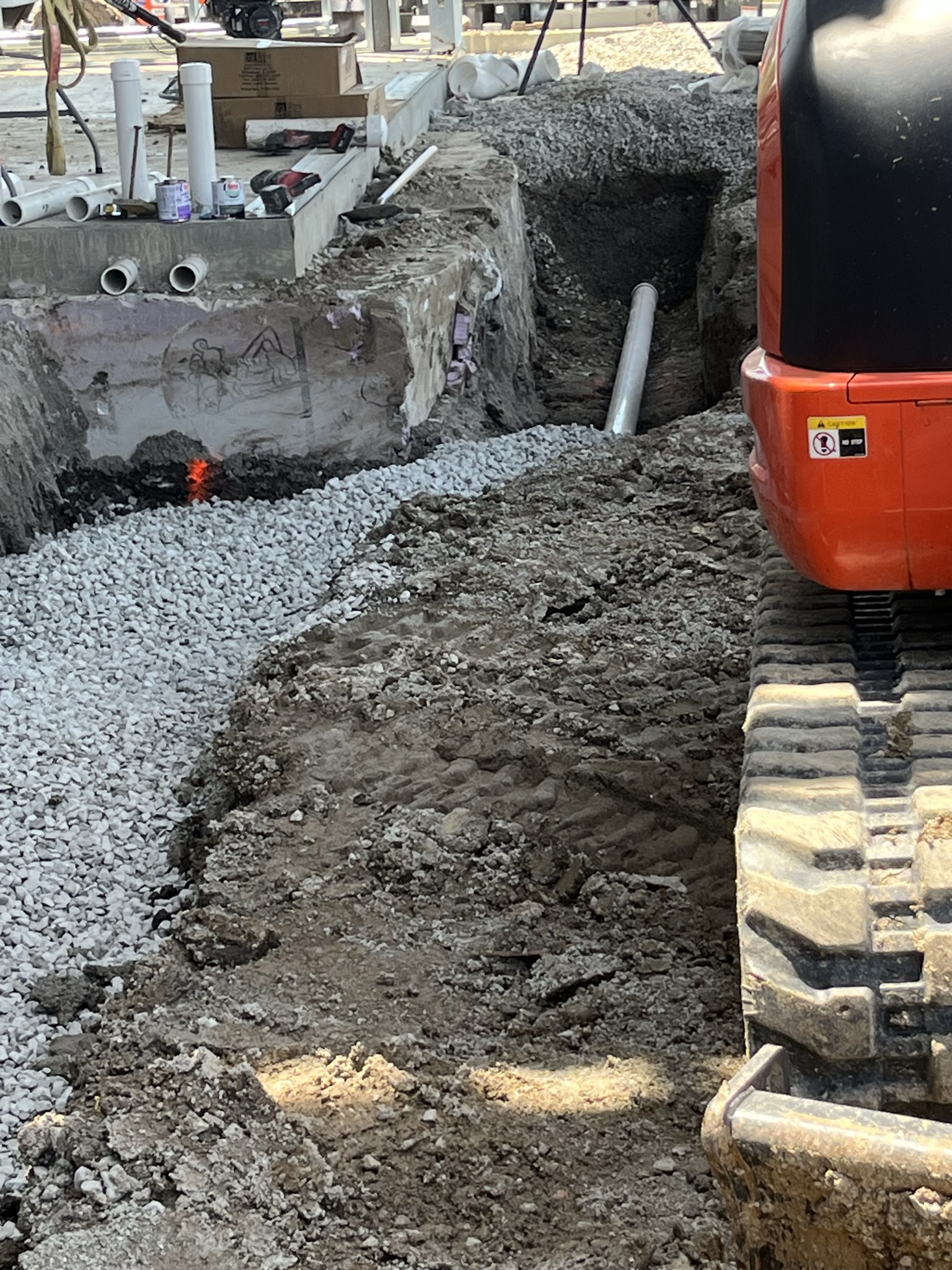

Storm Sewer Construction Inspection Partial 6/30/2023 06/30/2023
Misc
Informational
06/30/2023
6-30-23 BR 10' of storm sewer was installed 7-10-23 BR 100' of storm sewer was installed
Storm Sewer Construction Inspection Partial 7/11/2023 07/11/2023
Misc
Informational
06/30/2023
6-30-23 BR 10' of storm sewer was install on east side of building. 7-11-23 BR 60' of storm sewer was installed on east side as well 100' storm sewer was installed on the south side of the building. 7-17-23 BR Storm sewer was installed outlet structure and gutter from building was connected into storm sewer 7-20-23 BR Sand trap line was connected to storm sewer on west side of building. 8-29-23 BR 12'' storm sewer was in installation from new manhole 1000.JB to (1001. AI) 30'' inlet with dome grate. 8-31-23 BR 12'' Storm sewer was installed from (1001.AI) 30'' inlet with dome gate to(1003.CI) 2"x3" curb inlet.
Underslab Plumbing Inspection - Commercial Partial 7/13/2023 7/13/2023 07/13/2023
Misc
Informational
07/13/2023
Floor drains for garage bays. OK
Storm Sewer Construction Inspection Partial 7/20/2023 7/20/2023 07/20/2023
Misc
Informational
07/11/2023
6-30-23 BR 10' of storm sewer was install on east side of building. 7-11-23 BR 60' of storm sewer was installed on east side as well 100' storm sewer was installed on the south side of the building 7-20-23 BR Sand trap line on west side of building connect to storm sewer 8-29-23 BR 12'' storm sewer was in installation from new manhole 1000.JB to (1001. AI) 30'' inlet with dome grate. 8-31-23 BR 12'' Storm sewer was installed from (1001.AI) 30'' inlet with dome gate to(1003.CI) 2"x3" curb inlet.
Site Visit Partial 8/10/2023 8/10/2023 08/10/2023
Misc
Informational
06/08/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No work for development in the AM. 4-19-23 RH. No work for development in the AM. 4-21-23 RH. Masons are on site working on the building. No work for development in the AM. 4-24-23 RH. No work for development in the AM. 4-25-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM. 5-10-23 RH. No work for development in the AM. 5-15-23 RH. No work for development in the AM. 5-18-23 RH. No work for development in the AM. 5-19-23 RH. No work on site for development in the AM. 5-22-23 RH. No work on site for development in the AM. 6-8-23 BR No work for development 8-10-23 PS Contractor working on interior of building, no exterior work.
In-wall Inspection Partial 8/21/2023 8/21/2023 08/21/2023
Misc
Corrective Action Required
08/21/2023
Second floor only framing okay
Above Ceiling Inspection Partial 8/21/2023 8/21/2023 08/21/2023
Misc
Corrective Action Required
08/21/2023
Second floor only. Okay to install hard lid.
Footing Inspection - Commercial Passed 8/23/2023 8/23/2023 08/23/2023
Misc
Informational
08/23/2023
Addition for brick veneer
In-wall Inspection Failed 8/28/2023 8/28/2023 08/28/2023
Misc
Corrective Action Required
08/21/2023
-support boxes throughout -secure cable within 12” box throughout -complete ductwork 202 locker -complete plumbing in 203 -protect waterlines in 203 -protect water lines running through studs in 203 -plumbing in way of electrical box at sink 211
Storm Sewer Construction Inspection Passed 8/31/2023 8/31/2023 09/01/2023
Misc
Informational
07/20/2023
6-30-23 BR 10' of storm sewer was install on east side of building. 7-11-23 BR 60' of storm sewer was installed on east side as well 100' storm sewer was installed on the south side of the buildin 7-20-23 BR Sand trap line on west side of building connect to storm sewer 8-29-23 BR 12'' storm sewer was in installation from new manhole 1000.JB to (1001. AI) 30'' inlet with dome grate. 8-31-23 BR 12'' Storm sewer was installed from (1001.AI) 30'' inlet with dome gate to(1003.CI) 2"x3" curb inlet. 9-1-23 BR 12'' Storm sewer was istalled from (1003.CI) 2''x3'' curb inlet to (1004.CI) 2''x3'' curb inlet
In-wall Inspection Partial 9/7/2023 9/7/2023 09/07/2023
Misc
Corrective Action Required
08/28/2023
2nd floor only -complete plumbing in 203 N area
In-wall Inspection Partial 9/18/2023 9/18/2023 09/18/2023
Misc
Corrective Action Required
09/07/2023
1st floor inspected 2nd floor only -complete plumbing in 203 N area
Corrective Action Required
09/18/2023
Above Ceiling Inspection Failed 9/27/2023 9/27/2023 09/27/2023
Misc
Corrective Action Required
08/21/2023
Second floor bath only. Install bath vents
Above Ceiling Inspection Partial 10/11/2023 10/11/2023 10/11/2023
Misc
Corrective Action Required
09/27/2023
Second floor bath only. Install bath vents
Misc
Corrective Action Required
10/11/2023
First floor Inspected. -dayroom border of drop ceiling -bathrooms -conference room border of drop ceiling -captain office border of drop ceiling -covered patio on W side -east patio/entrance -water lines in inspected areas to be insulated 10/11/23 Mitchell Schwarz
Site Visit Partial 10/12/2023 10/12/2023 10/12/2023
Misc
Informational
08/10/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No work for development in the AM. 4-19-23 RH. No work for development in the AM. 4-21-23 RH. Masons are on site working on the building. No work for development in the AM. 4-24-23 RH. No work for development in the AM. 4-25-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM. 5-10-23 RH. No work for development in the AM. 5-15-23 RH. No work for development in the AM. 5-18-23 RH. No work for development in the AM. 5-19-23 RH. No work on site for development in the AM. 5-22-23 RH. No work on site for development in the AM. 6-8-23 BR No work for development 8-10-23 PS Contractor working on interior of building, no exterior work. 10-12-23 PS No work for development today
Above Ceiling Inspection Failed 10/13/2023 10/13/2023
Misc
Corrective Action Required
10/11/2023
Second floor bath only. Install bath vents
Misc
Corrective Action Required
10/11/2023
First floor Inspected. -dayroom border of drop ceiling -bathrooms -conference room border of drop ceiling -captain office border of drop ceiling -covered patio on W side -east patio/entrance -water lines in inspected areas to be insulated -secure MC within 12” of boxes -S most bathroom sprinkler to be completed -S most bathroom duct work completed 10/11/23 Mitchell Schwarz
Above Ceiling Inspection Failed 10/16/2023 10/16/2023 10/16/2023
Misc
Corrective Action Required
10/13/2023
Second floor bath only. Install bath vents
Misc
Corrective Action Required
10/13/2023
First floor Inspected. -dayroom border of drop ceiling -bathrooms -conference room border of drop ceiling -captain office border of drop ceiling -covered patio on W side -east patio/entrance -secure MC within 12” of boxes 10/11/23 Mitchell Schwarz
Underground Electrical Inspection - Commercial Partial 10/18/2023 10/18/2023 10/18/2023
Miscellaneous Correction
Informational
10/18/2023
Underground for the generator passed. Underground from the transformer to the generator passed.
Water Line - Hydrostatic Test Passed 10/4/2023 10/4/2023 10/25/2023
Misc
Informational
10/25/2023

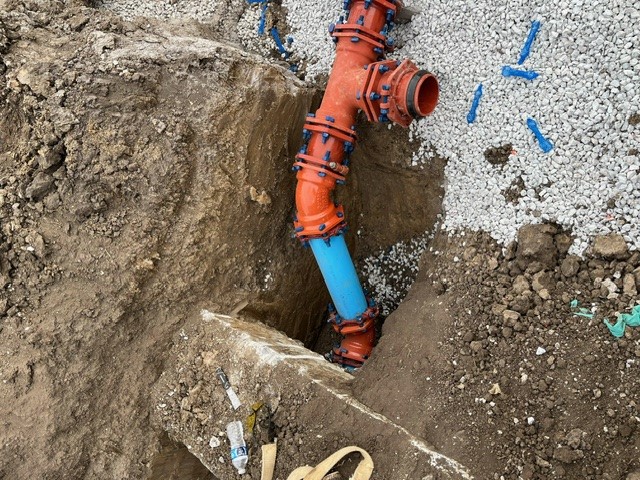

10-4-23 BR Contractor did hydrostatic test on the water at 150 psi for 2hr. which passes.

Pavement-Stabilized Subgrade Partial 10/23/2023 10/23/2023 10/30/2023
Misc
Informational
10/30/2023
10-23-23 BR Contractor remove existing curb on south west side of property next to scooters. Also they started grading on driveway and approach. 11-13-23 BR Contractor poured driveway approach to LS specifications.
Pavement-Curb Construction Partial 11/3/2023 11/03/2023
Misc
Informational
11/03/2023
11-1-23 BR Contractor tore out existing curb on west side of building. 11-2-23 BR Contractor formed up driveway curbs plus approach along with the curbs on the west side of building. 11-30-23 BR Contractor pour curbs around building to LS specifications. 12-15-23 BR Contractor pour the reminder of curbs around the building and driveway approach curbs to LS specifications.
Rated Assembly Inspection Partial 11/6/2023 11/6/2023 11/06/2023
Misc
Corrective Action Required
11/06/2023
Submit new UL detail for stair walls First layer, screw pattern walls under stairs
Rated Assembly Inspection Partial 11/8/2023 11/08/2023
Misc
Corrective Action Required
11/06/2023
First layer, screw pattern walls under stairs Fire caulking directly under stairs

Sidewalk Inspection Partial 11/8/2023 11/8/2023 11/08/2023
Misc
Informational
11/08/2023
11-7-23 BR Contractor formed sidewalk entrance and ADA ramp up and aggregate is place plus compacted ready for concrete. 11-8-23 BR Entrance sidewalk and ADA ramp is concrete to specifications.
Above Ceiling Inspection Partial 11/14/2023 11/14/2023
Misc
Corrective Action Required
10/16/2023
Second floor bath only. Install bath vents
Misc
Corrective Action Required
10/16/2023
First floor Inspected. -dayroom border of drop ceiling -bathrooms -conference room border of drop ceiling -captain office border of drop ceiling -covered patio on W side -east patio/entrance -secure MC within 12” of boxes 10/11/23 Mitchell Schwarz
Misc
Informational
11/14/2023
Under stairs okay to first layer rock
Rated Assembly Inspection Partial 11/15/2023 11/15/2023 11/15/2023
Misc
Corrective Action Required
11/08/2023
First layer, screw pattern walls under stairs Fire caulking directly under stairs 1st and 2nd layer under stairs ceiling
Rated Assembly Inspection Partial 11/17/2023 11/17/2023
Misc
Corrective Action Required
11/15/2023
First layer, screw pattern walls under stairs Fire caulking directly under stairs 1st, 2nd and 3rd layer under stairs ceiling
Site Visit Partial 11/20/2023 11/20/2023
Misc
Informational
10/12/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No work for development in the AM. 4-19-23 RH. No work for development in the AM. 4-21-23 RH. Masons are on site working on the building. No work for development in the AM. 4-24-23 RH. No work for development in the AM. 4-25-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM. 5-10-23 RH. No work for development in the AM. 5-15-23 RH. No work for development in the AM. 5-18-23 RH. No work for development in the AM. 5-19-23 RH. No work on site for development in the AM. 5-22-23 RH. No work on site for development in the AM. 6-8-23 BR No work for development 8-10-23 PS Contractor working on interior of building, no exterior work. 10-12-23 PS No work for development today 11-20-23 Dustin A, Called to look at the east side of building for possible pour. Informed super that is was to wet due to it raining all day. Also suggested a possible proof roll for later this week. 11-23-23 Dustin A, Went out to look at pre pour with RH, After inspecting we determined that DW is approved to pour 12-11-23 Dustin A, No activity on site for us. 12-21-23 Dustin A, sidewalk prep . working on storm drain basin
Gas Service Inspection - Commercial Passed 11/29/2023 11/29/2023 11/29/2023
Electrical Service Inspection Failed 11/29/2023 11/29/2023 11/29/2023
Misc
Corrective Action Required
11/29/2023
not ready for inspection
Underground Electrical Inspection - Commercial Partial 11/29/2023 11/29/2023
Miscellaneous Correction
Informational
10/18/2023
Underground for the generator passed. Underground from the transformer to the generator passed. under ground electrical for light poles S side of building.
Electrical Service Inspection Failed 12/4/2023 12/4/2023 12/04/2023
Misc
Corrective Action Required
11/29/2023
-provide 3/0 copper main bonding jumper from bus connected to the grounding electrode conductor to the service grounded bus bar
Pavement-Aggregate Base Partial 12/5/2023 12/05/2023
Misc
Informational
12/05/2023
11-5-23 BR Contractor started demolition on existing driveway approach on the south side of building. Also, contractor is building the parking lot base and placing aggregate and compaction.
Pavement-Proof Roll Partial 12/6/2023 12/06/2023
Misc
Informational
12/06/2023
12-6-23 BR Contractor preformed a poof roll on the parking lot on the south side of the building. There is a section on the south side of the parking lot where vehicle will be parking that needs to be compacted more. Also 20' of the driveway approach by the entrance of the rear garage doors into the building was poof roll as well. 12-7-23 BR Contractor corrected the section on the south side of the parking lot and now ready for concrete.
Electrical Service Inspection Passed 12/7/2023 12/7/2023 12/07/2023
Misc
Resolved
12/07/2023
-provide 3/0 copper main bonding jumper from bus connected to the grounding electrode conductor to the service grounded bus bar
Pavement-Surface Partial 12/8/2023 12/08/2023
Misc
Informational
12/08/2023
12-8-23 BR Contractor started pouring concrete parking lot stalls and 30' of driveway by the garage doors. Had to stop contractor from pouring do to weather. 12-12-23 PS Contractor pouring concrete at trash enclosure and pavement just on the west side of building near fire truck bay doors 12-14-23 BR Contractor pouring remainder of parking lot stall and parking lot entrance on the west side of building next to scooters parking lot. Also pour the remainder portion from trash enclosure to mid driveway approach entrance. 12-19-23 BR Contractor pouring remainder of parking lot and approach entrance.
Pavement-Surface Partial 12/12/2023 12/12/2023 12/12/2023
Misc
Informational
12/08/2023
12-8-23 BR Contractor started pouring concrete parking lot stalls and 30' of driveway by the garage doors. Had to stop contractor from pouring do to weather. 12-12-23 PS Contractor pouring concrete at trash enclosure and pavement just on the west side of building near fire truck bay doors 12-14-23 BR Contractor pouring remainder of parking lot stall and parking lot entrance on the west side of building next to scooters parking lot. Also pour the remainder portion from trash enclosure to mid driveway approach entrance. 12-19-23 BR Contractor pouring remainder of parking lot and approach entrance.
Above Ceiling Inspection Failed 12/12/2023 12/12/2023
Misc
Corrective Action Required
11/14/2023
Second floor bath only. Install bath vents
Misc
Corrective Action Required
11/14/2023
First floor Inspected. -dayroom border of drop ceiling -bathrooms -conference room border of drop ceiling -captain office border of drop ceiling -covered patio on W side -east patio/entrance -secure MC within 12” of boxes 10/11/23 Mitchell Schwarz
Misc
Informational
11/14/2023
-203 to be completed -202 secure conduit with in 12” of box -east end of hall to be completed -support mc at E fire pole -213 close boxes and fill unused knockout. -212 okay -211 okay -210 okay -209 okay -205 complete duct work -207 to be completed -208 okay -hall duct work To be seal
Pavement-Surface Partial 12/12/2023 12/12/2023 12/12/2023
Misc
Informational
12/12/2023
12-8-23 BR Contractor started pouring concrete parking lot stalls and 30' of driveway by the garage doors. Had to stop contractor from pouring do to weather. 12-12-23 PS Contractor pouring concrete at trash enclosure and pavement just on the west side of building near fire truck bay doors. PM Contractor poured concrete at south side of building
Rated Assembly Inspection Partial 12/20/2023 12/20/2023 12/19/2023
Misc
Corrective Action Required
11/17/2023
First layer, screw pattern walls under stairs Fire caulking directly under stairs 1st, 2nd and 3rd layer under stairs ceiling SUBMIT UL LISTING DESGIN FOR ELEVATOR
Rated Assembly Inspection Partial 12/22/2023 12/22/2023 12/22/2023
Misc
Corrective Action Required
12/19/2023
First layer, screw pattern walls under stairs Fire caulking directly under stairs 1st, 2nd and 3rd layer under stairs ceiling 1st layer elevator
Underground Electrical Inspection - Commercial Partial 12/22/2023 12/22/2023 12/22/2023
Miscellaneous Correction
Informational
11/29/2023
Inspected areas Underground for the generator passed. Underground from the transformer to the generator passed. underground conduit for light poles S side of building. Underground conduit for non permanent power
Rated Assembly Inspection Partial 12/28/2023 12/28/2023 12/28/2023
Misc
Corrective Action Required
12/22/2023
First layer, screw pattern walls under stairs Fire caulking directly under stairs 1st, 2nd and 3rd layer under stairs ceiling 1st layer elevator **Correction: Face layer of elevator wall-mud&tape gaps
Above Ceiling Inspection Partial 12/29/2023 12/29/2023 12/29/2023
Misc
Corrective Action Required
12/12/2023
Second floor bath only. Install bath vents
Misc
Corrective Action Required
12/12/2023
First floor Inspected. -dayroom border of drop ceiling -bathrooms -conference room border of drop ceiling -captain office border of drop ceiling -covered patio on W side -east patio/entrance -secure MC within 12” of boxes 10/11/23 Mitchell Schwarz
Misc
Informational
12/12/2023
-203 to be completed -202 secure conduit with in 12” of box -east end of hall to be completed -support mc at E fire pole -213 close boxes and fill unused knockout. -212 okay -211 okay -210 okay -209 okay -205 complete duct work -207 to be completed -208 okay -hall duct work To be seal -ceiling space above stair ok
Retention Basin Partial 1/3/2024 1/3/2024 01/03/2024
Misc
Informational
01/03/2024
1-3-24 Dustin A, Basin 1 is installed Per plans . Approved to backfill. Basin 2 Still Needs some work done
Site Visit Partial 1/3/2024 1/3/2024 01/03/2024
Misc
Informational
11/20/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No work for development in the AM. 4-19-23 RH. No work for development in the AM. 4-21-23 RH. Masons are on site working on the building. No work for development in the AM. 4-24-23 RH. No work for development in the AM. 4-25-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM. 5-10-23 RH. No work for development in the AM. 5-15-23 RH. No work for development in the AM. 5-18-23 RH. No work for development in the AM. 5-19-23 RH. No work on site for development in the AM. 5-22-23 RH. No work on site for development in the AM. 6-8-23 BR No work for development 8-10-23 PS Contractor working on interior of building, no exterior work. 10-12-23 PS No work for development today 10-20-23 Dustin A, Called to look at the east side of building for possible pour. Informed super that is was to wet due to it raining all day. Also suggested a possible proof roll for later this week. 12-28-23 Dustin A, Contractors working on detention pond. 12-29-23 Dustin A, No activity today for our department.
Misc
Informational
01/02/2024
1-2-24 DP. No work for development today. Mike did mention that the plan is for the sidewalk crew to come form and pour public sidewalk on thursday of this week. He mentioned that they knew to bring blankets. 1-3-24 Dustin A, no activity for us today
Site Visit Partial 1/4/2024 1/4/2024 01/04/2024
Misc
Informational
01/02/2024
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No work for development in the AM. 4-19-23 RH. No work for development in the AM. 4-21-23 RH. Masons are on site working on the building. No work for development in the AM. 4-24-23 RH. No work for development in the AM. 4-25-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM. 5-10-23 RH. No work for development in the AM. 5-15-23 RH. No work for development in the AM. 5-18-23 RH. No work for development in the AM. 5-19-23 RH. No work on site for development in the AM. 5-22-23 RH. No work on site for development in the AM. 6-8-23 BR No work for development 8-10-23 PS Contractor working on interior of building, no exterior work. 10-12-23 PS No work for development today 10-20-23 Dustin A, Called to look at the east side of building for possible pour. Informed super that is was to wet due to it raining all day. Also suggested a possible proof roll for later this week. 12-28-23 Dustin A, Contractors working on detention pond. 12-29-23 Dustin A, No activity today for our department.
Misc
Informational
01/02/2024
1-2-24 DP. No work for development today. Mike did mention that the plan is for the sidewalk crew to come form and pour public sidewalk on thursday of this week. He mentioned that they knew to bring blankets. 1-4-24 Dustin A, No work for us being done 1-8-24 Dustin A, no work due to weather 1-16-24 Dustin A, No activity due to weather 1-17-24 Dustin A, No outside work being done. 1-18-24 Dustin A, Conditions have not changed, nobody is performing work for our department. 1-19-23 Dustin A, No activity today due to frigid temperatures. 1-23-24 Dustin A, Met with mike to discuss pouring concrete maybe next week. Just prep work being done 1-25-24 Dustin A, Forming sidewalk near south entrance , Tearing out a cracked section. Lookin so pour some sidewalk tomorrow at 9 am 1-29-24 Dustin A, Informed concrete contractor that a valve in SW will need to be lowered due to being a trip hazard.
Piers/Caissons Inspection - Commercial Partial 1/5/2024 1/5/2024 01/05/2024
Misc
Informational
01/05/2024
3 light pole bases inspected
Underground Electrical Inspection - Commercial Partial 1/5/2024 01/05/2024
Miscellaneous Correction
Informational
12/22/2023
Inspected areas Underground for the generator passed. Underground from the transformer to the generator passed. underground conduit for light poles S side of building. Underground conduit for non permanent power Underground conduit between both West most light pole bases
Sidewalk Inspection Partial 1/11/2024 1/11/2024 01/11/2024
Misc
Informational
11/08/2023
11-7-23 BR Contractor formed sidewalk entrance and ADA ramp up and aggregate is place plus compacted ready for concrete. 11-8-23 BR Entrance sidewalk and ADA ramp is concrete to specifications. 1-11-23 PS Checked surface temps for public sidewalks below blankets, subgrade surface below freezing. Not approved for pour. Recall when conditions improve
Retention Basin Partial 1/31/2024 1/31/2024 01/31/2024
Misc
Informational
01/03/2024
1-3-24 Dustin A, Basin 1 is installed Per plans . Approved to backfill. Basin 2 Still Needs some work done 1-31-24 Dustin A, Cleaning basin of debris, working on backfilling
Above Ceiling Inspection Failed 2/1/2024 2/1/2024 02/01/2024
Misc
Corrective Action Required
12/29/2023
Second floor bath only. Install bath vents
Misc
Corrective Action Required
12/29/2023
First floor -Complete day room -Complete hallway -gym full unused MC connection at box Inspected. -dayroom border of drop ceiling okay -bathrooms okay -conference room border of drop ceiling okay -captain office border of drop ceiling okay -covered patio on W side okay -east patio/entrance okay -conference room okay
Misc
Informational
12/29/2023
2nd floor -203 to be completed -202 okay -hall okay -213 close boxes and fill unused knockout. -212 okay -211 okay -210 okay -209 okay -205 okay -207 to be completed -208 okay -hall duct work To be seal -ceiling space above stair ok
Retention Basin Partial 2/2/2024 2/2/2024 02/02/2024
Misc
Informational
01/31/2024
1-3-24 Dustin A, Basin 1 is installed Per plans . Approved to backfill. Basin 2 Still Needs some work done 1-31-24 Dustin A, Cleaning basin of debris, working on backfilling 2-2-24 Dustin A, East retention pond is ready for backfilled.
Above Ceiling Inspection Not Ready 2/2/2024 2/2/2024 02/02/2024
Misc
Corrective Action Required
02/01/2024
Second floor bath only. Install bath vents
Misc
Corrective Action Required
02/01/2024
Remove drop ceiling tiles for inspection First floor -Complete day room -Complete hallway -gym full unused MC connection at box Inspected. -dayroom border of drop ceiling okay -bathrooms okay -conference room border of drop ceiling okay -captain office border of drop ceiling okay -covered patio on W side okay -east patio/entrance okay -conference room okay
Misc
Informational
02/01/2024
Remove drop ceiling tiles for inspection 2nd floor -203 to be completed -202 okay -hall okay -213 close boxes and fill unused knockout. -212 okay -211 okay -210 okay -209 okay -205 okay -207 to be completed -208 okay -hall duct work To be seal -ceiling space above stair ok
Above Ceiling Inspection Partial 2/5/2024 2/5/2024 02/05/2024
Misc
Resolved
02/05/2024
Second floor bath only. Install bath vents
Misc
Informational
02/05/2024
First floor -day room okay - hallway okay -gym okay -bathrooms okay -conference room okay -captain office okay -covered patio on W side okay -east patio/entrance okay -conference room okay 2nd floor -203 okay -202 okay -hall okay -213 okay -212 okay -211 okay -210 okay -209 okay -205 okay -207 okay -208 okay -ceiling space above stair ok
Misc
Resolved
02/05/2024
Remove drop ceiling tiles for inspection 2nd floor -203 to be completed -202 okay -hall okay -213 close boxes and fill unused knockout. -212 okay -211 okay -210 okay -209 okay -205 okay -207 to be completed -208 okay -hall duct work To be seal -ceiling space above stair ok
Pavement-Surface Partial 2/7/2024 02/07/2024
Misc
Informational
12/12/2023
12-8-23 BR Contractor started pouring concrete parking lot stalls and 30' of driveway by the garage doors. Had to stop contractor from pouring do to weather. 12-12-23 PS Contractor pouring concrete at trash enclosure and pavement just on the west side of building near fire truck bay doors. PM Contractor poured concrete at south side of building 2-2-24 Dustin A, Contractor breaking up and replacing cracked panels and curbs 2-7-24 Dustin A, All Panels have been replaced.
Sidewalk Inspection Failed 1/26/2024 1/26/2024 02/07/2024
Misc
Informational
01/11/2024
11-7-23 BR Contractor formed sidewalk entrance and ADA ramp up and aggregate is place plus compacted ready for concrete. 11-8-23 BR Entrance sidewalk and ADA ramp is concrete to specifications. 1-11-23 PS Checked surface temps for public sidewalks below blankets, subgrade surface below freezing. Not approved for pour. Recall when conditions improve 1-25-24 Dustin A, Inspected the Sw near south side door, Approved to pour, 1-29-24 Dustin A , Inspected what's been poured so far. A top hat for a valve is to high in ADA ramp. Informed contractor its a trip hazard and will need to be fixed. 1-30-24 Dustin A, The rest of the SW is formed and meets city specs , approved to pour. 2-7-24 Dustin A, Sw is poured. There is a cracked panel that will need to be replaced.
Retention Basin Partial 2/9/2024 2/9/2024 02/09/2024
Misc
Informational
02/02/2024
1-3-24 Dustin A, Basin 1 is installed Per plans . Approved to backfill. Basin 2 Still Needs some work done 1-31-24 Dustin A, Cleaning basin of debris, working on backfilling 2-2-24 Dustin A, East retention pond is ready for backfilled. 2-9-24 Dustin A, East retention is finished
Alarm Test Passed 2/12/2024 02/12/2024
Sprinkler - Hydrostatic Test Passed 2/12/2024 02/12/2024
Sprinkler - Flow Test Passed 2/12/2024 02/12/2024
Above Ceiling Inspection Passed 2/13/2024 02/13/2024
Misc
Informational
02/05/2024
First floor -day room okay - hallway okay -gym okay -bathrooms okay -conference room okay -captain office okay -covered patio on W side okay -east patio/entrance okay -conference room okay 2nd floor -203 okay -202 okay -hall okay -213 okay -212 okay -211 okay -210 okay -209 okay -205 okay -207 okay -208 okay -ceiling space above stair ok
In-wall Inspection Passed 2/13/2024 02/13/2024
Occupancy Inspection - Engineering Temporary C of O 2/14/2024 2/14/2024 02/14/2024
Misc
Informational
02/14/2024
2-14-24 Dustin A, Everything for Temp C of O has passed PUNCHLIST: Cracked sidewalk Vegetation Final grading Cut valves down to grade Attach driveway to public road on SW Lemans Ln to be completed by 3-1-24
Occupancy Inspection - Planning Temporary C of O 2/14/2024 2/14/2024 02/14/2024
Corrective Action Required
02/14/2024
Vegetative screening remains to be installed around the ground mounted generator. Please install the screening accordance with the approved landscaping plan.
Corrective Action Required
02/14/2024
At the time of inspection sod was still being installed. Please complete the sod install as depicted on the approved landscaping plan.
Corrective Action Required
02/14/2024
Trash enclosure gates shall be painted to be compatible with the color of the enclosure walls or building it is to serve. Please paint the trash enclosure gates in accordance with the UDO standards.
Underground Electrical Inspection - Commercial Passed 2/14/2024 02/14/2024
Miscellaneous Correction
Informational
01/05/2024
Inspected areas Underground for the generator passed. Underground from the transformer to the generator passed. underground conduit for light poles S side of building. Underground conduit for non permanent power Underground conduit between both West most light pole bases
Piers/Caissons Inspection - Commercial Passed 2/14/2024 02/14/2024
Misc
Informational
01/05/2024
3 light pole bases inspected
Rated Assembly Inspection Passed 2/14/2024 02/14/2024
Misc
Corrective Action Required
12/28/2023
First layer, screw pattern walls under stairs Fire caulking directly under stairs 1st, 2nd and 3rd layer under stairs ceiling 1st layer elevator **Correction: Face layer of elevator wall-mud&tape gaps
Underslab Plumbing Inspection - Commercial Passed 2/14/2024 02/14/2024
Misc
Informational
07/13/2023
Floor drains for garage bays. OK
Underslab Electrical Inspection - Commercial Passed 2/14/2024 02/14/2024
Misc
Informational
06/27/2023
Underslab electrical ok below: -under rm 111; lv under stair; utility&shop; ramp; conference room; day room; kitchen;East end garage bays
Foundation Inspection - Commercial Passed 2/14/2024 02/14/2024
Misc
Informational
04/05/2023
Foundation wall OK: -Ramp walls and F.walls at SW corner of building
Occupancy Inspection - Codes Commercial Failed 2/14/2024 2/14/2024 02/14/2024
Misc
Corrective Action Required
02/14/2024
-paint exterior gas line -uncover sprinkler heads in locker room and locker wash room -be sure all locker room outlets to be GFCI protected -outlets within 6’ of “boot wash station” to be GFCI protected -GFCI protection for outlets in garage area -seal penetrations from 1st floor to 2nd floor for dryer vent above locker wash room - kitchen island outlets not working correctly or tripping -all kitchen outlets to be GFCI protected -protect plumbing under sink in accessible bathrooms -seal all raceways in rated area under stairs -missing knock out in electrical box under stairs -backflow device At ice machine -GFCI protection in laundry 2nd floor within 6’ of sink -secure RTU conduit in place -outlets at RTU’s not working at time of inspection -lable all RTU and breakers -install bonding jumper at at water line around backflow device and valve -install water anti syphon device at water spigot in sprinkler room -connect fmc to connector at boiler -Install all missing glass in doors 1st floor -complete all inspection items for other departments Okay to install appliances in kitchen and move in furniture. DO NOT OCCUPY
Erosion Control Inspection Passed 2/19/2024 2/19/2024 02/14/2024
Misc
Informational
06/05/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison control is up and in working order. 2-2-23 PS Erosion control within compliance 2-6-22 RH. Erosion control is up and in working order. 2-13-23 RH. Erosion cotrol is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-6-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order. 4-18-23 RH. Erosion control is up and in working order. 4-20-23 RH. Erosion control is up and in working order. 4-24-23 RH. Erosion control is up and in working order. 5-1-23 RH. Erosion Control is up and in working order. 5-15-23 RH. Erosion Control is up and in working order. 5-22-23 RH. Erosion Control is up and in working order. 6-5-23 BR Erosion control is up and working order. 2-12-24 Dustin A, no silt fence up due to laying sod this weel. Straw waddles were installed next to scooters
Pavement-Surface Partial 2/19/2024 2/19/2024 02/14/2024
Misc
Corrective Action Required
02/14/2024
12-8-23 BR Contractor started pouring concrete parking lot stalls and 30' of driveway by the garage doors. Had to stop contractor from pouring do to weather. 12-12-23 PS Contractor pouring concrete at trash enclosure and pavement just on the west side of building near fire truck bay doors. PM Contractor poured concrete at south side of building 2-2-24 Dustin A, Contractor breaking up and replacing cracked panels and curbs 2-7-24 Dustin A, All Panels have been replaced. 2-14-24 Dustin A, Drive is in just needs to attach to city street
Retention Basin Passed 2/19/2024 2/19/2024 02/14/2024
Misc
Informational
02/09/2024
1-3-24 Dustin A, Basin 1 is installed Per plans . Approved to backfill. Basin 2 Still Needs some work done 1-31-24 Dustin A, Cleaning basin of debris, working on backfilling 2-2-24 Dustin A, East retention pond is ready for backfilled. 2-9-24 Dustin A, East retention is finished
Water Service Inspection Passed 3/23/2023 02/16/2024
Misc
Informational
03/23/2023
3-10-23 RH. Spoke with Site Rite about water line consturciton. Copper will be used from main to the meter and copper going 10' out from the meter. 3-20-23 RH. Contractor ran fire line from slab down and under the footing toward the main. Ductile Iron was used pipe war wrapped and thrust block was poured. Copper was ran next to fire line for service line. Flowable fill will be used around pipe to support footing. 3-23-23 RH. Contractor is digging out for water service line today. They will place copper between meter and main then place coper to meter. Contractor then placed copper from under slab to meter and from the meter to the tap.
Water Line - Coliform Test 1 Passed 2/16/2024 02/16/2024
Water Line - Coliform Test 2 Passed 2/16/2024 02/16/2024
Misc
Informational
02/16/2024
2-16-24 Dustin A, Passed per BR
Storm Sewer Construction Inspection Passed 2/16/2024 02/16/2024
Misc
Informational
08/31/2023
6-30-23 BR 10' of storm sewer was install on east side of building. 7-11-23 BR 60' of storm sewer was installed on east side as well 100' storm sewer was installed on the south side of the buildin 7-20-23 BR Sand trap line on west side of building connect to storm sewer 8-29-23 BR 12'' storm sewer was in installation from new manhole 1000.JB to (1001. AI) 30'' inlet with dome grate. 8-31-23 BR 12'' Storm sewer was installed from (1001.AI) 30'' inlet with dome gate to(1003.CI) 2"x3" curb inlet. 2-16-24 Dustin A, Passed per BR
Site Visit Complete 2/16/2024 02/16/2024
Misc
Informational
01/04/2024
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today. 3-9-23 RH. No work for development today due to rain. 3-15-23 RH. Spoke with contractor about water tye in and fire line eventual tye in. 3-21-23 RH. No work being completed for development due to rain. 3-24-23 RH. No work for development today. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 4-3-23 RH. No work for development in the AM. 4-10-23 RH. No work for development in the AM. 4-11-23 RH. No work for development in the AM. 4-12-23 RH. No work for development in the AM. 4-19-23 RH. No work for development in the AM. 4-21-23 RH. Masons are on site working on the building. No work for development in the AM. 4-24-23 RH. No work for development in the AM. 4-25-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM. 5-10-23 RH. No work for development in the AM. 5-15-23 RH. No work for development in the AM. 5-18-23 RH. No work for development in the AM. 5-19-23 RH. No work on site for development in the AM. 5-22-23 RH. No work on site for development in the AM. 6-8-23 BR No work for development 8-10-23 PS Contractor working on interior of building, no exterior work. 10-12-23 PS No work for development today 10-20-23 Dustin A, Called to look at the east side of building for possible pour. Informed super that is was to wet due to it raining all day. Also suggested a possible proof roll for later this week. 12-28-23 Dustin A, Contractors working on detention pond. 12-29-23 Dustin A, No activity today for our department.
Misc
Informational
01/04/2024
1-2-24 DP. No work for development today. Mike did mention that the plan is for the sidewalk crew to come form and pour public sidewalk on thursday of this week. He mentioned that they knew to bring blankets. 1-4-24 Dustin A, No work for us being done
Site Visit Complete 2/2/2023 2/2/2023 02/16/2024
Misc
Informational
02/02/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23.
Site Visit Complete 3/7/2023 02/16/2024
Misc
Informational
03/02/2023
2-2-23 PS Made site visit to discuss project status with contractor. Contractor expected to have meeting with subs tomorrow to discuss timeline to begin work on water, sewer and storm within the month. Building footings expected to begin on 2-20-23. 2-6-23 RH. No work being done on site today for development. 2-15-23 PS No work being performed on site 2-17-23 RH. No work for development on site. 2-28-23 RH. Fire house is having footings being dug out today. No work for development today. 3-2-23 RH. No work being completed on site today for development. 3-7-23 RH. No work for devlopment today.
Erosion Control Inspection Passed 3/14/2023 02/16/2024
Misc
Informational
03/06/2023
1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison control is up and in working order. 2-2-23 PS Erosion control within compliance 2-6-22 RH. Erosion control is up and in working order. 2-13-23 RH. Erosion cotrol is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-6-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion control is up and in working order.
Grading/Excavation/Fill Inspection Passed 2/13/2023 02/16/2024
Misc
Informational
02/08/2023
1-13-22 RH. Contractor has started cutting site down to subgrade. No work for development today. 1-23-23 PS Contractor placed compacted material for building. Contractor installing fence for job site, job trailer and temp power 1-27-23 PS Contractor working on general site work removing spoils piles from project 1-31-23 RH. Contractor continued moving fill and grading site. 2-1-23 PS Contractor continued grading site and fill removal. 2-7-23 RH. Contractor continues to work on building pad. 2-8-23 PS Contractor working on building pad and removing spoils pile 2-13-23 RH. Contractor continues to work on removing fill and building pad. 2-16-24 Dustin A, Site is graded and sodded
Pavement-Aggregate Base Passed 2/16/2024 02/16/2024
Misc
Informational
12/05/2023
11-5-23 BR Contractor started demolition on existing driveway approach on the south side of building. Also, contractor is building the parking lot base and placing aggregate and compaction.
Pavement-Curb Construction Passed 12/15/2023 02/16/2024
Misc
Informational
11/03/2023
11-1-23 BR Contractor tore out existing curb on west side of building. 11-2-23 BR Contractor formed up driveway curbs plus approach along with the curbs on the west side of building. 11-30-23 BR Contractor pour curbs around building to LS specifications. 12-15-23 BR Contractor pour the reminder of curbs around the building and driveway approach curbs to LS specifications.
Pavement-Proof Roll Passed 2/16/2024 02/16/2024
Misc
Informational
12/06/2023
12-6-23 BR Contractor preformed a poof roll on the parking lot on the south side of the building. There is a section on the south side of the parking lot where vehicle will be parking that needs to be compacted more. Also 20' of the driveway approach by the entrance of the rear garage doors into the building was poof roll as well.
Pavement-Stabilized Subgrade Passed 2/16/2024 02/16/2024
Misc
Informational
10/30/2023
10-23-23 BR Contractor remove existing curb on south west side of property next to scooters. Also they started grading on driveway and approach.
Sewer Service Inspection Passed 2/16/2024 02/16/2024
Misc
Informational
06/30/2023
6-30-23 BR 4' PVC was installed and concrete encasement was reinforced with rebar and poured.
Water Line - Construction Inspection Passed 2/16/2024 02/16/2024
Misc
Informational
03/23/2023
3-10-23 RH. Spoke with Site Rite about water line consturciton. Copper will be used from main to the meter and copper going 10' out from the meter. 3-20-23 RH. Contractor ran fire line from slab down and under the footing toward the main. Ductile Iron was used pipe war wrapped and thrust block was poured. Flowable fill will be used around pipe to support footing. 3-23-23 RH. Contractor is digging out for water service line today. They will place copper between meter and main then place coper to meter.
Water Service Inspection Passed 2/16/2024 02/16/2024
Misc
Informational
03/23/2023
3-13-23 DP. Water dept. told contractor that they are going to sub out the water tap due to it being HDPE. The earliest they can do the tap now is Monday 3/21/23. I had the contractor come and cover the water main with concrete blankets since it will be exposed for so long. 3-20-23 RH. Copper line was used from main to meter then all the way to building.
Water Line - Hydrostatic Test Passed 2/16/2024 02/16/2024
Misc
Informational
02/16/2024
BR Fire line held Pressure.
Occupancy Inspection - Water Utilities Passed 2/14/2024 2/16/2024 02/22/2024
Grading/Excavation/Fill Inspection Passed 2/23/2024 02/23/2024
Misc
Informational
02/13/2023
1-13-22 RH. Contractor has started cutting site down to subgrade. No work for development today. 1-23-23 PS Contractor placed compacted material for building. Contractor installing fence for job site, job trailer and temp power 1-27-23 PS Contractor working on general site work removing spoils piles from project 1-31-23 RH. Contractor continued moving fill and grading site. 2-1-23 PS Contractor continued grading site and fill removal. 2-7-23 RH. Contractor continues to work on building pad. 2-8-23 PS Contractor working on building pad and removing spoils pile 2-13-23 RH. Contractor continues to work on removing fill and building pad.
Pavement-Surface Failed 3/14/2024 03/14/2024
Misc
Informational
02/14/2024
12-8-23 BR Contractor started pouring concrete parking lot stalls and 30' of driveway by the garage doors. Had to stop contractor from pouring do to weather. 12-12-23 PS Contractor pouring concrete at trash enclosure and pavement just on the west side of building near fire truck bay doors. PM Contractor poured concrete at south side of building 2-2-24 Dustin A, Contractor breaking up and replacing cracked panels and curbs 2-7-24 Dustin A, All Panels have been replaced. 2-14-24 Dustin A, Drive is in just needs to attach to city street 2-16-24 Dustin A, Drive attached. Passed 3-6-24 Dustin A, There is a cracked panel on the south side.l
Sidewalk Inspection Failed 3/12/2024 3/12/2024 03/14/2024
Misc
Informational
01/30/2024
11-7-23 BR Contractor formed sidewalk entrance and ADA ramp up and aggregate is place plus compacted ready for concrete. 11-8-23 BR Entrance sidewalk and ADA ramp is concrete to specifications. 1-11-23 PS Checked surface temps for public sidewalks below blankets, subgrade surface below freezing. Not approved for pour. Recall when conditions improve 1-25-24 Dustin A, Inspected the Sw near south side door, Approved to pour, 1-29-24 Dustin A , Inspected what's been poured so far. A top hat for a valve is to high in ADA ramp. Informed contractor its a trip hazard and will need to be fixed. 1-30-24 Dustin A, The rest of the SW is formed and meets city specs , approved to pour.
Miscellaneous Correction
Corrective Action Required
03/14/2024
3-6-24 Cracked panel next to manhole on east side of building. Mike was made aware.
Occupancy Inspection - Engineering Temporary C of O 3/15/2024 3/14/2024 03/14/2024
Misc
Informational
02/14/2024
2-14-24 Dustin A, Everything for Temp C of O has passed PUNCHLIST: Cracked sidewalk Cracked panel south side in parking lot Curb storm inlets cleaned out. Clean gravel out of street against curb
Occupancy Inspection - Fire Passed 2/14/2024 3/15/2024 03/15/2024
Occupancy Inspection - Planning Temporary C of O 3/15/2024 3/15/2024 03/15/2024
Corrective Action Required
03/15/2024
Vegetative screening remains to be installed. Per McCownGordon, they can’t finish plantings at theFire Station until mid-April, at the earliest. I am good with a TCO untill that time.
Occupancy Inspection - Codes Commercial Ready for Temp CO 3/15/2024 3/15/2024 03/15/2024
Misc
Corrective Action Required
02/14/2024
-complete all inspection items for other departments
Occupancy Inspection - Planning Passed 05/30/2024
Sidewalk Inspection Passed 6/27/2024 6/27/2024 06/27/2024
Misc
Informational
03/14/2024
11-7-23 BR Contractor formed sidewalk entrance and ADA ramp up and aggregate is place plus compacted ready for concrete. 11-8-23 BR Entrance sidewalk and ADA ramp is concrete to specifications. 1-11-23 PS Checked surface temps for public sidewalks below blankets, subgrade surface below freezing. Not approved for pour. Recall when conditions improve 1-25-24 Dustin A, Inspected the Sw near south side door, Approved to pour, 1-29-24 Dustin A , Inspected what's been poured so far. A top hat for a valve is to high in ADA ramp. Informed contractor its a trip hazard and will need to be fixed. 1-30-24 Dustin A, The rest of the SW is formed and meets city specs , approved to pour.
Miscellaneous Correction
Corrective Action Required
03/14/2024
3-6-24 Cracked panel next to manhole on east side of building. Mike was made aware.
Occupancy Inspection - Engineering Passed 6/27/2024 6/27/2024 06/27/2024
Misc
Informational
03/14/2024
2-14-24 Dustin A, Everything for Temp C of O has passed PUNCHLIST: Cracked sidewalk Cracked panel south side in parking lot Curb storm inlets cleaned out. Clean gravel out of street against curb
Occupancy Inspection - Codes Commercial Full C of O 6/27/2024 06/27/2024
Misc
Resolved
06/27/2024
-complete all inspection items for other departments
Documents & Images
Date Uploaded File Type Document Name
10/27/2022 Application Form City of Lees Summit_Fire Station 5_Commercial Permit Application_10272022
10/28/2022 Plans LEES SUMMIT FIRE STATION 5_DRAWINGS_REV 0_10272022
10/28/2022 Engineer Report/Study LEES SUMMIT FIRE STATION 5_STRUCTURAL CALCULATIONS_REV 0_10272022
10/28/2022 Specifications LEES SUMMIT FIRE STATION 5_SPECIFICATIONS_REV 0_10272022
10/31/2022 Letter Codes Mod Request
11/10/2022 Letter DS P/R Corrections Document
11/30/2022 Plans LEES SUMMIT FIRE STATION 5_DRAWINGS_REV1_REVIEW RESPONSE
11/30/2022 Letter LEES SUMMIT FIRE STATION 5_REVIEW RESPONSE
11/30/2022 Engineer Report/Study LEES SUMMIT FIRE STATION 5_STORM SHELTER PEER REVIEW_REVIEW RESPONSE
12/05/2022 Letter Fire Building Plan Review
12/05/2022 Letter License Tax Bill
12/07/2022 Letter DS P/R Corrections Document
12/23/2022 Plans Lee's Summit_FS5 Responses_20221223
01/03/2023 Engineer Report/Study Fire_4-5_Spec-Inspections
01/06/2023 Receipt Receipt for transaction: 2023-000088
01/06/2023 Letter DS Building Permit
01/09/2023 Plans LEES SUMMIT FIRE STATION 5_DRAWINGS_COMBINED PERMIT SET_20230106
01/10/2023 Approved Plans approved - LEES SUMMIT FIRE STATION 5_DRAWINGS_COMBINED PERMIT SET_20230106
01/13/2023 Letter INSPECTION SUMMARY
01/23/2023 Letter INSPECTION SUMMARY
01/23/2023 Letter INSPECTION SUMMARY
01/24/2023 Activity Document Temporary Construction Easement
01/25/2023 Letter INSPECTION SUMMARY
01/27/2023 Letter INSPECTION SUMMARY
01/30/2023 Letter INSPECTION SUMMARY
01/31/2023 Letter INSPECTION SUMMARY
02/01/2023 Letter INSPECTION SUMMARY
02/02/2023 Letter INSPECTION SUMMARY
02/02/2023 Letter INSPECTION SUMMARY
02/06/2023 Letter INSPECTION SUMMARY
02/06/2023 Letter INSPECTION SUMMARY
02/07/2023 Letter INSPECTION SUMMARY
02/08/2023 Letter INSPECTION SUMMARY
02/13/2023 Letter INSPECTION SUMMARY
02/13/2023 Letter INSPECTION SUMMARY
02/15/2023 Letter INSPECTION SUMMARY
02/17/2023 Letter INSPECTION SUMMARY
02/22/2023 Letter INSPECTION SUMMARY
02/27/2023 Letter INSPECTION SUMMARY
02/28/2023 Letter INSPECTION SUMMARY
03/01/2023 Letter INSPECTION SUMMARY
03/01/2023 Letter Fire Building Plan Review
03/01/2023 Letter Fire Building Plan Review
03/01/2023 Letter Fire Building Plan Review
03/02/2023 Letter Fire Building Plan Review
03/02/2023 Letter INSPECTION SUMMARY
03/02/2023 Letter INSPECTION SUMMARY
03/03/2023 Letter INSPECTION SUMMARY
03/06/2023 Letter INSPECTION SUMMARY
03/07/2023 Letter INSPECTION SUMMARY
03/07/2023 Letter INSPECTION SUMMARY
03/09/2023 Letter INSPECTION SUMMARY
03/10/2023 Letter INSPECTION SUMMARY
03/14/2023 Letter INSPECTION SUMMARY
03/14/2023 Letter INSPECTION SUMMARY
03/15/2023 Letter INSPECTION SUMMARY
03/15/2023 Letter INSPECTION SUMMARY
03/17/2023 Letter INSPECTION SUMMARY
03/20/2023 Letter INSPECTION SUMMARY
03/21/2023 Fire Line To Building
03/21/2023 Fire Line To Main
03/21/2023 Letter INSPECTION SUMMARY
03/21/2023 Letter INSPECTION SUMMARY
03/21/2023 Letter INSPECTION SUMMARY
03/22/2023 Letter INSPECTION SUMMARY
03/23/2023 Letter INSPECTION SUMMARY
03/23/2023 Letter INSPECTION SUMMARY
03/24/2023 Water Line Connection
03/24/2023 Water Line Connection (2)
03/24/2023 Letter INSPECTION SUMMARY
03/27/2023 Letter INSPECTION SUMMARY
03/30/2023 Letter INSPECTION SUMMARY
03/30/2023 Letter INSPECTION SUMMARY
03/30/2023 Letter INSPECTION SUMMARY
03/30/2023 Lee's Summit Fire Station #5 FP Hyd Calcs
03/30/2023 Lee's Summit Fire Station #5 FP Plan
03/31/2023 Letter Fire (Sprinkler) Plan Review
03/31/2023 Letter INSPECTION SUMMARY
04/03/2023 Letter INSPECTION SUMMARY
04/03/2023 Letter INSPECTION SUMMARY
04/05/2023 Letter INSPECTION SUMMARY
04/05/2023 Letter INSPECTION SUMMARY
04/05/2023 Letter INSPECTION SUMMARY
04/10/2023 Letter INSPECTION SUMMARY
04/10/2023 Letter INSPECTION SUMMARY
04/10/2023 Plans Lee's Summit Fire Station #5_20230410
04/11/2023 Letter INSPECTION SUMMARY
04/12/2023 Letter INSPECTION SUMMARY
04/12/2023 Letter INSPECTION SUMMARY
04/13/2023 Letter Lee's Summit Fire Station #4 & #5 ASI Narratives
04/17/2023 Letter INSPECTION SUMMARY
04/18/2023 Letter INSPECTION SUMMARY
04/19/2023 Letter INSPECTION SUMMARY
04/20/2023 Letter INSPECTION SUMMARY
04/21/2023 Letter INSPECTION SUMMARY
04/24/2023 Letter INSPECTION SUMMARY
04/24/2023 Letter INSPECTION SUMMARY
04/24/2023 Letter Fire Building Plan Review
04/24/2023 Letter INSPECTION SUMMARY
04/25/2023 Letter INSPECTION SUMMARY
04/26/2023 Letter INSPECTION SUMMARY
04/26/2023 Letter INSPECTION SUMMARY
04/27/2023 Letter INSPECTION SUMMARY
05/01/2023 Letter INSPECTION SUMMARY
05/03/2023 Letter INSPECTION SUMMARY
05/03/2023 Code Mod Request Code Modification Request - elev exh
05/05/2023 Letter INSPECTION SUMMARY
05/10/2023 Letter INSPECTION SUMMARY
05/15/2023 Letter INSPECTION SUMMARY
05/15/2023 Letter INSPECTION SUMMARY
05/18/2023 Letter INSPECTION SUMMARY
05/19/2023 Letter INSPECTION SUMMARY
05/22/2023 Letter INSPECTION SUMMARY
05/22/2023 Letter INSPECTION SUMMARY
06/05/2023 Letter INSPECTION SUMMARY
06/06/2023 Lees Summit Fire Station 5 FA plans 6-1-2023
06/07/2023 Letter INSPECTION SUMMARY
06/08/2023 Letter INSPECTION SUMMARY
06/12/2023 Letter INSPECTION SUMMARY
06/19/2023 Letter Fire (Alarm) Plan Review Notice
06/20/2023 Letter INSPECTION SUMMARY
06/20/2023 Approved Plans APPROVED FIRE STATION 5 REVISED FDP 6.19.2023
06/27/2023 Letter INSPECTION SUMMARY
06/28/2023 Letter INSPECTION SUMMARY
06/30/2023 Letter Fire (Alarm) Plan Review Notice
06/30/2023 Letter INSPECTION SUMMARY
06/30/2023 Letter INSPECTION SUMMARY
06/30/2023 Letter INSPECTION SUMMARY
07/03/2023 4'' pvc encasement
07/03/2023 4'' pvc sewer line
07/03/2023 4'' pvc sewer line 2
07/07/2023 8'' water main revising 1
07/07/2023 8'' water main revising 2
07/10/2023 Letter INSPECTION SUMMARY
07/11/2023 Letter INSPECTION SUMMARY
07/13/2023 Letter INSPECTION SUMMARY
07/17/2023 Storm sewer in driveway 1
07/17/2023 Storm sewer in driveway 2
07/17/2023 Gutter into storm sewer
07/17/2023 Letter INSPECTION SUMMARY
07/20/2023 Sand trap into storm line
07/20/2023 Sand trap line connect to storm sewer
07/20/2023 Letter INSPECTION SUMMARY
07/31/2023 Letter INSPECTION SUMMARY
08/07/2023 Lees Summit Fire Sation 5 8-2-2023
08/10/2023 Letter INSPECTION SUMMARY
08/14/2023 Letter INSPECTION SUMMARY
08/14/2023 Letter Fire (Alarm) Plan Review Notice
08/21/2023 Letter INSPECTION SUMMARY
08/21/2023 Letter INSPECTION SUMMARY
08/23/2023 Lee's Summit Fire Station FA Submittal
08/23/2023 Lee's Summit Fire Station FA Plan 5 8-21-2023
08/23/2023 Letter INSPECTION SUMMARY
08/28/2023 Letter INSPECTION SUMMARY
08/29/2023 Letter INSPECTION SUMMARY
08/31/2023 Letter INSPECTION SUMMARY
09/01/2023 Letter INSPECTION SUMMARY
09/07/2023 Letter INSPECTION SUMMARY
09/07/2023 Letter INSPECTION SUMMARY
09/08/2023 Lee's Summit Fire Station FA Plan 5 8-21-2023 APPROVED
09/08/2023 Letter Fire (Alarm) Plan Review Notice

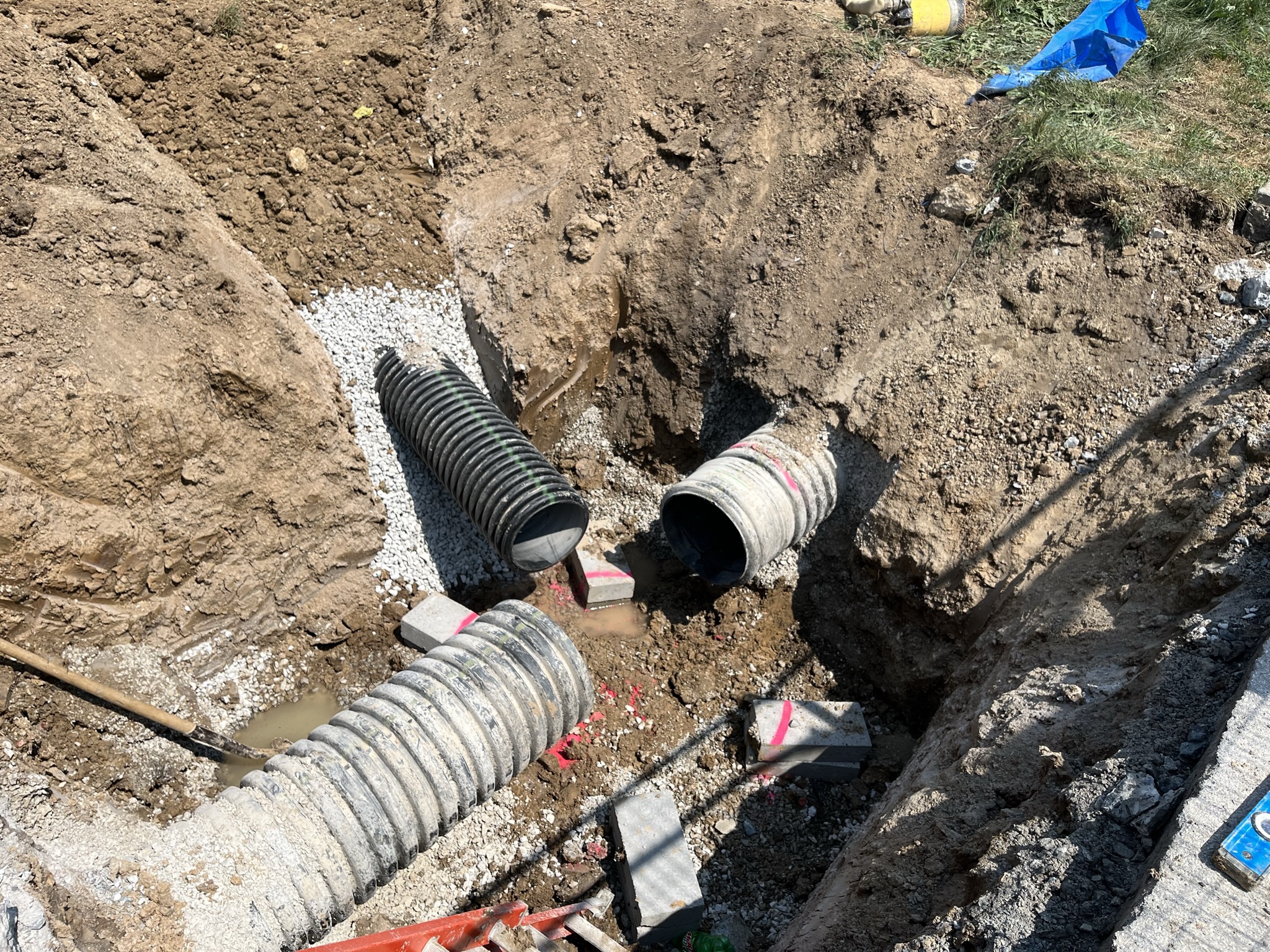

09/11/2023 New Strom Sewer Manhole 1
09/11/2023 New Strom Sewer Manhole 2
09/11/2023 New Strom Sewer Manhole 3
09/27/2023 Letter Fire (Alarm) Plan Review Notice
09/27/2023 Letter Fire (Alarm) Plan Review Notice
09/27/2023 Letter INSPECTION SUMMARY
09/27/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/04/2023 Letter INSPECTION SUMMARY
10/04/2023 Letter INSPECTION SUMMARY

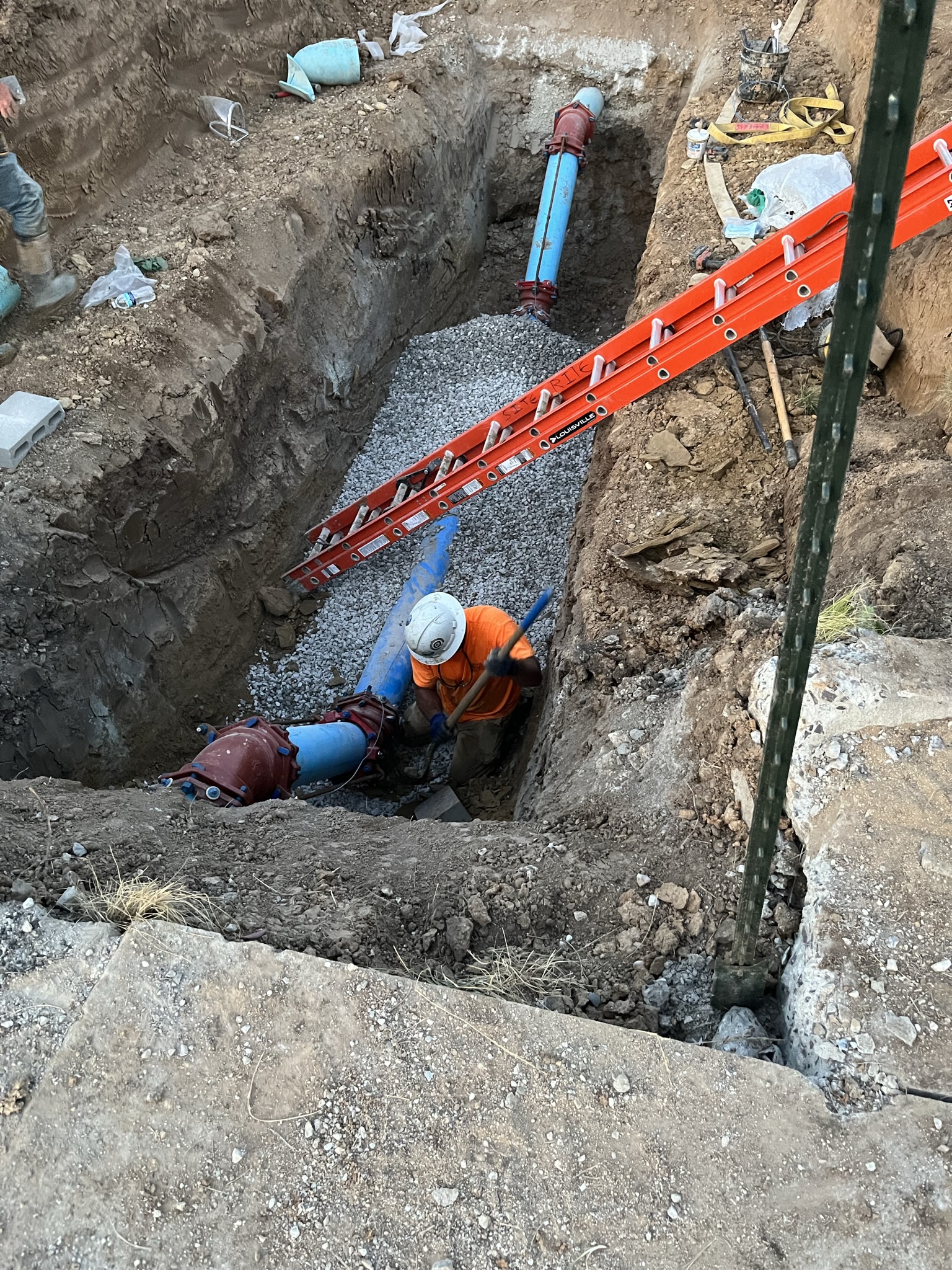

10/04/2023 Fire Hydrant assembly
10/04/2023 Fire line assembly 1
10/04/2023 Fire line assembly 2
10/04/2023 Fire line assembly 3
10/11/2023 Letter Fire (Alarm) Plan Review Notice
10/11/2023 Letter INSPECTION SUMMARY
10/12/2023 Letter INSPECTION SUMMARY
10/12/2023 Code Mod Request Code Mod Request - front door hardware
10/13/2023 Letter INSPECTION SUMMARY
10/16/2023 Letter INSPECTION SUMMARY
10/18/2023 Letter INSPECTION SUMMARY
10/25/2023 Letter INSPECTION SUMMARY
10/30/2023 Letter INSPECTION SUMMARY
11/03/2023 Letter INSPECTION SUMMARY
11/06/2023 Letter INSPECTION SUMMARY
11/06/2023 Email RE_ FS 5 Storm water feature
11/06/2023 Tel_Radio Room UL Listing Clarificaiton_GLMV (1)
11/08/2023 Letter INSPECTION SUMMARY
11/08/2023 Letter INSPECTION SUMMARY
11/13/2023 Letter INSPECTION SUMMARY
11/14/2023 Letter INSPECTION SUMMARY
11/15/2023 Letter INSPECTION SUMMARY
11/17/2023 Letter INSPECTION SUMMARY
11/20/2023 Letter INSPECTION SUMMARY
11/22/2023 Letter INSPECTION SUMMARY
11/22/2023 East Drive Paving firehouse 5
11/29/2023 Plans PRCOM20225393 - LSFS 5 - UL LISTING TO CITY
11/30/2023 Letter INSPECTION SUMMARY
12/04/2023 Letter INSPECTION SUMMARY
12/04/2023 Letter INSPECTION SUMMARY
12/04/2023 Letter INSPECTION SUMMARY
12/04/2023 Letter INSPECTION SUMMARY
12/05/2023 Letter INSPECTION SUMMARY
12/05/2023 Approved Plans approved revisions - PRCOM20225393 - LSFS 5 - UL LISTING TO CITY
12/06/2023 Letter INSPECTION SUMMARY
12/07/2023 Letter INSPECTION SUMMARY
12/07/2023 Letter INSPECTION SUMMARY
12/08/2023 Letter INSPECTION SUMMARY
12/12/2023 Letter INSPECTION SUMMARY
12/12/2023 Letter INSPECTION SUMMARY
12/12/2023 Letter INSPECTION SUMMARY
12/13/2023 Batch Tickets 12-12 West Paving
12/15/2023 Letter INSPECTION SUMMARY
12/15/2023 Letter INSPECTION SUMMARY
12/20/2023 Letter INSPECTION SUMMARY
12/20/2023 Letter INSPECTION SUMMARY
12/20/2023 RFI #170 - UL Assembly at the Elevator Door - GLMV
12/22/2023 Letter INSPECTION SUMMARY
12/22/2023 Letter INSPECTION SUMMARY
12/22/2023 RFI #174 - Bioretention Basin 4inch Perforated Pipe_GLMV
12/22/2023 RFI #179 - LSFS 5 Bioretention Basin Rock Size - FOR RECORD-KDW
12/22/2023 firestation 5 retention construction 1
12/22/2023 firestation 5 concrete holding water
12/22/2023 firestation5 retention construction2
12/22/2023 firestation 5 concrete holding water2
12/28/2023 firehouse5 detention pond
12/28/2023 Letter INSPECTION SUMMARY
12/29/2023 Letter INSPECTION SUMMARY
12/30/2023 Elevator Permit - Station 5
01/02/2024 Letter INSPECTION SUMMARY
01/03/2024 Letter INSPECTION SUMMARY
01/03/2024 Letter INSPECTION SUMMARY
01/04/2024 Letter INSPECTION SUMMARY
01/05/2024 Letter INSPECTION SUMMARY
01/05/2024 Letter INSPECTION SUMMARY
01/08/2024 Letter INSPECTION SUMMARY
01/11/2024 Letter INSPECTION SUMMARY
01/29/2024 firehouse valve in sw
01/30/2024 Letter INSPECTION SUMMARY
01/31/2024 Letter INSPECTION SUMMARY
02/01/2024 Letter INSPECTION SUMMARY
02/02/2024 Letter INSPECTION SUMMARY

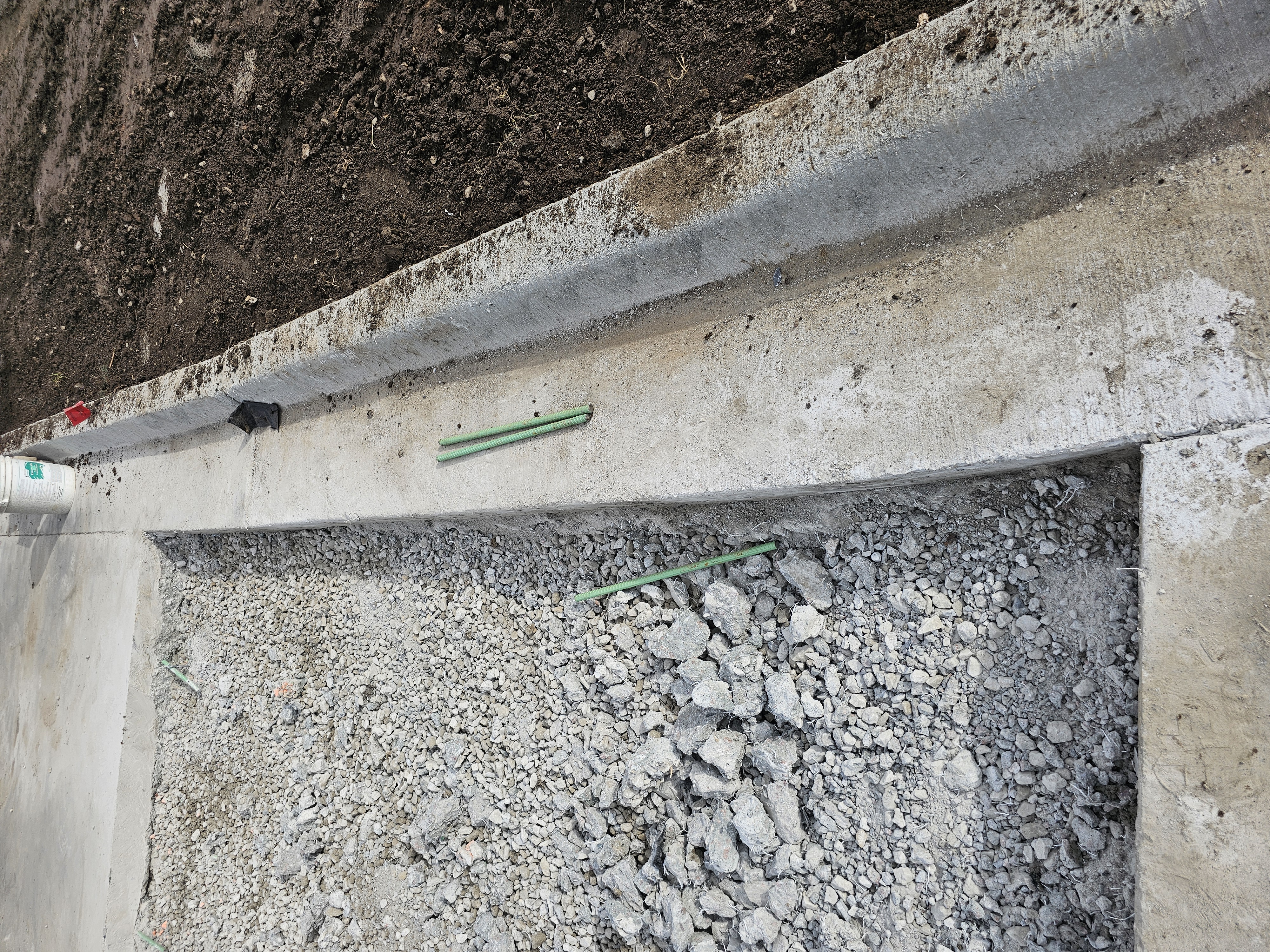

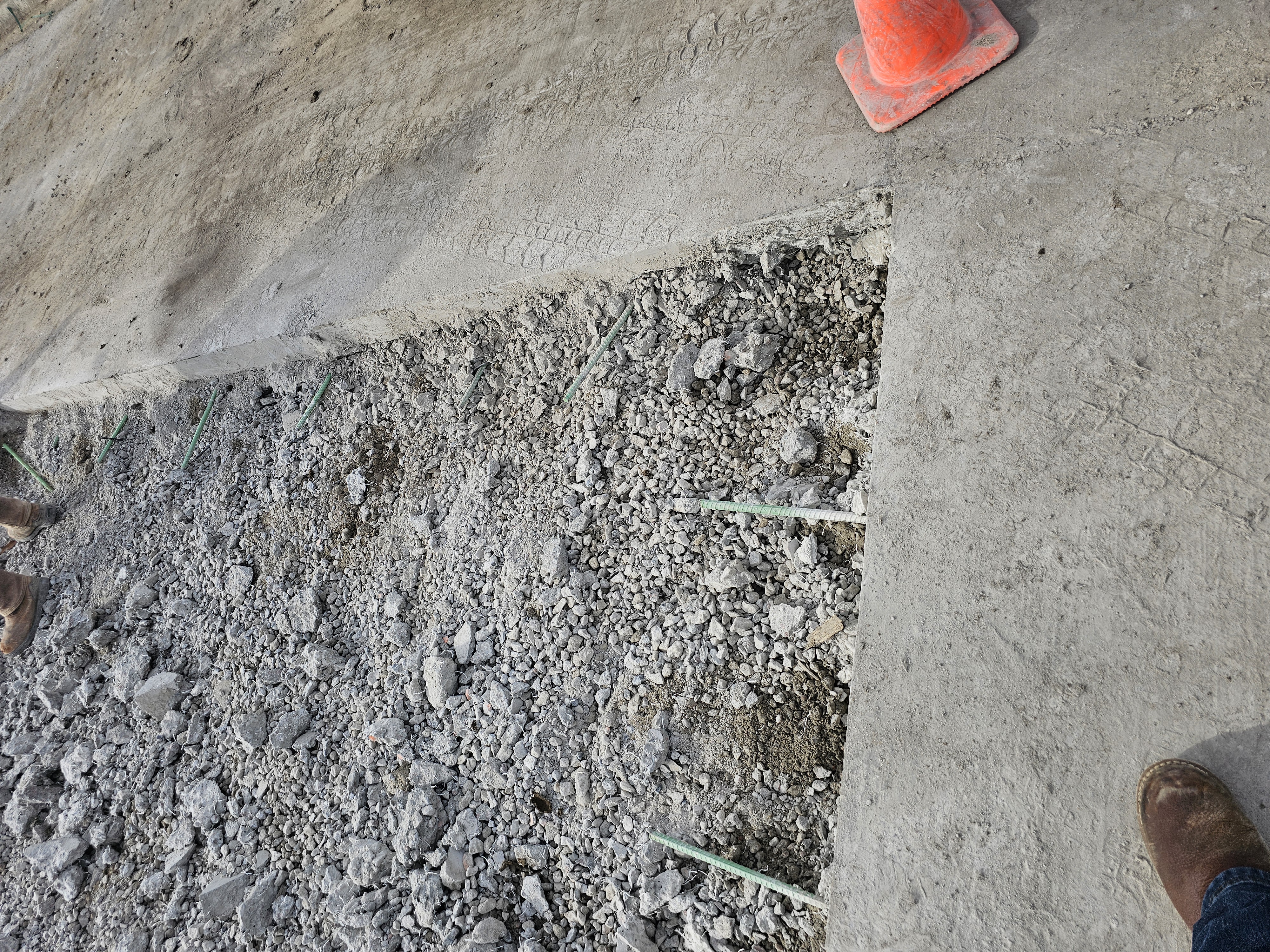

02/02/2024 firehouse 5 drive replacement 8
02/02/2024 firehouse 5 drive panel 2
02/02/2024 fir4ehouse 5 drive replacement 7
02/02/2024 firehouse 5 drive replacement 6
02/02/2024 firehouse 5 drive replacement 5
02/02/2024 firehouse 5 drive replacement 3
02/02/2024 firehouse 5 drive replacement 4
02/02/2024 firehouse 5 drive panel place
02/02/2024 Letter INSPECTION SUMMARY
02/05/2024 Letter INSPECTION SUMMARY
02/07/2024 Letter INSPECTION SUMMARY
02/07/2024 Letter INSPECTION SUMMARY
02/07/2024 Letter INSPECTION SUMMARY
02/09/2024 Letter INSPECTION SUMMARY
02/09/2024 Letter INSPECTION SUMMARY
02/12/2024 3RD Party Insp Report Lee's Summit Fire Station 4-5 New Backflow 2024
02/13/2024 3RD Party Insp Report MO Boiler Inspection Reports Lees Summit Fire Stations
02/14/2024 Letter INSPECTION SUMMARY
02/14/2024 Letter INSPECTION SUMMARY
02/14/2024 Letter INSPECTION SUMMARY
02/14/2024 Letter INSPECTION SUMMARY
02/14/2024 Letter INSPECTION SUMMARY
02/14/2024 Letter INSPECTION SUMMARY
02/14/2024 Letter INSPECTION SUMMARY
02/14/2024 Letter INSPECTION SUMMARY
02/14/2024 Letter INSPECTION SUMMARY
02/14/2024 Letter INSPECTION SUMMARY
02/14/2024 Letter INSPECTION SUMMARY
02/14/2024 Letter INSPECTION SUMMARY
02/14/2024 Letter INSPECTION SUMMARY
02/14/2024 Letter INSPECTION SUMMARY
02/14/2024 Letter INSPECTION SUMMARY
02/14/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/16/2024 Letter INSPECTION SUMMARY
02/19/2024 3RD Party Insp Report Lees Summit Fire Stations 4 & 5 - Backflow Test Reports - Rand
02/23/2024 Letter INSPECTION SUMMARY
03/14/2024 Letter INSPECTION SUMMARY
03/14/2024 Letter INSPECTION SUMMARY
03/15/2024 Letter INSPECTION SUMMARY
03/15/2024 Letter INSPECTION SUMMARY
03/15/2024 Letter INSPECTION SUMMARY
03/15/2024 Letter INSPECTION SUMMARY
03/15/2024 Letter INSPECTION SUMMARY
03/20/2024 Certificate/License Codes Temporary Certificate of Occupancy
03/20/2024 Receipt Receipt for transaction:2024-001737
04/03/2024 Code Mod Request CMR for R2 vs B
05/30/2024 Letter INSPECTION SUMMARY
06/27/2024 3RD Party Insp Report No. 5 SI Letter_Optimized
06/27/2024 Letter Codes Final Certificate of Occupancy
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
